Scheduling under Uncertainty Frank Werner Faculty of Mathematics
- Slides: 59
Scheduling under Uncertainty Frank Werner Faculty of Mathematics
Outline of the talk 1. 2. 3. 4. 5. 6. Introduction Stochastic approach Fuzzy approach Robust approach Stability approach Selection of a suitable approach PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 2
1. Introduction Notations PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 3
• Deterministic models: all data are deterministically given in advance • Stochastic models: data include random variables In real-life scheduling: many types of uncertainty (e. g. processing times not exactly known, machine breakdowns, additionally ariving jobs with high priorities, rounding errors, etc. ) Uncertain (interval) processing times: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 4
Relationship between stochastic and uncertain problems: Distribution function Density function PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 5
Approaches for problems with inaccurate data: • Stochastic approach: use of random variables with known probability distributions • Fuzzy approach: fuzzy numbers as data • Robust approach: determination of a schedule hedging against the worst-case scenario • Stability approach: combination of a stability analysis, a multi-stage decision framework and the concept of a minimal dominant set of semi-active schedules → There is no unique method for all types of uncertainties. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 6
Two-phase decision-making procedure 1) Off-line (proactive) phase construction of a set of potentially optimal solutions before the realization of the activities (static scheduling environment, schedule planning phase) 2) On-line (reactive) phase selection of a solution from when more information is available and/or a part of the schedule has already been realized → use of fast algorithms (dynamic scheduling environment, schedule execution phase) PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 7
General literature (surveys) Pinedo: Scheduling, Theory, Algorithms and Systems, Prentice Hall, 1995, 2002, 2008, 2012 • Slowinski and Hapke: Scheduling under Fuzziness, Physica, 1999 • Kasperski: Discrete Optimization with Interval Data, Springer, 2008 • Sotskov, Sotskova, Lai and Werner: Scheduling under Uncertainty; Theory and Algorithms, Belarusian Science, 2010 • For the RCPSP under uncertainty, see e. g. • Herroelen and Leus, Int. J. Prod. Res. . 2004 • Herroelen and Leus, EJOR, 2005 • Demeulemeester and Herroelen, Special Issue, J. Scheduling, 2007 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 8
2. Stochastic approach • Distribution of random variables (e. g. processing times, release dates, due dates) known in advance • Often: minimization of expectation values (of makespan, total completion time, etc. ) Classes of policies (see Pinedo 1995) • Non-preemptive static list policy (NSL) • Preemptive static list policy (PSL) • Non-preemptive dynamic policy (ND) • Preemptive dynamic policy (PD) PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 9
Some results for single-stage problems (see Pinedo 1995) Single machine problems (a) Problem WSEPT rule: order the jobs according to non-increasing ratios Theorem 1: The WSEPT rule determines an optimal solution in the class of NSL as well as ND policies. (b) Problem Theorem 2: The EDD rule determines an optimal solution in the class of NSL, ND and PD policies. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 10
(c) Problem Theorem 3: The WSEPT rule determines an optimal solution in the class of NSL, ND and PD policies. Remark: The same result holds for geometrically distributed Parallel machine problems (a) Problem Theorem 4: The LEPT rule determines an optimal solution in the class of NSL policies. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 11
(b) Problem Theorem 5: The non-preemptive LEPT policy determines an optimal solution in the class of PD policies. (c) Problem Theorem 6: The non-preemptive SEPT policy determines an optimal solution in the class of PD policies. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 12
Selected references (1) • • • • Pinedo and Weiss, Nav. Res. Log. Quart. , 1979 Glazebrook, J. Appl. Prob. , 1979 Weiss and Pinedo, J. Appl. Prob. , 1980 Weber, J. Appl. Prob. , 1982 Pinedo, Oper. Res. , 1982; 1983 Pinedo, EJOR, 1984 Pinedo and Weiss, Oper. Res. , 1984 Möhring, Radermacher and Weiss, ZOR, 1984; 1985 Pinedo, Management Sci. , 1985 Wie and Pinedo, Math. Oper. Res. , 1986 Weber, Varaiya and Walrand, J. Appl. Prob. , 1986 Righter, System and Control Letters, 1988 Weiss, Ann. Oper. Res. , 1990 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 13
Selected references (2) • • • • Weiss, Math. Oper. Res. , 1992 Righter, Stochastic Orders, 1994 Cai and Tu, Nav. Res. Log. , 1996 Cai and Zhou, Oper. Res. , 1999 Möhring, Schulz and Uetz, J. ACM, 1999 Nino-Mora, Encyclop. Optimiz. , 2001 Cai, Sun and Zhou, Prob. Eng. Inform. Sci. , 2003 Ebben, Hans and Olde Weghuis, OR Spectrum, 2005 Ivanescu, Fransoo and Bertrand, OR Spectrum, 2005 Cai, Wu and Zhou, IEEE Transactions Autom. Sci. Eng. , 2007 Cai, Wu and Zhou, J. Scheduling, 2007; 2011 Cai, Wu and Zhou, Oper. Res. , 2009 Tam, Ehrgott, Ryan and Zakeri, OR Spectrum, 2011 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 14
3. Fuzzy approach Fuzzy scheduling techniques either fuzzify existing scheduling rules or solve mathematical programming problems • Often: fuzzy processing times , fuzzy due dates • Examples • triangular fuzzy processing times PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 trapezoidal fuzzy processing times 15
Often: possibilistic approach (Dubois and Prade 1988) Chanas and Kasperski (2001) Problem Objective: Assumption: → adaption of Lawler‘s algorithm for problem PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 16
Special cases: a) b) c) d) Alternative goal approach - fuzzy goal, Objective: Chanas and Kasperski (2003) Problem Objective: → adaption of Lawler‘s algorithm for problem PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 17
Selected references (1) • • • Dumitru and Luban, Fuzzy Sets and Systems, 1982 Tada, Ishii and Nishida, APORS, 1990 Ishii, Tada and Masuda, Fuzzy Sets and Systems, 1992 Grabot and Geneste, Int. J. Prod. Res. , 1994 Han, Ishii and Fuji, EJOR, 1994 Ishii and Tada, EJOR, 1995 Stanfield, King and Joines, EJOR, 1996 Kuroda and Wang, Int. J. Prod. Econ. , 1996 Özelkan and Duckstein, EJOR, 1999 Sakawa and Kubota, EJOR, 2000 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 18
Selected references (2) • • Chanas and Kasperski, Eng. Appl. Artif. Intell. , 2001 Chanas and Kasperski, EJOR, 2003 Chanas and Kasperski, Fuzzy Sets and Systems, 2004 Itoh and Ishii, Fuzzy Optim. and Dec. Mak. , 2005 Kasperski, Fuzzy Sets and Systems, 2005 Inuiguchi, LNCS, 2007 Petrovic, Fayad, Petrovic, Burke and Kendall, Ann. Oper. Res. , 2008 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 19
4. Robust approach Objective: Find a solution, which minimizes the „worst-case“ performance over all scenarios. Notations (single machine problems) maximal regret of Minmax regret problem (MRP): Find a sequence PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 such that 20

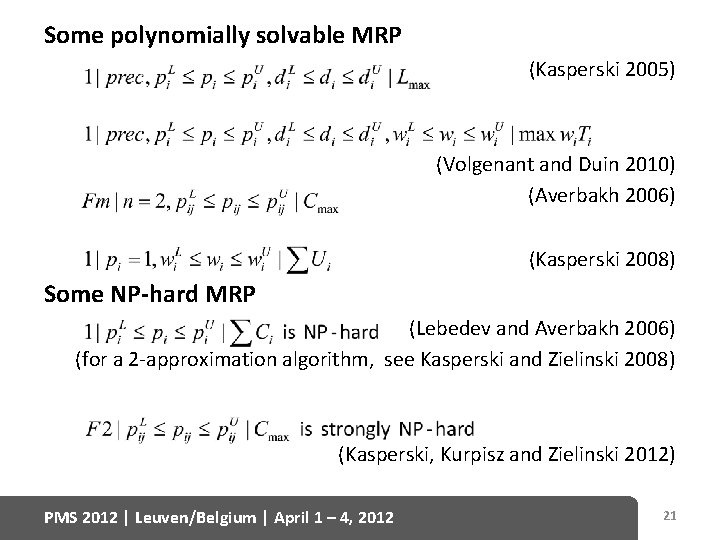

Some polynomially solvable MRP (Kasperski 2005) (Volgenant and Duin 2010) (Averbakh 2006) (Kasperski 2008) Some NP-hard MRP (Lebedev and Averbakh 2006) (for a 2 -approximation algorithm, see Kasperski and Zielinski 2008) (Kasperski, Kurpisz and Zielinski 2012) PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 21
Kasperski and Zielinski (2011) Consideration of MRP‘s using fuzzy intervals Deviation interval Known: deviation Application of possibility theory (Dubois and Prade 1988) possibly optimal if necessarily optimal if PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 22
Fuzzy problem or equivalently where is a fuzzy interval and with membership function is the complement of The fuzzy problem can be efficiently solved if a polynomial algorithm for the corresponding MRP exists. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 23
Solution approaches a) Binary search method - repeated exact solution of the MRP - applications: : binary search subroutine in B&B algorithm PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 24
b) Mixed integer programming formulation - use of a MIP solver - application: c) Parametric approach - solution of a parametric version of a MRP (often time-consuming) - application: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 25
Selected references (1) • • • Daniels and Kouvelis, Management Sci. , 1995 Kouvelis and Yu, Kluwer, 1997 Kouvelis, Daniels and Vairaktarakis, IEEE Transactions, 2000 Averbakh, OR Letters, 2001 Yang and Yu, J. Comb. Optimiz. , 2002 Kasperski, OR Letters, 2005 Kasperski and Zielinski, Inf. Proc. Letters, 2006 Lebedev and Averbakh, DAM, 2006 Averbakh, EJOR, 2006 Montemanni, JMMA, 2007 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 26
Selected references (2) • • • Kasperski and Zielinski, OR Letters, 2008 Sabuncuoglu and Goren, Int. J. Comp. Integr. Manufact. , 2009 Aissi, Bazgan and Vanderpooten, EJOR, 2009 Volgenant and Duin, COR, 2010 Kasperski and Zielinski, FUZZ-IEEE, 2011 Kasperski, Kurpisz and Zielinski, EJOR, 2012 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 27
5. Stability approach 5. 1. Foundations 5. 2. General shop problem 5. 3. Two-machine flow and job shop problems 5. 4. Problem 28
5. 1. Foundations Mixed Graph Example: 11 12 13 00 ** 21 22 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 23 29
Example (continued) 11 12 13 ** 00 21 22 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 23 30
Stability analysis of an optimal digraph Definition 1 The closed ball stability ball of if for any remains optimal. The maximal value is called a is called the stability radius of digraph Known: • Characterization of the extreme values of • Formulas for calculating • Computational results for job shop problems with (see Sotskov, Sotskova and Werner, Omega, 1997) PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 31
5. 2. General shop problem Definition 2 is called a G-solution for problem if for any fixed contains an optimal digraph. If any is not a G-solution, is called a minimal G-solution denoted as Introduction of the relative stability radius: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 32
Definition 3 Let be such that for any The maximal value of of such a stability ball called the relative stability radius is Known: • Dominance relations among paths and sets of paths • Characterization of the extreme values of PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 33
Characterization of a G-solution for problem Definition 4 (strongly) dominates in → dominance relation Theorem 7: is a G-solution. There exists a finite covering of polytope by closed convex sets with such that for any and any there exists a for which Corollary: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 34
Theorem 8: Let be a G-solution with Then: is a minimal G-solution. For any there exists a vector such that Algorithms for problem PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 35
Several 3 -phase schemes: • B&B: implicit (or explicit) enumeration scheme for generating a G-solution • SOL: reduction of different • by generating a sequence with the same and MINSOL: generation of a minimal G-solution a repeated application of algorithm SOL PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 by 36
Some computational results: Degree of uncertainty (4, 4) Exact solution 1, 3, 5, 7 41. 8 6. 4 2. 4 19. 9 3. 8 2. 4 2, 6, 8, 10 79. 0 14. 7 9. 5 27. 3 6. 9 4. 4 5, 10, 15, 20 434. 9 43. 5 34. 8 112. 8 25. 7 20. 0 Degree of uncertainty (4, 4) Heuristic solution Exact solution Heuristic solution 1, 3, 5, 7 34. 2 7. 5 6. 3 24. 1 6. 5 5. 5 2, 6, 8, 10 88. 3 16. 1 14. 5 52. 9 13. 5 12. 0 5, 10, 15, 20 477. 7 30. 8 30. 1 132. 0 24. 8 24. 0 Exact sol. : , Heuristic sol. : PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 37
5. 3. Two-machine problems with interval processing times a) Problem Johnson permutation: Partition of the job set PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 38
Theorem 9: (1) for any either (2) ) and if satisfies – – – PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 39
Theorem 10: If then Percentage of instances with , where 5 10 15 20 25 30 1 99. 2 95. 2 91. 2 86. 1 79. 2 72. 8 2 97. 2 89. 8 77. 6 63. 5 51. 0 39. 6 3 95. 0 80. 9 66. 4 47. 6 32. 8 20. 6 4 91. 8 78. 6 56. 0 39. 2 20. 3 10. 7 5 91. 0 69. 4 44. 9 28. 9 14. 6 6. 0 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 40
General case of problem Theorem 11: There exists an Theorem 12: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 41
Example: 1 9 10 5 5 10 2 12 11 8 6 11 8 14 13 6 4 4 9 15 17 7 4 4 without transitive arcs: J 2 J 1 J 3 J 5 J 6 J 4 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 42
Properties of in the case of see Matsveichuk, Sotskov and Werner, Optimization, 2011 Schedule execution phase: see Sotskov, Sotskova, Lai and Werner, Scheduling under uncertainty, 2010 (Section 3. 5) Computational results for and for b) Problem → Reduction to two problems: see Sotskov, Sotskova, Lai and Werner, Scheduling under uncertainty, 2010 (Section 3. 6) PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 43

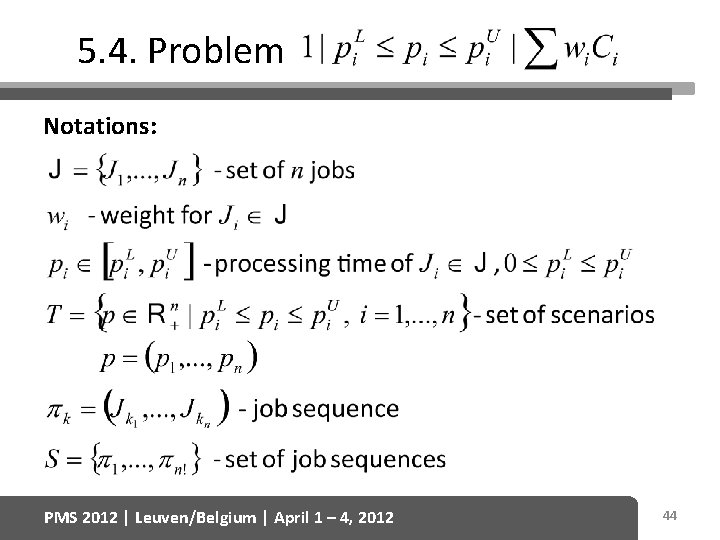

5. 4. Problem Notations: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 44
Definition of the stability box: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 45
Definition 5 The maximal closed rectangular box is a stability box of permutation , if permutation being optimal for instance with a scenario remains optimal for the instance with a scenario for each If there does not exist a scenario such that permutation is optimal for instance , then Remark: The stability box is a subset of the stability region. However, the stability box is used since it can easily be computed. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 46
Theorem 13: For the problem , job if and only if the following inequality holds: Lower (upper) bound on the range of optimality of : PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 dominates preserving the 47
Theorem 14: If there is no job , in permutation such that inequality holds for at least one job , then the stability box is calculated as follows: otherwise PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 48
Example: Data for calculating PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 49
Stability box for Relative volume of a stability box Maximal ranges of possible variations of the processing times , within the stability box are dashed. PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 50
Sotskov, Egorova, Lai and Werner (2011) Derivation of properties of a stability box that allow to derive an algorithm MAX-STABOX for finding a permutation with • the largest dimension and • the largest volume of a stability box PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 51
Computational results Randomly generated instances with PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 52
Selected references • • Lai, Sotskova and Werner, Math. Comp. Model. , vol. 26, 1997 Sotskov, Wagelmans and Werner, Ann. Oper. Res. , vol. 38, 1998 Lai, Sotskova and Werner, Eur. J. Oper. Res. , vol. 159, 2004 Sotskov, Egorova and Lai, Math. Comp. Model. , vol. 50, 2009 Sotskov, Egorova and Werner, Aut. Rem. Control, vol. 71, 2010 Sotskov, Egorova, Lai and Werner, Proceedings SIMULTECH, 2011 Sotskov and Lai, Comp. Oper. Res. , vol. 39, 2012 Sotskov, Lai and Werner, Manuscript, 2012 PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 53
6. Selection of a suitable approach Problem Cardinality of Theorem 15: PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 54
Theorem 16: Assume that there is no Then: Theorem 17: not uniquely determined Construct an equivalent instance with less jobs for which is uniquely determined Assumption: uniquely determined. - instance with the set of scenarios PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 55
Uncertainty measures Dominance graph Recommendations: use a stability approach use a robust approach use a fuzzy or stochastic approach PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 56
Example: 1 5 6 300 60 50 2 4 6 240 60 40 3 6 14 420 70 30 4 2 7 140 70 20 5 10 35 700 70 20 6 5 10 250 50 25 Dominance conditions: apply a stochastic or a fuzzy approach PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 57
Example (continued): 1 5 6 300 60 50 5. 5 54 6/11 2 4 6 240 60 40 5 48 3 6 14 420 70 30 10 42 4 2 7 140 70 20 4. 5 31 1/9 5 10 35 700 70 20 22. 5 31 1/9 6 5 10 250 50 25 7. 5 33 1/9 Remark: (apply a robust approach) easier computable than PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 58
Announcement of a book Sequencing and Scheduling with Inaccurate Data Editors: To appear at: Completion: Yuri N. Sotskov and Frank Werner Nova Science Publishers Summer 2013 4 parts: Each part contains a survey and 2 -4 further chapters. Part 1: Part 2: Part 3: Part 4: Stochastic approach Fuzzy approach Robust approach Stability approach Contact address: survey: Cai et al. survey: Sakawa et al. survey: Kasperski and Zielinski survey: Sotskov and Werner frank. werner@ovgu. de PMS 2012 | Leuven/Belgium | April 1 – 4, 2012 59
