Materials Requirements Planning

Materials Requirements Planning

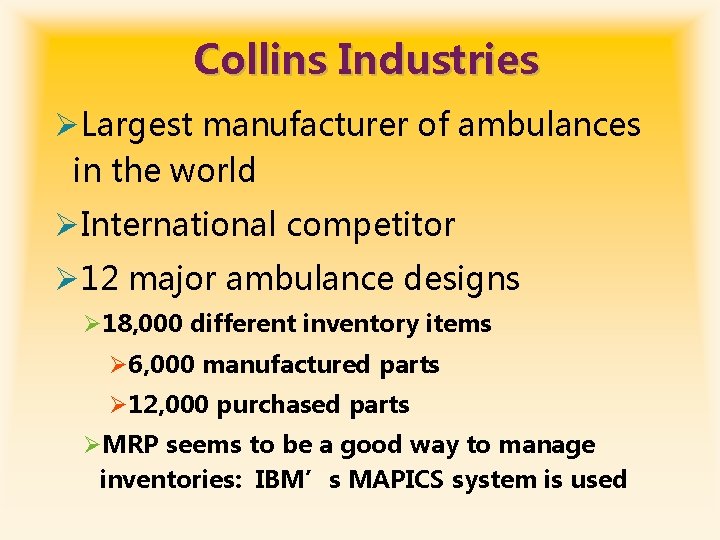

Collins Industries ØLargest manufacturer of ambulances in the world ØInternational competitor Ø 12 major

Collins Industries ØLargest manufacturer of ambulances in the world ØInternational competitor Ø 12 major ambulance designs Ø 18, 000 different inventory items Ø 6, 000 manufactured parts Ø 12, 000 purchased parts ØMRP seems to be a good way to manage inventories: IBM’s MAPICS system is used

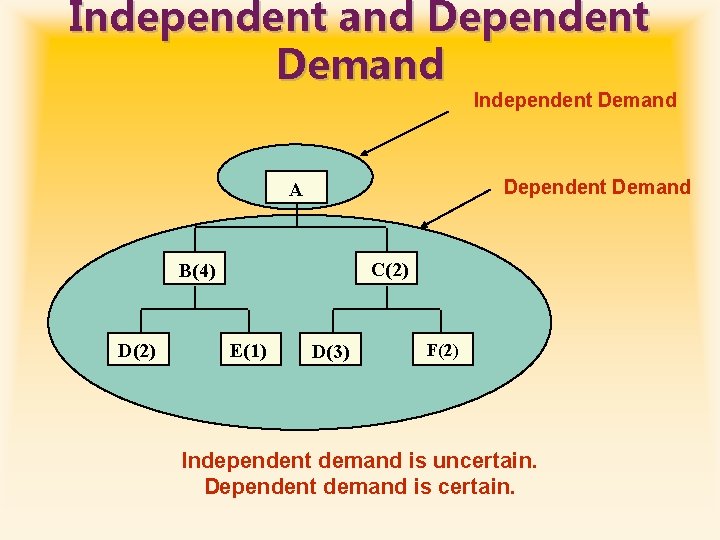

Independent and Dependent Demand Independent Demand Dependent Demand A C(2) B(4) D(2) E(1) D(3)

Independent and Dependent Demand Independent Demand Dependent Demand A C(2) B(4) D(2) E(1) D(3) F(2) Independent demand is uncertain. Dependent demand is certain.

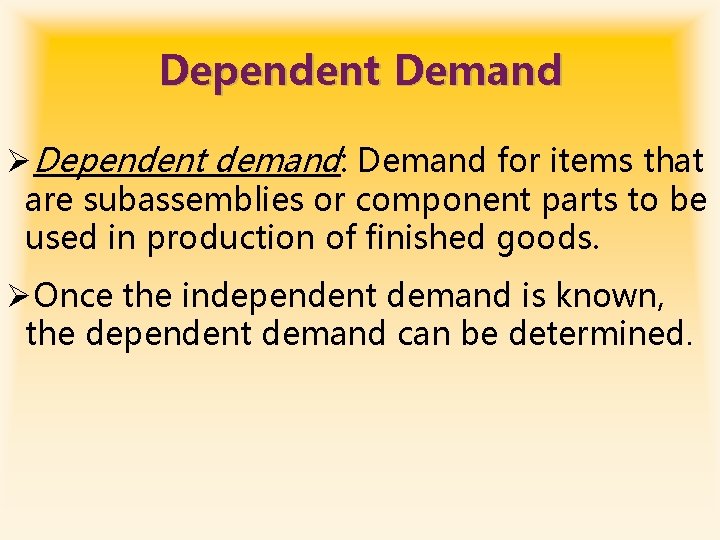

Dependent Demand ØDependent demand: Demand for items that are subassemblies or component parts to

Dependent Demand ØDependent demand: Demand for items that are subassemblies or component parts to be used in production of finished goods. ØOnce the independent demand is known, the dependent demand can be determined.

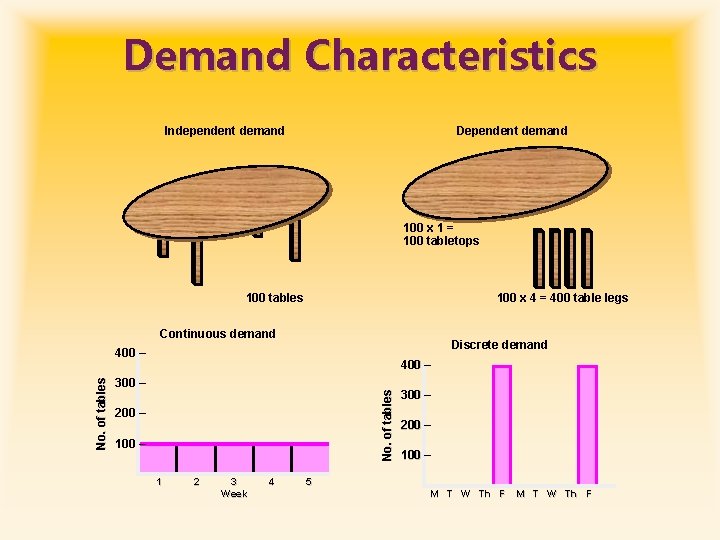

Demand Characteristics Independent demand Dependent demand 100 x 1 = 100 tabletops 100 x

Demand Characteristics Independent demand Dependent demand 100 x 1 = 100 tabletops 100 x 4 = 400 table legs 100 tables Continuous demand Discrete demand 400 – 300 – No. of tables 400 – 200 – 1 2 3 Week 4 300 – 200 – 100 – 5 M T W Th F

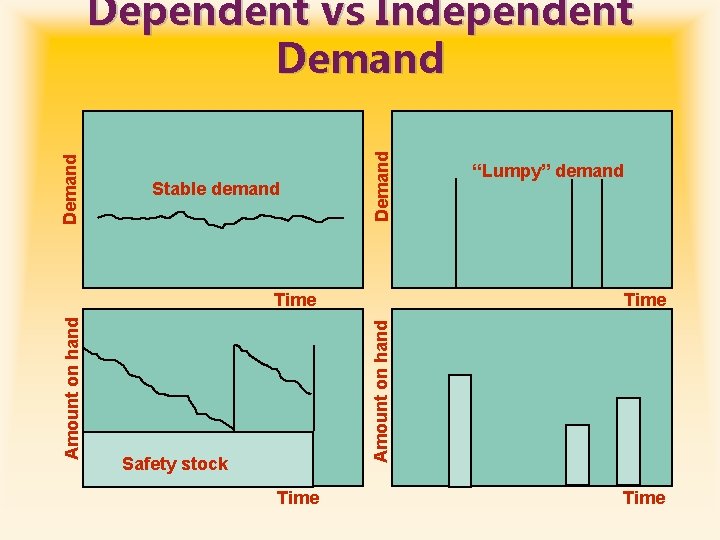

Stable demand Demand Dependent vs Independent Demand Time Amount on hand Time “Lumpy” demand

Stable demand Demand Dependent vs Independent Demand Time Amount on hand Time “Lumpy” demand Safety stock Time

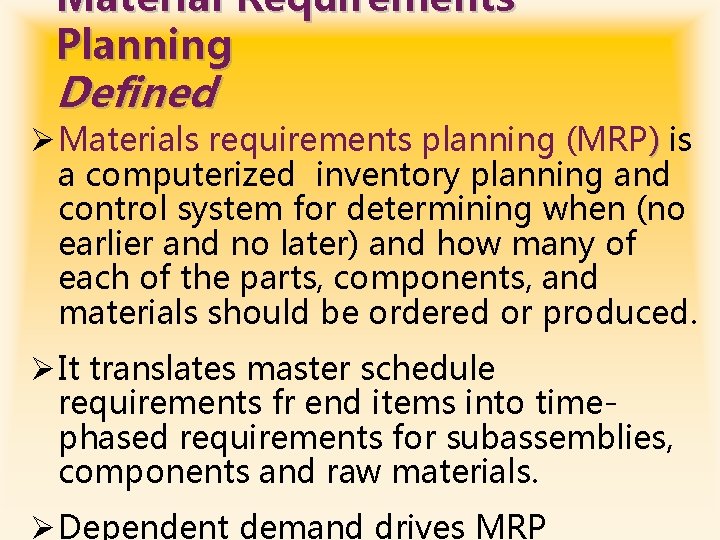

Material Requirements Planning Defined Ø Materials requirements planning (MRP) is a computerized inventory planning

Material Requirements Planning Defined Ø Materials requirements planning (MRP) is a computerized inventory planning and control system for determining when (no earlier and no later) and how many of each of the parts, components, and materials should be ordered or produced. Ø It translates master schedule requirements fr end items into timephased requirements for subassemblies, components and raw materials. Ø Dependent demand drives MRP

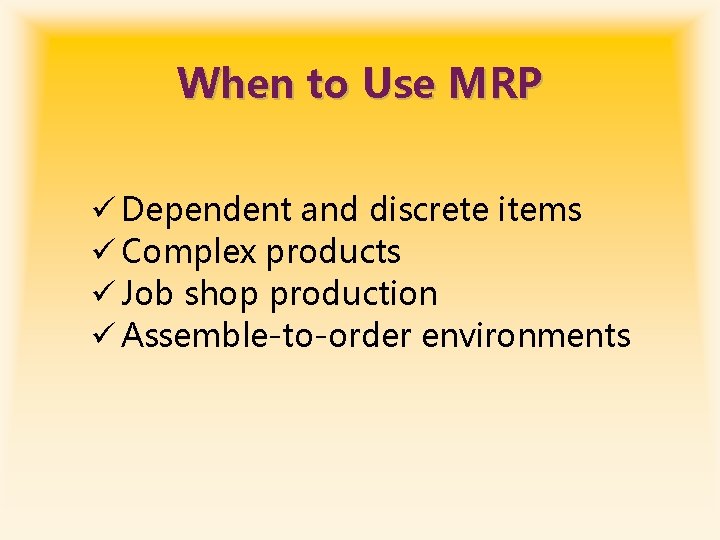

When to Use MRP ü Dependent and discrete items ü Complex products ü Job

When to Use MRP ü Dependent and discrete items ü Complex products ü Job shop production ü Assemble-to-order environments

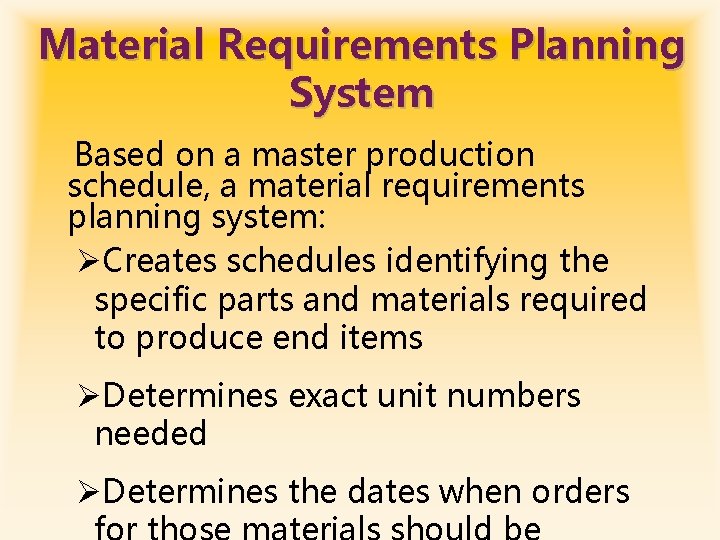

Material Requirements Planning System Based on a master production schedule, a material requirements planning

Material Requirements Planning System Based on a master production schedule, a material requirements planning system: ØCreates schedules identifying the specific parts and materials required to produce end items ØDetermines exact unit numbers needed ØDetermines the dates when orders

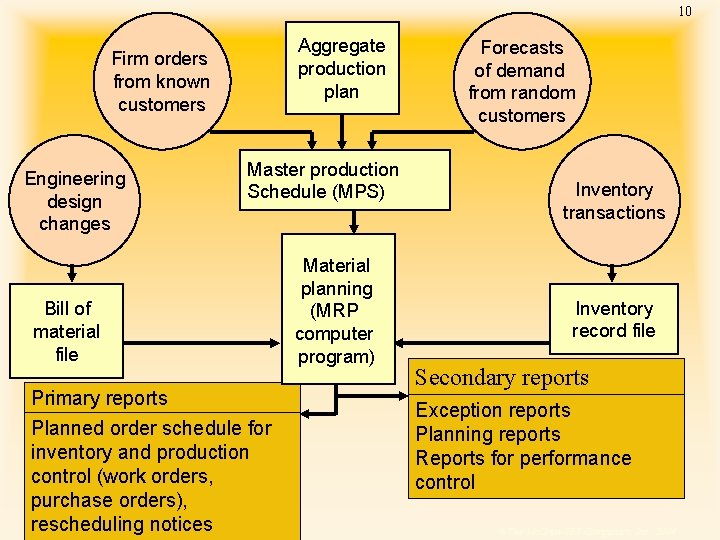

10 Aggregate production plan Firm orders from known customers Engineering design changes Master production

10 Aggregate production plan Firm orders from known customers Engineering design changes Master production Schedule (MPS) Bill of material file Primary reports Planned order schedule for inventory and production control (work orders, purchase orders), rescheduling notices Material planning (MRP computer program) Forecasts of demand from random customers Inventory transactions Inventory record file Secondary reports Exception reports Planning reports Reports for performance control ©The Mc. Graw-Hill Companies, Inc. , 2004

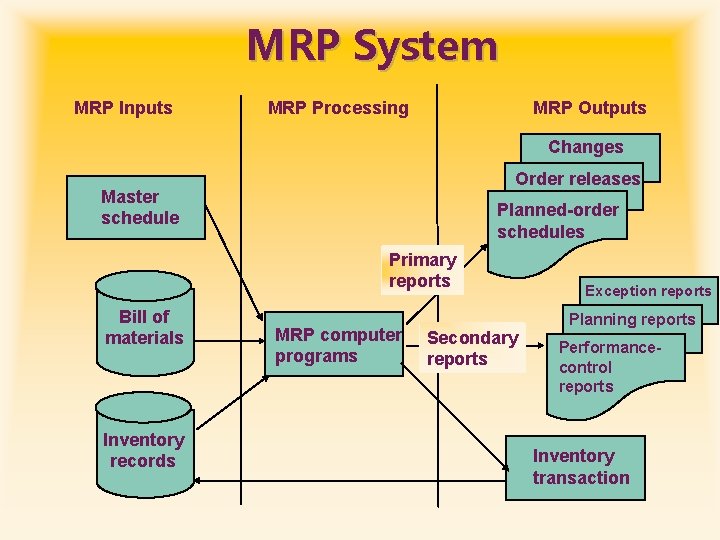

MRP System MRP Inputs MRP Processing MRP Outputs Changes Order releases Master schedule Planned-order

MRP System MRP Inputs MRP Processing MRP Outputs Changes Order releases Master schedule Planned-order schedules Primary reports Bill of materials Inventory records MRP computer programs Secondary reports Exception reports Planning reports Performancecontrol reports Inventory transaction

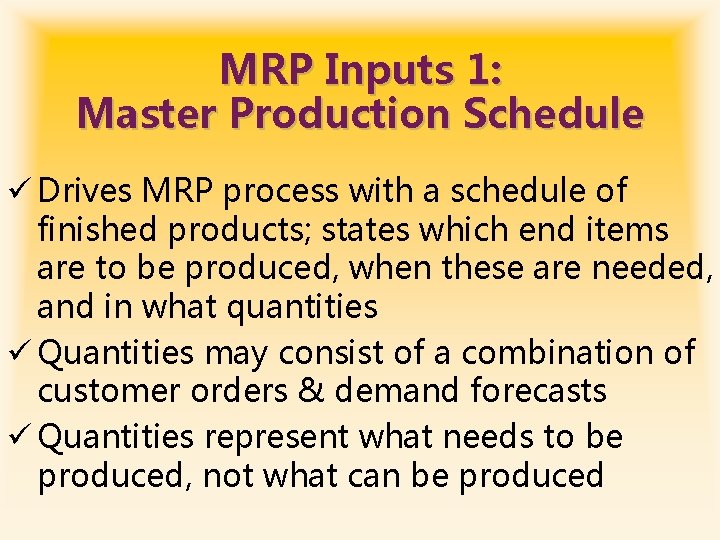

MRP Inputs 1: Master Production Schedule ü Drives MRP process with a schedule of

MRP Inputs 1: Master Production Schedule ü Drives MRP process with a schedule of finished products; states which end items are to be produced, when these are needed, and in what quantities ü Quantities may consist of a combination of customer orders & demand forecasts ü Quantities represent what needs to be produced, not what can be produced

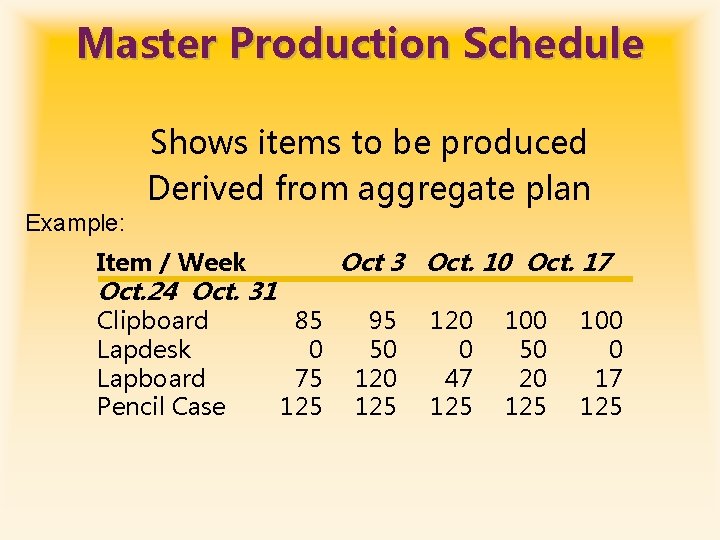

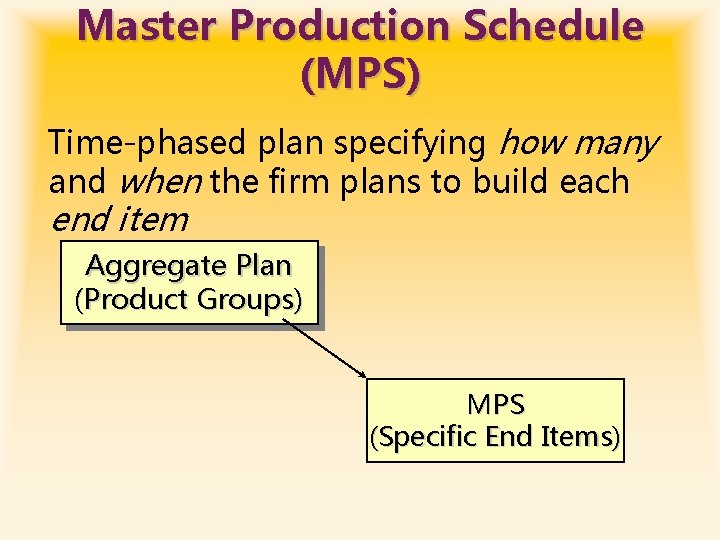

Master Production Schedule (MPS) Time-phased plan specifying how many and when the firm plans

Master Production Schedule (MPS) Time-phased plan specifying how many and when the firm plans to build each end item Aggregate Plan (Product Groups) MPS (Specific End Items)

Master Production Schedule Shows items to be produced Derived from aggregate plan Example: Oct

Master Production Schedule Shows items to be produced Derived from aggregate plan Example: Oct 3 Oct. 10 Oct. 17 Item / Week Oct. 24 Oct. 31 Clipboard Lapdesk Lapboard Pencil Case 85 0 75 125 95 50 125 120 0 47 125 100 50 20 125 100 0 17 125

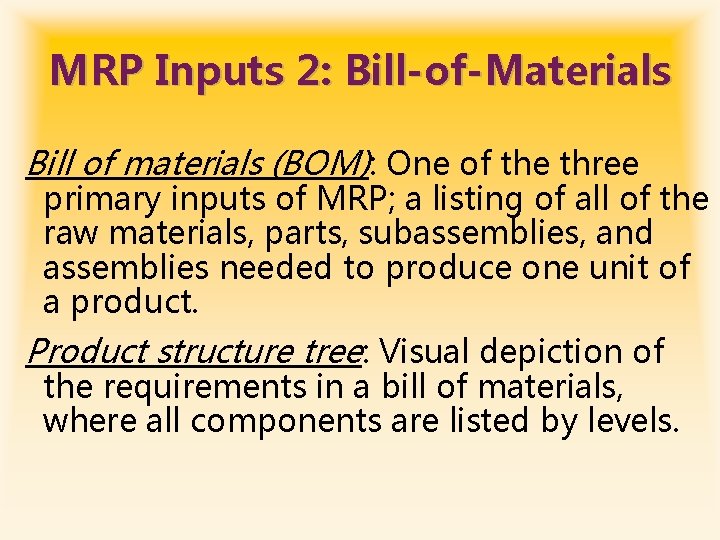

MRP Inputs 2: Bill-of-Materials Bill of materials (BOM): One of the three primary inputs

MRP Inputs 2: Bill-of-Materials Bill of materials (BOM): One of the three primary inputs of MRP; a listing of all of the raw materials, parts, subassemblies, and assemblies needed to produce one unit of a product. Product structure tree: Visual depiction of the requirements in a bill of materials, where all components are listed by levels.

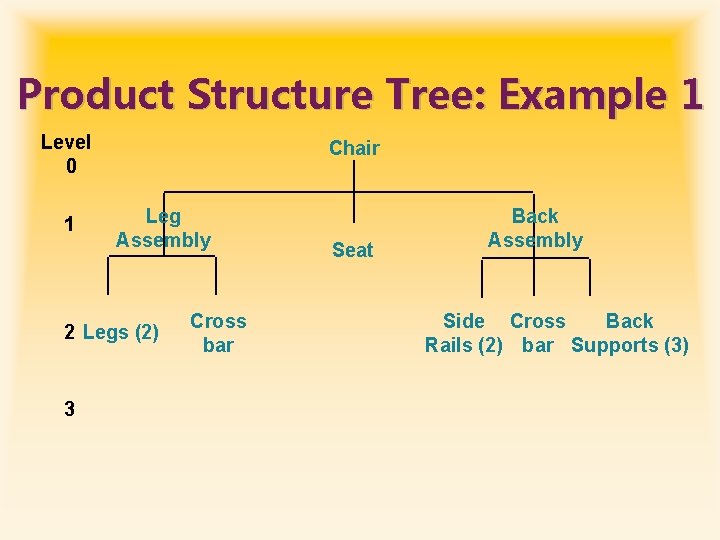

Product Structure Tree: Example 1 Level 0 1 Chair Leg Assembly 2 Legs (2)

Product Structure Tree: Example 1 Level 0 1 Chair Leg Assembly 2 Legs (2) 3 Cross bar Seat Back Assembly Side Cross Back Rails (2) bar Supports (3)

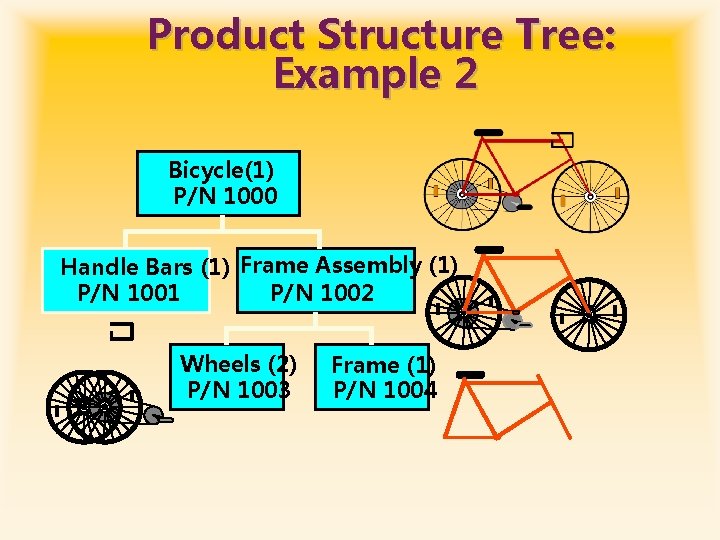

Product Structure Tree: Example 2 Bicycle(1) P/N 1000 Handle Bars (1) Frame Assembly (1)

Product Structure Tree: Example 2 Bicycle(1) P/N 1000 Handle Bars (1) Frame Assembly (1) P/N 1001 P/N 1002 Wheels (2) P/N 1003 Frame (1) P/N 1004

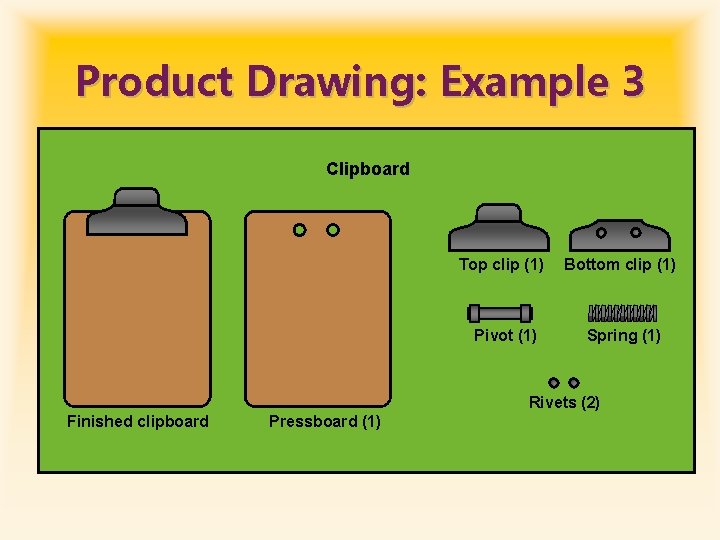

Product Drawing: Example 3 Clipboard Top clip (1) Bottom clip (1) Pivot (1) Spring

Product Drawing: Example 3 Clipboard Top clip (1) Bottom clip (1) Pivot (1) Spring (1) Rivets (2) Finished clipboard Pressboard (1)

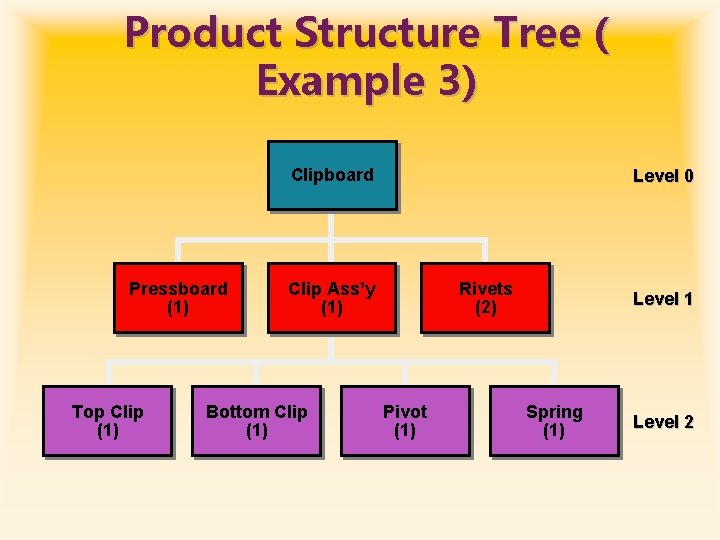

Product Structure Tree ( Example 3) Clipboard Pressboard (1) Top Clip (1) Level 0

Product Structure Tree ( Example 3) Clipboard Pressboard (1) Top Clip (1) Level 0 Clip Ass’y (1) Bottom Clip (1) Rivets (2) Pivot (1) Level 1 Spring (1) Level 2

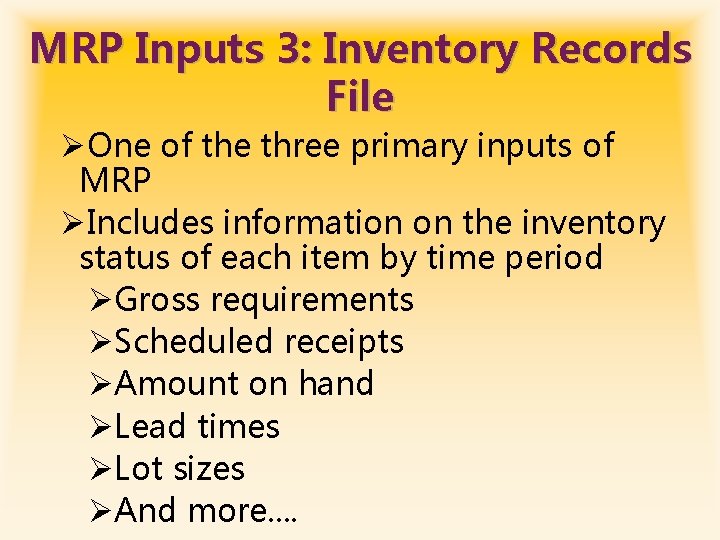

MRP Inputs 3: Inventory Records File ØOne of the three primary inputs of MRP

MRP Inputs 3: Inventory Records File ØOne of the three primary inputs of MRP ØIncludes information on the inventory status of each item by time period ØGross requirements ØScheduled receipts ØAmount on hand ØLead times ØLot sizes ØAnd more. .

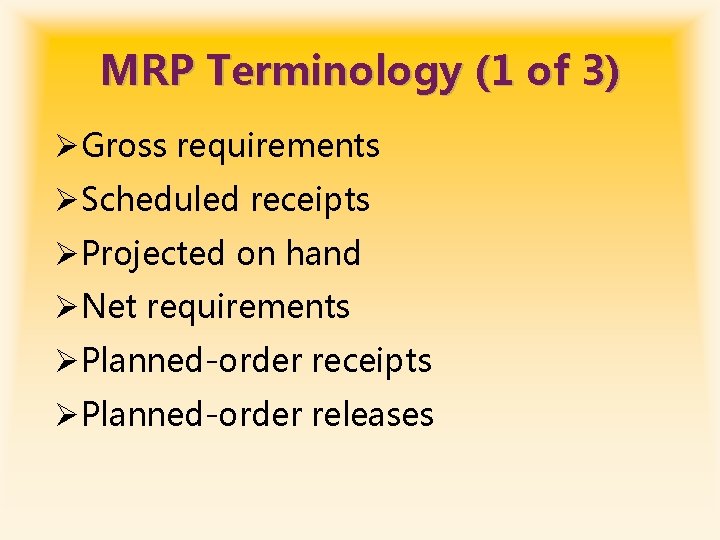

MRP Terminology (1 of 3) ØGross requirements ØScheduled receipts ØProjected on hand ØNet requirements

MRP Terminology (1 of 3) ØGross requirements ØScheduled receipts ØProjected on hand ØNet requirements ØPlanned-order receipts ØPlanned-order releases

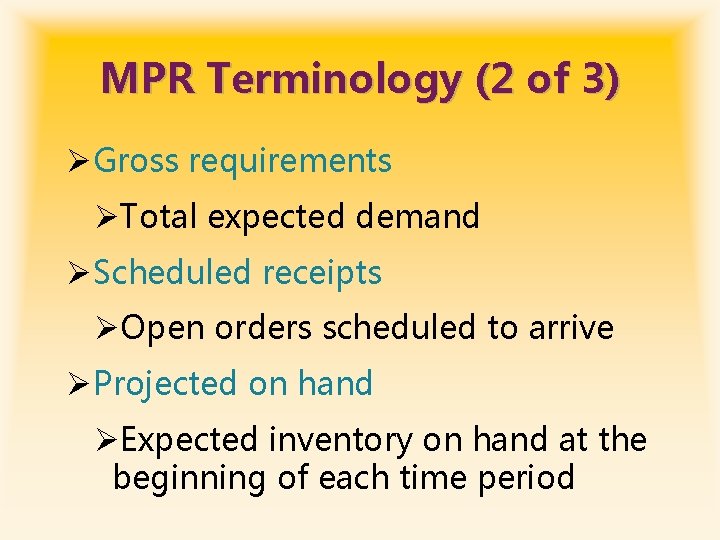

MPR Terminology (2 of 3) ØGross requirements ØTotal expected demand ØScheduled receipts ØOpen orders

MPR Terminology (2 of 3) ØGross requirements ØTotal expected demand ØScheduled receipts ØOpen orders scheduled to arrive ØProjected on hand ØExpected inventory on hand at the beginning of each time period

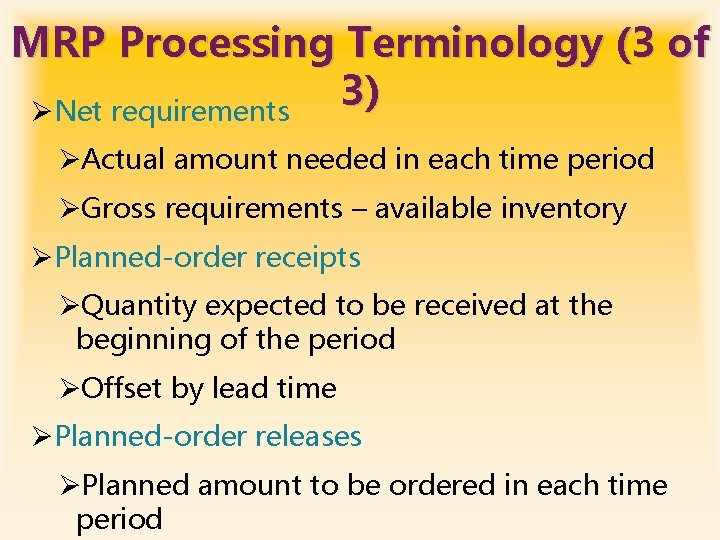

MRP Processing Terminology (3 of 3) ØNet requirements ØActual amount needed in each time

MRP Processing Terminology (3 of 3) ØNet requirements ØActual amount needed in each time period ØGross requirements – available inventory ØPlanned-order receipts ØQuantity expected to be received at the beginning of the period ØOffset by lead time ØPlanned-order releases ØPlanned amount to be ordered in each time period

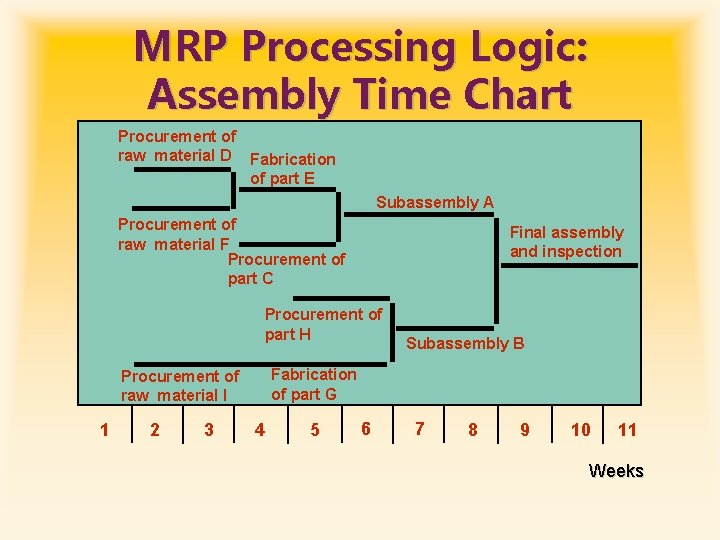

MRP Processing Logic: Assembly Time Chart Procurement of raw material D Fabrication of part

MRP Processing Logic: Assembly Time Chart Procurement of raw material D Fabrication of part E Subassembly A Procurement of raw material F Procurement of part C Final assembly and inspection Procurement of part H Fabrication of part G Procurement of raw material I 1 2 3 Subassembly B 4 5 6 7 8 9 10 11 Weeks

Calculation of Gross Requirements A C B Periods 5 S Lead time = 4

Calculation of Gross Requirements A C B Periods 5 S Lead time = 4 for A Master schedule for A Lead time = 6 for S Master schedule for S 6 7 8 9 10 11 40 50 15 Periods Gross requirements: B 1 7 10 2 40+10 8 = 50 C B 8 3 4 40 50 20 9 10 11 12 13 40 20 30 5 6 15+30 = 45 Master schedule for S sold directly 1 2 3 10 10 Therefore, these are the gross requirements for B

Basic MRP Processes 1. Exploding the bill of material 2. Netting out inventory 3.

Basic MRP Processes 1. Exploding the bill of material 2. Netting out inventory 3. Lot sizing 4. Time-phasing requirements

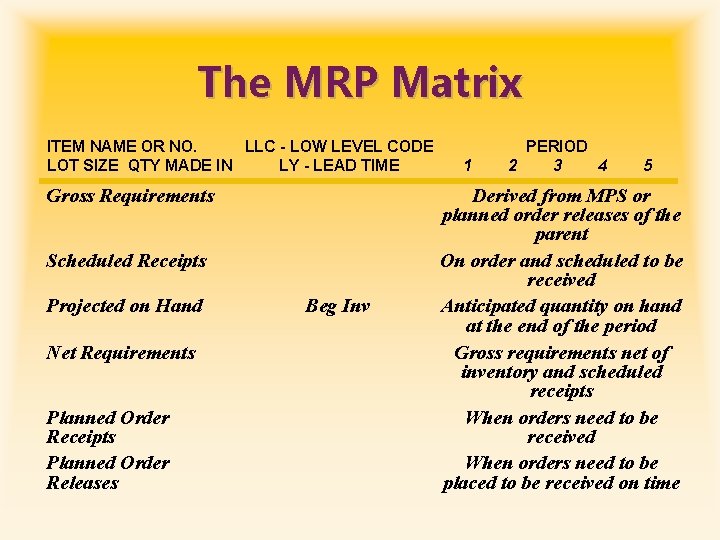

The MRP Matrix ITEM NAME OR NO. LLC - LOW LEVEL CODE LOT SIZE

The MRP Matrix ITEM NAME OR NO. LLC - LOW LEVEL CODE LOT SIZE QTY MADE IN LY - LEAD TIME Gross Requirements Scheduled Receipts Projected on Hand Net Requirements Planned Order Receipts Planned Order Releases Beg Inv 1 PERIOD 2 3 4 5 Derived from MPS or planned order releases of the parent On order and scheduled to be received Anticipated quantity on hand at the end of the period Gross requirements net of inventory and scheduled receipts When orders need to be received When orders need to be placed to be received on time

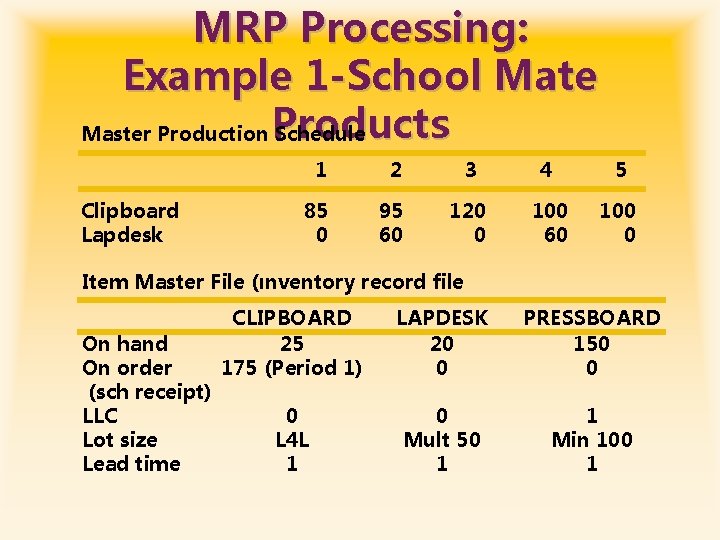

MRP Processing: Example 1 -School Mate Master Production Products Schedule Clipboard Lapdesk 1 2

MRP Processing: Example 1 -School Mate Master Production Products Schedule Clipboard Lapdesk 1 2 3 4 5 85 0 95 60 120 0 100 60 100 0 Item Master File (ınventory record file On hand On order (sch receipt) LLC Lot size Lead time CLIPBOARD 25 175 (Period 1) LAPDESK 20 0 PRESSBOARD 150 0 0 L 4 L 1 0 Mult 50 1 1 Min 100 1

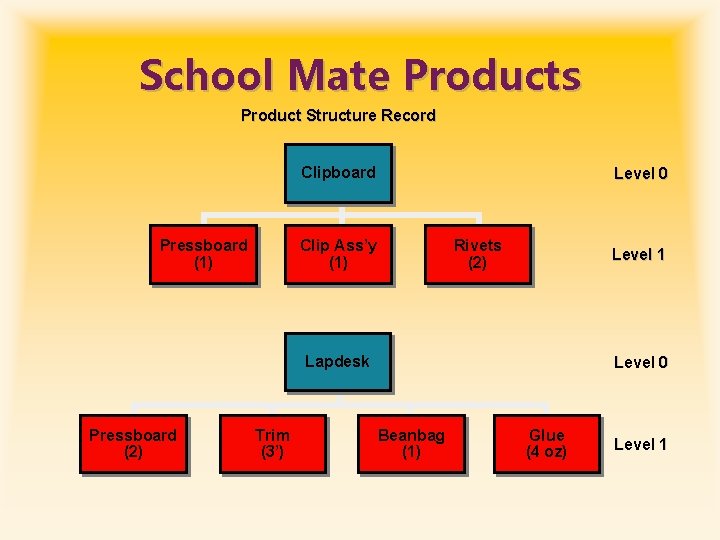

School Mate Products Product Structure Record Clipboard Pressboard (1) Level 0 Clip Ass’y (1)

School Mate Products Product Structure Record Clipboard Pressboard (1) Level 0 Clip Ass’y (1) Rivets (2) Level 1 Lapdesk Pressboard (2) Trim (3’) Level 0 Beanbag (1) Glue (4 oz) Level 1

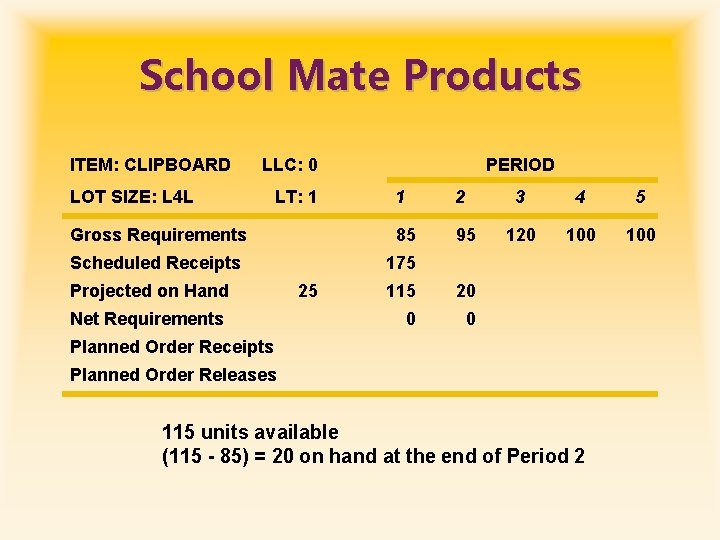

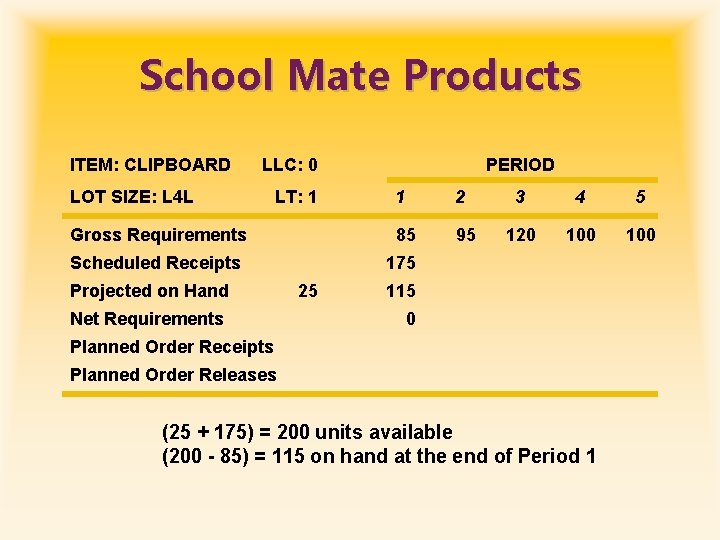

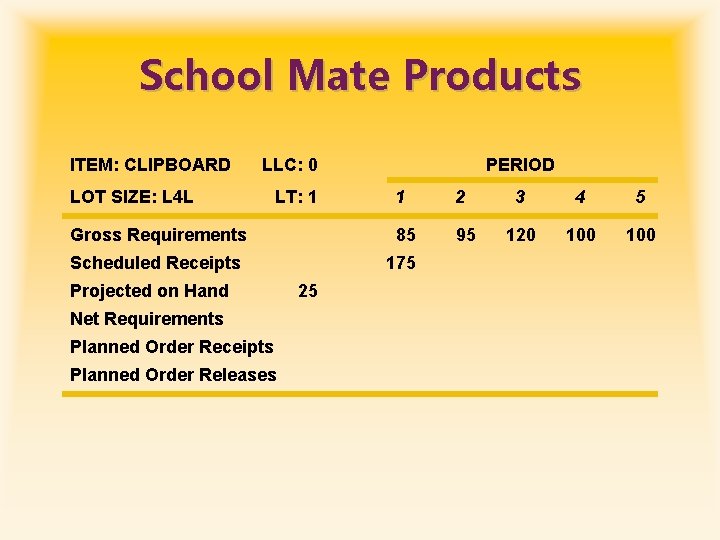

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1 PERIOD 1 2 Gross Requirements 85 95 Scheduled Receipts 175 Projected on Hand Net Requirements Planned Order Receipts Planned Order Releases 25 3 4 5 120 100

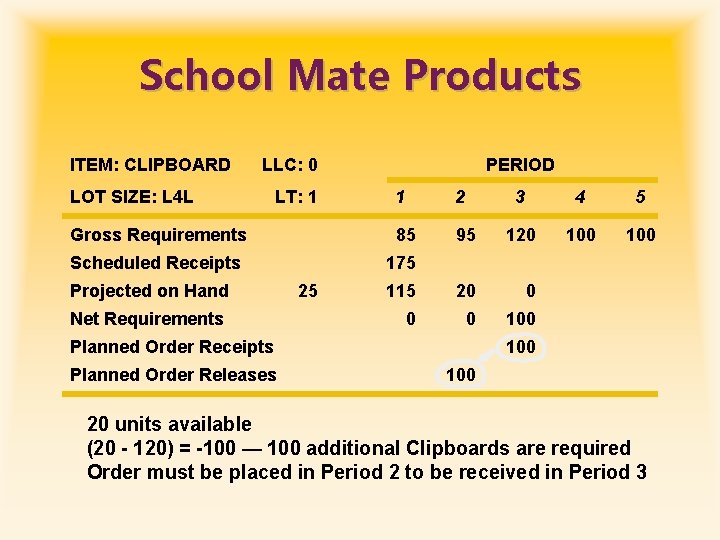

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1 PERIOD 1 2 Gross Requirements 85 95 Scheduled Receipts 175 Projected on Hand Net Requirements 25 3 4 5 120 100 115 0 Planned Order Receipts Planned Order Releases (25 + 175) = 200 units available (200 - 85) = 115 on hand at the end of Period 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1 PERIOD 1 2 Gross Requirements 85 95 Scheduled Receipts 175 Projected on Hand Net Requirements 25 115 20 0 0 3 4 5 120 100 Planned Order Receipts Planned Order Releases 115 units available (115 - 85) = 20 on hand at the end of Period 2

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1 PERIOD 1 2 Gross Requirements 85 Scheduled Receipts 175 Projected on Hand Net Requirements 25 3 4 5 95 120 100 115 20 0 100 Planned Order Receipts Planned Order Releases 100 20 units available (20 - 120) = -100 — 100 additional Clipboards are required Order must be placed in Period 2 to be received in Period 3

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1

School Mate Products ITEM: CLIPBOARD LLC: 0 LOT SIZE: L 4 L LT: 1 PERIOD 1 2 Gross Requirements 85 Scheduled Receipts 175 Projected on Hand Net Requirements 25 3 4 5 95 120 100 115 20 0 0 100 100 Planned Order Receipts Planned Order Releases 100 Following the same logic Gross Requirements in Periods 4 and 5 develop Net Requirements, Planned Order Receipts, and Planned Order Releases

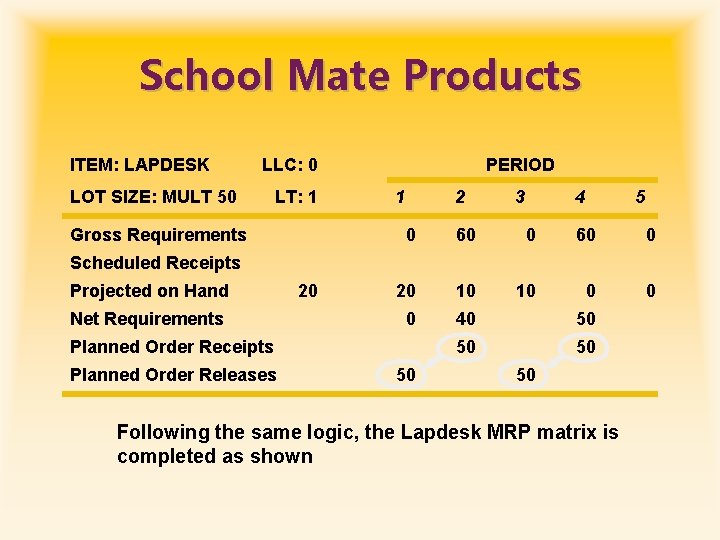

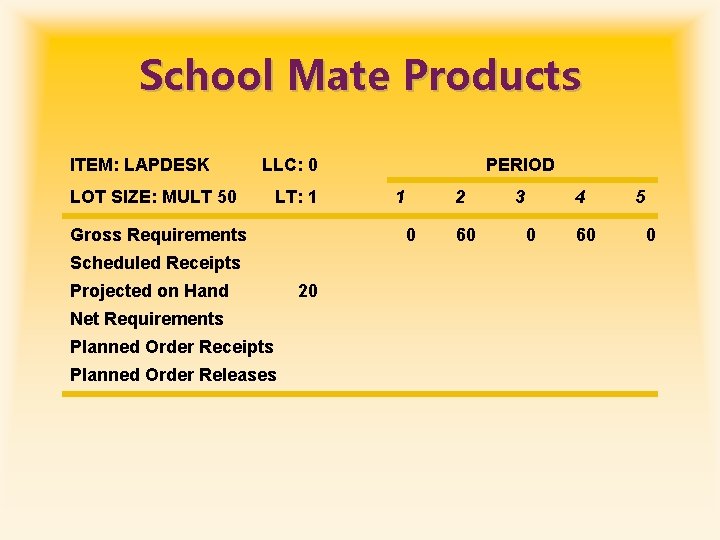

School Mate Products ITEM: LAPDESK LLC: 0 LOT SIZE: MULT 50 LT: 1 Gross

School Mate Products ITEM: LAPDESK LLC: 0 LOT SIZE: MULT 50 LT: 1 Gross Requirements Net Requirements Planned Order Receipts Planned Order Releases 1 2 0 Scheduled Receipts Projected on Hand PERIOD 20 60 3 4 0 60 5 0

School Mate Products ITEM: LAPDESK LLC: 0 LOT SIZE: MULT 50 LT: 1 Gross

School Mate Products ITEM: LAPDESK LLC: 0 LOT SIZE: MULT 50 LT: 1 Gross Requirements PERIOD 1 2 3 4 5 0 60 0 20 10 10 0 40 50 50 50 Scheduled Receipts Projected on Hand Net Requirements 20 Planned Order Receipts Planned Order Releases 50 50 Following the same logic, the Lapdesk MRP matrix is completed as shown

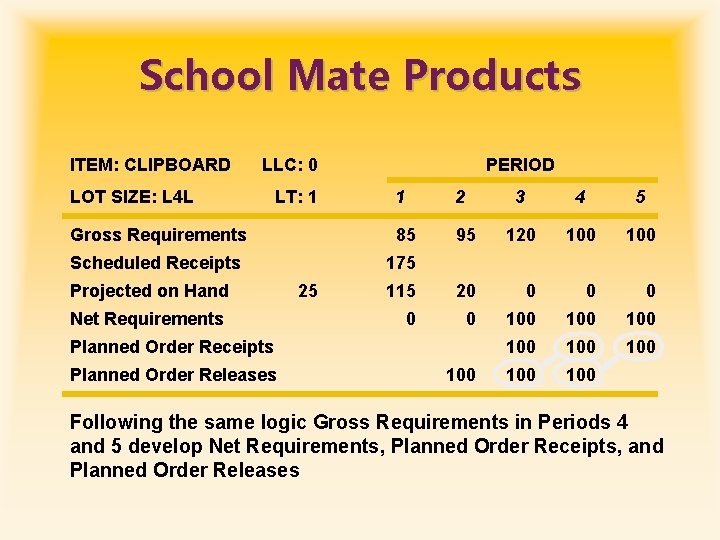

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1 1 Planned Order Releases ITEM: LAPDESK LOT SIZE: MULT 50 LLC: 0 LT: 1 Planned Order Releases 1 2 PERIOD 3 4 100 100 2 PERIOD 3 4 5 50 50 ITEM: PRESSBOARD LLC: 0 LOT SIZE: MIN 100 LT: 1 Gross Requirements Scheduled Receipts Projected on Hand 150 Net Requirements Planned Order Receipts Planned Order Releases 5 PERIOD 1 2 3

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1 1 Planned Order Releases ITEM: LAPDESK LOT SIZE: MULT 50 LLC: 0 LT: 1 Planned Order Releases ITEM: PRESSBOARD LLC: 0 LOT SIZE: MIN 100 LT: 1 Gross Requirements Scheduled Receipts Projected on Hand 150 Net Requirements Planned Order Receipts Planned Order Releases 2 PERIOD 3 4 100 100 x 1 2 PERIOD 3 4 5 4 100 5 x 1 1 50 x 2 1 100 5 50 x 2 PERIOD 2 100 3 200 0

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1

School Mate Products ITEM: CLIPBOARD LOT SIZE: L 4 L LLC: 0 LT: 1 1 Planned Order Releases ITEM: LAPDESK LOT SIZE: MULT 50 LLC: 0 LT: 1 Planned Order Releases 1 2 PERIOD 3 4 100 100 2 PERIOD 3 4 5 5 50 50 ITEM: PRESSBOARD LLC: 0 LOT SIZE: MIN 100 LT: 1 Gross Requirements Scheduled Receipts Projected on Hand 150 Net Requirements Planned Order Receipts Planned Order Releases 5 PERIOD 1 100 2 100 3 200 4 100 50 50 50 100 150 150 100 100 0 0

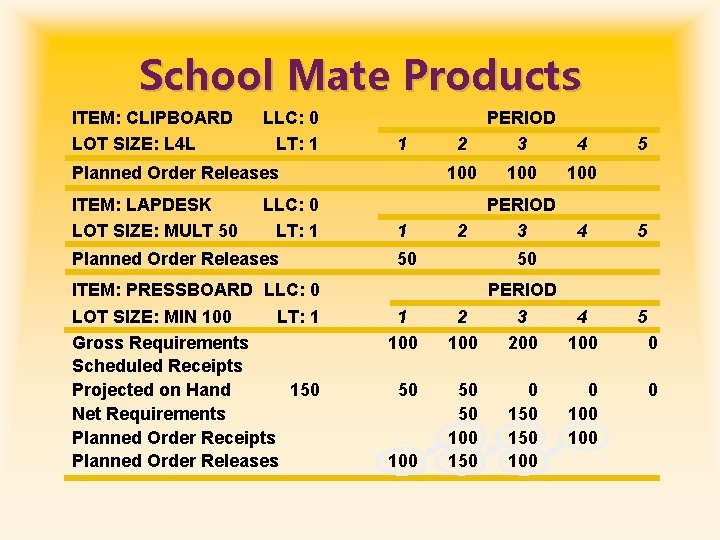

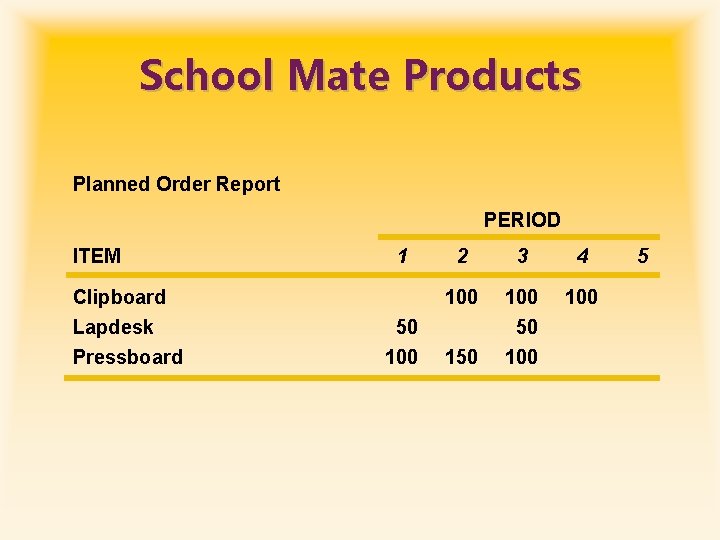

School Mate Products Planned Order Report PERIOD ITEM Clipboard Lapdesk Pressboard 1 50 100

School Mate Products Planned Order Report PERIOD ITEM Clipboard Lapdesk Pressboard 1 50 100 2 3 4 100 50 100 150 5

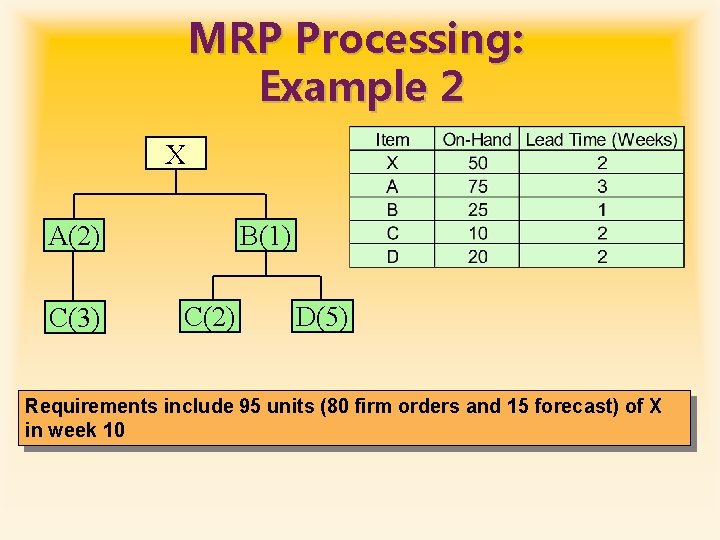

MRP Processing: Example 2 X A(2) C(3) B(1) C(2) D(5) Requirements include 95 units

MRP Processing: Example 2 X A(2) C(3) B(1) C(2) D(5) Requirements include 95 units (80 firm orders and 15 forecast) of X in week 10

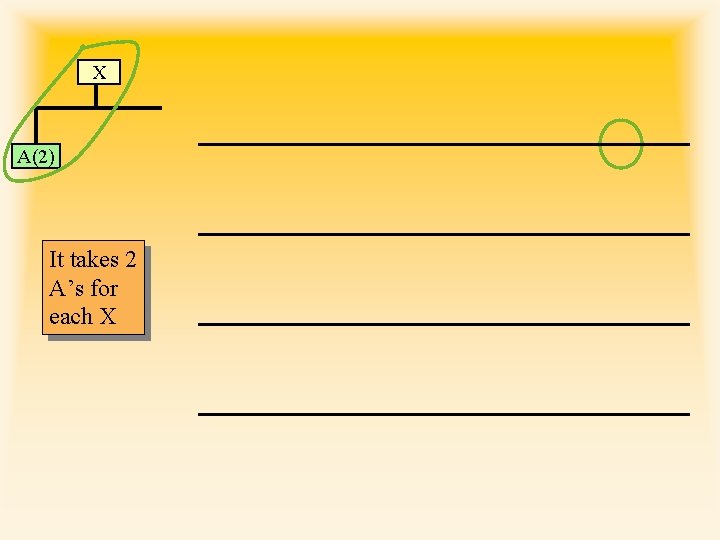

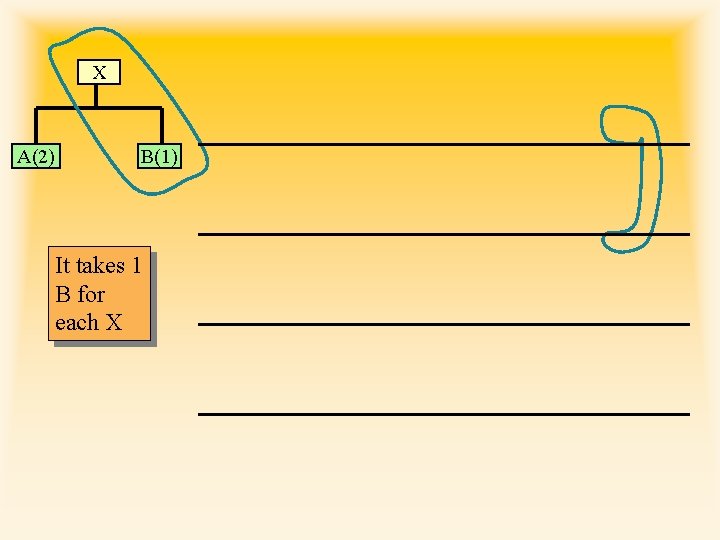

X A(2) It takes 2 A’s for each X

X A(2) It takes 2 A’s for each X

X A(2) B(1) It takes 1 B for each X

X A(2) B(1) It takes 1 B for each X

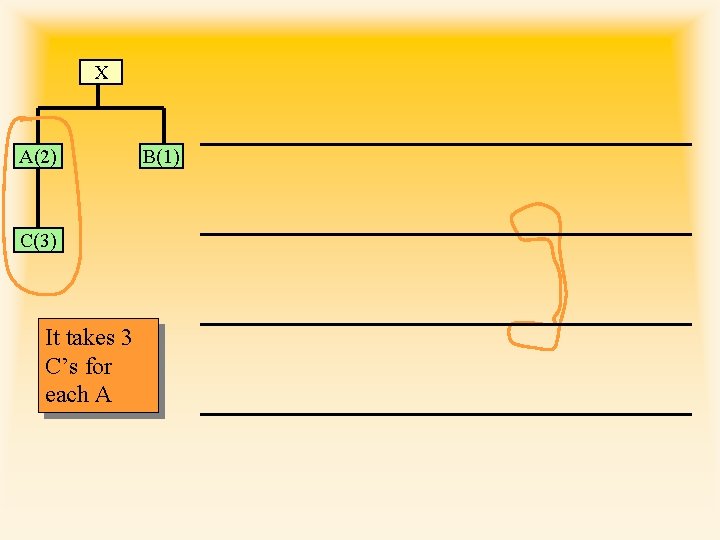

X A(2) C(3) It takes 3 C’s for each A B(1)

X A(2) C(3) It takes 3 C’s for each A B(1)

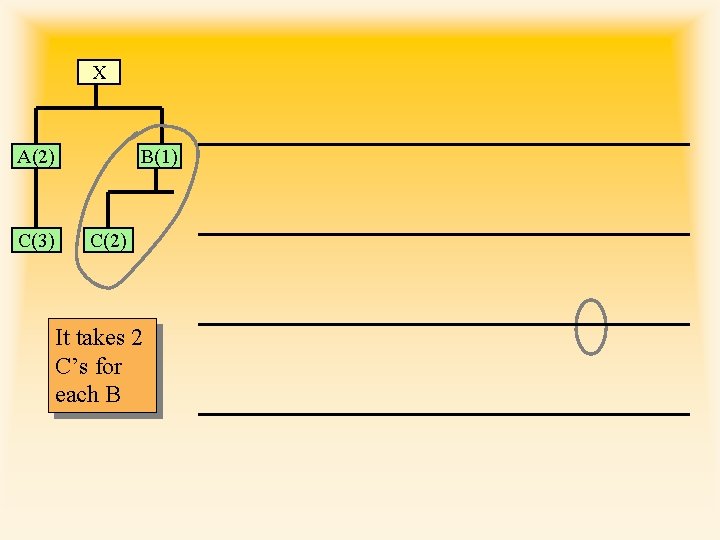

X A(2) C(3) B(1) C(2) It takes 2 C’s for each B

X A(2) C(3) B(1) C(2) It takes 2 C’s for each B

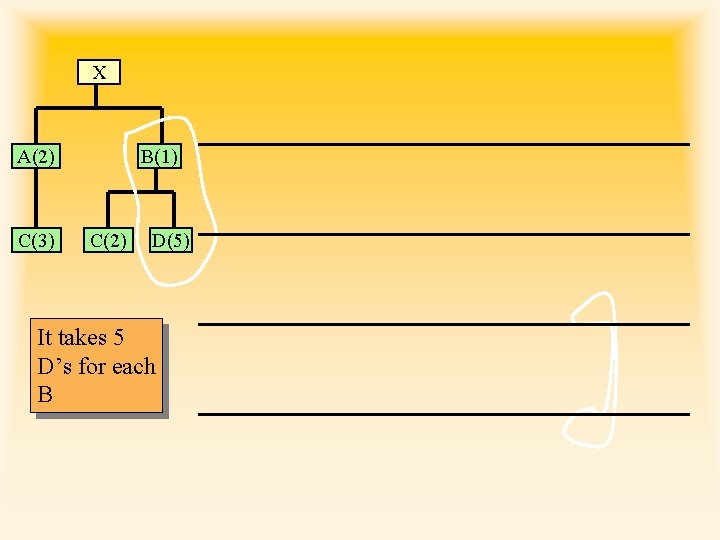

X A(2) C(3) B(1) C(2) D(5) It takes 5 D’s for each B

X A(2) C(3) B(1) C(2) D(5) It takes 5 D’s for each B

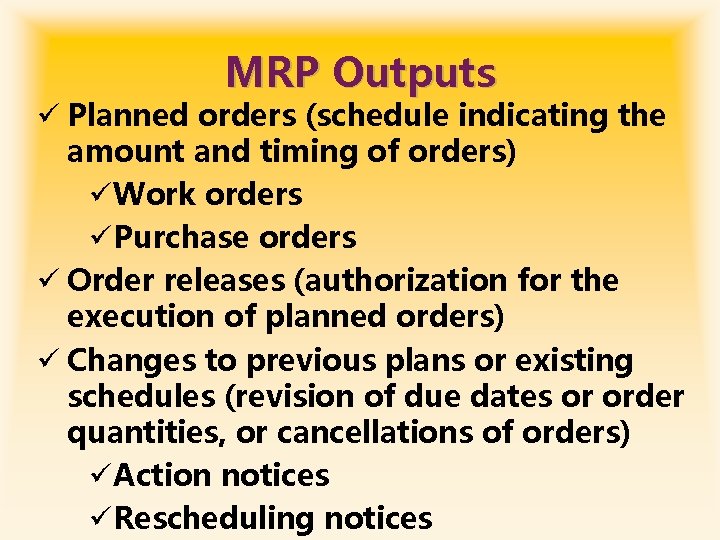

MRP Outputs ü Planned orders (schedule indicating the amount and timing of orders) üWork

MRP Outputs ü Planned orders (schedule indicating the amount and timing of orders) üWork orders üPurchase orders ü Order releases (authorization for the execution of planned orders) ü Changes to previous plans or existing schedules (revision of due dates or order quantities, or cancellations of orders) üAction notices üRescheduling notices

Updating the MRP System ØRegenerative system ØUpdates MRP records periodically ØNet-change system ØUpdates MPR

Updating the MRP System ØRegenerative system ØUpdates MRP records periodically ØNet-change system ØUpdates MPR records continuously

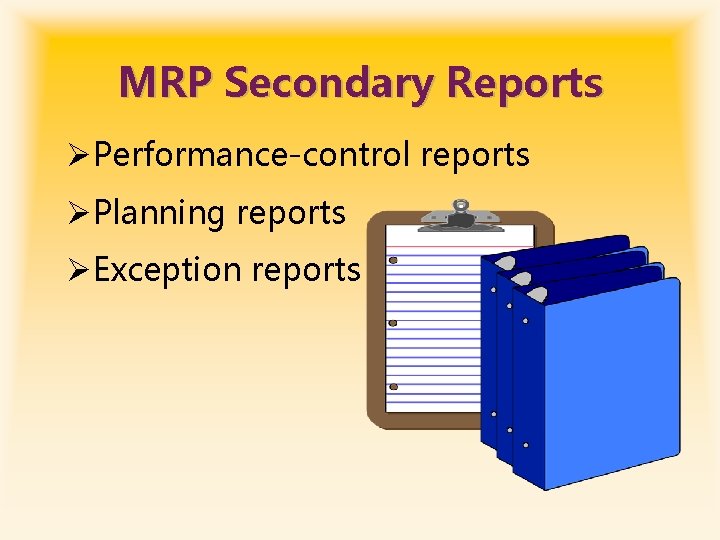

MRP Secondary Reports ØPerformance-control reports ØPlanning reports ØException reports

MRP Secondary Reports ØPerformance-control reports ØPlanning reports ØException reports

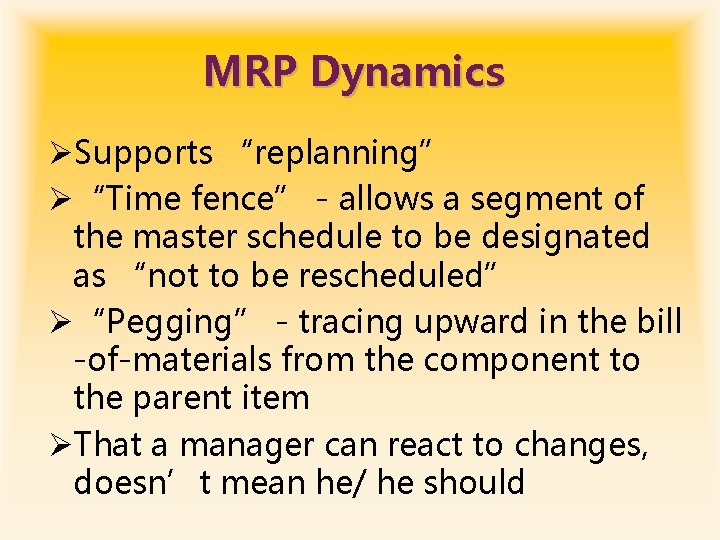

MRP Dynamics ØSupports “replanning” Ø“Time fence” - allows a segment of the master schedule

MRP Dynamics ØSupports “replanning” Ø“Time fence” - allows a segment of the master schedule to be designated as “not to be rescheduled” Ø“Pegging” - tracing upward in the bill -of-materials from the component to the parent item ØThat a manager can react to changes, doesn’t mean he/ he should

Other Considerations ØSafety Stock ØLot sizing ØLot-for-lot ordering (L 4 L) ØEconomic order quantity

Other Considerations ØSafety Stock ØLot sizing ØLot-for-lot ordering (L 4 L) ØEconomic order quantity ØPart Period Balancing ØWagner-Whitin algorithm Ø& others Which one to use? The one that is least costly! costly

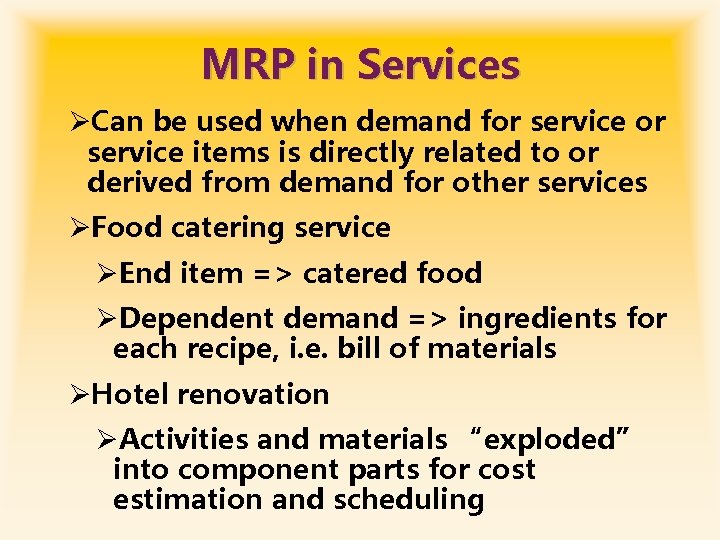

MRP in Services ØCan be used when demand for service items is directly related

MRP in Services ØCan be used when demand for service items is directly related to or derived from demand for other services ØFood catering service ØEnd item => catered food ØDependent demand => ingredients for each recipe, i. e. bill of materials ØHotel renovation ØActivities and materials “exploded” into component parts for cost estimation and scheduling

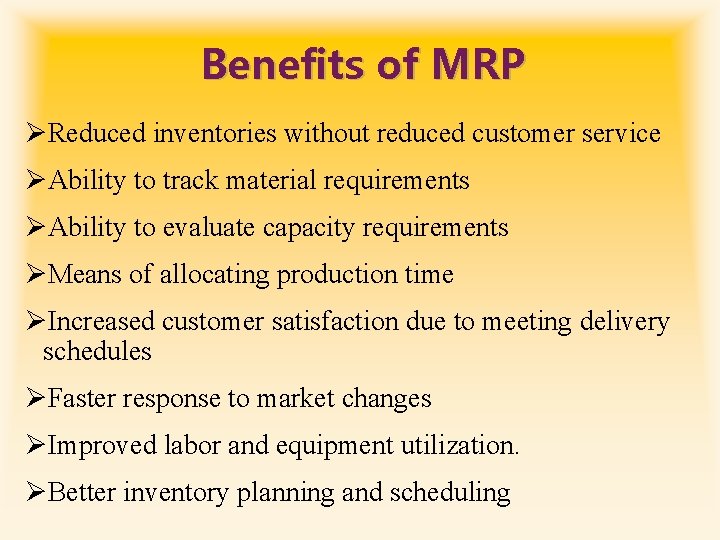

Benefits of MRP ØReduced inventories without reduced customer service ØAbility to track material requirements

Benefits of MRP ØReduced inventories without reduced customer service ØAbility to track material requirements ØAbility to evaluate capacity requirements ØMeans of allocating production time ØIncreased customer satisfaction due to meeting delivery schedules ØFaster response to market changes ØImproved labor and equipment utilization. ØBetter inventory planning and scheduling

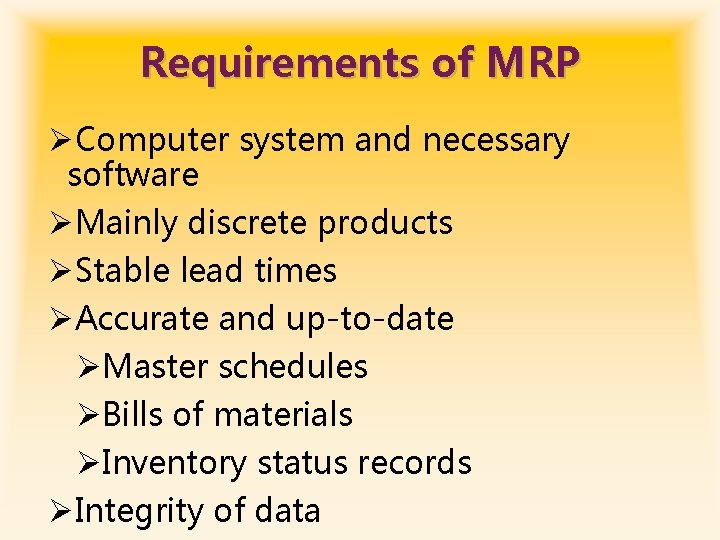

Requirements of MRP ØComputer system and necessary software ØMainly discrete products ØStable lead times

Requirements of MRP ØComputer system and necessary software ØMainly discrete products ØStable lead times ØAccurate and up-to-date ØMaster schedules ØBills of materials ØInventory status records ØIntegrity of data

Extensions of MRP

Extensions of MRP

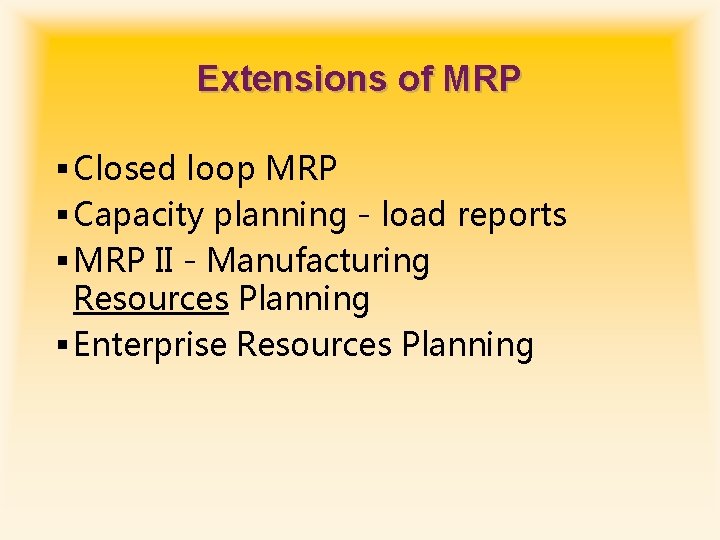

Extensions of MRP § Closed loop MRP § Capacity planning - load reports §

Extensions of MRP § Closed loop MRP § Capacity planning - load reports § MRP II - Manufacturing Resources Planning § Enterprise Resources Planning

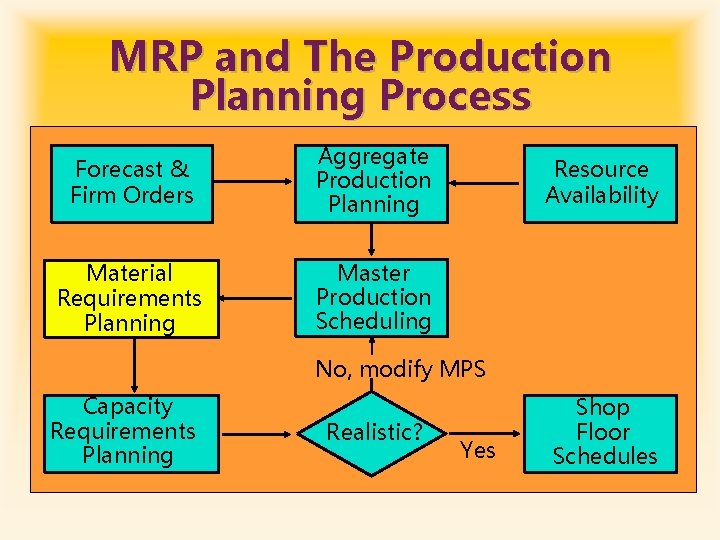

MRP and The Production Planning Process Forecast & Firm Orders Aggregate Production Planning Material

MRP and The Production Planning Process Forecast & Firm Orders Aggregate Production Planning Material Requirements Planning Master Production Scheduling Resource Availability No, modify MPS Capacity Requirements Planning Realistic? Yes Shop Floor Schedules

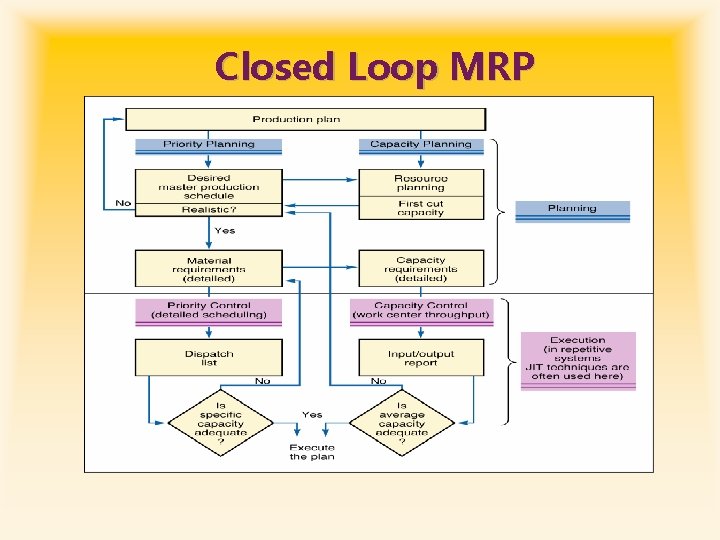

Closed Loop MRP

Closed Loop MRP

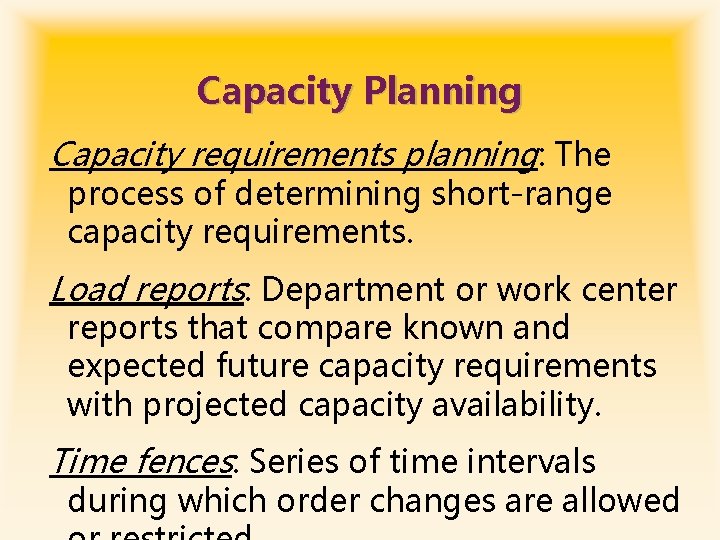

Capacity Planning Capacity requirements planning: The process of determining short-range capacity requirements. Load reports:

Capacity Planning Capacity requirements planning: The process of determining short-range capacity requirements. Load reports: Department or work center reports that compare known and expected future capacity requirements with projected capacity availability. Time fences: Series of time intervals during which order changes are allowed

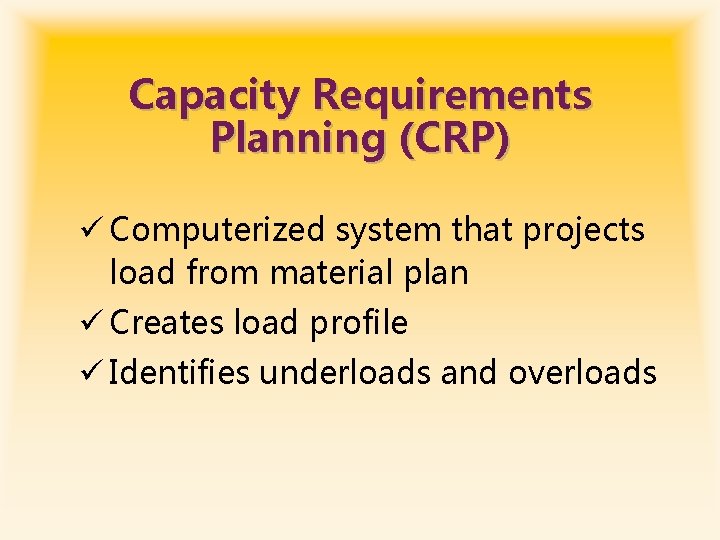

Capacity Requirements Planning (CRP) ü Computerized system that projects load from material plan ü

Capacity Requirements Planning (CRP) ü Computerized system that projects load from material plan ü Creates load profile ü Identifies underloads and overloads

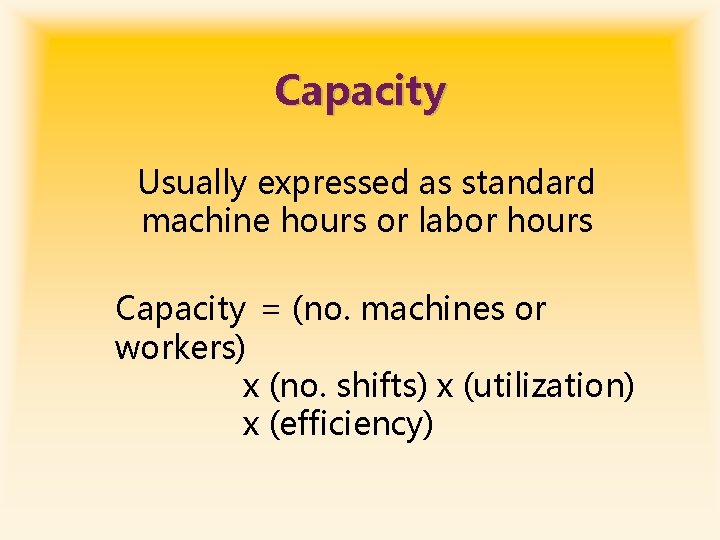

Capacity Usually expressed as standard machine hours or labor hours Capacity = (no. machines

Capacity Usually expressed as standard machine hours or labor hours Capacity = (no. machines or workers) x (no. shifts) x (utilization) x (efficiency)

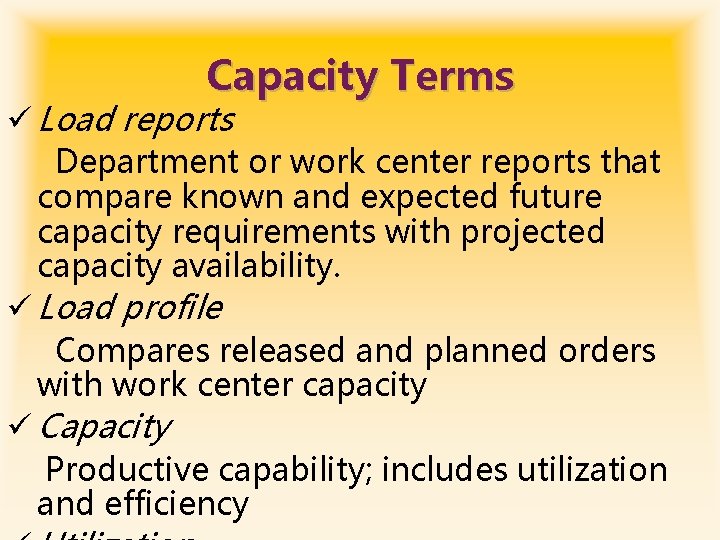

Capacity Terms ü Load reports Department or work center reports that compare known and

Capacity Terms ü Load reports Department or work center reports that compare known and expected future capacity requirements with projected capacity availability. ü Load profile Compares released and planned orders with work center capacity ü Capacity Productive capability; includes utilization and efficiency

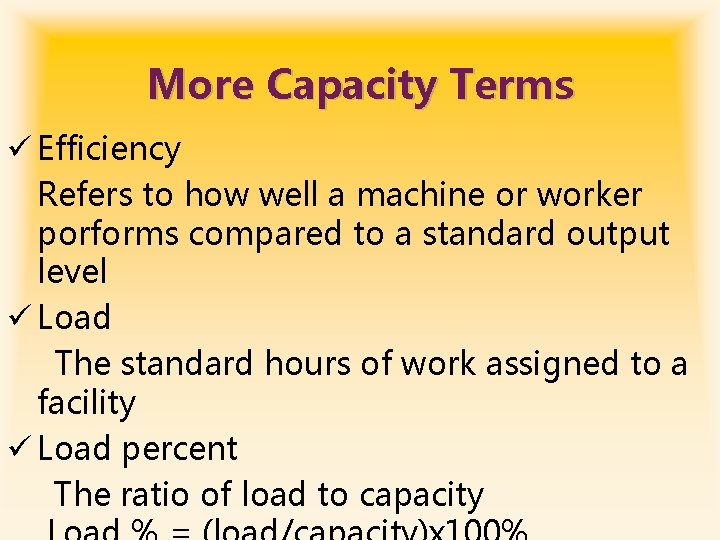

More Capacity Terms ü Efficiency Refers to how well a machine or worker porforms

More Capacity Terms ü Efficiency Refers to how well a machine or worker porforms compared to a standard output level ü Load The standard hours of work assigned to a facility ü Load percent The ratio of load to capacity

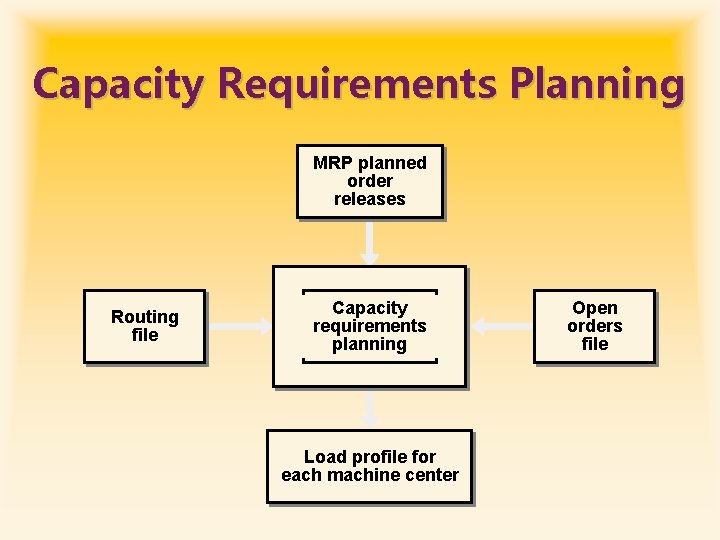

Capacity Requirements Planning MRP planned order releases Routing file Capacity requirements planning Load profile

Capacity Requirements Planning MRP planned order releases Routing file Capacity requirements planning Load profile for each machine center Open orders file

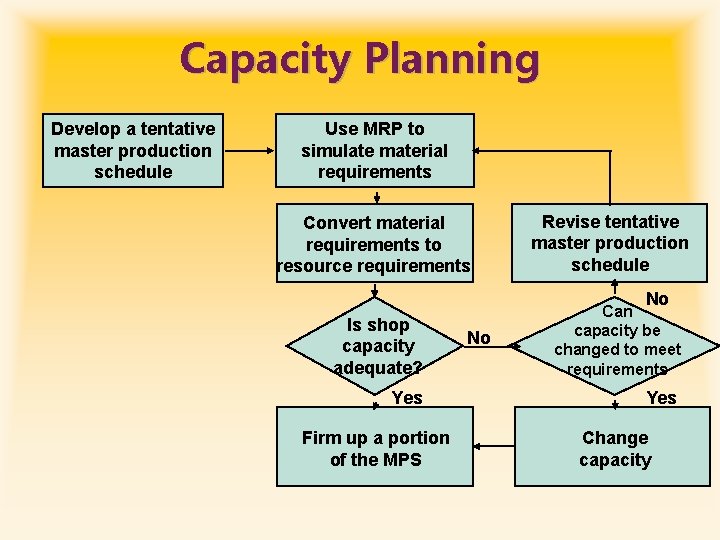

Capacity Planning Develop a tentative master production schedule Use MRP to simulate material requirements

Capacity Planning Develop a tentative master production schedule Use MRP to simulate material requirements Convert material requirements to resource requirements Revise tentative master production schedule No Is shop capacity adequate? Yes Firm up a portion of the MPS No Can capacity be changed to meet requirements Yes Change capacity

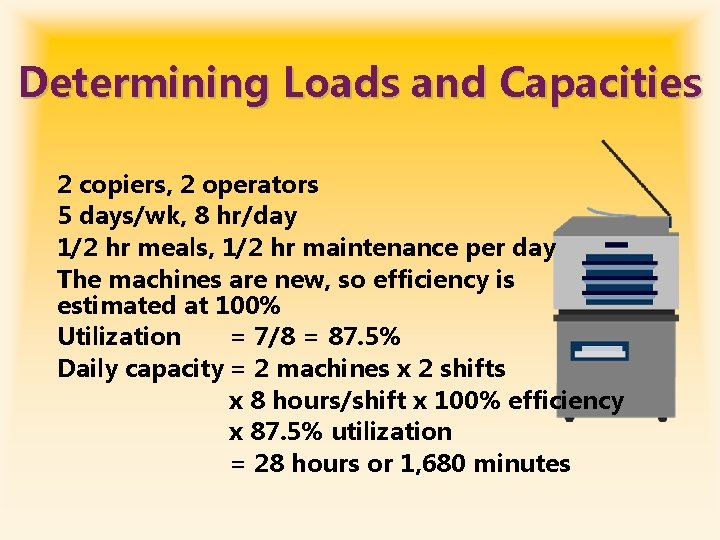

Determining Loads and Capacities 2 copiers, 2 operators 5 days/wk, 8 hr/day 1/2 hr

Determining Loads and Capacities 2 copiers, 2 operators 5 days/wk, 8 hr/day 1/2 hr meals, 1/2 hr maintenance per day The machines are new, so efficiency is estimated at 100% Utilization = 7/8 = 87. 5% Daily capacity = 2 machines x 2 shifts x 8 hours/shift x 100% efficiency x 87. 5% utilization = 28 hours or 1, 680 minutes

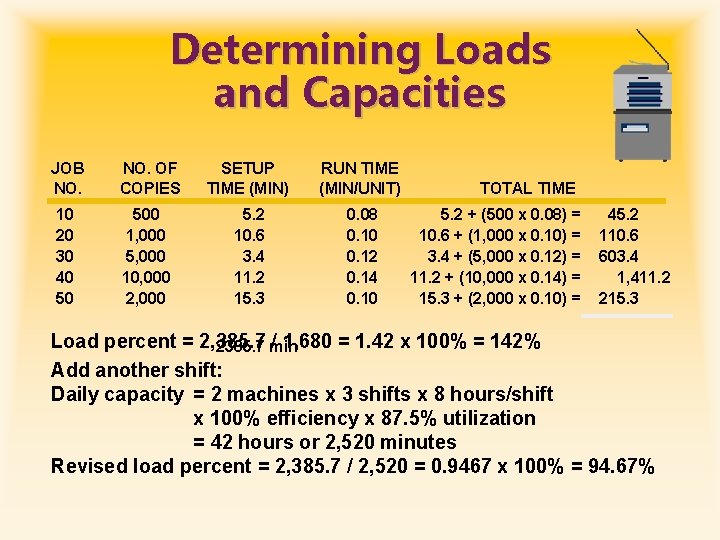

Determining Loads and Capacities JOB NO. OF COPIES SETUP TIME (MIN) RUN TIME (MIN/UNIT)

Determining Loads and Capacities JOB NO. OF COPIES SETUP TIME (MIN) RUN TIME (MIN/UNIT) 10 20 30 40 50 500 1, 000 5, 000 10, 000 2, 000 5. 2 10. 6 3. 4 11. 2 15. 3 0. 08 0. 10 0. 12 0. 14 0. 10 TOTAL TIME 5. 2 + (500 x 0. 08) = 10. 6 + (1, 000 x 0. 10) = 3. 4 + (5, 000 x 0. 12) = 11. 2 + (10, 000 x 0. 14) = 15. 3 + (2, 000 x 0. 10) = 45. 2 110. 6 603. 4 1, 411. 2 215. 3 Load percent = 2, 385. 7 / 1, 680 = 1. 42 x 100% = 142% 2385. 7 min Add another shift: Daily capacity = 2 machines x 3 shifts x 8 hours/shift x 100% efficiency x 87. 5% utilization = 42 hours or 2, 520 minutes Revised load percent = 2, 385. 7 / 2, 520 = 0. 9467 x 100% = 94. 67%

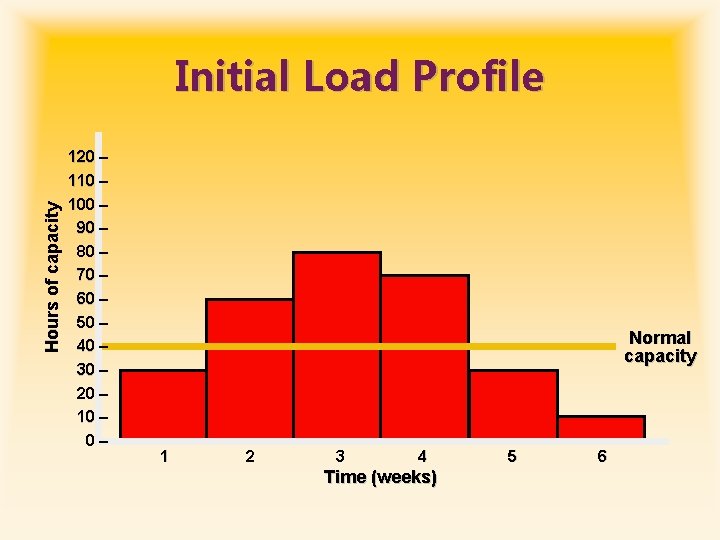

Hours of capacity Initial Load Profile 120 – 110 – 100 – 90 –

Hours of capacity Initial Load Profile 120 – 110 – 100 – 90 – 80 – 70 – 60 – 50 – 40 – 30 – 20 – 10 – 0– Normal capacity 1 2 3 4 Time (weeks) 5 6

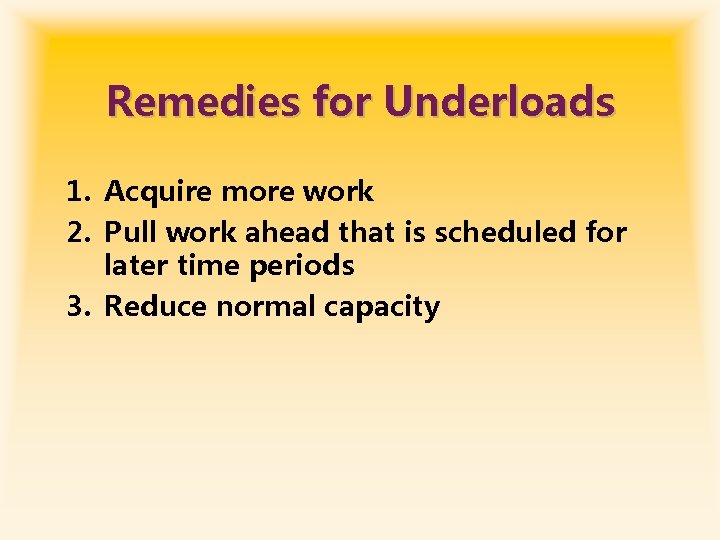

Remedies for Underloads 1. Acquire more work 2. Pull work ahead that is scheduled

Remedies for Underloads 1. Acquire more work 2. Pull work ahead that is scheduled for later time periods 3. Reduce normal capacity

Remedies for Overloads Ø Eliminate unnecessary requirements Ø Reroute jobs to alternative machines or

Remedies for Overloads Ø Eliminate unnecessary requirements Ø Reroute jobs to alternative machines or work centers Ø Change lot-sizing or safety stock requirements Ø Split lots between two or more machines Ø Send pieces to the second operation before the entire lot has completed the first operation Ø Increase normal capacity Ø Subcontract Ø Increase the efficiency of the operation Ø Push work back to later time periods

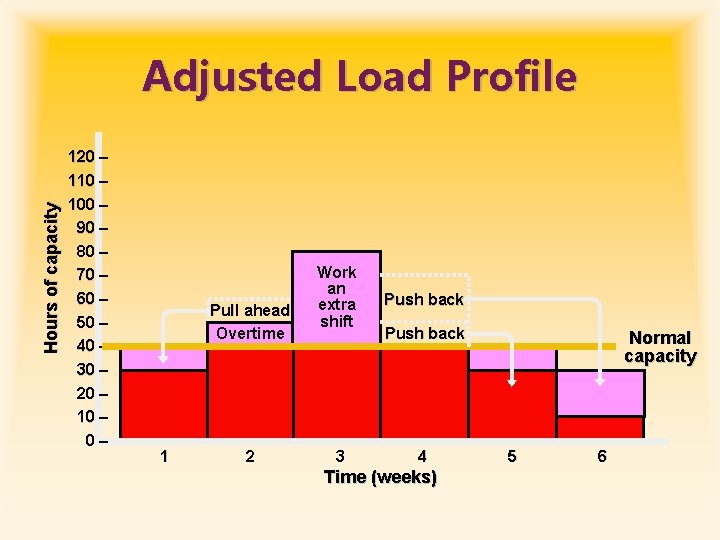

Hours of capacity Adjusted Load Profile 120 – 110 – 100 – 90 –

Hours of capacity Adjusted Load Profile 120 – 110 – 100 – 90 – 80 – 70 – 60 – 50 – 40 – 30 – 20 – 10 – 0– Pull ahead Overtime 1 2 Work an extra shift Push back 3 4 Push back Time (weeks) Normal capacity 5 6

Relaxing MRP Assumptions ü Material is not always the constraining resource ü Lead times

Relaxing MRP Assumptions ü Material is not always the constraining resource ü Lead times can vary ü Not every transaction needs to be recorded ü JIT can be used with MRP ü The shop floor may require a more sophisticated scheduling system

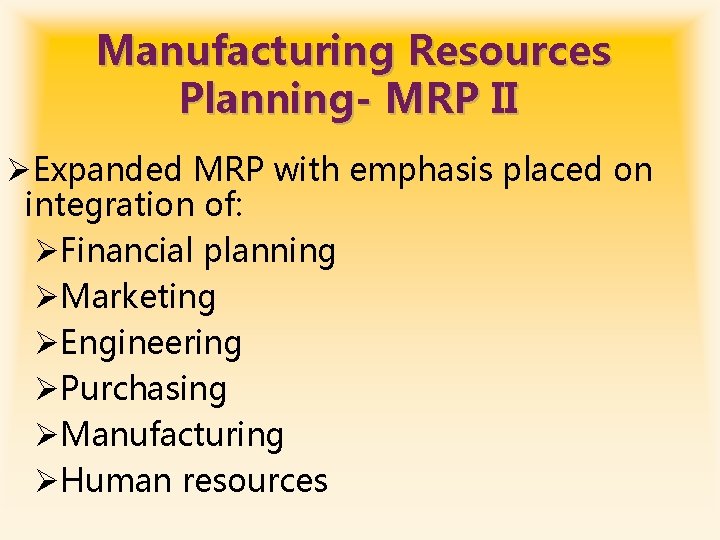

Manufacturing Resources Planning- MRP II ØExpanded MRP with emphasis placed on integration of: ØFinancial

Manufacturing Resources Planning- MRP II ØExpanded MRP with emphasis placed on integration of: ØFinancial planning ØMarketing ØEngineering ØPurchasing ØManufacturing ØHuman resources

Manufacturing Resources Planning (MRP II) ØGoal: Plan and monitor all resources of a manufacturing

Manufacturing Resources Planning (MRP II) ØGoal: Plan and monitor all resources of a manufacturing firm (closed loop): Ømanufacturing Ømarketing Øfinance Øengineering ØSimulate the manufacturing system

MRP II Manufacturing Master production schedule Marketing Production plan MRP Rough-cut capacity planning Capacity

MRP II Manufacturing Master production schedule Marketing Production plan MRP Rough-cut capacity planning Capacity req. planning Adjust production plan Yes Problems? No Requirements schedules No Problems? Adjust master schedule Market Demand Finance Yes

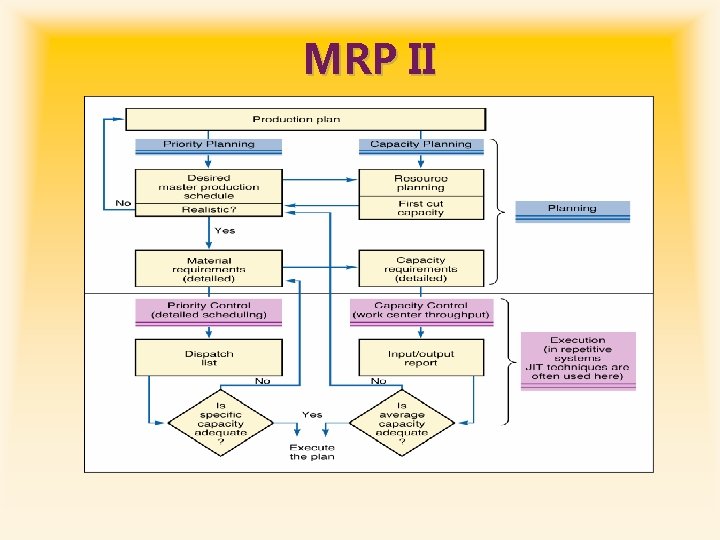

MRP II

MRP II

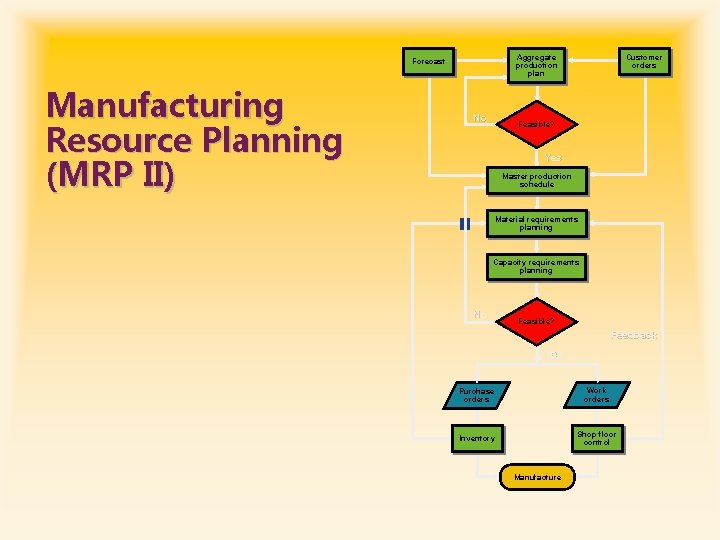

Manufacturing Resource Planning (MRP II) Customer orders Aggregate production plan Forecast No Feasible? Yes

Manufacturing Resource Planning (MRP II) Customer orders Aggregate production plan Forecast No Feasible? Yes Master production schedule Material requirements planning Capacity requirements planning No Feasible? Feedback Yes Purchase orders Work orders Inventory Shop floor control Manufacture

Manufacturing Resource Planning (MRP II) Aggregate production plan Forecast No Customer orders Aggregate production

Manufacturing Resource Planning (MRP II) Aggregate production plan Forecast No Customer orders Aggregate production plan Forecast No Feasible? Customer orders Yes Master production schedule Material requirements planning Capacity requirements planning Feasible? No Feasible? Feedback Yes Master production schedule Yes Purchase orders Work orders Inventory Shop floor control Manufacture

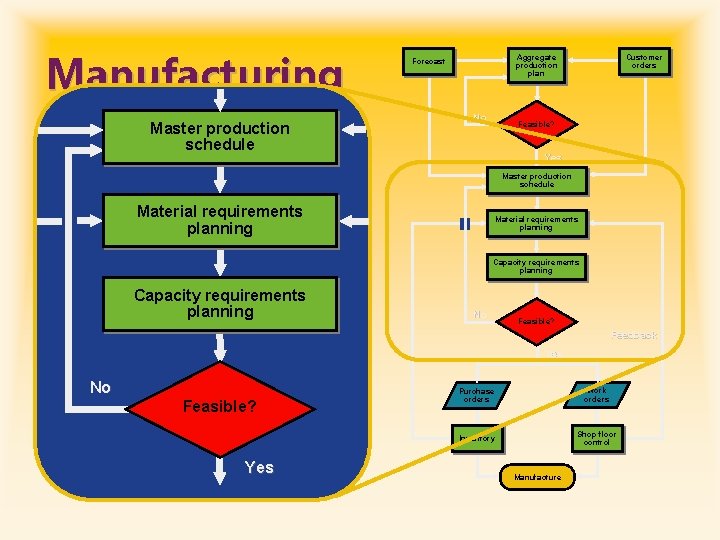

Manufacturing Resource Planning (MRP II) Master production schedule Customer orders Aggregate production plan Forecast

Manufacturing Resource Planning (MRP II) Master production schedule Customer orders Aggregate production plan Forecast No Feasible? Yes Master production schedule Material requirements planning Capacity requirements planning No Feasible? Feedback Yes No Feasible? Yes Purchase orders Work orders Inventory Shop floor control Manufacture

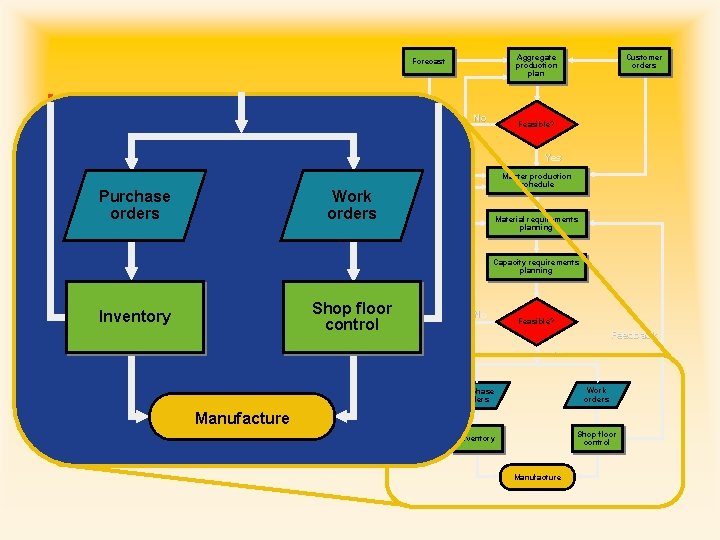

Manufacturing Resource Planning (MRP II) Purchase orders Customer orders Aggregate production plan Forecast No

Manufacturing Resource Planning (MRP II) Purchase orders Customer orders Aggregate production plan Forecast No Feasible? Yes Master production schedule Work orders Material requirements planning Capacity requirements planning Shop floor control Inventory No Feasible? Feedback Yes Purchase orders Work orders Inventory Shop floor control Manufacture

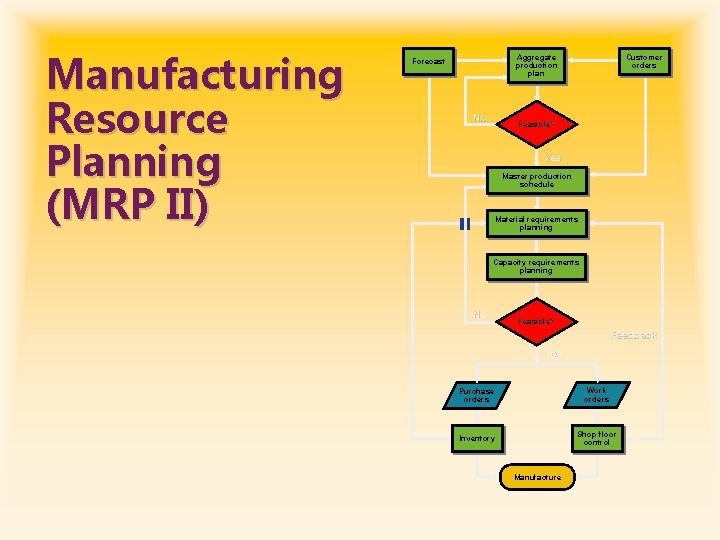

Manufacturing Resource Planning (MRP II) Customer orders Aggregate production plan Forecast No Feasible? Yes

Manufacturing Resource Planning (MRP II) Customer orders Aggregate production plan Forecast No Feasible? Yes Master production schedule Material requirements planning Capacity requirements planning No Feasible? Feedback Yes Purchase orders Work orders Inventory Shop floor control Manufacture

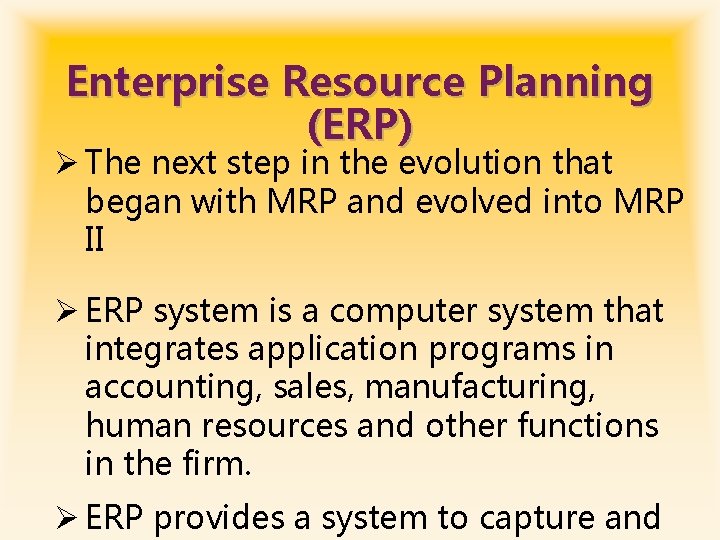

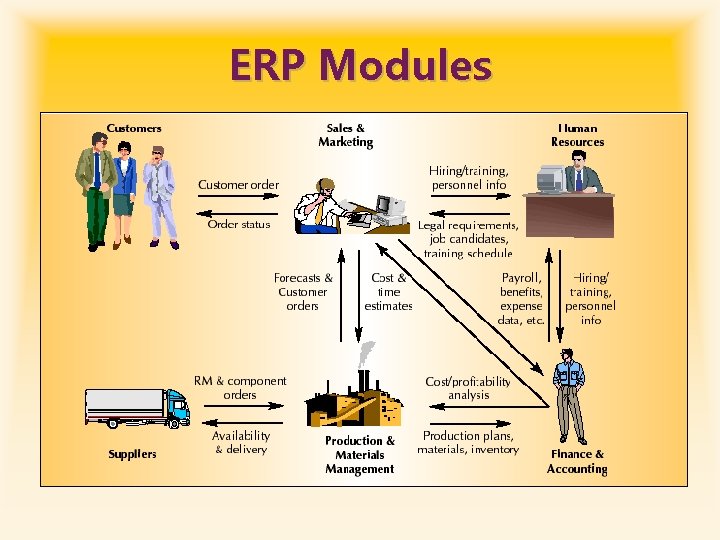

Enterprise Resource Planning (ERP) Ø The next step in the evolution that began with

Enterprise Resource Planning (ERP) Ø The next step in the evolution that began with MRP and evolved into MRP II Ø ERP system is a computer system that integrates application programs in accounting, sales, manufacturing, human resources and other functions in the firm. Ø ERP provides a system to capture and

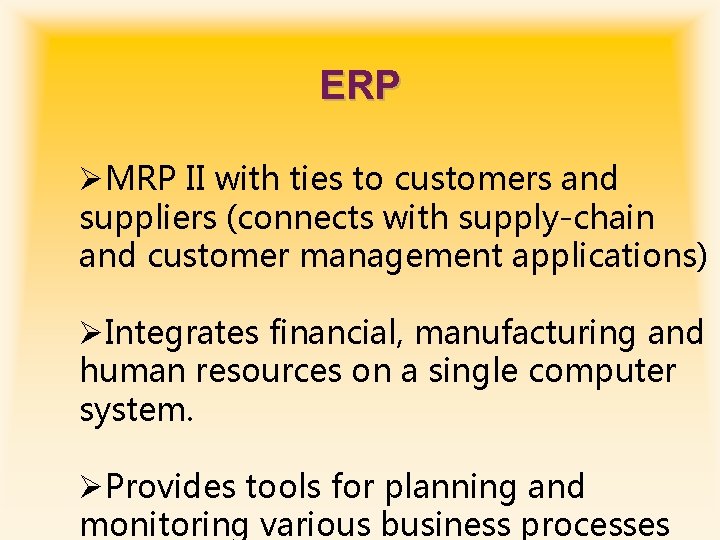

ERP ØMRP II with ties to customers and suppliers (connects with supply-chain and customer

ERP ØMRP II with ties to customers and suppliers (connects with supply-chain and customer management applications) ØIntegrates financial, manufacturing and human resources on a single computer system. ØProvides tools for planning and monitoring various business processes

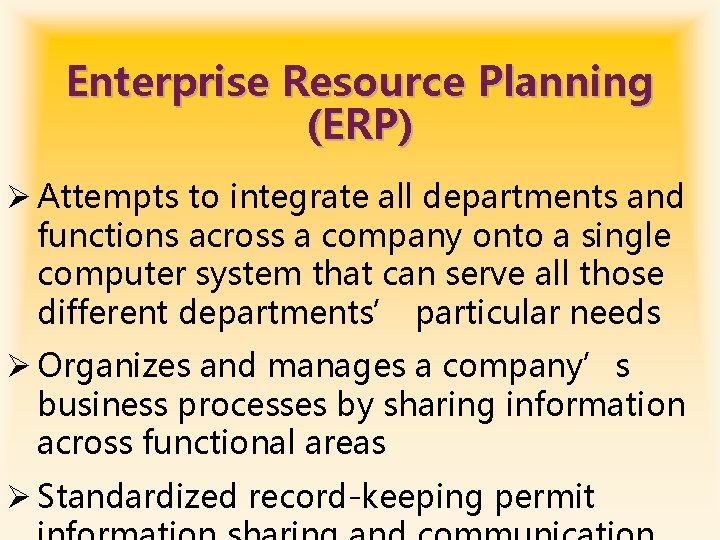

Enterprise Resource Planning (ERP) Ø Attempts to integrate all departments and functions across a

Enterprise Resource Planning (ERP) Ø Attempts to integrate all departments and functions across a company onto a single computer system that can serve all those different departments’ particular needs Ø Organizes and manages a company’s business processes by sharing information across functional areas Ø Standardized record-keeping permit

Enterprise Resource Planning ERP Such an integration is accomplished through a database shared by

Enterprise Resource Planning ERP Such an integration is accomplished through a database shared by all the application programs

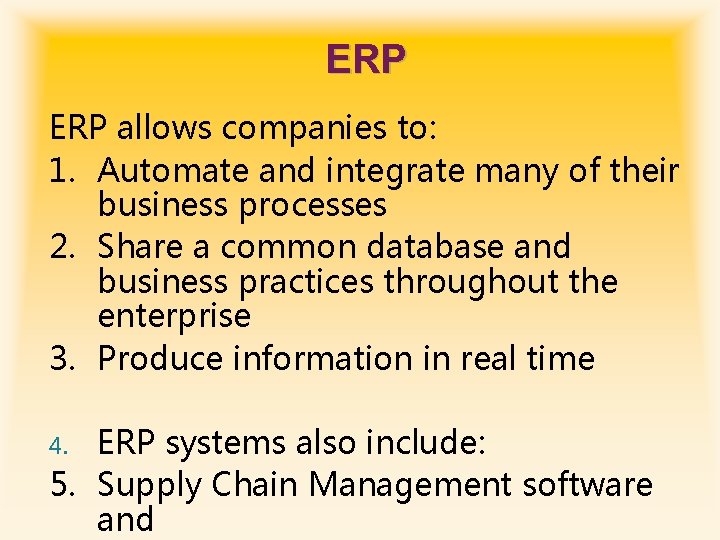

ERP allows companies to: 1. Automate and integrate many of their business processes 2.

ERP allows companies to: 1. Automate and integrate many of their business processes 2. Share a common database and business practices throughout the enterprise 3. Produce information in real time ERP systems also include: 5. Supply Chain Management software and 4.

ERP Modules

ERP Modules

ERP’s Central Database Finance & Accounting Sales & Marketing ERP Data Repository Human Resources

ERP’s Central Database Finance & Accounting Sales & Marketing ERP Data Repository Human Resources Production & Materials Management

ERP Strategy Considerations ØHigh initial cost ØHigh cost to maintain ØFuture upgrades ØTraining

ERP Strategy Considerations ØHigh initial cost ØHigh cost to maintain ØFuture upgrades ØTraining
