PROTECH CONSULTANTS PVT LTD Corporate Presentation Practicing Innovation

- Slides: 30
PROTECH CONSULTANTS PVT. LTD. Corporate Presentation Practicing Innovation leads to Success
PRELUDE § A Medium sized Engineering Consultancy Company serving the Chemical and Petrochemical Industry. § Founded in 1986 by experienced Chemical Engineering Professionals. § Successfully Commissioned several Process Plants in India and also abroad § Located in Chennai DIRECTORS R. NARASIMHAN A Chemical Engineer having over 37 years industrial experience. He has wide experience in Chlor Alkali, technical grade Pesticides & formulation and implementing projects. Dr. N. RANGAPRASAD A Chemical Engineer with PG from IIS, Bangalore and Doctorate from University of Oklahama, USA having over 35 years experience in plant & process design, supervision of erection and commissioning. He has specialized in developing engineering concepts for various projects. R. VENKATKRISHNA A Chemical Engineer with UG from REC Trichy and having over 14 years experience in Engineering, Procurement and Project Management. 2
OFFICE OVERVIEW Reception Conference Room Engineering Department CAD Department 3
Engineering Capacity Engg. Services Offered PROTECH has § § About 25000 Process/ Project Engineering Hours per annum. About 20000 Mechanical Engineering Hours per annum § About 35000 Piping Engineering / drafting Hours per annum. § About 7000 Electrical Engineering Hours per annum. § § About 20000 Civil Engineering Hours per annum. About 10000 Instrumentation Engineering Hours per annum. § Pre-investment Studies § Basic Engineering § Detailed Engineering § Project Management § Procurement Assistance § Construction and Commissioning assistance § Turnkey supply of systems 4

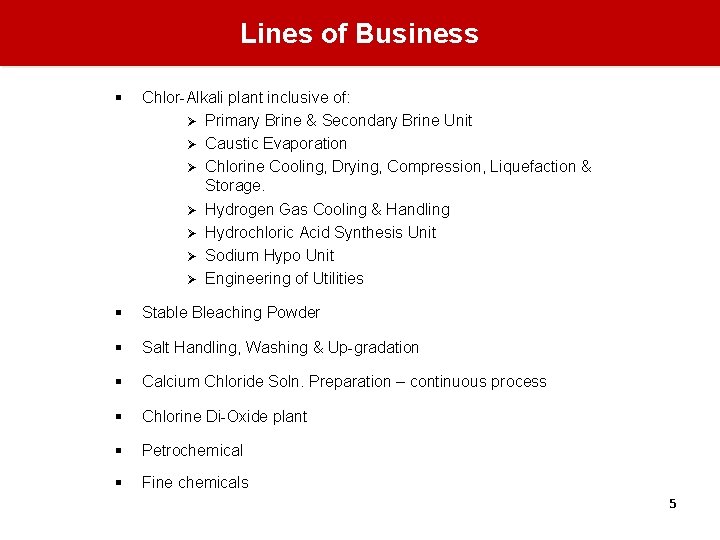

Lines of Business § Chlor-Alkali plant inclusive of: Ø Primary Brine & Secondary Brine Unit Ø Caustic Evaporation Ø Chlorine Cooling, Drying, Compression, Liquefaction & Storage. Ø Hydrogen Gas Cooling & Handling Ø Hydrochloric Acid Synthesis Unit Ø Sodium Hypo Unit Ø Engineering of Utilities § Stable Bleaching Powder § Salt Handling, Washing & Up-gradation § Calcium Chloride Soln. Preparation – continuous process § Chlorine Di-Oxide plant § Petrochemical § Fine chemicals 5
Process Engineering § Preparation of process description for the plant. § Developing Material and energy balance for the processing unit. § Developing process and instruments diagrams (P & ID's) for Process & Utility Sections. § Developing quantity of utilities required for the plant § Pipe line sizing. § Preparation of line list, valve list, equipment list etc. § Submission of Plant Operating Manual. § Assistance during Pre-commissioning & Commissioning § Carrying out Hazop Study for addressing safety related issues of the plant. 6
Mechanical Engineering § § § Preparation of Data sheets, Enquiry specification sheets for fabricated equipment including detailed sketches. Preparation of Enquiry specification sheets for bought-out items like pumps, blowers, filters, etc. , Preparation of Enquiry specification sheets for package items like boilers, compressors, chillers etc. Plot plan. Equipment layouts (plan and sections). Scrutiny, checking and approval of fabrication drawings for fabricated items prepared by vendors and Inspection. Preparation of load data drawing including foundation and pocket details for carrying out the civil work. Review of vendor documents / drawings for the bought - out items. Preparation of Enquiry specification for equipment/piping erection work, insulation and painting work etc. Preparation of drawings for submission to government bodies. Supervision of Mechanical erection 7

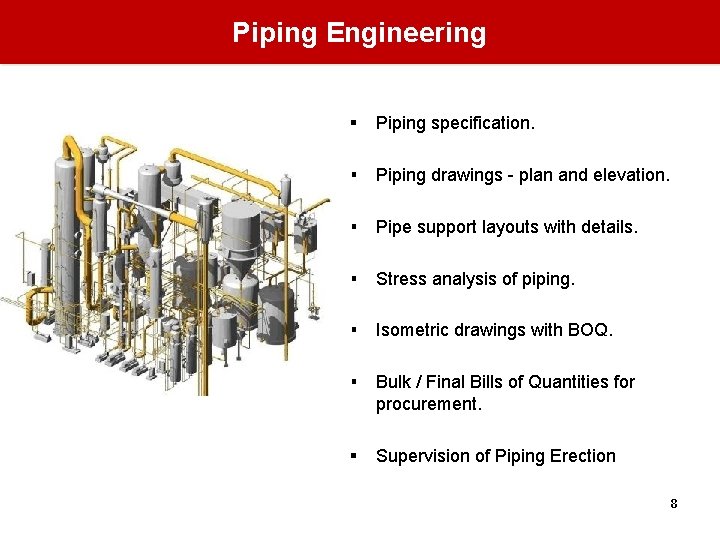

Piping Engineering § Piping specification. § Piping drawings - plan and elevation. § Pipe support layouts with details. § Stress analysis of piping. § Isometric drawings with BOQ. § Bulk / Final Bills of Quantities for procurement. § Supervision of Piping Erection 8
Civil Engineering § Architectural drawings for all the buildings. § Detailed civil drawing for all plant buildings, utility area, adjoining roads, drains, equipment foundations, pipe/cable racks etc. § Preparation of bill of quantities, technical specifications, piling design and layout. § Preparation of Civil tender. § Floating of civil tender to various vendors, including terms & conditions. § Preparation of Bid analysis for the civil construction work. § Supervision of civil construction. 9
Electrical Engineering § Single line diagrams. § Preparation of Cable & Cable Tray Routing drawing and selecting location of Push Button Stations. § Enquiry specification sheets for the electrical equipment including Transformer, MCC, Cables, Switches, Lighting etc. § Power / Earthing / Lighting Layouts for the process and utility buildings. § Bill of material for electrical items like cable, cable tray etc. § Enquiry specification for electrical erection. § Supervision of electrical erection 10
Instrumentation Engineering § § § Instrument Summary. Enquiry specification sheets for all instruments. Process control and interlock description. Preparation of I/O list for analog and digital signal for DCS. Preparation of control loop schematic diagrams, wiring diagrams, process graphic diagrams for DCS graphics, interlock/ladder logic diagram Instrument Cable & Cable Tray Routing Drawing Instrument layout. Specifications for air headers, instrument cables, junction boxes and cable trays. Instrument cable schedule. Loop Diagrams & Hook up diagrams. Enquiry specification for instrument erection along with instrument erection MTO. Supervision of Instrument Erection. 11

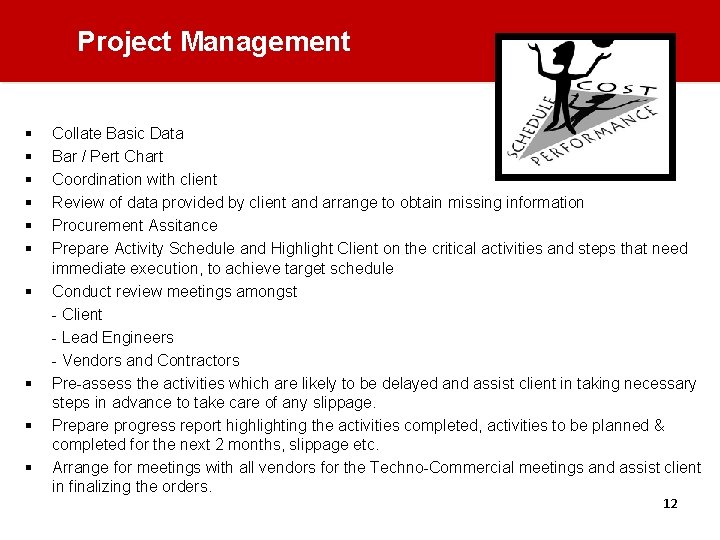

Project Management § § § § § Collate Basic Data Bar / Pert Chart Coordination with client Review of data provided by client and arrange to obtain missing information Procurement Assitance Prepare Activity Schedule and Highlight Client on the critical activities and steps that need immediate execution, to achieve target schedule Conduct review meetings amongst - Client - Lead Engineers - Vendors and Contractors Pre-assess the activities which are likely to be delayed and assist client in taking necessary steps in advance to take care of any slippage. Prepare progress report highlighting the activities completed, activities to be planned & completed for the next 2 months, slippage etc. Arrange for meetings with all vendors for the Techno-Commercial meetings and assist client in finalizing the orders. 12
Know-How & Proven Technologies Available for… § Complete Chlor-Alkali plant (except IEM Electrolyser supply and License to operate). § Chlorine Drying, Liquefaction & Vaporisation unit. § Chlorine Di-oxide solution plant for Pulp & Paper Industry - R 2 process and modified Hydrogen Peroxide process § Stable bleaching powder plant § Salt up-gradation and Iodization plant § Calcium Chloride Plant Strategic Alliance With ERCO worldwide, Canada For setting up of Chlorine Dioxide plants using R 8 and R 10 process. 13
Special Designs Carried Out for § Chlorine Liquefier § Chlorine drying tower § Chlorine Vaporizer § Ion Exchange Unit for Brine Purification § Calcium Chloride Solution – continuous process § Reactors § Single effect, Double effect and Triple effect Caustic evaporators 14
Infrastructure Facilities § HP SERVER 2013 with § 20 KV online UPS. § Desktop – 40 stations. § Laptop & Projectors. § “A 0” Size Plotter. § “A 3 & A 4” Size Laser Printers. § High Speed Broadband Internet Connectivity with WIFI. § § Software Tools Used PROCESS, MECHANICAL, INSTRUMENTATION & ELECTRICAL: Extensive LAN network. Library housing the necessary technical codes & standards and reference books. Subscribed to leading technical journals & magazines. § § § Auto. CAD Release 2013– Network Version (12 user’s) for Drafting. Designers Desktop for mechanical design of vessels, heat exchangers and tall columns – Based on ASME & TEMA. CV Spec for Control Valve Sizing. MS Project for project management. TALLY ERP 9 – for accounting. CIVIL & STRUCTURAL: § § § STADD 2008 for Structural Design. STRAP 2004 for Structural Detailing. REVIT 2009 for Architecture. 15

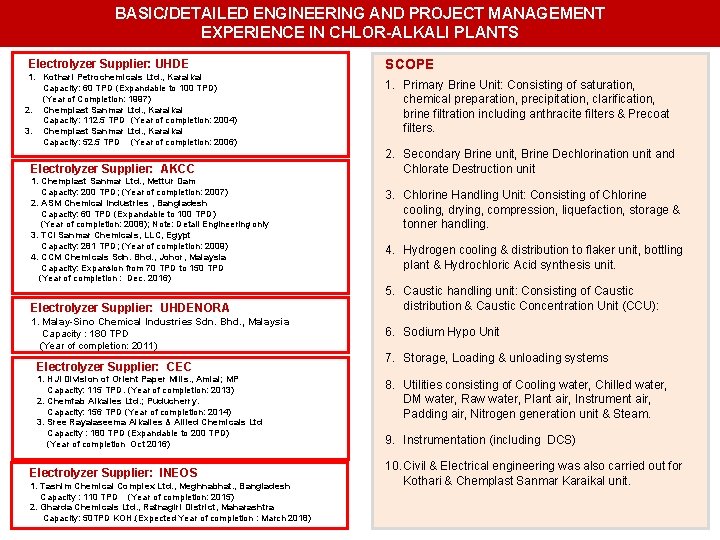

BASIC/DETAILED ENGINEERING AND PROJECT MANAGEMENT EXPERIENCE IN CHLOR-ALKALI PLANTS Electrolyzer Supplier: UHDE 1. Kothari Petrochemicals Ltd. , Karaikal Capacity: 60 TPD (Expandable to 100 TPD) (Year of Completion: 1997) 2. Chemplast Sanmar Ltd. , Karaikal Capacity: 112. 5 TPD (Year of completion: 2004) 3. Chemplast Sanmar Ltd. , Karaikal Capacity: 52. 5 TPD (Year of completion: 2006) Electrolyzer Supplier: AKCC 1. Chemplast Sanmar Ltd. , Mettur Dam Capacity: 200 TPD; (Year of completion: 2007) 2. ASM Chemical Industries , Bangladesh Capacity: 60 TPD (Expandable to 100 TPD) (Year of completion: 2008); Note: Detail Engineering only 3. TCI Sanmar Chemicals, LLC, Egypt Capacity: 281 TPD; (Year of completion: 2009) 4. CCM Chemicals Sdn. Bhd. , Johor, Malaysia Capacity: Expansion from 70 TPD to 150 TPD (Year of completion : Dec. 2016) Electrolyzer Supplier: UHDENORA 1. Malay-Sino Chemical Industries Sdn. Bhd. , Malaysia Capacity : 180 TPD (Year of completion: 2011) Electrolyzer Supplier: CEC 1. HJI Division of Orient Paper Mills. , Amlai; MP Capacity: 115 TPD. (Year of completion: 2013) 2. Chemfab Alkalies Ltd. ; Puducherry. Capacity: 156 TPD (Year of completion: 2014) 3. Sree Rayalaseema Alkalies & Allied Chemicals Ltd Capacity : 180 TPD (Expandable to 200 TPD) (Year of completion Oct 2016) Electrolyzer Supplier: INEOS 1. Tasnim Chemical Complex Ltd. , Meghnabhat. , Bangladesh Capacity : 110 TPD (Year of completion: 2015) 2. Gharda Chemicals Ltd. , Ratnagiri District, Maharashtra Capacity: 50 TPD KOH. (Expected Year of completion : March 2018) SCOPE 1. Primary Brine Unit: Consisting of saturation, chemical preparation, precipitation, clarification, brine filtration including anthracite filters & Precoat filters. 2. Secondary Brine unit, Brine Dechlorination unit and Chlorate Destruction unit 3. Chlorine Handling Unit: Consisting of Chlorine cooling, drying, compression, liquefaction, storage & tonner handling. 4. Hydrogen cooling & distribution to flaker unit, bottling plant & Hydrochloric Acid synthesis unit. 5. Caustic handling unit: Consisting of Caustic distribution & Caustic Concentration Unit (CCU): 6. Sodium Hypo Unit 7. Storage, Loading & unloading systems 8. Utilities consisting of Cooling water, Chilled water, DM water, Raw water, Plant air, Instrument air, Padding air, Nitrogen generation unit & Steam. 9. Instrumentation (including DCS) 10. Civil & Electrical engineering was also carried out for Kothari & Chemplast Sanmar Karaikal unit.

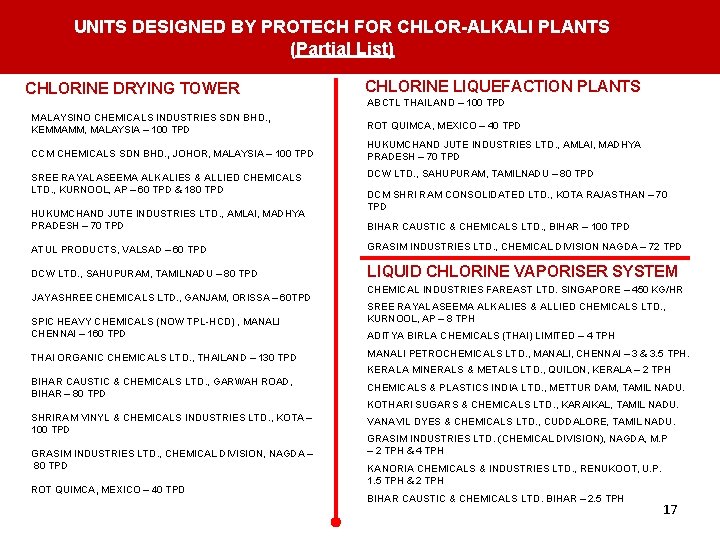

UNITS DESIGNED BY PROTECH FOR CHLOR-ALKALI PLANTS (Partial List) CHLORINE DRYING TOWER CHLORINE LIQUEFACTION PLANTS ABCTL THAILAND – 100 TPD MALAYSINO CHEMICALS INDUSTRIES SDN BHD. , KEMMAMM, MALAYSIA – 100 TPD ROT QUIMCA, MEXICO – 40 TPD CCM CHEMICALS SDN BHD. , JOHOR, MALAYSIA – 100 TPD HUKUMCHAND JUTE INDUSTRIES LTD. , AMLAI, MADHYA PRADESH – 70 TPD SREE RAYALASEEMA ALKALIES & ALLIED CHEMICALS LTD. , KURNOOL, AP – 60 TPD & 180 TPD HUKUMCHAND JUTE INDUSTRIES LTD. , AMLAI, MADHYA PRADESH – 70 TPD DCW LTD. , SAHUPURAM, TAMILNADU – 80 TPD DCM SHRI RAM CONSOLIDATED LTD. , KOTA RAJASTHAN – 70 TPD BIHAR CAUSTIC & CHEMICALS LTD. , BIHAR – 100 TPD ATUL PRODUCTS, VALSAD – 60 TPD GRASIM INDUSTRIES LTD. , CHEMICAL DIVISION NAGDA – 72 TPD DCW LTD. , SAHUPURAM, TAMILNADU – 80 TPD LIQUID CHLORINE VAPORISER SYSTEM JAYASHREE CHEMICALS LTD. , GANJAM, ORISSA – 60 TPD SPIC HEAVY CHEMICALS (NOW TPL-HCD) , MANALI CHENNAI – 160 TPD THAI ORGANIC CHEMICALS LTD. , THAILAND – 130 TPD CHEMICAL INDUSTRIES FAREAST LTD. SINGAPORE – 450 KG/HR SREE RAYALASEEMA ALKALIES & ALLIED CHEMICALS LTD. , KURNOOL, AP – 8 TPH ADITYA BIRLA CHEMICALS (THAI) LIMITED – 4 TPH MANALI PETROCHEMICALS LTD. , MANALI, CHENNAI – 3 & 3. 5 TPH. KERALA MINERALS & METALS LTD. , QUILON, KERALA – 2 TPH BIHAR CAUSTIC & CHEMICALS LTD. , GARWAH ROAD, BIHAR – 80 TPD CHEMICALS & PLASTICS INDIA LTD. , METTUR DAM, TAMIL NADU. SHRIRAM VINYL & CHEMICALS INDUSTRIES LTD. , KOTA – 100 TPD VANAVIL DYES & CHEMICALS LTD. , CUDDALORE, TAMIL NADU. GRASIM INDUSTRIES LTD. , CHEMICAL DIVISION, NAGDA – 80 TPD ROT QUIMCA, MEXICO – 40 TPD KOTHARI SUGARS & CHEMICALS LTD. , KARAIKAL, TAMIL NADU. GRASIM INDUSTRIES LTD. (CHEMICAL DIVISION), NAGDA, M. P – 2 TPH & 4 TPH KANORIA CHEMICALS & INDUSTRIES LTD. , RENUKOOT, U. P. 1. 5 TPH & 2 TPH BIHAR CAUSTIC & CHEMICALS LTD. BIHAR – 2. 5 TPH 17

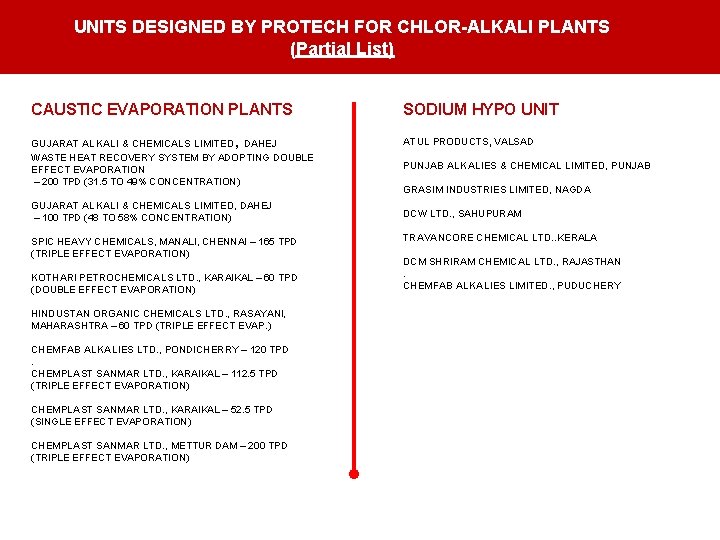

UNITS DESIGNED BY PROTECH FOR CHLOR-ALKALI PLANTS (Partial List) CAUSTIC EVAPORATION PLANTS , GUJARAT ALKALI & CHEMICALS LIMITED DAHEJ WASTE HEAT RECOVERY SYSTEM BY ADOPTING DOUBLE EFFECT EVAPORATION – 200 TPD (31. 5 TO 49% CONCENTRATION) GUJARAT ALKALI & CHEMICALS LIMITED, DAHEJ – 100 TPD (48 TO 58% CONCENTRATION) SPIC HEAVY CHEMICALS, MANALI, CHENNAI – 165 TPD (TRIPLE EFFECT EVAPORATION) KOTHARI PETROCHEMICALS LTD. , KARAIKAL – 60 TPD (DOUBLE EFFECT EVAPORATION) HINDUSTAN ORGANIC CHEMICALS LTD. , RASAYANI, MAHARASHTRA – 60 TPD (TRIPLE EFFECT EVAP. ) CHEMFAB ALKALIES LTD. , PONDICHERRY – 120 TPD. CHEMPLAST SANMAR LTD. , KARAIKAL – 112. 5 TPD (TRIPLE EFFECT EVAPORATION) CHEMPLAST SANMAR LTD. , KARAIKAL – 52. 5 TPD (SINGLE EFFECT EVAPORATION) CHEMPLAST SANMAR LTD. , METTUR DAM – 200 TPD (TRIPLE EFFECT EVAPORATION) SODIUM HYPO UNIT ATUL PRODUCTS, VALSAD PUNJAB ALKALIES & CHEMICAL LIMITED, PUNJAB GRASIM INDUSTRIES LIMITED, NAGDA DCW LTD. , SAHUPURAM TRAVANCORE CHEMICAL LTD. . KERALA DCM SHRIRAM CHEMICAL LTD. , RAJASTHAN. CHEMFAB ALKALIES LIMITED. , PUDUCHERY

VARIOUS OTHER PROJECTS - PARTIAL LIST SALT & MARINE CHEMICAL PLANTS INTERNATIONAL COUNCIL FOR CONTROL OF IODINE DEFICIENCY DISORDERS, SRI LANKA (ICCIDDSL) , 15 TPH & 8 TPH SALT WASHERY (YEAR OF COMPLETION: 2007) HINDUSTAN SALTS LIMITED, SAMBHAR LAKE, RAJASTHAN 10 TPH SALT UP-GRADATION (YEAR OF COMPLETION: 2006) . , TAMILNADU SALT CORPORATION LTD VALINOKKAM, 15750 TPA IODIZED SALT & 9810 TPA DOUBLE FORTIFIED SALT (YEAR OF COMPLETION: 2004) CHEMPLAST SANMAR LTD. , SALT WORKS, VEDARANYAM. 40 TPH SALT UP-GRADATION PLANT (YEAR OF COMPLETION 2003) PREM NAMAK UDYOG PVT. LTD. , DHARANGHDRA 72, 000 TPA FREE FLOWING IODIZED SALT . INORGANIC CHEMICAL PLANTS TUTICORIN ALKALI CHEMICAL & FERTILIZERS LTD. TUTICORIN, T. N. 175 TPD CO 2 RECOVERY PLANT FROM BOILER FLUE GAS DENORA INDIA LTD. , UDYOGMANDAL, KERALA 5 TPD SODIUM CHLORATE PLANT ATOFINA CATALYST INDIA LIMITED, NAGDA ALUMINIUM CHLORIDE MANUFACTURING PLANT GUJARAT ALKALIES & CHEMICALS LIMITED, RANOLI, CALCIUM CHLORIDE SOLUTION PREPARATION (CONTINOUS PROCESS) & EVAPORATION (33 TO 46%) CAPACITY: 26. 5 TPD OMAN CHLORINE, SOHAR, OMAN TURNKEY SUPPLY OF CALCIUM CHLORIDE SOLUTION PREPARATION UNIT CAPACITY: 37 TPD. OTHER PROJECTS THE METAL POWDER COMPANY LTD. THIRUVALLUR, T. N AUTOCLAVE AERATED CONCRETE BRICKS PLANT. 19

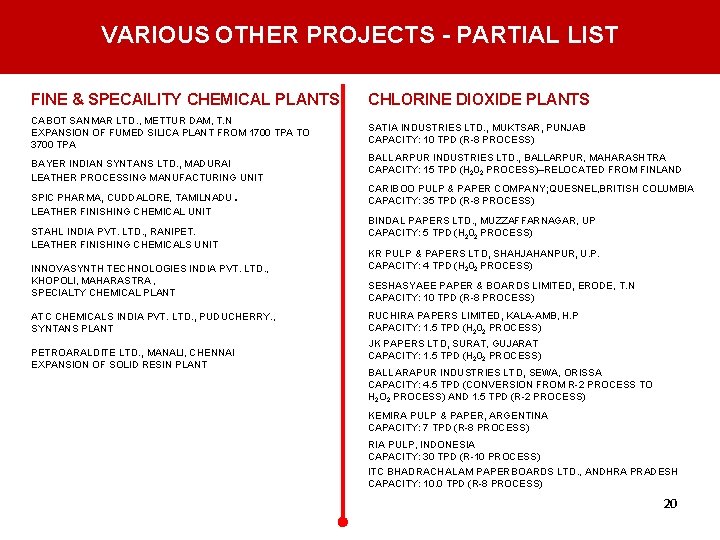

VARIOUS OTHER PROJECTS - PARTIAL LIST FINE & SPECAILITY CHEMICAL PLANTS CHLORINE DIOXIDE PLANTS CABOT SANMAR LTD. , METTUR DAM, T. N EXPANSION OF FUMED SILICA PLANT FROM 1700 TPA TO 3700 TPA SATIA INDUSTRIES LTD. , MUKTSAR, PUNJAB CAPACITY: 10 TPD (R-8 PROCESS) BALLARPUR INDUSTRIES LTD. , BALLARPUR, MAHARASHTRA CAPACITY: 15 TPD (H 202 PROCESS)–RELOCATED FROM FINLAND . CARIBOO PULP & PAPER COMPANY; QUESNEL, BRITISH COLUMBIA CAPACITY: 35 TPD (R-8 PROCESS) BAYER INDIAN SYNTANS LTD. , MADURAI LEATHER PROCESSING MANUFACTURING UNIT SPIC PHARMA, CUDDALORE, TAMILNADU LEATHER FINISHING CHEMICAL UNIT STAHL INDIA PVT. LTD. , RANIPET. LEATHER FINISHING CHEMICALS UNIT INNOVASYNTH TECHNOLOGIES INDIA PVT. LTD. , KHOPOLI, MAHARASTRA , SPECIALTY CHEMICAL PLANT ATC CHEMICALS INDIA PVT. LTD. , PUDUCHERRY. , SYNTANS PLANT PETROARALDITE LTD. , MANALI, CHENNAI EXPANSION OF SOLID RESIN PLANT BINDAL PAPERS LTD. , MUZZAFFARNAGAR, UP CAPACITY: 5 TPD (H 202 PROCESS) KR PULP & PAPERS LTD, SHAHJAHANPUR, U. P. CAPACITY: 4 TPD (H 202 PROCESS) SESHASYAEE PAPER & BOARDS LIMITED, ERODE, T. N CAPACITY: 10 TPD (R-8 PROCESS) RUCHIRA PAPERS LIMITED, KALA-AMB, H. P CAPACITY: 1. 5 TPD (H 202 PROCESS) JK PAPERS LTD, SURAT, GUJARAT CAPACITY: 1. 5 TPD (H 202 PROCESS) BALLARAPUR INDUSTRIES LTD, SEWA, ORISSA CAPACITY: 4. 5 TPD (CONVERSION FROM R-2 PROCESS TO H 2 O 2 PROCESS) AND 1. 5 TPD (R-2 PROCESS) KEMIRA PULP & PAPER, ARGENTINA CAPACITY: 7 TPD (R-8 PROCESS) RIA PULP, INDONESIA CAPACITY: 30 TPD (R-10 PROCESS) ITC BHADRACHALAM PAPERBOARDS LTD. , ANDHRA PRADESH CAPACITY: 10. 0 TPD (R-8 PROCESS) 20
VARIOUS OTHER PROJECTS - PARTIAL LIST PETROCHEMICALS PLANTS MANALI PETROCHEMICALS LTD. , CHENNAI, TAMIL NADU Detailed Engineering Services for setting up of Propylene Oxide Reactor Unit - Plant-II & Plant-I SUPREME PETROCHEM LIMITED, MANALI, Engineering Services for revamping of their existing Expanded Polystyrene (EPS) Plant INDIAN ADDITIVES LTD. , MANALI, TAMIL NADU. Detailed Engineering Services for installation of Batch Reactor, Blending Vessels and 100 KL Liquid Storage Tanks CETEX PETROCHEMICALS LTD. , MANALI, TAMIL NADU Consultancy services for Debottlenecking of Secondary Butyl Alcohol (SBA) & Methyl Ethyl Ketone (MEK) plant. SRF LIMITED, MANALI, CHENNA Detailed Engineering of Nylon plant for capacity expansion. Basic Engineering by Polymer Engineering, Germany STAHL INDIA PRIVATE LIMITED, RANIPET, TAMIL NADU Detailed Engineering for cooling & blending system & pressure control system for existing reactors of their acrylic plant DCW LIMITED, SAHUPURAM, TAMIL NADU Basic & Detailed Engineering Services for 12 TPD Tri Chloro Ethylene (TCE) Plant FEASIBILITY & HAZOP STUDY DEEPAK GULF, OMAN Preparation of detailed project report for 160/ 54 TPD Sodium Nitrite/ Nitrate, 130 TPD Caustic Soda and 177 TPD Calcium Chloride Granules KOTHARI SUGARS & CHEMICALS LTD. , T. N Preparation of detailed project report for 52. 5 TPD Sodium Chlorate Plant. DEEPAK NITRITE LIMITED, VADODARA. Preparation of detailed project report for 60 TPD Caustic Soda plant. ANDHRA PRADESH PAPER MILLS LTD. , HYDERABAD Feasibility report for Caustic Soda Plant ADITYA BIRLA CHEMICALS (THAILAND) LTD. , THAILAND Hazop Study of P & I Diagrams for existing Chloralkali plant. CHEMFAB ALKALIES LTD. , PONDICHERRY Engineering Services for carrying out the study of thermal balance of the existing Caustic Concentration Unit, for carrying out technical safety audit for existing Chlorine plants and for carrying out the feasibility study for enhancement of Liquid Chlorine production. MANALI PETROCHEMICALS LTD. , CHENNAI, TAMIL NADU Detailed Engineering Services for PGMME Augmentation and Polyol Expansion. 21

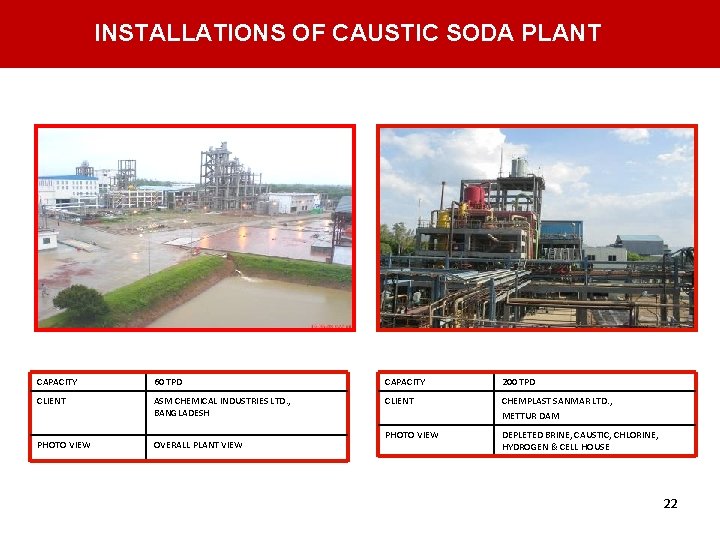

INSTALLATIONS OF CAUSTIC SODA PLANT CAPACITY 60 TPD CAPACITY 200 TPD CLIENT ASM CHEMICAL INDUSTRIES LTD. , BANGLADESH CLIENT CHEMPLAST SANMAR LTD. , METTUR DAM PHOTO VIEW OVERALL PLANT VIEW PHOTO VIEW DEPLETED BRINE, CAUSTIC, CHLORINE, HYDROGEN & CELL HOUSE 22
INSTALLATIONS OF CAUSTIC SODA PLANT CAPACITY 200 TPD CAPACITY 281 TPD CLIENT CHEMPLAST SANMAR LTD. , METTUR DAM CLIENT TCI SANMAR CHEMICALS LLC, PORTSAID, EGYPT PHOTO VIEW CELL HOUSE VIEW PHOTO VIEW CLARRIFIER, TANKS & SLUDGE PIT 23

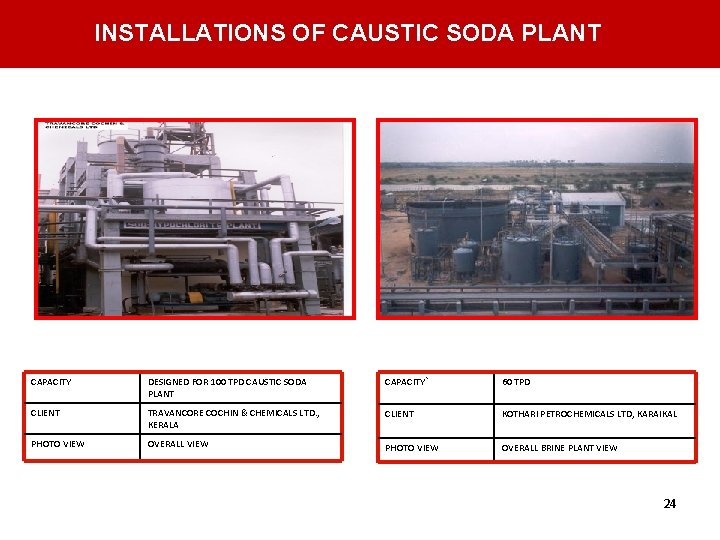

INSTALLATIONS OF CAUSTIC SODA PLANT CAPACITY DESIGNED FOR 100 TPD CAUSTIC SODA PLANT CAPACITY` 60 TPD CLIENT TRAVANCORE COCHIN & CHEMICALS LTD. , KERALA CLIENT KOTHARI PETROCHEMICALS LTD, KARAIKAL PHOTO VIEW OVERALL VIEW PHOTO VIEW OVERALL BRINE PLANT VIEW 24

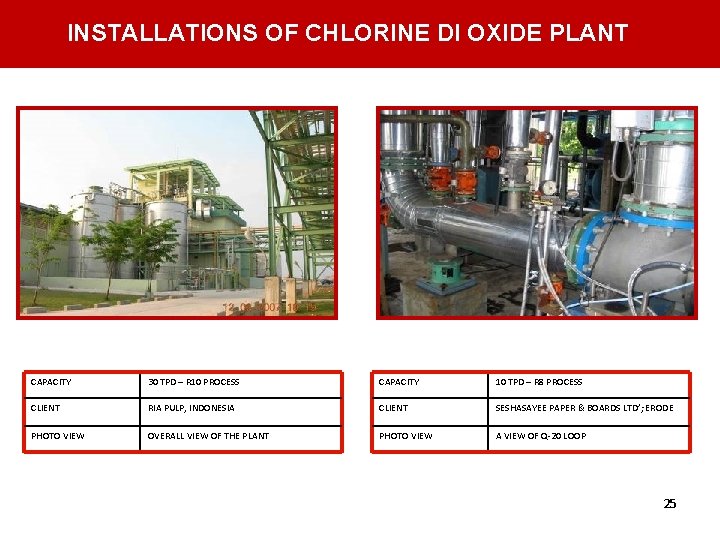

INSTALLATIONS OF CHLORINE DI OXIDE PLANT CAPACITY 30 TPD – R 10 PROCESS CAPACITY 10 TPD – R 8 PROCESS CLIENT RIA PULP, INDONESIA CLIENT SESHASAYEE PAPER & BOARDS LTD’; ERODE PHOTO VIEW OVERALL VIEW OF THE PLANT PHOTO VIEW A VIEW OF Q-20 LOOP 25

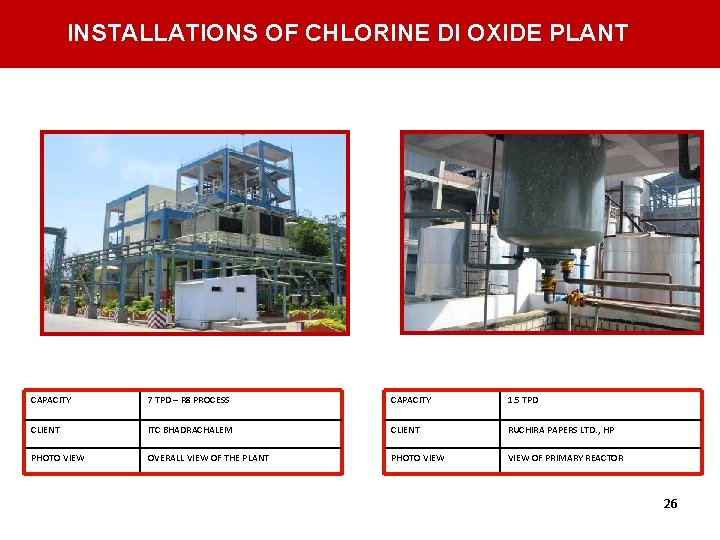

INSTALLATIONS OF CHLORINE DI OXIDE PLANT CAPACITY 7 TPD – R 8 PROCESS CAPACITY 1. 5 TPD CLIENT ITC BHADRACHALEM CLIENT RUCHIRA PAPERS LTD. , HP PHOTO VIEW OVERALL VIEW OF THE PLANT PHOTO VIEW OF PRIMARY REACTOR 26

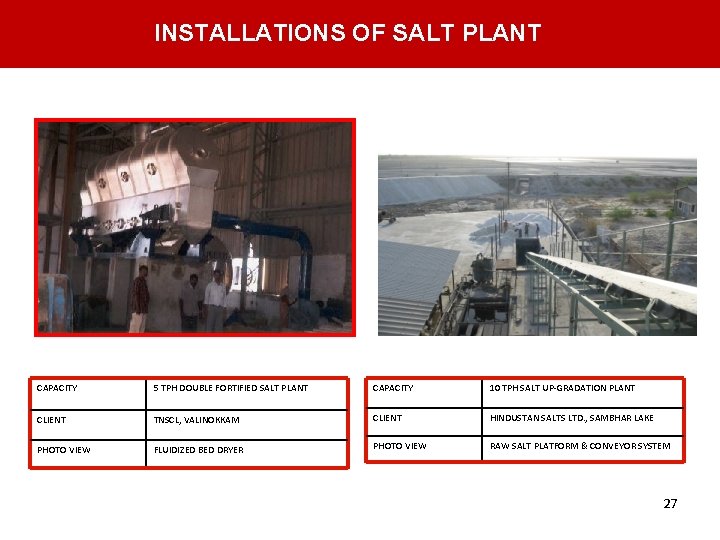

INSTALLATIONS OF SALT PLANT CAPACITY 5 TPH DOUBLE FORTIFIED SALT PLANT CAPACITY 10 TPH SALT UP-GRADATION PLANT CLIENT TNSCL, VALINOKKAM CLIENT HINDUSTAN SALTS LTD. , SAMBHAR LAKE PHOTO VIEW FLUIDIZED BED DRYER PHOTO VIEW RAW SALT PLATFORM & CONVEYOR SYSTEM 27
INSTALLATIONS OF CAUSTIC EVAPORATION UNIT CAPACITY 200 TPD – TRIPPLE EFFECT CAPACITY 200 TPD – DOUBLE EFFECT CLIENT CHEMPLAST SANMR LTD. , METTUR DAM CLIENT GUJARAT ALKALIES & CHEMICALS LTD. , DAHEJ PHOTO VIEW OVER ALL VIEW 28
INSTALLATIONS OF CALCIUM CHLORIDE PLANT CAPACITY 26. 5 TPD CLIENT GUJARAT ALKALIES & CHEMICALS LTD. RANOLI PHOTO VIEW REACTORS & NEUTRALIZING TANK 29
IN PURSUIT OF ENERGY SAVING, RENEWABLE RESOURCES, USING RECYCLED PRODUCTS FOR A NON TOXIC WORLD. Thank you! 30
