EMS Migration SRP Info Electric customers end FY

  • Slides: 31
Download presentation
EMS Migration

EMS Migration

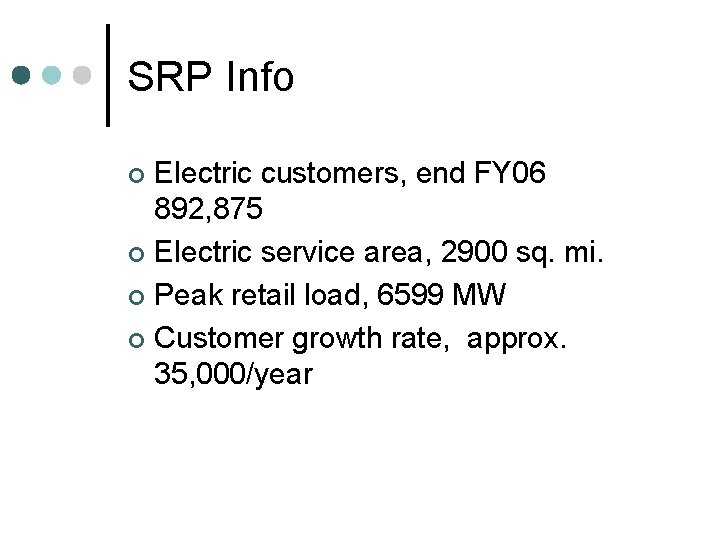

SRP Info Electric customers, end FY 06 892, 875 ¢ Electric service area, 2900

SRP Info Electric customers, end FY 06 892, 875 ¢ Electric service area, 2900 sq. mi. ¢ Peak retail load, 6599 MW ¢ Customer growth rate, approx. 35, 000/year ¢

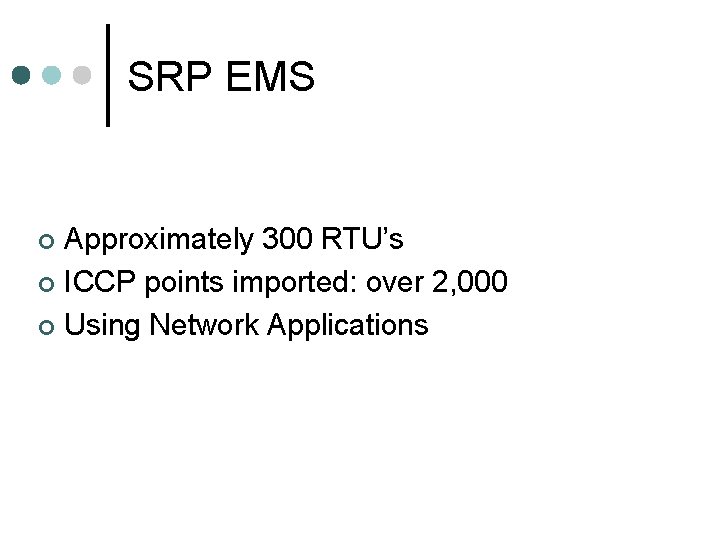

SRP EMS Approximately 300 RTU’s ¢ ICCP points imported: over 2, 000 ¢ Using

SRP EMS Approximately 300 RTU’s ¢ ICCP points imported: over 2, 000 ¢ Using Network Applications ¢

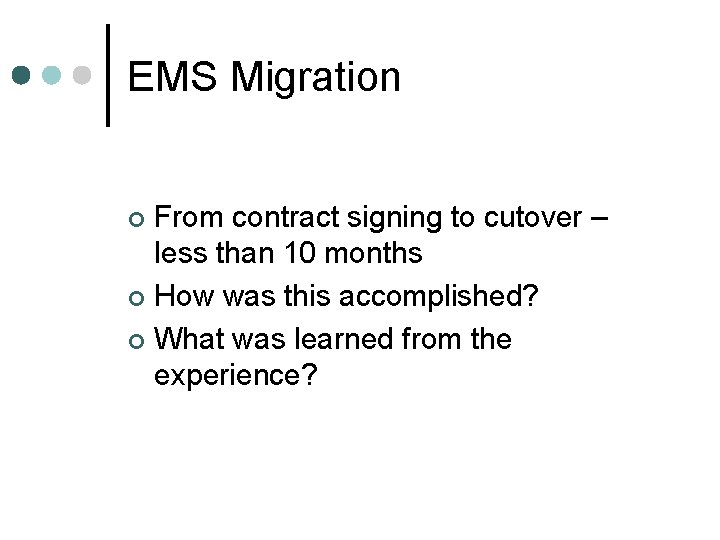

EMS Migration From contract signing to cutover – less than 10 months ¢ How

EMS Migration From contract signing to cutover – less than 10 months ¢ How was this accomplished? ¢ What was learned from the experience? ¢

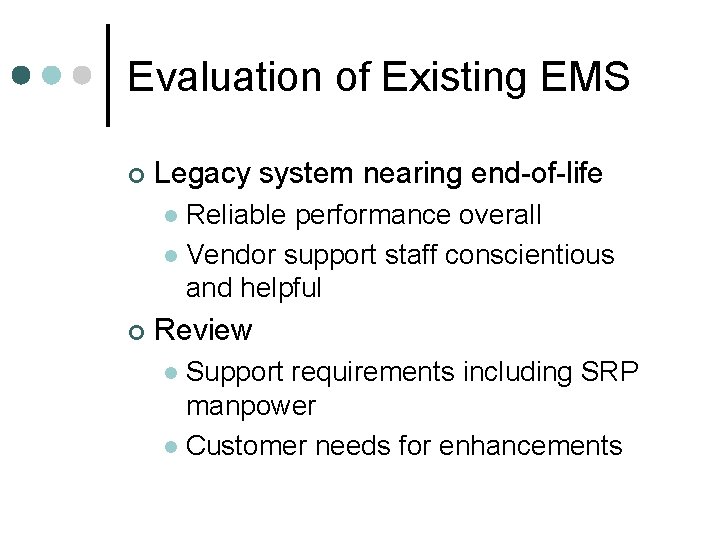

Evaluation of Existing EMS ¢ Legacy system nearing end-of-life Reliable performance overall l Vendor

Evaluation of Existing EMS ¢ Legacy system nearing end-of-life Reliable performance overall l Vendor support staff conscientious and helpful l ¢ Review Support requirements including SRP manpower l Customer needs for enhancements l

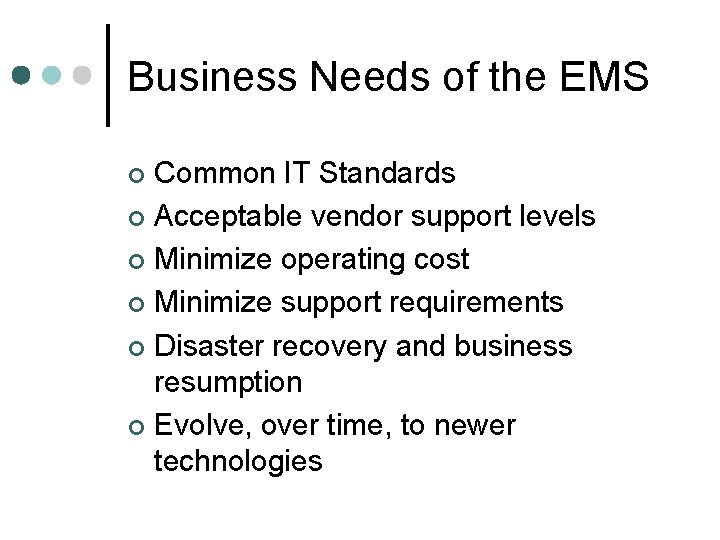

Business Needs of the EMS Common IT Standards ¢ Acceptable vendor support levels ¢

Business Needs of the EMS Common IT Standards ¢ Acceptable vendor support levels ¢ Minimize operating cost ¢ Minimize support requirements ¢ Disaster recovery and business resumption ¢ Evolve, over time, to newer technologies ¢

Develop List of Potential Vendors ¢ Criteria for Vendor Viability Technical capabilities l Product

Develop List of Potential Vendors ¢ Criteria for Vendor Viability Technical capabilities l Product evolutions l Customer evaluations l

Pre-Qualification of Bidders ¢ Assessment of vendors by SRP Potential bidders track records l

Pre-Qualification of Bidders ¢ Assessment of vendors by SRP Potential bidders track records l Budgetaries provided by vendors l Project team experience including site visits l Ability to support implementation plan l

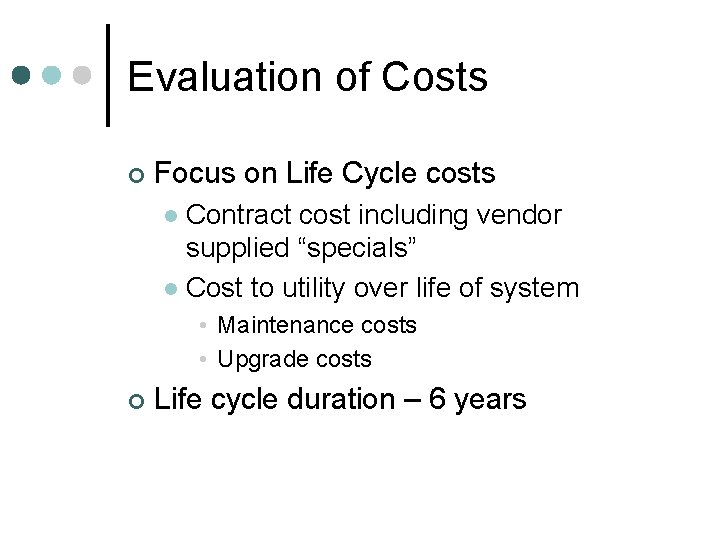

Evaluation of Costs ¢ Focus on Life Cycle costs Contract cost including vendor supplied

Evaluation of Costs ¢ Focus on Life Cycle costs Contract cost including vendor supplied “specials” l Cost to utility over life of system l • Maintenance costs • Upgrade costs ¢ Life cycle duration – 6 years

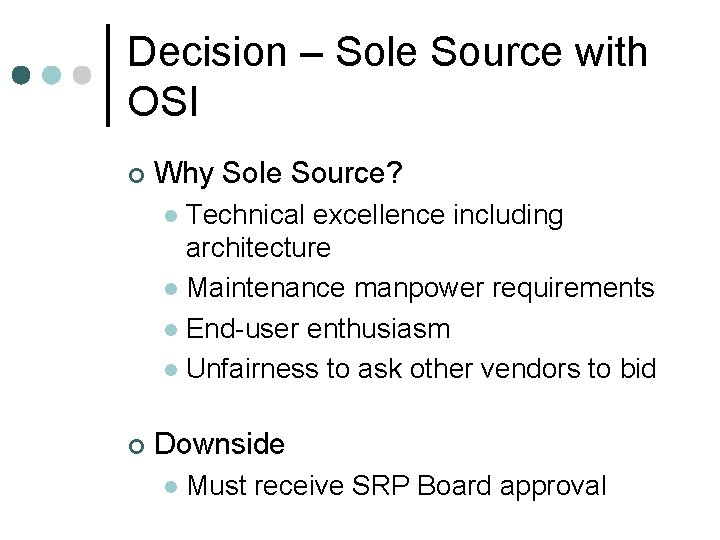

Decision – Sole Source with OSI ¢ Why Sole Source? Technical excellence including architecture

Decision – Sole Source with OSI ¢ Why Sole Source? Technical excellence including architecture l Maintenance manpower requirements l End-user enthusiasm l Unfairness to ask other vendors to bid l ¢ Downside l Must receive SRP Board approval

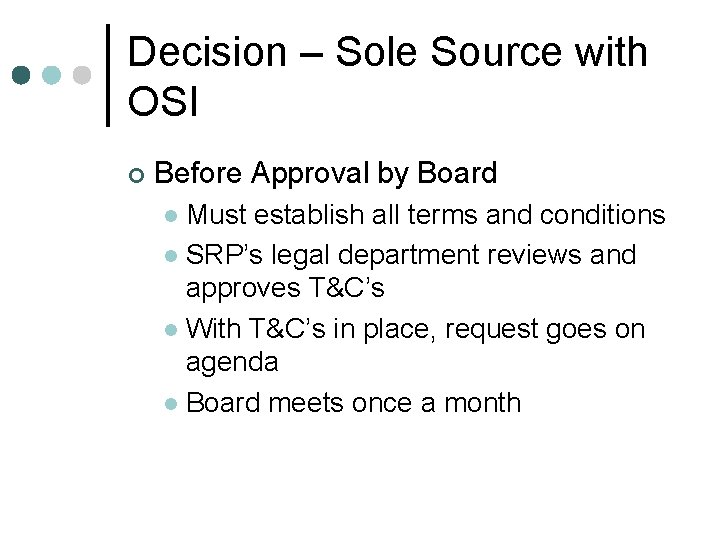

Decision – Sole Source with OSI ¢ Before Approval by Board Must establish all

Decision – Sole Source with OSI ¢ Before Approval by Board Must establish all terms and conditions l SRP’s legal department reviews and approves T&C’s l With T&C’s in place, request goes on agenda l Board meets once a month l

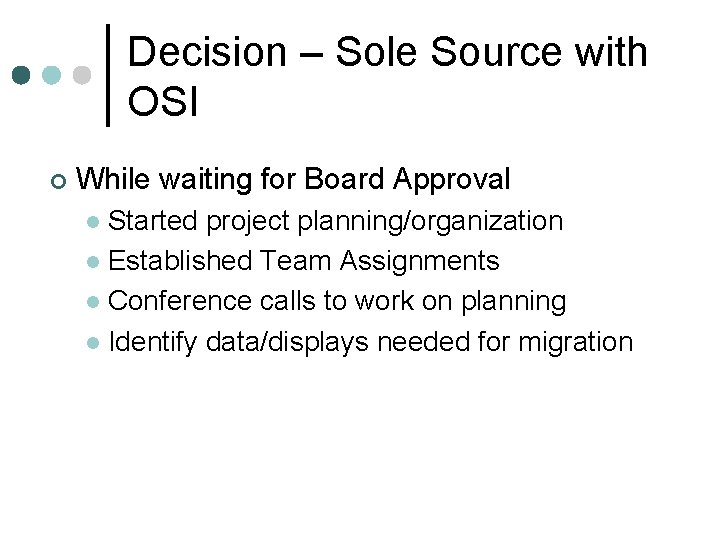

Decision – Sole Source with OSI ¢ While waiting for Board Approval Started project

Decision – Sole Source with OSI ¢ While waiting for Board Approval Started project planning/organization l Established Team Assignments l Conference calls to work on planning l Identify data/displays needed for migration l

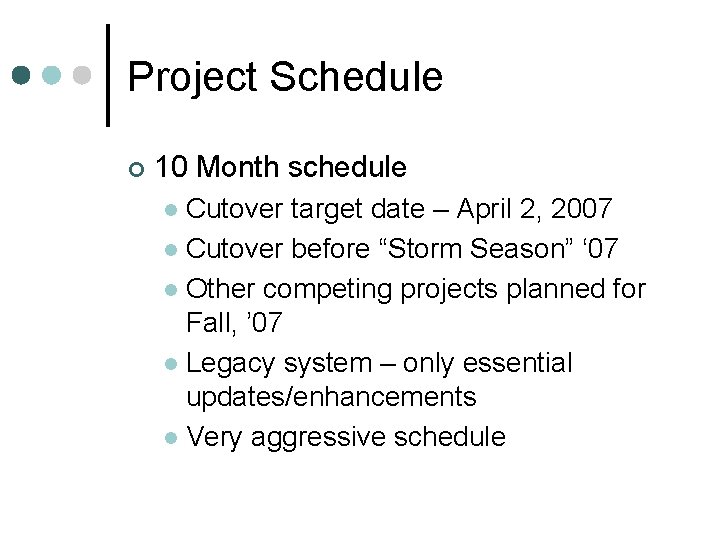

Project Schedule ¢ 10 Month schedule Cutover target date – April 2, 2007 l

Project Schedule ¢ 10 Month schedule Cutover target date – April 2, 2007 l Cutover before “Storm Season” ‘ 07 l Other competing projects planned for Fall, ’ 07 l Legacy system – only essential updates/enhancements l Very aggressive schedule l

Project Team

Project Team

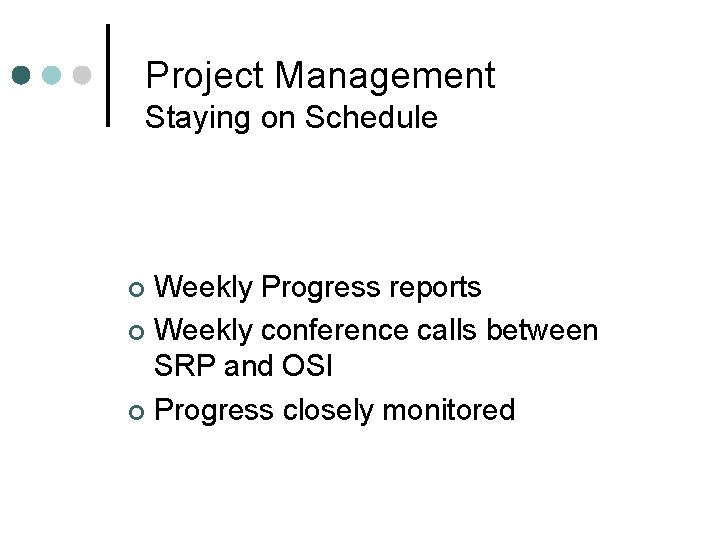

Project Management Staying on Schedule Weekly Progress reports ¢ Weekly conference calls between SRP

Project Management Staying on Schedule Weekly Progress reports ¢ Weekly conference calls between SRP and OSI ¢ Progress closely monitored ¢

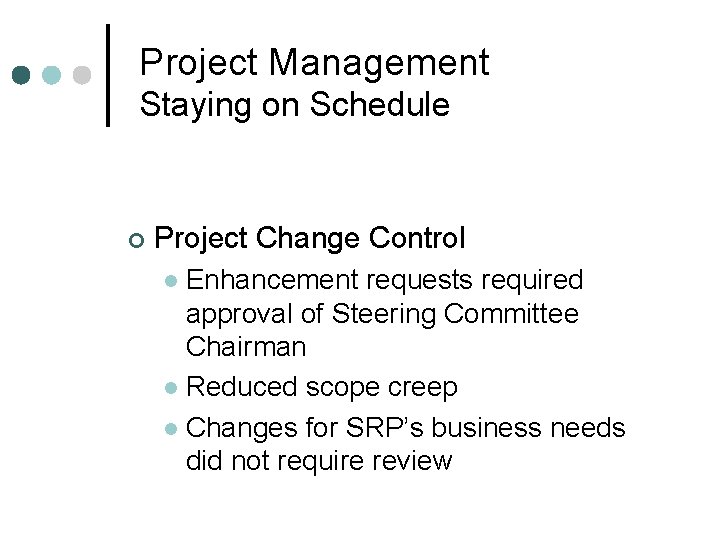

Project Management Staying on Schedule ¢ Project Change Control Enhancement requests required approval of

Project Management Staying on Schedule ¢ Project Change Control Enhancement requests required approval of Steering Committee Chairman l Reduced scope creep l Changes for SRP’s business needs did not require review l

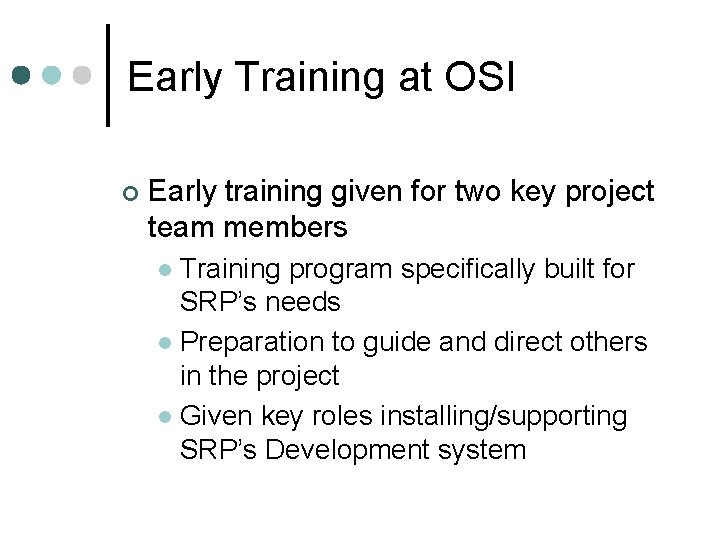

Early Training at OSI ¢ Early training given for two key project team members

Early Training at OSI ¢ Early training given for two key project team members Training program specifically built for SRP’s needs l Preparation to guide and direct others in the project l Given key roles installing/supporting SRP’s Development system l

SRP’s Development System ¢ System installed at SRP August, ’ 06 All RTU’s connected

SRP’s Development System ¢ System installed at SRP August, ’ 06 All RTU’s connected in “listen mode” l Incoming ICCP data sent to system l Software development l Installation/verification of DB’s and displays from OSI l Network Apps tuning l

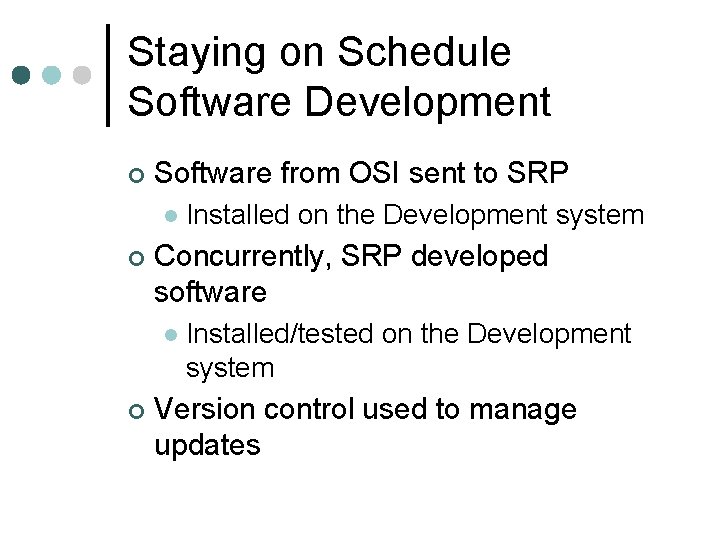

Staying on Schedule Software Development ¢ Software from OSI sent to SRP l ¢

Staying on Schedule Software Development ¢ Software from OSI sent to SRP l ¢ Concurrently, SRP developed software l ¢ Installed on the Development system Installed/tested on the Development system Version control used to manage updates

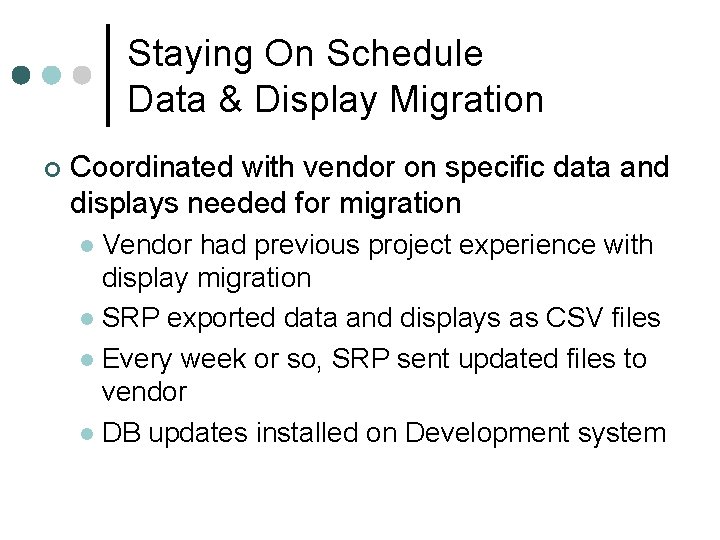

Staying On Schedule Data & Display Migration ¢ Coordinated with vendor on specific data

Staying On Schedule Data & Display Migration ¢ Coordinated with vendor on specific data and displays needed for migration Vendor had previous project experience with display migration l SRP exported data and displays as CSV files l Every week or so, SRP sent updated files to vendor l DB updates installed on Development system l

Staying on Schedule ¢ As project needs were identified Paid Overtime was approved l

Staying on Schedule ¢ As project needs were identified Paid Overtime was approved l Some attended training by day – worked on project assignments during evenings/weekends l

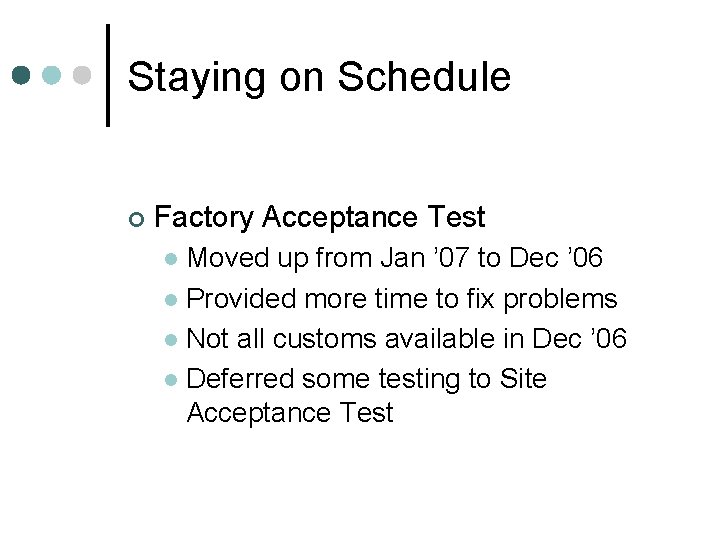

Staying on Schedule ¢ Factory Acceptance Test Moved up from Jan ’ 07 to

Staying on Schedule ¢ Factory Acceptance Test Moved up from Jan ’ 07 to Dec ’ 06 l Provided more time to fix problems l Not all customs available in Dec ’ 06 l Deferred some testing to Site Acceptance Test l

Staying on Schedule ¢ Factory Acceptance Test Long days for SRP – 11 to

Staying on Schedule ¢ Factory Acceptance Test Long days for SRP – 11 to 12 hours l Longer days for OSI project team l • Arrived early (before SRP) • Stayed late to prepare for the next day’s tests

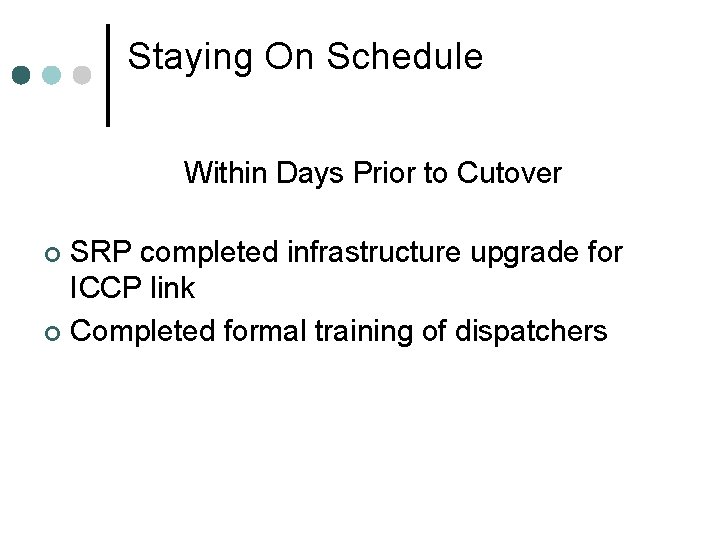

Staying On Schedule Within Days Prior to Cutover SRP completed infrastructure upgrade for ICCP

Staying On Schedule Within Days Prior to Cutover SRP completed infrastructure upgrade for ICCP link ¢ Completed formal training of dispatchers ¢

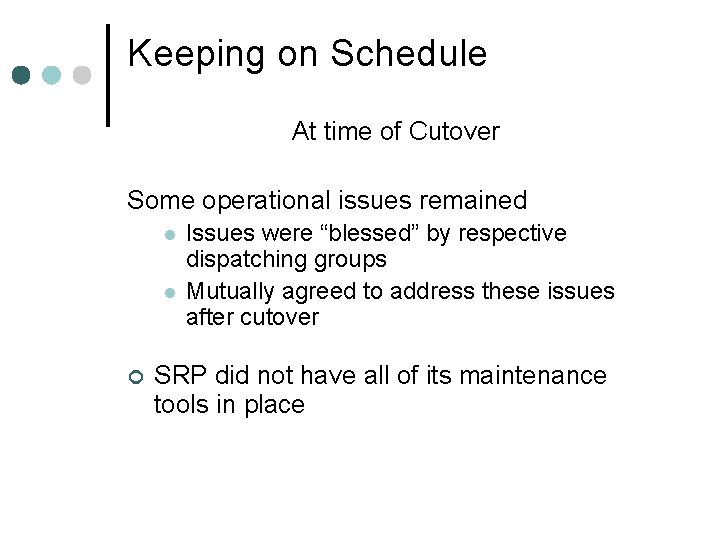

Keeping on Schedule At time of Cutover Some operational issues remained l l ¢

Keeping on Schedule At time of Cutover Some operational issues remained l l ¢ Issues were “blessed” by respective dispatching groups Mutually agreed to address these issues after cutover SRP did not have all of its maintenance tools in place

On-line Test and Cutover ¢ 2 -hour On-line Test Monday evening, March 26, 2007

On-line Test and Cutover ¢ 2 -hour On-line Test Monday evening, March 26, 2007 l Test was successful l ¢ Cutover to monarch™ Thursday morning, March 29, 2007 l Target date: April 2, 2007 l

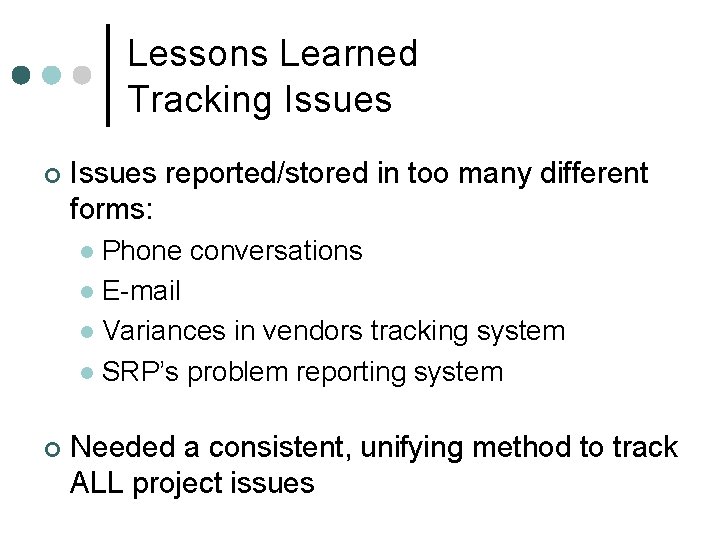

Lessons Learned Tracking Issues ¢ Issues reported/stored in too many different forms: Phone conversations

Lessons Learned Tracking Issues ¢ Issues reported/stored in too many different forms: Phone conversations l E-mail l Variances in vendors tracking system l SRP’s problem reporting system l ¢ Needed a consistent, unifying method to track ALL project issues

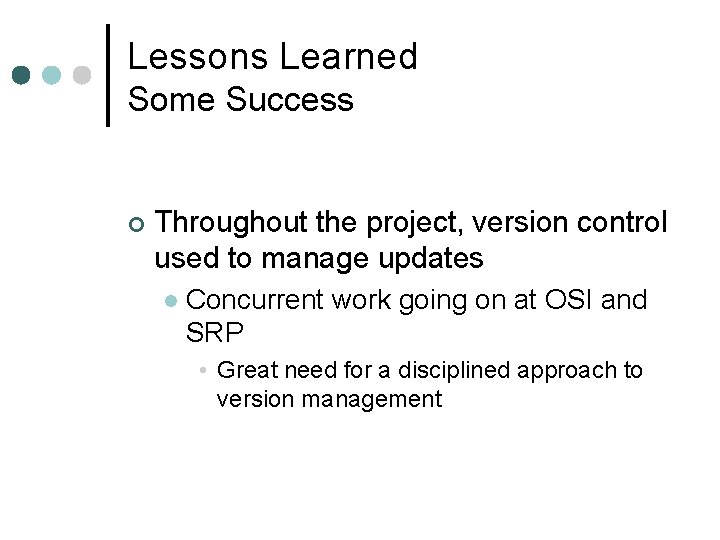

Lessons Learned Some Success ¢ Throughout the project, version control used to manage updates

Lessons Learned Some Success ¢ Throughout the project, version control used to manage updates l Concurrent work going on at OSI and SRP • Great need for a disciplined approach to version management

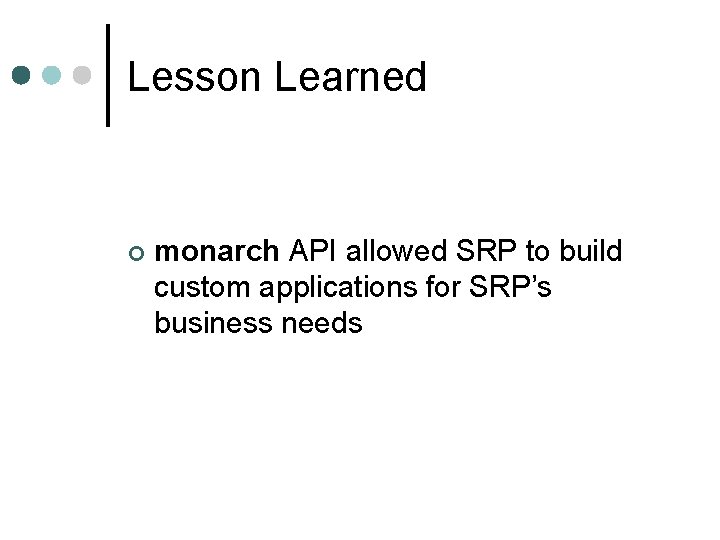

Lesson Learned ¢ monarch API allowed SRP to build custom applications for SRP’s business

Lesson Learned ¢ monarch API allowed SRP to build custom applications for SRP’s business needs

Throughout the Project l As one SRP team member stated, OSI “jumped through hoops”

Throughout the Project l As one SRP team member stated, OSI “jumped through hoops” • Creating specials needed by SRP • Updating the base product

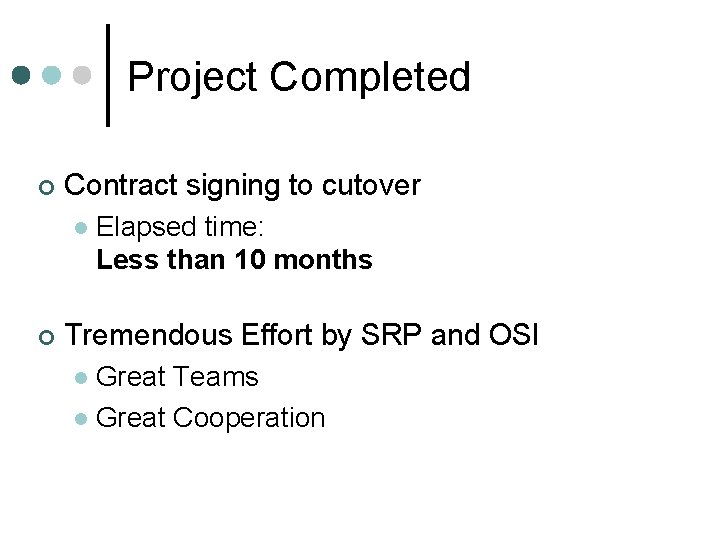

Project Completed ¢ Contract signing to cutover l ¢ Elapsed time: Less than 10

Project Completed ¢ Contract signing to cutover l ¢ Elapsed time: Less than 10 months Tremendous Effort by SRP and OSI Great Teams l Great Cooperation l
