Proposal for the final project of the UNUFTP

  • Slides: 14
Download presentation

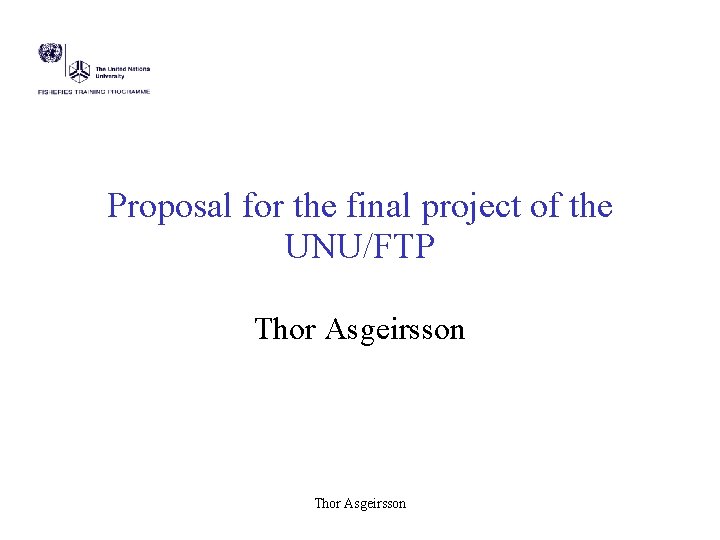

Proposal for the final project of the UNU/FTP Thor Asgeirsson

Proposal for the final project of the UNU/FTP Thor Asgeirsson

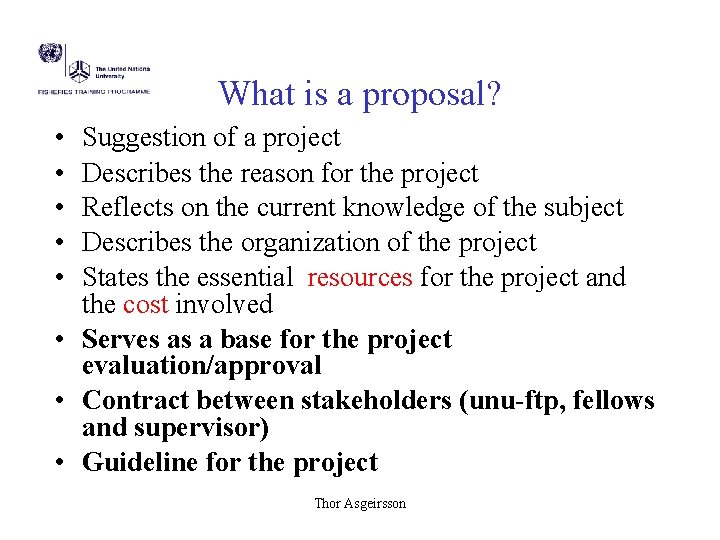

What is a proposal? • • • Suggestion of a project Describes the reason

What is a proposal? • • • Suggestion of a project Describes the reason for the project Reflects on the current knowledge of the subject Describes the organization of the project States the essential resources for the project and the cost involved • Serves as a base for the project evaluation/approval • Contract between stakeholders (unu-ftp, fellows and supervisor) • Guideline for the project Thor Asgeirsson

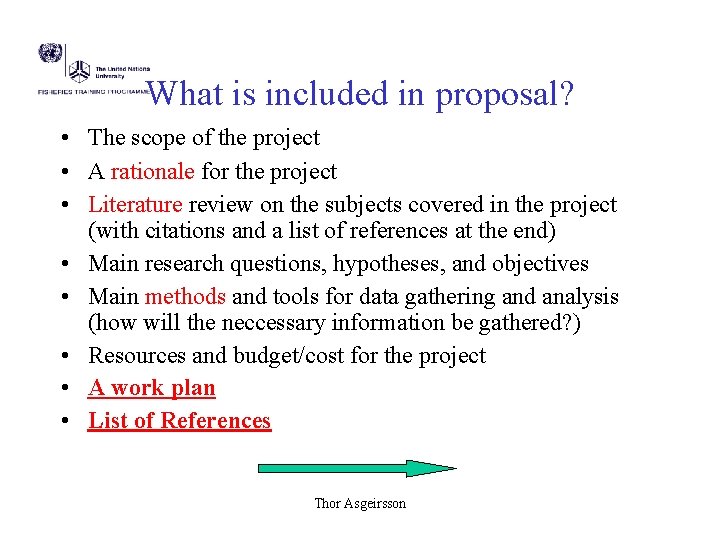

What is included in proposal? • The scope of the project • A rationale

What is included in proposal? • The scope of the project • A rationale for the project • Literature review on the subjects covered in the project (with citations and a list of references at the end) • Main research questions, hypotheses, and objectives • Main methods and tools for data gathering and analysis (how will the neccessary information be gathered? ) • Resources and budget/cost for the project • A work plan • List of References Thor Asgeirsson

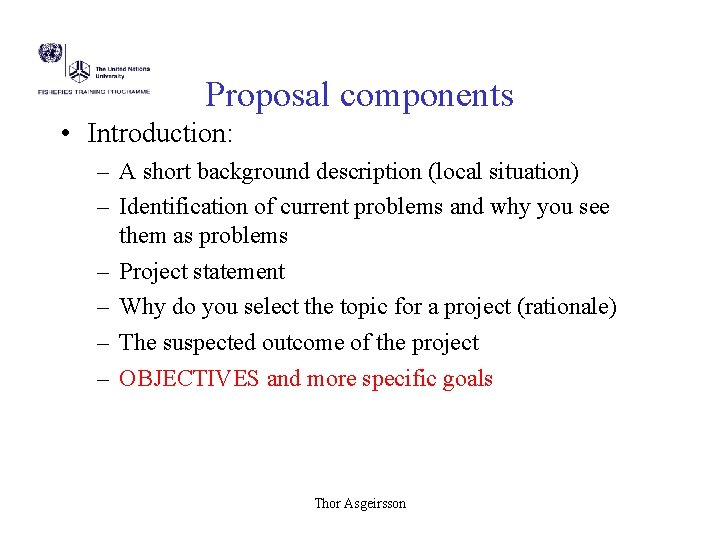

Proposal components • Introduction: – A short background description (local situation) – Identification of

Proposal components • Introduction: – A short background description (local situation) – Identification of current problems and why you see them as problems – Project statement – Why do you select the topic for a project (rationale) – The suspected outcome of the project – OBJECTIVES and more specific goals Thor Asgeirsson

Proposal components cont. • Literature review – Give an overview of the current knowledge

Proposal components cont. • Literature review – Give an overview of the current knowledge of the topic (not extensive lit. search) 2 -3 pages – Use citations and put the literature used in a special reference list – This is not waste of time – this part will be used in the final report!! Thor Asgeirsson

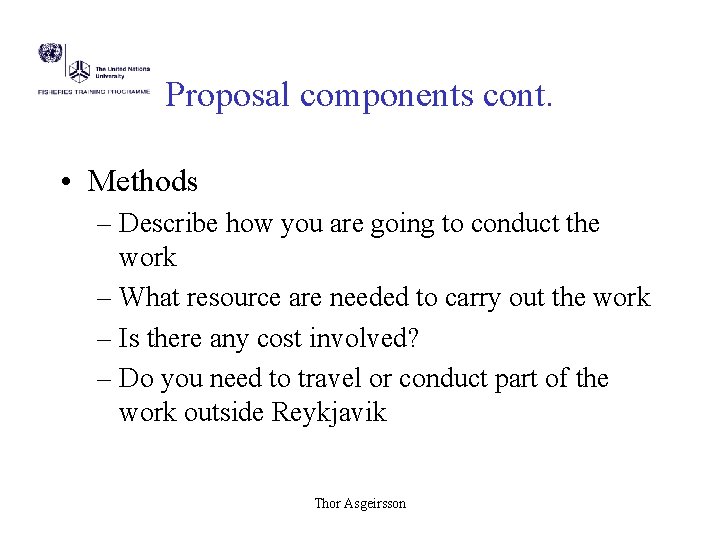

Proposal components cont. • Methods – Describe how you are going to conduct the

Proposal components cont. • Methods – Describe how you are going to conduct the work – What resource are needed to carry out the work – Is there any cost involved? – Do you need to travel or conduct part of the work outside Reykjavik Thor Asgeirsson

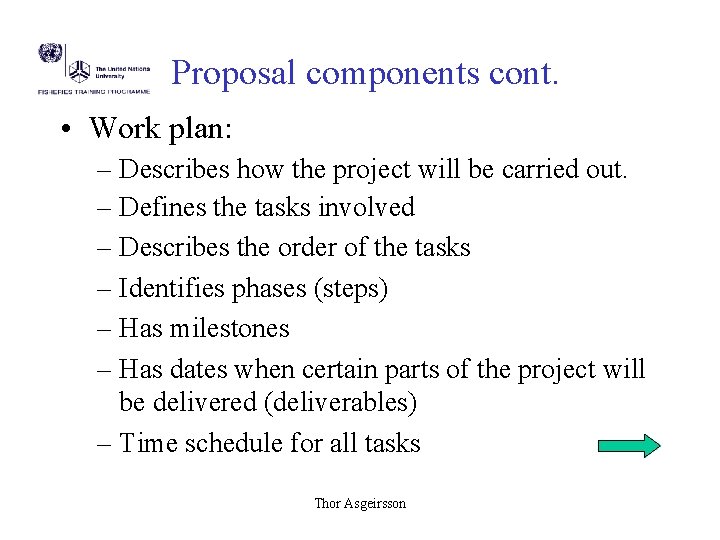

Proposal components cont. • Work plan: – Describes how the project will be carried

Proposal components cont. • Work plan: – Describes how the project will be carried out. – Defines the tasks involved – Describes the order of the tasks – Identifies phases (steps) – Has milestones – Has dates when certain parts of the project will be delivered (deliverables) – Time schedule for all tasks Thor Asgeirsson

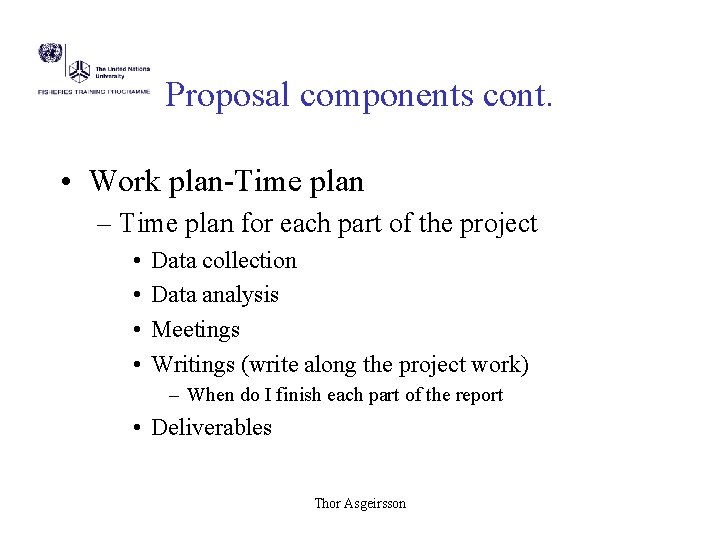

Proposal components cont. • Work plan-Time plan – Time plan for each part of

Proposal components cont. • Work plan-Time plan – Time plan for each part of the project • • Data collection Data analysis Meetings Writings (write along the project work) – When do I finish each part of the report • Deliverables Thor Asgeirsson

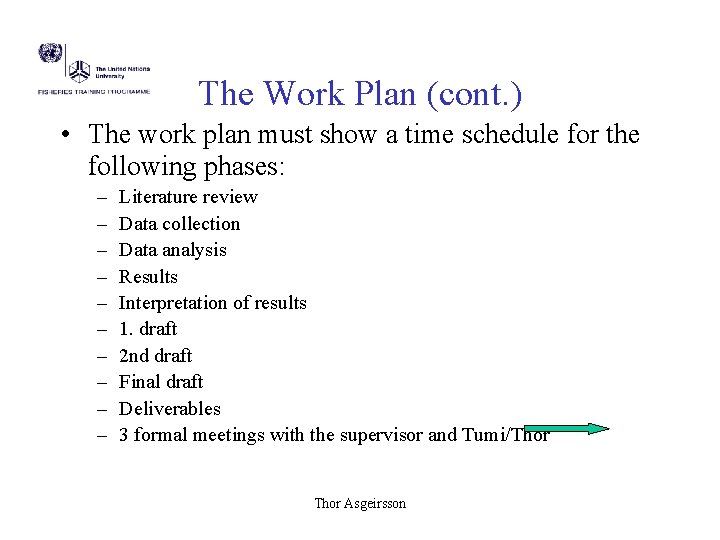

The Work Plan (cont. ) • The work plan must show a time schedule

The Work Plan (cont. ) • The work plan must show a time schedule for the following phases: – – – – – Literature review Data collection Data analysis Results Interpretation of results 1. draft 2 nd draft Final draft Deliverables 3 formal meetings with the supervisor and Tumi/Thor Asgeirsson

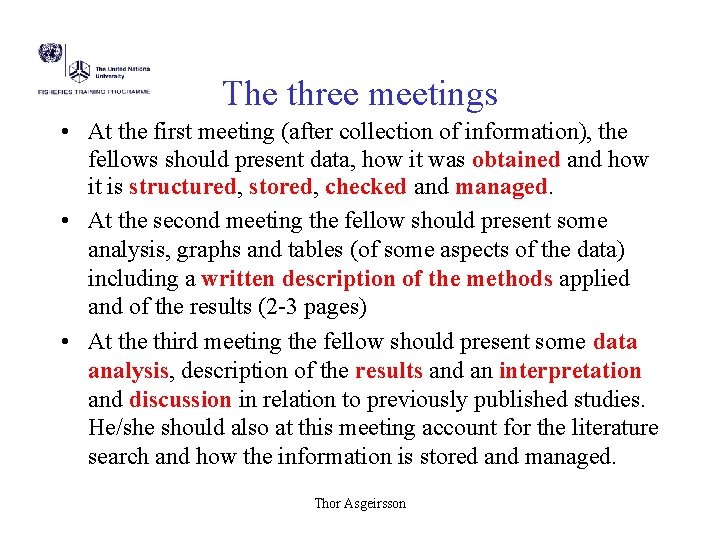

The three meetings • At the first meeting (after collection of information), the fellows

The three meetings • At the first meeting (after collection of information), the fellows should present data, how it was obtained and how it is structured, stored, checked and managed. • At the second meeting the fellow should present some analysis, graphs and tables (of some aspects of the data) including a written description of the methods applied and of the results (2 -3 pages) • At the third meeting the fellow should present some data analysis, description of the results and an interpretation and discussion in relation to previously published studies. He/she should also at this meeting account for the literature search and how the information is stored and managed. Thor Asgeirsson

Time Plan (Schedule) Phaseweek 1 2 3 4 5 Literature review Data collection Data

Time Plan (Schedule) Phaseweek 1 2 3 4 5 Literature review Data collection Data analysis 1 st meeting 30. 11 Methods written Results finished 13. 12 9. 12 Discussion written Formatting Thor Asgeirsson 6 7 8 9 10 11

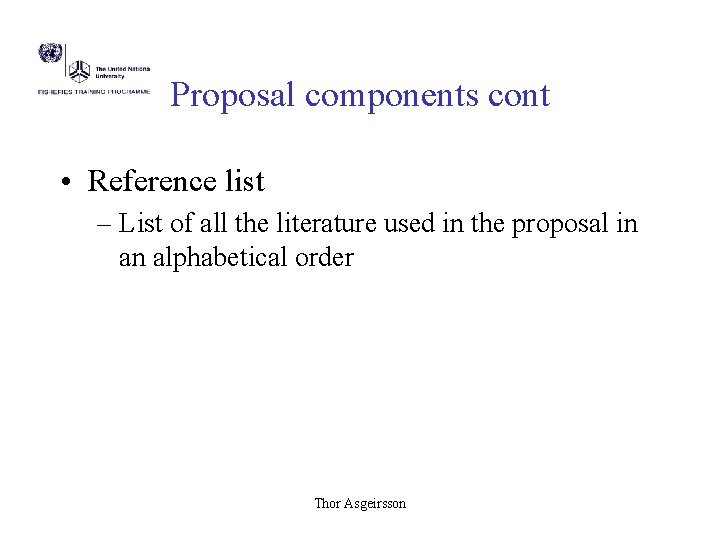

Proposal components cont • Reference list – List of all the literature used in

Proposal components cont • Reference list – List of all the literature used in the proposal in an alphabetical order Thor Asgeirsson

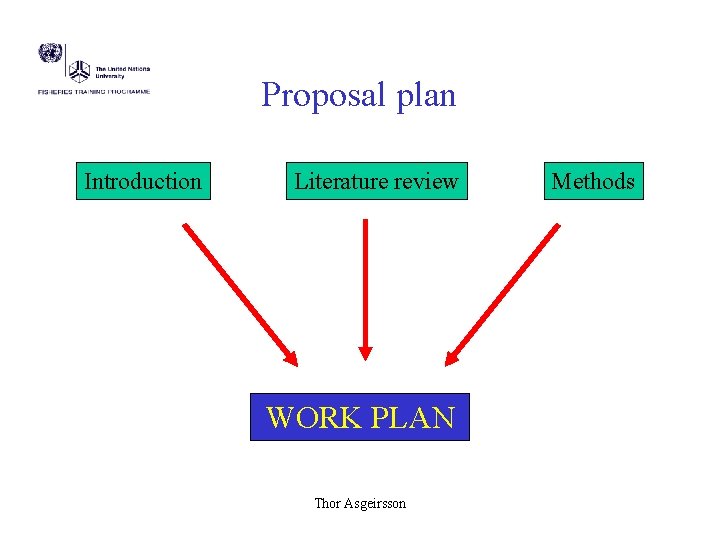

Proposal plan Introduction Literature review WORK PLAN Thor Asgeirsson Methods

Proposal plan Introduction Literature review WORK PLAN Thor Asgeirsson Methods

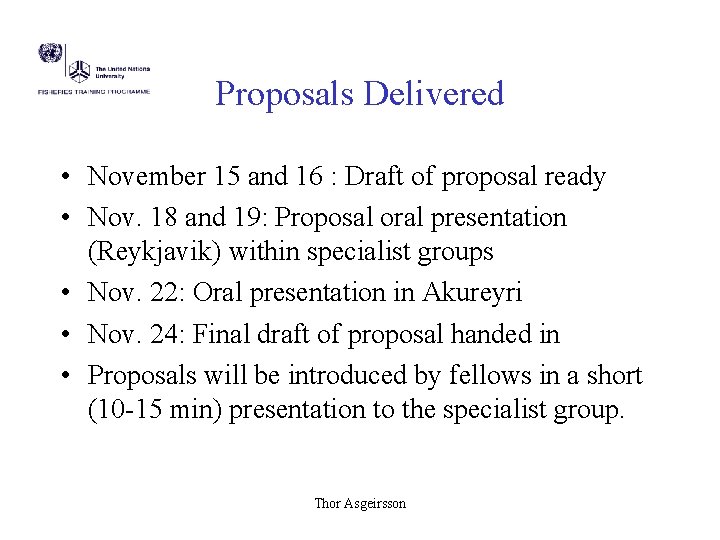

Proposals Delivered • November 15 and 16 : Draft of proposal ready • Nov.

Proposals Delivered • November 15 and 16 : Draft of proposal ready • Nov. 18 and 19: Proposal oral presentation (Reykjavik) within specialist groups • Nov. 22: Oral presentation in Akureyri • Nov. 24: Final draft of proposal handed in • Proposals will be introduced by fellows in a short (10 -15 min) presentation to the specialist group. Thor Asgeirsson
