SMP International Poultry Expertise Centre IPEC S Korea











- Slides: 11
SMP International Poultry Expertise Centre (IPEC), S. Korea Final report 13 Dec. 2016 - Mr. Jos Berkvens (Barneveld city) Dr. Ferry Leenstra (WLR) Mr. Bertus Bronkhost (PEC) Dr. Xin-Ying Ren (WLR)
Report setup § Project Consortium § Project Timeline & milestones § Project Feasibility study trip § Conclusion & follow up 2

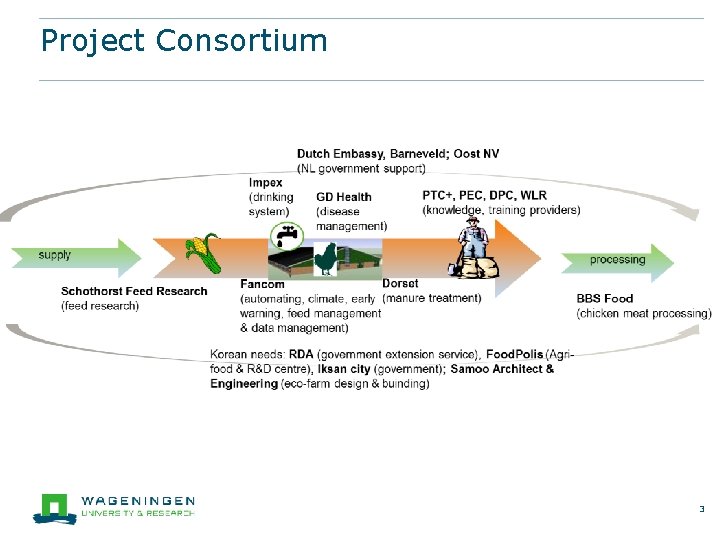

Project Consortium 3

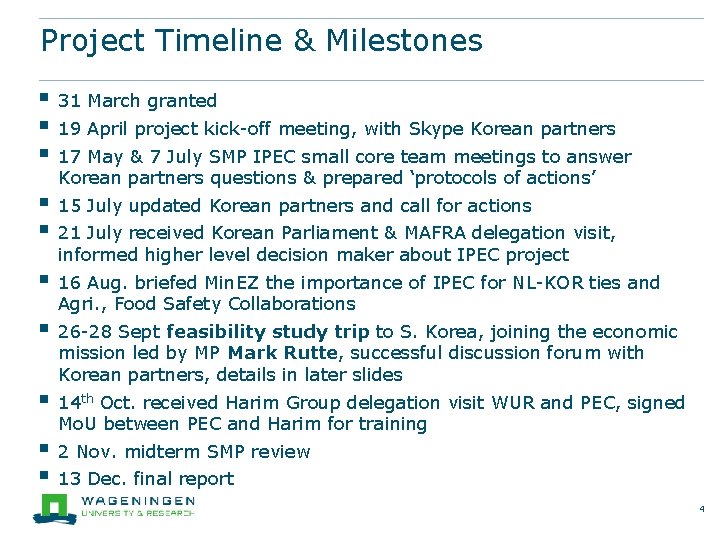

Project Timeline & Milestones § § § 31 March granted § § 15 July updated Korean partners and call for actions § 16 Aug. briefed Min. EZ the importance of IPEC for NL-KOR ties and Agri. , Food Safety Collaborations § 26 -28 Sept feasibility study trip to S. Korea, joining the economic mission led by MP Mark Rutte, successful discussion forum with Korean partners, details in later slides § 14 th Oct. received Harim Group delegation visit WUR and PEC, signed Mo. U between PEC and Harim for training § § 2 Nov. midterm SMP review 19 April project kick-off meeting, with Skype Korean partners 17 May & 7 July SMP IPEC small core team meetings to answer Korean partners questions & prepared ‘protocols of actions’ 21 July received Korean Parliament & MAFRA delegation visit, informed higher level decision maker about IPEC project 13 Dec. final report 4

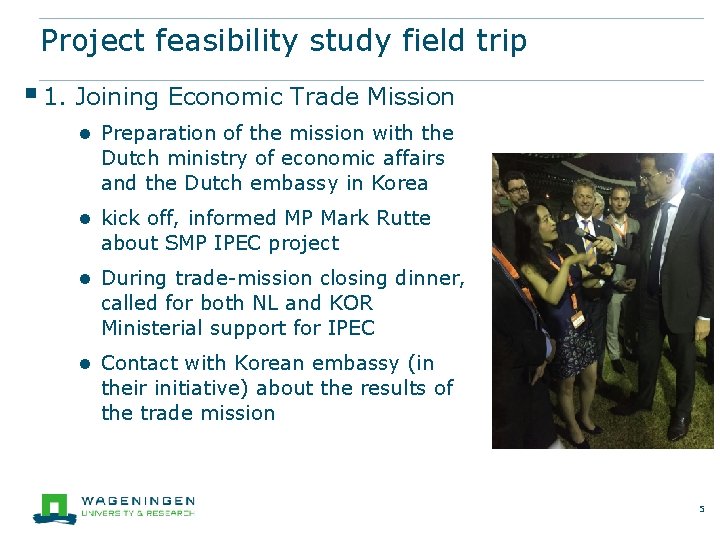

Project feasibility study field trip § 1. Joining Economic Trade Mission ● Preparation of the mission with the Dutch ministry of economic affairs and the Dutch embassy in Korea ● kick off, informed MP Mark Rutte about SMP IPEC project ● During trade-mission closing dinner, called for both NL and KOR Ministerial support for IPEC ● Contact with Korean embassy (in their initiative) about the results of the trade mission 5

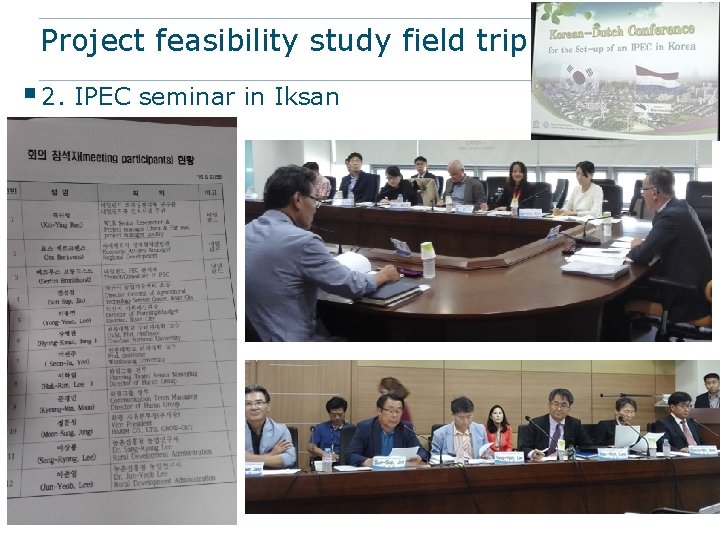

Project feasibility study field trip § 2. IPEC seminar in Iksan 6

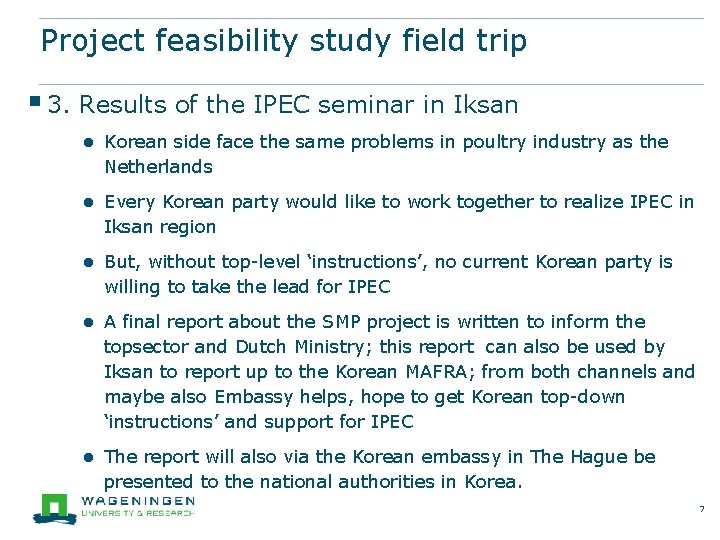

Project feasibility study field trip § 3. Results of the IPEC seminar in Iksan ● Korean side face the same problems in poultry industry as the Netherlands ● Every Korean party would like to work together to realize IPEC in Iksan region ● But, without top-level ‘instructions’, no current Korean party is willing to take the lead for IPEC ● A final report about the SMP project is written to inform the topsector and Dutch Ministry; this report can also be used by Iksan to report up to the Korean MAFRA; from both channels and maybe also Embassy helps, hope to get Korean top-down ‘instructions’ and support for IPEC ● The report will also via the Korean embassy in The Hague be presented to the national authorities in Korea. 7

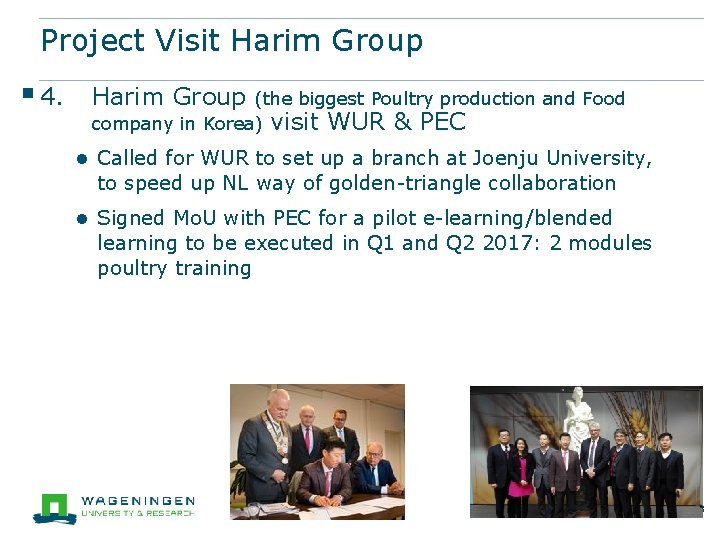

Project Visit Harim Group § 4. Harim Group (the biggest Poultry production and Food company in Korea) visit WUR & PEC ● Called for WUR to set up a branch at Joenju University, to speed up NL way of golden-triangle collaboration ● Signed Mo. U with PEC for a pilot e-learning/blended learning to be executed in Q 1 and Q 2 2017: 2 modules poultry training 8
Project summary § This SMP has built up a consortium necessary for IPEC project whole-chain approach § Feasibility study trip was a success, built up mutual understandings and common interests with Korean partners § Dutch Ministry, Mr. van Dam, Dutch Embassy in Seoul, are well informed about this project; MAFRA is also informed about the IPEC initiative; “Top-down” in S. Korea is utterly important § IPEC is an item in the common agenda of a Korean/Dutch steering group guarding the progress of the agreements during the trade mission § This SMP has prepared well and paved a good way for future global IPEC project 9
Project follow up Barneveld will lead from now on for global IPEC: 1. Start lobbying the most top-level decision makers in S. Korea for IPEC 2. Starting a pilot e-learning with Harim 3. Making short time results: • Website • Office/meeting room in Iksan • Setting up a working group with mandate 4. Evaluating and adapting the consortium to the outcome of the feasibility study 5. Preparing a PPS for implementation of attainable program parts 10
Thanks! 11
