Welcome Update on ESS Construction Project Spectroscopy STAP Meeting 13 th of April 2018 Ken Andersen, Neutron Instruments Division, European Spallation Source ERIC
Welcome! • This is a test! – we are trying a video-conferencing format for some STAP meetings – two STAP meetings per year, synchronised with SAC meetings 2

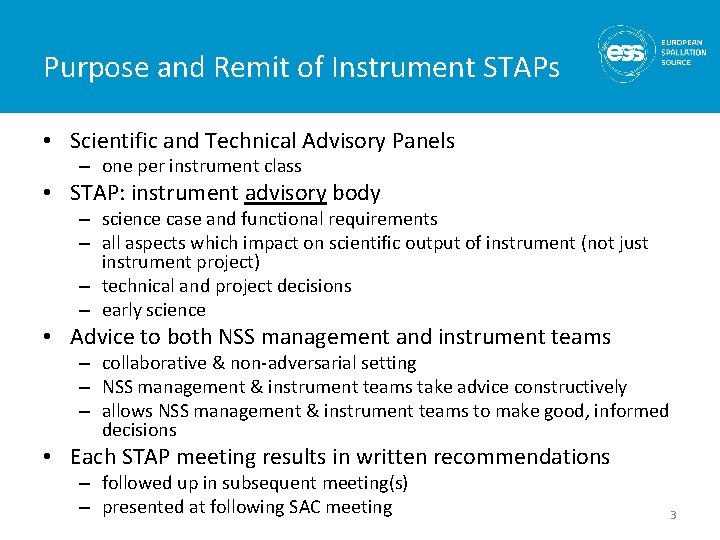

Purpose and Remit of Instrument STAPs • Scientific and Technical Advisory Panels – one per instrument class • STAP: instrument advisory body – science case and functional requirements – all aspects which impact on scientific output of instrument (not just instrument project) – technical and project decisions – early science • Advice to both NSS management and instrument teams – collaborative & non-adversarial setting – NSS management & instrument teams take advice constructively – allows NSS management & instrument teams to make good, informed decisions • Each STAP meeting results in written recommendations – followed up in subsequent meeting(s) – presented at following SAC meeting 3
Construction and Operations Budgets Construction Initial Operations Steady-State Operations 4

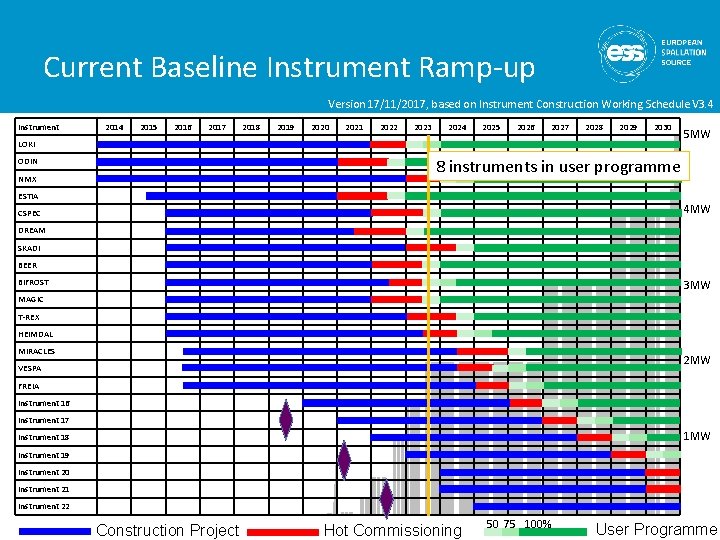

Current Baseline Instrument Ramp-up Version 17/11/2017, based on Instrument Construction Working Schedule V 3. 4 Instrument 2014 2015 2016 2017 2018 2019 2020 2021 2022 2023 2024 2025 2026 2027 2028 2029 2030 LOKI 5 MW 8 instruments in user programme ODIN NMX ESTIA 4 MW CSPEC DREAM SKADI BEER BIFROST 3 MW MAGIC T-REX HEIMDAL MIRACLES 2 MW VESPA FREIA Instrument 16 Instrument 17 1 MW Instrument 18 Instrument 19 Instrument 20 Instrument 21 Instrument 22 Construction Project Hot Commissioning 50 75 100% User Programme
Re-baselining in Progress • Delays to Conventional Facilities (CF) – changes imposed by Swedish Radiation Protection Authority (SSM) on dealing with earthquake requirements – redesign of target and instrument buildings delaying CF construction by 1 -2 years • Timeline – – – – Preliminary dates communicated to instrument teams in December additional information on instrument installation provided integrated installation plan presented at IKON 14 13 -15/2 updated CF dates received early March instrument schedule integration workshop 8 th May SAC meeting 3 -4/5 external review 22 -24/5 Council meeting in June: new baseline approved 6
Science Directorate re-baseline proposal (based on CF building access dates of 5 th March) A. Three user instruments be ready to start operation by end of 2023. Preferred First instruments to be: DREAM, ODIN & LOKI (+ Test Beam Line), B. First eight instruments ready to start operation by end of 2024. Add BEER, CSPEC, ESTIA, MAGIC & BIFROST to User Program C. All fifteen instruments ready to start operation by end of 2026. Add 7 more instruments to User Program over next two years Major schedule delays: Beam on Target Beam on 1 st Instrument Eight Instrument into User Program NSS project completion Preserved milestones: Start of user program (SOUP) in 2023 NSS project completion in 2025 = 21 months = 17 months = 16 months < 12 months (with zero float) (also with zero float). 7
First out-of-bunker access dates for Instrument Installation E 04 Dec 2019 1 Dec 2019 Black = baseline dates from 2016 Jan 2020 15 Dec 2019 E 03 May 2019 Sep 2019 E 01 15 Aug 2019 (incl. crane E 01) E 02 (2) Nov 2019 March – Sept 2021 30 April 2021 Grey = estimation 30 th Jan 2018 (shown at IKON 14) RED = fixed dates 5 th March 2018 December 2019 Dec 2020 - May 2021 21 Dec 2020 (crane operational 28 Jan 2021) D 03 D 02 April 2020 D 01 February 2020 April –Sep 2021 (full D 01 same date range) 19 May 2021 (crane operational 16 June 2021) 8

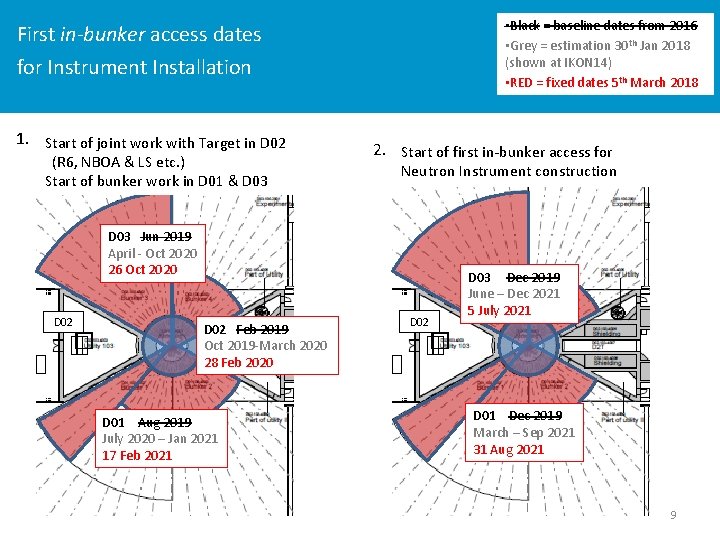

• Black = baseline dates from 2016 • Grey = estimation 30 th Jan 2018 (shown at IKON 14) • RED = fixed dates 5 th March 2018 First in-bunker access dates for Instrument Installation 1. Start of joint work with Target in D 02 (R 6, NBOA & LS etc. ) Start of bunker work in D 01 & D 03 2. Start of first in-bunker access for Neutron Instrument construction D 03 Jun 2019 April - Oct 2020 26 Oct 2020 D 02 Feb 2019 Oct 2019 -March 2020 28 Feb 2020 D 01 Aug 2019 July 2020 – Jan 2021 17 Feb 2021 D 02 D 03 Dec 2019 June – Dec 2021 5 July 2021 D 01 Dec 2019 March – Sep 2021 31 Aug 2021 9
Proposed rebaseline schedule for NBI* Installation (TG 4 –> TG 5) (V 4. -1, 26 th March 2018) (based on CF building access dates of 5 th March) NSS access to E 01 Cave installation & fitout OOB Guides & shielding Beam on Target Start User Program (3 NBI*) 8 NBI* in User Program In bunker installation Cold commissioning 0. 00 West sector North sector NSS access to D 03 East and South sectors NSS access to D 01 2019 * NBI = Neutron Beam Instrument 2020 2021 2022 2023 2024 2025 10
