UCSD Medical Center Hillcrest Campus Case Study Gerry

  • Slides: 16
Download presentation
UCSD Medical Center - Hillcrest Campus Case Study Gerry White Facilities Design & Construction

UCSD Medical Center - Hillcrest Campus Case Study Gerry White Facilities Design & Construction University of California, San Diego

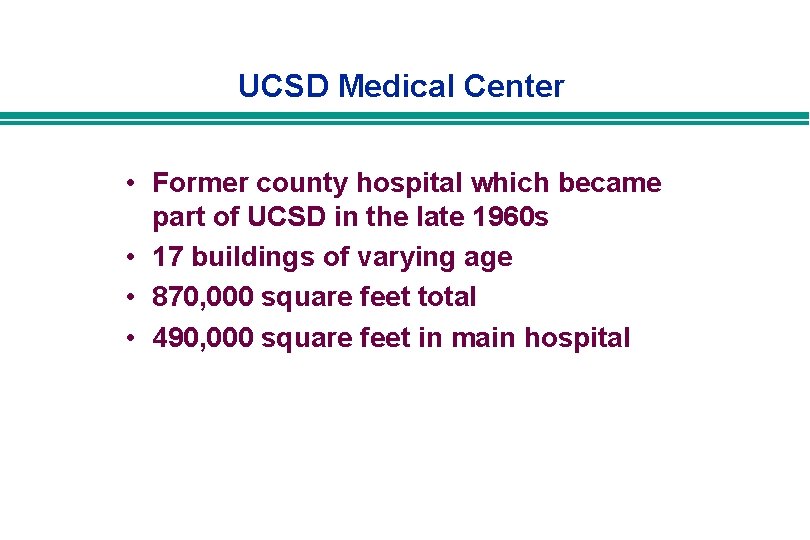

UCSD Medical Center • Former county hospital which became part of UCSD in the

UCSD Medical Center • Former county hospital which became part of UCSD in the late 1960 s • 17 buildings of varying age • 870, 000 square feet total • 490, 000 square feet in main hospital

UCSD Medical Center Original HVAC Equipment • Four chillers, 2380 tons capacity – Two

UCSD Medical Center Original HVAC Equipment • Four chillers, 2380 tons capacity – Two 760 ton centrifugal chillers, 1975, R-11 – 160 ton air cooled unit, 1982, R-22 – 700 ton 2 -stage absorption unit, 1991 • Three cooling towers • Primary chilled water distribution system • Four boilers – 3 can only operate at 60% of rated capacity – Unreliable and unsafe

UCSD Medical Center Original Electricity Consumption

UCSD Medical Center Original Electricity Consumption

UCSD Medical Center Original Gas Consumption

UCSD Medical Center Original Gas Consumption

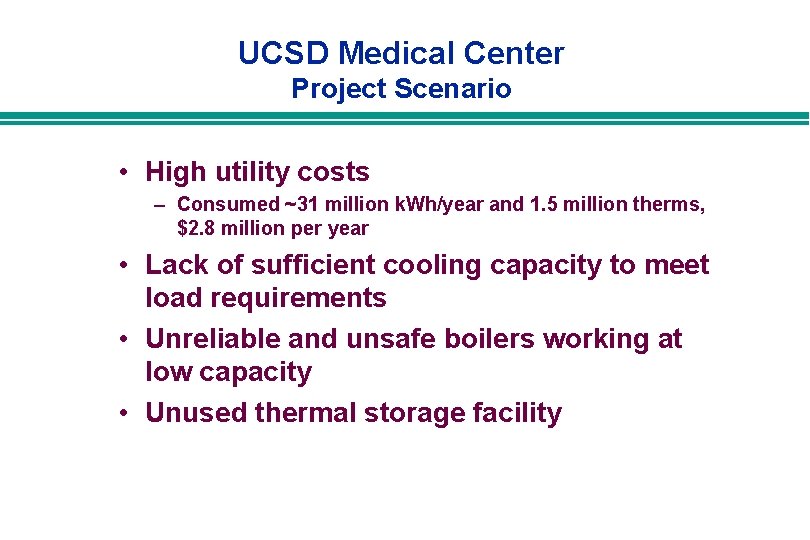

UCSD Medical Center Project Scenario • High utility costs – Consumed ~31 million k.

UCSD Medical Center Project Scenario • High utility costs – Consumed ~31 million k. Wh/year and 1. 5 million therms, $2. 8 million per year • Lack of sufficient cooling capacity to meet load requirements • Unreliable and unsafe boilers working at low capacity • Unused thermal storage facility

UCSD Medical Center Major Project Challenges • Selling project and finding financing – hospital

UCSD Medical Center Major Project Challenges • Selling project and finding financing – hospital finances very tight – project had to pay for itself • Keeping hospital operational – night and off-hour work – use of temporary chillers – transition from old to new controls

UCSD Medical Center Project Solutions • • • Load reductions Distribution system improvements New

UCSD Medical Center Project Solutions • • • Load reductions Distribution system improvements New central plant equipment New control system Recommissioned systems

UCSD Medical Center Load Reductions • Lighting improvements coincident with project – High efficiency

UCSD Medical Center Load Reductions • Lighting improvements coincident with project – High efficiency T-8 lamps with electronic ballasts – Changed over 15, 000 fixtures – Light levels maintained • Reactivated an old, unused thermal energy storage system – 3, 500 ton/hr system – 500 tons cooling capacity

UCSD Medical Center Distribution System Improvements • Air handling unit replacement – replaced several

UCSD Medical Center Distribution System Improvements • Air handling unit replacement – replaced several selected supply and exhaust units • Replaced AHU components – cooling coils & control valves • Chilled water system – converted to primary/secondary – changed to 2 -way valves

UCSD Medical Center Central Plant Equipment • Removed two oldest R-11 760 ton chillers

UCSD Medical Center Central Plant Equipment • Removed two oldest R-11 760 ton chillers – installed two new 750 ton R-123 chillers • Removed 3 older boilers – replaced with 2 new low NOx dual fuel boilers • Upgraded all chilled water and steam system plant auxillary systems

UCSD Medical Center Control Systems & Commissioning • Upgraded entire control system to direct

UCSD Medical Center Control Systems & Commissioning • Upgraded entire control system to direct digital control • Energy conservation strategies implemented – night-time AHU discharge temperature resets – discriminator controls set discharge temperatures to meet worst zone conditions • Recommissioned all HVAC systems and steam distribution system

UCSD Medical Center Integrated Economics

UCSD Medical Center Integrated Economics

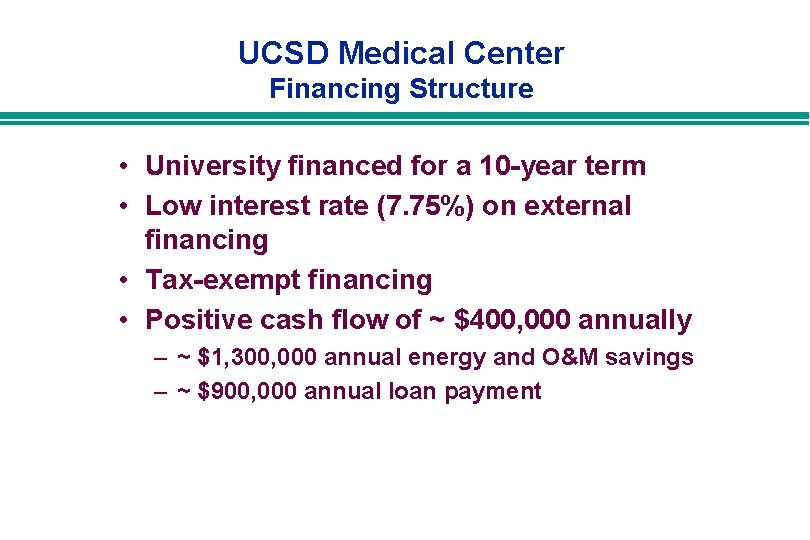

UCSD Medical Center Financing Structure • University financed for a 10 -year term •

UCSD Medical Center Financing Structure • University financed for a 10 -year term • Low interest rate (7. 75%) on external financing • Tax-exempt financing • Positive cash flow of ~ $400, 000 annually – ~ $1, 300, 000 annual energy and O&M savings – ~ $900, 000 annual loan payment

UCSD Medical Center Project Timeline 28 months to complete project

UCSD Medical Center Project Timeline 28 months to complete project

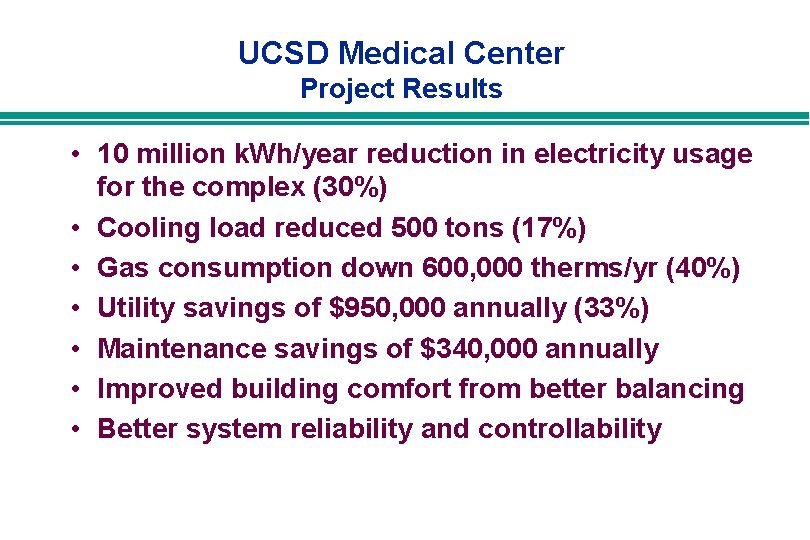

UCSD Medical Center Project Results • 10 million k. Wh/year reduction in electricity usage

UCSD Medical Center Project Results • 10 million k. Wh/year reduction in electricity usage for the complex (30%) • Cooling load reduced 500 tons (17%) • Gas consumption down 600, 000 therms/yr (40%) • Utility savings of $950, 000 annually (33%) • Maintenance savings of $340, 000 annually • Improved building comfort from better balancing • Better system reliability and controllability
