Offsite Improvements Project Construction Phasing & Traffic Impacts

Offsite Improvements Project Construction Phasing & Traffic Impacts

Construction Timeline

Construction Timeline

Stage 1 Construction • Demolition & Grading at 4 corners of intersection (outside of

Stage 1 Construction • Demolition & Grading at 4 corners of intersection (outside of roadway) • Installation of temporary signalization poles & lights • Traffic island demolition & temporary patch paving • Existing trees to be saved wherever possible Traffic Impacts • One-lane closures at times • Flagging • Streets open in all directions N 5 Week Duration Begin: 4/17/2010 Complete: 5/24/2010

Stage 2 7 Week Duration Begin: 5/24/2010 Complete: 7/27/2010 Construction • Underground Utility Street

Stage 2 7 Week Duration Begin: 5/24/2010 Complete: 7/27/2010 Construction • Underground Utility Street Crossings – New storm drain – Power & communications • Utility Installation Continues through Stage 5 Traffic Impacts • Multiple lane closures – Merge traffic around work N New Power & Comm. Stage 2 Power & Comm. Crossing Storm Crossing • Flagging – WSP to override traffic signal at times • Jefferson St. closed (between 14 th & 16 th Ave. ) – Detour Signage Stage 4 Stage 3 -5 New Power & Comm. Stage 3 -5 New Storm (incl. 16 th Ave. )

Stage 2 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th

Stage 2 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th Ave. will be detoured to Capitol Way via 14 th Ave. & Maple Park Dr. 7 Week Duration Begin: 5/24/2010 Complete: 7/27/2010 N

Stage 3 Construction • 14 th Ave. (South Half) – Surface demolition – Grading

Stage 3 Construction • 14 th Ave. (South Half) – Surface demolition – Grading – Temporary paving • Jefferson St. (S. of 14 TH) – Surface demolition – Grading – Surface improvements Traffic Impacts • 14 th Ave. traffic shifts north • Flagging & WSP • Jefferson St. is closed (between 14 th & 16 th Ave. ) – Detour Signage N 3 Week Duration Begin: 7/27/2010 Complete: 8/11/2010

Stage 3 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th

Stage 3 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th Ave. will be detoured to Capitol Way via 14 th Ave. & Maple Park Dr. 3 Week Duration Begin: 7/27/2010 Complete: 8/11/2010 N

Stage 4 Construction 7 Week Duration Begin: 8/11/2010 Complete: 9/21/2010 • 14 th Ave.

Stage 4 Construction 7 Week Duration Begin: 8/11/2010 Complete: 9/21/2010 • 14 th Ave. (North Half) – – Surface demolition Grading Surface Improvements Roundabout Construction • Jefferson St. (S. of 14 TH) – Surface improvements continue Traffic Impacts • 14 th Ave. traffic shifts south • Flagging & WSP • Jefferson St. is closed – Between 14 th – 16 th – N. of 14 th to job limits – Detour Signage N

Stage 4 Traffic Detours • Detours from stages 2 & 3 to remain •

Stage 4 Traffic Detours • Detours from stages 2 & 3 to remain • Traffic on Jefferson north of 14 th to be detoured to Union Ave. or Capitol Way for access to I -5 or 14 th Ave. 7 Week Duration Begin: 8/11/2010 Complete: 9/21/2010 N

Stage 5 Construction • 14 th Ave. (South Half) – Surface Improvements – Roundabout

Stage 5 Construction • 14 th Ave. (South Half) – Surface Improvements – Roundabout Construction • Jefferson St. (S. of 14 TH) – Surface improvements continue • 16 th Ave. (E. of Jefferson) – Surface improvements Traffic Impacts • 14 th Ave. traffic shifts around circle • Flagging & WSP • Jefferson St. is closed between 14 th & 16 th – Detour Signage N 8 Week Duration Begin: 9/21/2010 Complete: 11/13/2010

Stage 5 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th

Stage 5 Traffic Detours Local Jefferson St. traffic between 14 th & 16 th Ave. will be detoured to Capitol Way via 14 th Ave. & Maple Park Dr. 8 Week Duration Begin: 9/21/2010 Complete: 11/13/2010 N

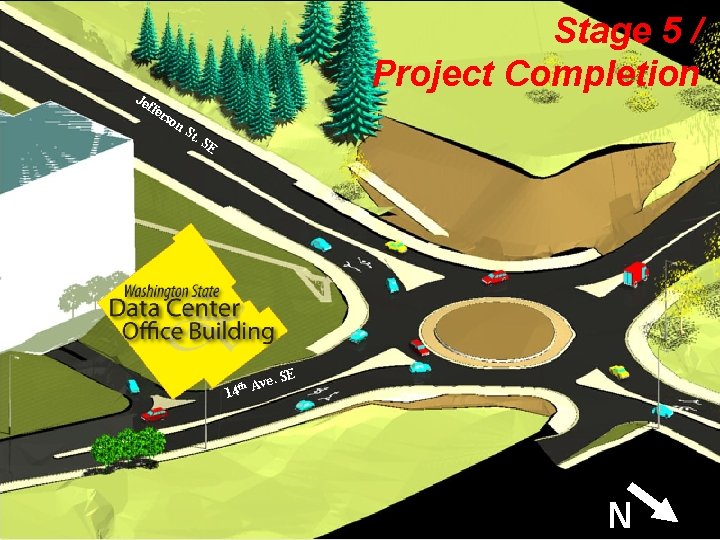

Je Stage 5 / Project Completion ffe rso n. S t. S E ve.

Je Stage 5 / Project Completion ffe rso n. S t. S E ve. A 14 th SE N
