FEE PPS Status Enzo Carrone June 8, 2009 FEE PPS Status FAC E. Carrone Enzo. carrone@slac. stanford. edu

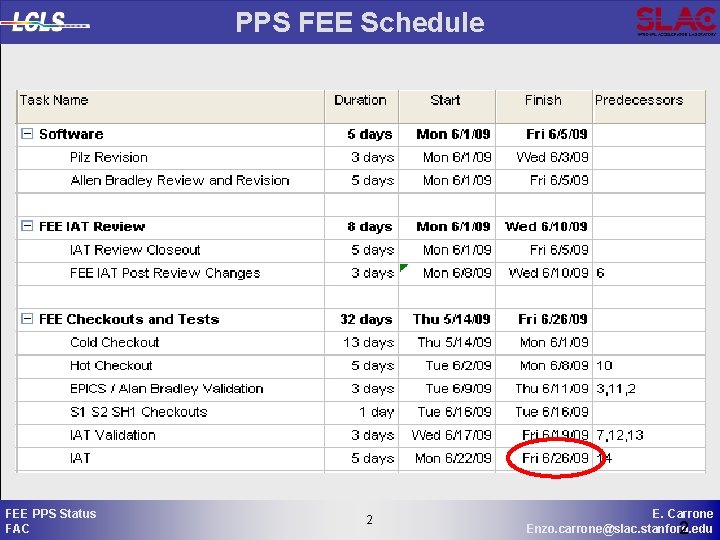

PPS FEE Schedule FEE PPS Status FAC 2 2 E. Carrone Enzo. carrone@slac. stanford. edu 2
FEE/NEH Schedule FEE PPS Status FAC 3 3 E. Carrone Enzo. carrone@slac. stanford. edu
Critical Path FEE PPS Status FAC “Enhanced” QA/QC activities 4 4 E. Carrone Enzo. carrone@slac. stanford. edu

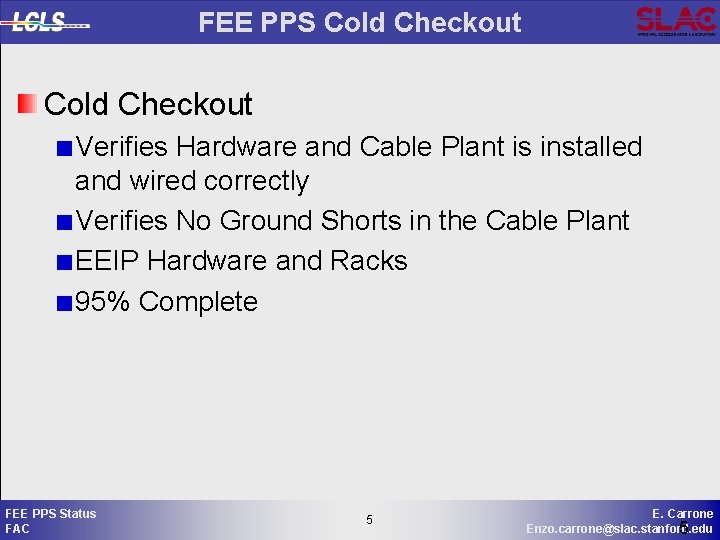

FEE PPS Cold Checkout Verifies Hardware and Cable Plant is installed and wired correctly Verifies No Ground Shorts in the Cable Plant EEIP Hardware and Racks 95% Complete FEE PPS Status FAC 5 5 E. Carrone Enzo. carrone@slac. stanford. edu 5

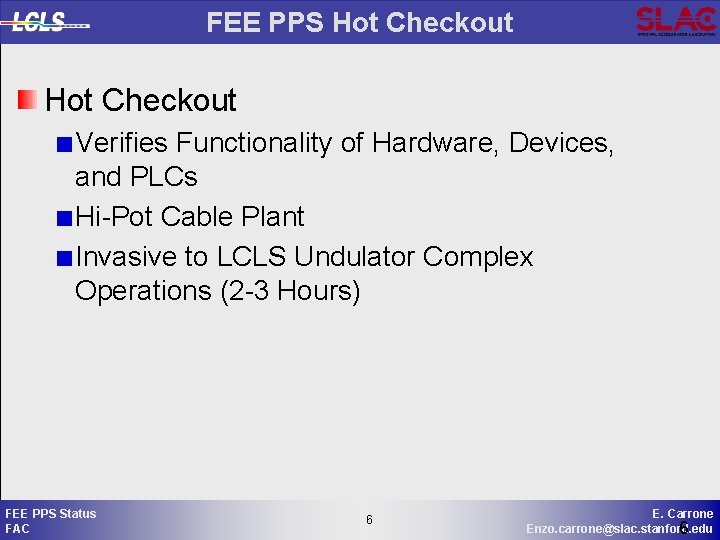

FEE PPS Hot Checkout Verifies Functionality of Hardware, Devices, and PLCs Hi-Pot Cable Plant Invasive to LCLS Undulator Complex Operations (2 -3 Hours) FEE PPS Status FAC 6 6 E. Carrone Enzo. carrone@slac. stanford. edu 6

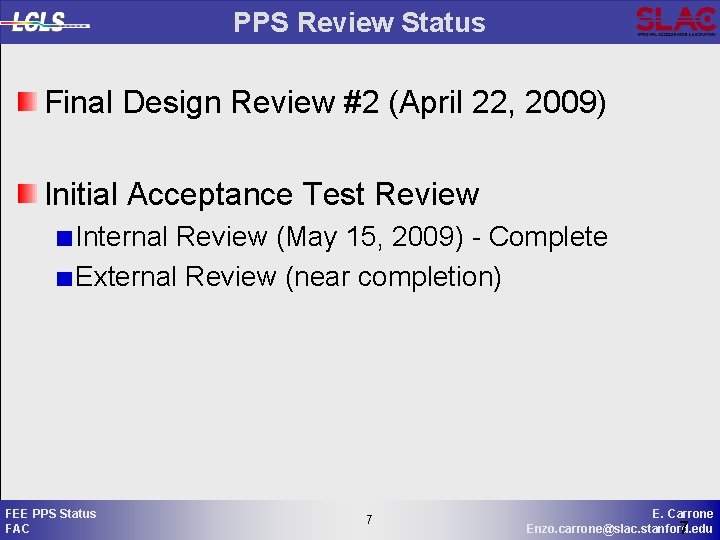

PPS Review Status Final Design Review #2 (April 22, 2009) Initial Acceptance Test Review Internal Review (May 15, 2009) - Complete External Review (near completion) FEE PPS Status FAC 7 7 E. Carrone Enzo. carrone@slac. stanford. edu 7

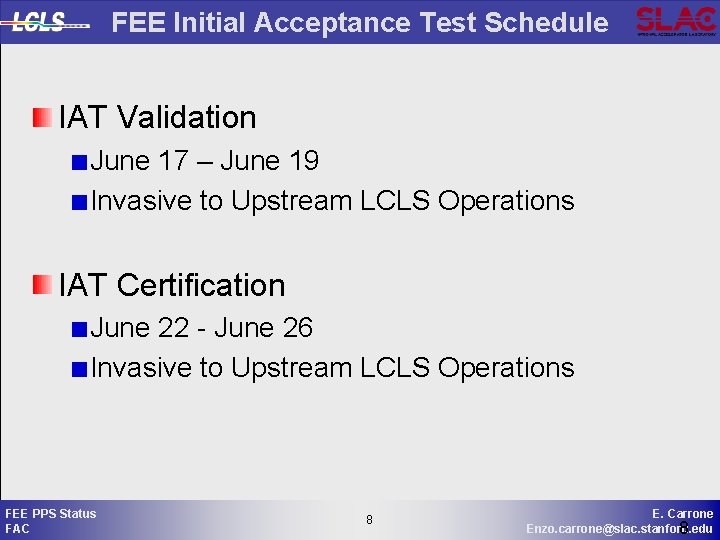

FEE Initial Acceptance Test Schedule IAT Validation June 17 – June 19 Invasive to Upstream LCLS Operations IAT Certification June 22 - June 26 Invasive to Upstream LCLS Operations FEE PPS Status FAC 8 8 E. Carrone Enzo. carrone@slac. stanford. edu 8
