YETS framework • YETS will start one week earlier (Dec 4 th instead of

YETS framework • YETS will start one week earlier (Dec 4 th instead of Dec 11 th). The extra week has been requested by CMS in order to extract the pixel tracker (DC-DC issue). • Following the issue in 16 L 2, it has been decided to warm up S 12 to ambient temperature. • Access to UX 25 from Mon Dec 4 th to Sun Mar 25 th (16 weeks). Decision to not open L 3 doors, no removal of shieldings this year. • Start beam commissioning expected 2 nd April (17 weeks beam to beam). YETS planning - 1 Dec 2017 2

Access • Access starts Monday 4 th at 9: 00 • UX cavern in

Access • Access starts Monday 4 th at 9: 00 • UX cavern in General mode • Magnets OFF and interlocked (already since Mon 27. 11) • No access in these dates: • AUG test – 20 th Dec – no access on entire site • Safety test: 4 th January after 17: 00 – no access underground • Beam Interlock Warning Test (from 6: 00 PM): 20 th and 21 st February (patrol not needed) – no access underground after 18: 00 • DSO test: 2 nd and 3 rd March (patrol needed) – no access underground YETS planning - 1 Dec 2017 3

LHC-EYETS: Constraints (Link to plannings) 4 LHC coordination meeting 28 th November 2017

LHC-EYETS: Constraints (Link to plannings) 4 LHC coordination meeting 28 th November 2017

Draft 2018 schedule (Q 1 and Q 2) YETS planning - 1 Dec 2017

Draft 2018 schedule (Q 1 and Q 2) YETS planning - 1 Dec 2017 5

Services availability during YETS • Electricity: • AUG test on 20 th Dec NO

Services availability during YETS • Electricity: • AUG test on 20 th Dec NO ACCESS TO P 2 (surface, underground). People who want to access surface must contact now TC • AUG in Meyrin on 6 th Jan (this will of course not affect P 2, but might affect users as it will cut offices, labs etc) • Test secours (10’): 9 th Jan (6: 00 AM – 6: 10 AM) details in next slide • Test “auto transfert”: 27 th and 28 th Jan (transparent) • Cooling and ventilation: • Maintenance scheduled in Feb (w 6 -7 -8) details in next slides • Gas: • details in next slides • Flammable gases: isobutane and methane stopped already on Monday 27 th Nov. Arcal-15 will be kept circulating until Thursday 21 st Jan, then it will be stopped for the whole CERN closure period (restart the 8 th). During that time Arcal-10 will be used instead (non-flammable). • Maintenance flammable gas detection system (done after CV maintenance of SG 2 in w 5) — will stop all flammable gases YETS planning - 1 Dec 2017 6

EN-EL: test secours Planned for Tuesday, 9 th Jan, at 6: 00 AM (10’)

EN-EL: test secours Planned for Tuesday, 9 th Jan, at 6: 00 AM (10’) For P 2 this will affect: • all buildings including SX 2 and SXL 2 • all offices, meeting rooms, wall outlets, light, coffee machine • the non UPS part of the ARC • the non UPS part of the detector cooling plants (this will trigger interlocks, e. g. LV) • the gas systems (PLCs stopped, interlocks triggered) Stop gas systems beforehand? • the circulation of iced and mixed water, ventilation (will restart after the 10 min. interruption) Are NOT affected at P 2: • all equipment on UPS (notably all CRs and inside ARC) • all racks in CR and UX As we do not know if all ventilation will restart OK, we will suspend cavern access until we confirm that all is nominal Note that this test is CERN-wide, so it will also affect your offices, labs etc. YETS planning - 1 Dec 2017

Cooling and ventilation maintenance • Ventilation units: • Week 5: maintenance UX 25 ventilation

Cooling and ventilation maintenance • Ventilation units: • Week 5: maintenance UX 25 ventilation systems (ITS/PMD/MCH/MTR) — 29 -30 -31. 1 NO access inside L 3 (stop L 3 ventilation) + 1 day no access inside FASS • Week 5 -6: UX 25 extraction/injection: 30’ interruptions — no impact on access • Week 5: SG 2 maintenance — will STOP flammable gases (Ar-H 2) for 3 days • Primary cooling: • Week 6: demineralized water UW 25 (stop L 3, Dipole) • Week 7: stop cooling towers (use external chillers). L 3 and Dipole cooling maintenance • Week 8: mixed-water UW 25 + PX 24 (use external chiller) — STOP chilled-water on Tue 20. 2 (will affect all cavern racks and cooling plants) (switch PX 24 racks to raw-water) • Detector cooling units: • • • 12 -13 February: TPC FEEC + ROD 14 -15 February: TRD 16 February: HMPID 19 -20 February: SPD 21 -22 February: SSD-SDD 23 February: TOF – PHOS YETS planning - 1 Dec 2017 8

Replacement rack supervision PLC • Intervention in weeks 7 -8 • Will cut all

Replacement rack supervision PLC • Intervention in weeks 7 -8 • Will cut all racks (UX, CRs) one by one: • PX 24: 13 th February • UX 25: 20 th and 21 st February YETS planning - 1 Dec 2017 9

Gas system status during YETS System Status Run supply Backup MCH ON Ar-CO 2

Gas system status during YETS System Status Run supply Backup MCH ON Ar-CO 2 MTR OFF PMD CPV HMPID envelope PHOS TOF TRD OFF OFF ON ON OFF ON TPC envelope ON Comment Switch to N 2 during CERN closure Stop flammable gas Nov 27 th. Outlet chambers to C 2 H 2 F 4 -i. C 4 H 10 -SF 6 C 2 H 2 F 4 purge for 1 -2 days. atmp. Restart Feb-Mar Ar-CO 2 Stop Nov 27 th Ar-CO 2 N 2 Stop Nov 27 th (restart in Feb) CH 4 Flushing by Argon Stop methane Nov 27 th N 2 manual supply C 2 H 2 F 4 -SF 6 C 2 H 2 F 4 Stop Nov 27 th Xe-CO 2 No cryo regeneration Switch to Ar-CO 2 during YETS Ne-CO 2 -N 2 Supply Ne-CO 2 -N 2 to TPCU CO 2 Bronkhorst supply YETS planning - 1 Dec 2017 10

Detector activities 1/3 • ITS: • Replacement of 5 pressure regulator in the SDD

Detector activities 1/3 • ITS: • Replacement of 5 pressure regulator in the SDD cooling plant • TPC: • Clean TPC FC walls with use of endoscope and cleaning tools, new gas humidifier in CR 5 • TPC x-ray irradiation (inspection 5 Dec with Klaus) • FEE checks, LVPS checks • T 0: • Investigation problem with QTC and Delay modules (access to rack C 33 -c 34) • Investigation problem with mainframe SY 1527 (CR 4), broke due to one module A 1532 was shorted. YETS planning - 1 Dec 2017 11

Detector activities • • 2/3 TOF: • TDC Readout Module (TRM) 03, 04 crate

Detector activities • • 2/3 TOF: • TDC Readout Module (TRM) 03, 04 crate 63 (SM 15, C-side) to replace. • Upgraded firmware (for continuous readout) to install in 10 TRMs (on A-side). If this (testing) installation fails more TRMs might be replaced • Local Trigger Module on crate 07 (SM 01, C-side) to replace • DCDC converter (A 1396) crate 43 (SM 10, C-side) to replace next week • Displacement of one Super Module (SM 01) requested by the Tech. Coordination: verification access for TPC-TRD-TOF LV cables replacement in back-frame TRD: • No hardware intervention planned at the detector, but we will upgrade the Wiener LV PS firmware, together with Mateusz from the DCS team. This is planned for January 18+19. It will require access to the galleries YETS planning - 1 Dec 2017 12

Detector activities 3/3 MTR: • Replacement gas gaps of two MTR RPCs in February

Detector activities 3/3 MTR: • Replacement gas gaps of two MTR RPCs in February (date tbc). Need nacelle (Iside) + open UP 25 (passage via LHC tunnel + PM crane) • Electronics checks: 12 to 14 December. Need nacelle (I-side) MCH: 1. Slats (nacelle needed) • Exchange few slats (which undergo HV trips); these slats will be repaired in Saclay antenna at CERN. • The work will be done in January (15. 1 to 31. 1) 2. Quadrants station 2 • 2 quadrants of Station 2 will be removed and repaired • The work will be done from mid-January to mid-February 3. Quadrants of station 1 • Check HV filter card (capacitors) in cavern YETS planning - 1 Dec 2017 13

Other activities • TE-VSC: close beampipe manual valve (4 th Dec) • Fire detection

Other activities • TE-VSC: close beampipe manual valve (4 th Dec) • Fire detection maintenance: 13 to 18 December • Fire & smoke detection maintenance (racks): 26 Feb to 2 Mar • Installation fire detection inside SXL 2 hall from 18 to 21. 12 (except 20. 12 for AUG). Need crane driver • ITS air ventilation duct (inside UX 25 cavern) (ENGIE) • TC: • (Corrado): install accelerometers inside L 3 • (Arturo): tent for TRD (low-beta) – Arturo to organize inspection with TRD/SMB • (Arturo): installation storage tent outside SX 2 parking: 6 to 8 March • (Antonio): refurbishment Yellow Platform (inside SX 2) during weeks 5 -6 and 8 • (Arturo, Elisa): visit of Criotec to inspect the ITS inox pipes (rework inox pipes in LS 2) – January 9 th at 14: 00 (tbc) YETS planning - 1 Dec 2017 14

Cabling activities (EN-EA and EN-EL) • Verification feasibility LV cables replacement (back-frame). Displacing TOF

Cabling activities (EN-EA and EN-EL) • Verification feasibility LV cables replacement (back-frame). Displacing TOF SM 1 (date tbc) • Installation scaffolding PX 24 shaft (inside cavern) (for LS 2 cables and OF) • Installation missing cable trays (mostly PX 24 shaft, not in cavern) • Determination lengths of optical fibers (EN-EL) • Installation TPCU A-side HV cables – wo connectors for the moment (request to install connectors on a fraction of them, to test the "protection resistor boxes") • Pull 2 Ethernet cables for A- and C-side cameras • Test FIT cables (ALICE) YETS planning - 1 Dec 2017 15

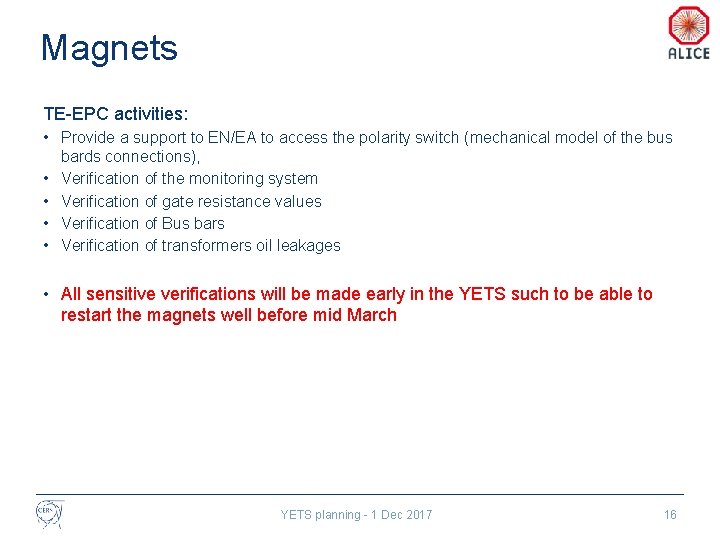

Magnets TE-EPC activities: • Provide a support to EN/EA to access the polarity switch

Magnets TE-EPC activities: • Provide a support to EN/EA to access the polarity switch (mechanical model of the bus bards connections), • Verification of the monitoring system • Verification of gate resistance values • Verification of Bus bars • Verification of transformers oil leakages • All sensitive verifications will be made early in the YETS such to be able to restart the magnets well before mid March YETS planning - 1 Dec 2017 16

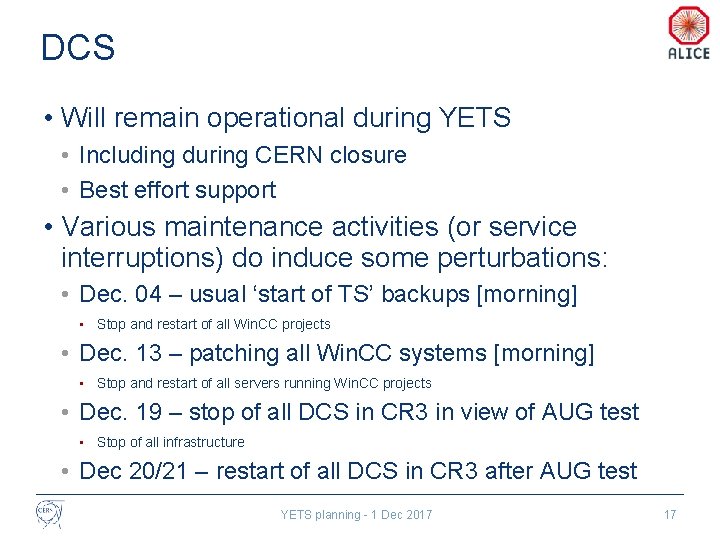

DCS • Will remain operational during YETS • Including during CERN closure • Best

DCS • Will remain operational during YETS • Including during CERN closure • Best effort support • Various maintenance activities (or service interruptions) do induce some perturbations: • Dec. 04 – usual ‘start of TS’ backups [morning] • Stop and restart of all Win. CC projects • Dec. 13 – patching all Win. CC systems [morning] • Stop and restart of all servers running Win. CC projects • Dec. 19 – stop of all DCS in CR 3 in view of AUG test • Stop of all infrastructure • Dec 20/21 – restart of all DCS in CR 3 after AUG test YETS planning - 1 Dec 2017 17

DCS • Cont’d • Jan. 05 – stop of DCS in Meyrin in view

DCS • Cont’d • Jan. 05 – stop of DCS in Meyrin in view of AUG test • Stop of non critical services (e. g. Amanda); restart on Monday Jan 08 • Feb. 13 – stop of all DCS in CR 3 in view of EL test • Stop of all infrastructure, restart on same day • Feb. 20 – installation latest patches and final maintenance • In shadow of cooling interventions. Possible stop of all infrastructure, restart on same day. • Detector DCS • New version of Frame. Work being validated, when certified detectors will have to update. Aiming for end January • Some updates to operation procedures is still to be implemented by several detectors (e. g. in go safe procedure). • These activities will be coordinated with detector experts directly YETS planning - 1 Dec 2017 18

DAQ • Power off CR 1 and ARC: 19/12 PM. • Power on CR

DAQ • Power off CR 1 and ARC: 19/12 PM. • Power on CR 1 and partial ARC (only shifters and RC stations): 10 -11/1 YETS planning - 1 Dec 2017 19

Access to CERN during CERN closure • This year, CERN will be closed from

Access to CERN during CERN closure • This year, CERN will be closed from Saturday, 23 December 2017 to Sunday, 7 January 2018 inclusive. The first working day of the new year will be Monday, 8 January 2018. • The only persons who will be entitled to enter the CERN site during the end-of-year closure are those who have received authorisation to do so for strictly professional reasons such as stand-by service and indispensable maintenance work. • For the access procedures, please read carefully the official instructions published here: • https: //home. cern/cern-people/official-communications/2017/11/accessorganizations-site-during-end-year-closure • Please contact now TC if you think you should be allowed to access the CERN premises during this time (need solid justification) YETS planning - 1 Dec 2017 20

Inspection rounds during CERN closure • As every year a daily inspection will done

Inspection rounds during CERN closure • As every year a daily inspection will done at P 2 during CERN End of Year closure (Sat. 23. 12 – Sun. 07. 01) • Thanks to all people that volunteered! • Inspection round includes SX 2 (ARC), SXL 2 (cleanroom), CR 1 -5, SG and Cavern • Remote monitoring of infrastructure and equipment remains possible, since DCS is available • Contact André if there is anything in particular you want to be checked YETS planning - 1 Dec 2017

Underground visits • Underground visits possible from Monday 4 December 2017 to Sunday 25

Underground visits • Underground visits possible from Monday 4 December 2017 to Sunday 25 March 2018 (except 14 to 18 Dec, 20 Dec, 23 Dec to 7 Jan and 2 -3 March) • Visit instructions and calendar: https: //alicecollaboration. web. cern. ch/general/alice_visits. html • Requests must be sent to alice-visits@cern. ch YETS planning - 1 Dec 2017 22
