Work Zone Safety Using Accelerated Bridge Construction ABC
Work Zone Safety Using Accelerated Bridge Construction (ABC) Rukhsana Lindsey, UDOT Presented by Jim Mc. Minimee Principal Engineer, Applied Research Associates
Utah § Small State • 2. 5 M people • $350 M Federal Program • DOT 1650 employees • Currently 6% unemployment statewide § Big Transportation Program • 250+ projects • $3+ B under construction
Our Need for Speed § Customer driven culture § Willing to take risks § Implement new technologies: • Accelerated Bridge Construction • Accelerate Pavement Construction • Diverging Diamond Interchanges § Increased partnerships
Department Themes § Accelerate Delivery § Decrease and Minimize Detours or Delays § Encourage Innovation that speeds project or provides value § Get a Good Price Balance of good price vs other themes
New Business Model • Societal Costs Minimized • Societal cost model includes safety costs • Lowest Construction Cost Project Cost • Public Praise • Political Capital Lowest
I-15 Design Build a Case Study in Project Acceleration § I-15 Design Build – SEP 14 • $1. 6 B Contract • 17 Miles, 130 Bridges, 7 Urban/3 Interstate Interchanges • 10 Year Maintenance Period § Drivers for Project • Public Support – 4 Years Instead of 9 Years • 2002 Winter Olympics § I – 15 Incentives • Quality, Project Management, MOT, Early Completion • Potential $50 M § Post Mortem User Cost Study Uof. U Dr Martin • USER COSTS SAVED > $500 M • Saved estimated 4400+ accidents over Traditional • 14 Lives Saved
What is ABC? § Innovative methods to decrease bridge construction time § Build elements offsite/outside traffic area § Transport to site and install rapidly
Benefits of ABC § Minimized traffic disruption – from months to days § Improved work zone safety – improved worker safety § Improved product quality – controlled environment, cure times, easier access, etc.
Innovative Technology • • • First implementation costs more Potential for new methods to cost less Promise of time savings Positive cost-benefit ratios Promise of cost savings
Utah Precast Deck Panel Projects
Family of Innovative ABC Elements and Methods Innovative Accelerated Bridge Construction Precast Concrete Elements Modular Construction Structure Placement Methods Accelerated Geotech Work Fast Track Contracting
Benefits of ABC § § Minimizes traffic disruption from months to days Improves work zone and worker safety User savings Improves product quality • Controlled environment • Cure times • Easier access
Utah ABC Costs 18 projects $45 M User Savings Valued Added $30, 000 $25, 000 $20, 000 $15, 000 $10, 000 $5, 000 $0 I-215; 4500 South I-80; State St. to 1300 I-80; Mt. Delle to Lambs 3300 South over I-215 East Canyon I-15; Widening, 500 North to I-215 Pioneer Crossing
Animation
Media Support
UDOT ABC History ABC Element Projects Bridges Self Propelled Modular Transporters (SPMT) 8 17 Half Thickness Deck Panels 5 74 Full Depth Deck Precast Deck Panels 15 21 Precast Voided Slabs 1 2 Approach Slab Panels 10 15 Precast Sleeper Slabs 12 19 Precast Abutments 3 5 Precast Bent Caps 2 2 Precast Deck – Slide-in Technique 3 5 Precast Box Culvert 3 7 Heavy Lift Cranes 3 4
Projects I-84 Riverdale Road; Lego Bridge
Projects 800 North; Precast Deck Panels
Projects 4500 South over I-215; SPMT

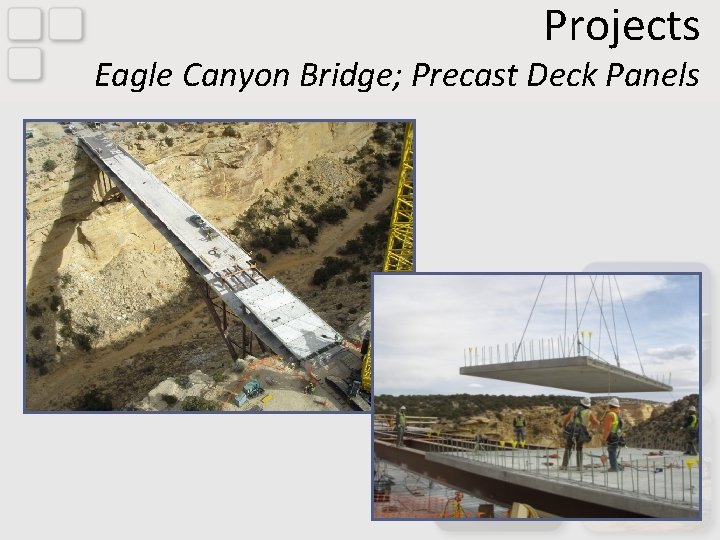

Projects Eagle Canyon Bridge; Precast Deck Panels
2009 Slide ins
2009 Slide ins
Projects Echo Canyon Bridge; Slide-in
UDOT Research Study § Reviewing status of ABC Program § 161 ABC projects § Started with SPMT projects
Preliminary Results § 18 Accelerated Bridge Projects- SPMTs • Traffic impacts Closures and Detours of 2 -3 days • Channelizing work zones of usual durations • Zero crashes within work zone(!) • Bridge built away from traffic with better worker safety and productivity. • One statistical surprise – Slightly more accidents after construction over.
Public Support for ABC Public Overall Satisfaction With Project Results (1 = not satisfied, 7 = very satisfied) 1; 0. 00% 2; 3; 0. 00% 1. 40% 4; 1. 40%5; 2. 80% 6; 18. 30% 7; 76. 10% 1 2 3 4 5 6 7
Questions?
