WORK DONE JUNE 2013 DRUG WING S No

- Slides: 32

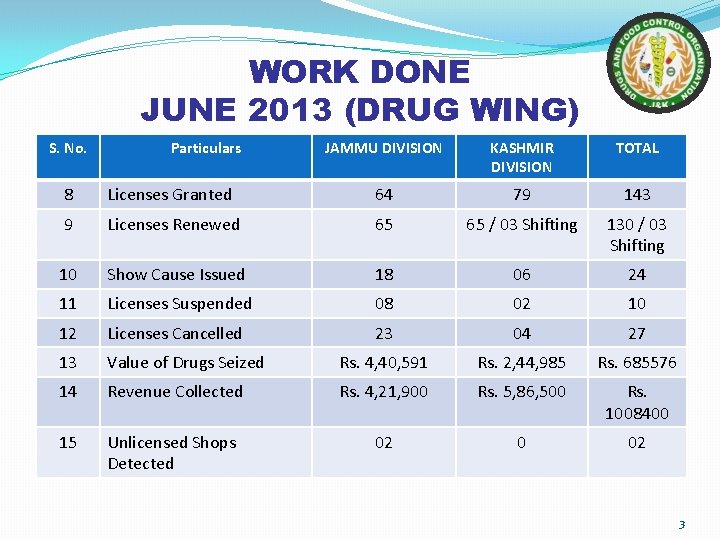

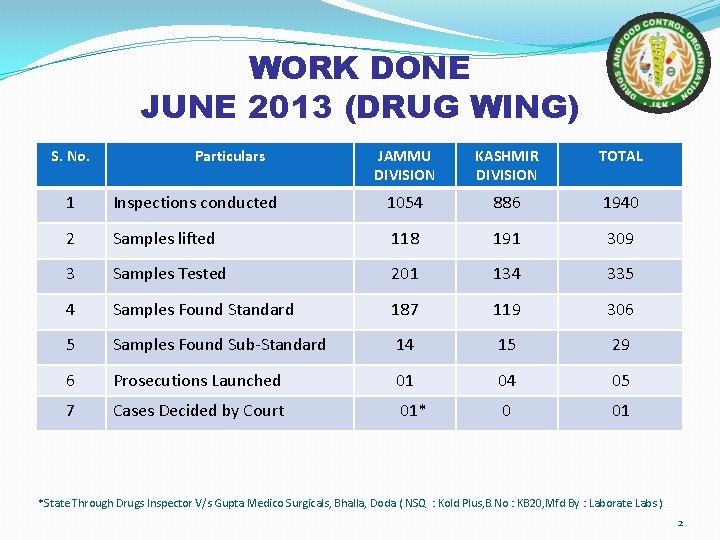

WORK DONE JUNE 2013 (DRUG WING) S. No. Particulars JAMMU DIVISION KASHMIR DIVISION TOTAL 1 Inspections conducted 1054 886 1940 2 Samples lifted 118 191 309 3 Samples Tested 201 134 335 4 Samples Found Standard 187 119 306 5 Samples Found Sub-Standard 14 15 29 6 Prosecutions Launched 01 04 05 7 Cases Decided by Court 01* 0 01 *State Through Drugs Inspector V/s Gupta Medico Surgicals, Bhalla, Doda ( NSQ : Kold Plus, B. No : KB 20, Mfd By : Laborate Labs ) 2
WORK DONE JUNE 2013 (DRUG WING) S. No. Particulars JAMMU DIVISION KASHMIR DIVISION TOTAL 8 Licenses Granted 64 79 143 9 Licenses Renewed 65 65 / 03 Shifting 130 / 03 Shifting 10 Show Cause Issued 18 06 24 11 Licenses Suspended 08 02 10 12 Licenses Cancelled 23 04 27 13 Value of Drugs Seized Rs. 4, 40, 591 Rs. 2, 44, 985 Rs. 685576 14 Revenue Collected Rs. 4, 21, 900 Rs. 5, 86, 500 Rs. 1008400 15 Unlicensed Shops Detected 02 0 02 3

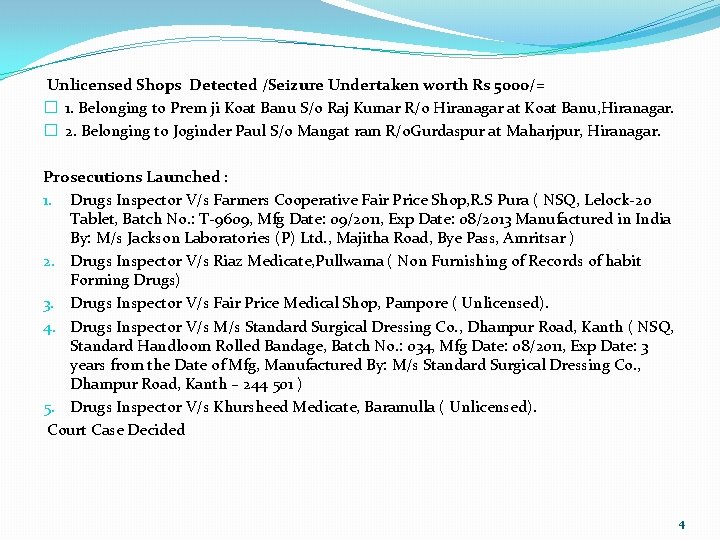

Unlicensed Shops Detected /Seizure Undertaken worth Rs 5000/= � 1. Belonging to Prem ji Koat Banu S/o Raj Kumar R/o Hiranagar at Koat Banu, Hiranagar. � 2. Belonging to Joginder Paul S/o Mangat ram R/o. Gurdaspur at Maharjpur, Hiranagar. Prosecutions Launched : 1. Drugs Inspector V/s Farmers Cooperative Fair Price Shop, R. S Pura ( NSQ, Lelock-20 Tablet, Batch No. : T-9609, Mfg Date: 09/2011, Exp Date: 08/2013 Manufactured in India By: M/s Jackson Laboratories (P) Ltd. , Majitha Road, Bye Pass, Amritsar ) 2. Drugs Inspector V/s Riaz Medicate, Pullwama ( Non Furnishing of Records of habit Forming Drugs) 3. Drugs Inspector V/s Fair Price Medical Shop, Pampore ( Unlicensed). 4. Drugs Inspector V/s M/s Standard Surgical Dressing Co. , Dhampur Road, Kanth ( NSQ, Standard Handloom Rolled Bandage, Batch No. : 034, Mfg Date: 08/2011, Exp Date: 3 years from the Date of Mfg, Manufactured By: M/s Standard Surgical Dressing Co. , Dhampur Road, Kanth – 244 501 ) 5. Drugs Inspector V/s Khursheed Medicate, Baramulla ( Unlicensed). Court Case Decided 4

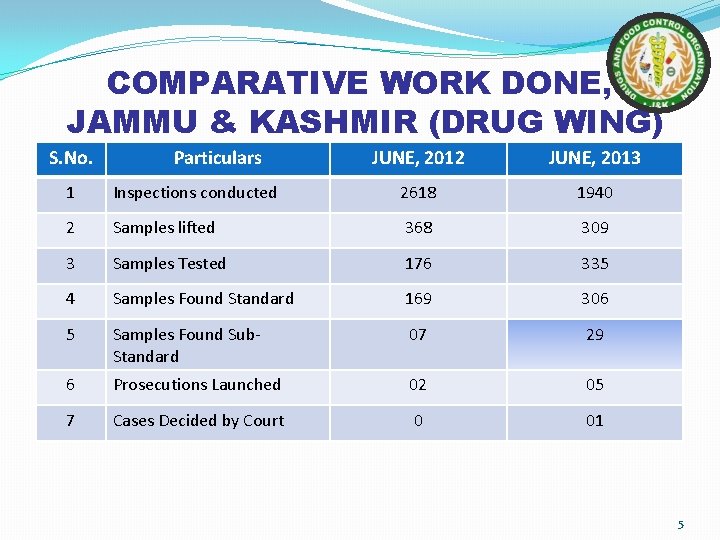

COMPARATIVE WORK DONE, JAMMU & KASHMIR (DRUG WING) S. No. Particulars JUNE, 2012 JUNE, 2013 1 Inspections conducted 2618 1940 2 Samples lifted 368 309 3 Samples Tested 176 335 4 Samples Found Standard 169 306 5 Samples Found Sub. Standard 07 29 6 Prosecutions Launched 02 05 7 Cases Decided by Court 0 01 5

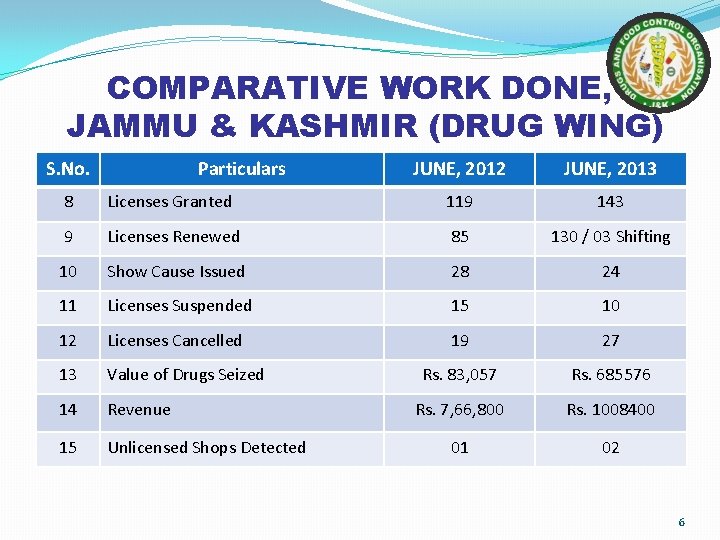

COMPARATIVE WORK DONE, JAMMU & KASHMIR (DRUG WING) S. No. Particulars JUNE, 2012 JUNE, 2013 8 Licenses Granted 119 143 9 Licenses Renewed 85 130 / 03 Shifting 10 Show Cause Issued 28 24 11 Licenses Suspended 15 10 12 Licenses Cancelled 19 27 13 Value of Drugs Seized Rs. 83, 057 Rs. 685576 14 Revenue Rs. 7, 66, 800 Rs. 1008400 15 Unlicensed Shops Detected 01 02 6
7

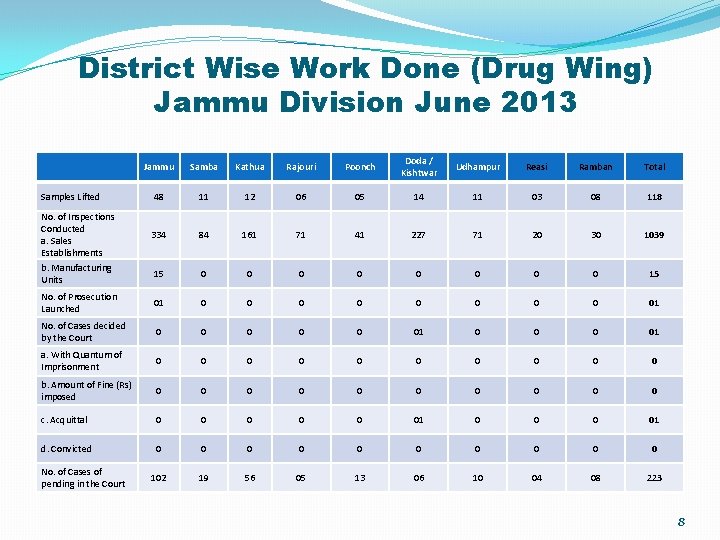

District Wise Work Done (Drug Wing) Jammu Division June 2013 Jammu Samba Kathua Rajouri Poonch Doda / Kishtwar Udhampur Reasi Ramban Total 48 11 12 06 05 14 11 03 08 118 334 84 161 71 41 227 71 20 30 1039 15 0 0 0 0 15 No. of Prosecution Launched 01 0 0 0 0 01 No. of Cases decided by the Court 0 0 01 a. With Quantum of Imprisonment 0 0 0 0 0 b. Amount of Fine (Rs) imposed 0 0 0 0 0 c. Acquittal 0 0 01 d. Convicted 0 0 0 0 0 102 19 56 05 13 06 10 04 08 223 Samples Lifted No. of Inspections Conducted a. Sales Establishments b. Manufacturing Units No. of Cases of pending in the Court 8

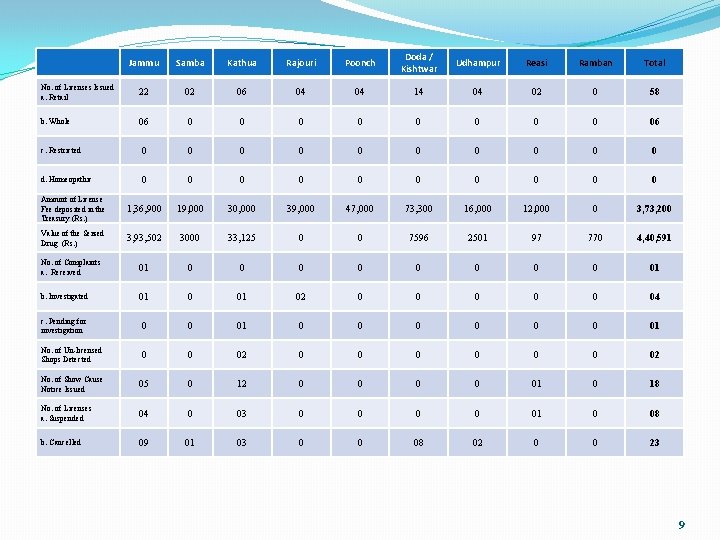

Jammu Samba Kathua Rajouri Poonch Doda / Kishtwar Udhampur Reasi Ramban Total No. of Licenses Issued a. Retail 22 02 06 04 04 14 04 02 0 58 b. Whole 06 0 0 0 0 06 c. Restricted 0 0 0 0 0 d. Homeopathic 0 0 0 0 0 Amount of License Fee deposited in the Treasury (Rs. ) 1, 36, 900 19, 000 30, 000 39, 000 47, 000 73, 300 16, 000 12, 000 0 3, 73, 200 Value of the Seized Drug (Rs. ) 3, 93, 502 3000 33, 125 0 0 7596 2501 97 770 4, 40, 591 No. of Complaints a. Received 01 0 0 0 0 01 b. Investigated 01 02 0 0 04 c. Pending for investigation 0 0 01 0 0 0 01 No. of Un-licensed Shops Detected 0 0 02 0 0 0 02 No. of Show Cause Notice Issued 05 0 12 0 0 01 0 18 No. of Licenses a. Suspended 04 0 03 0 0 01 0 08 b. Cancelled 09 01 03 0 0 08 02 0 0 23 9
Jammu Samba Kathua Rajouri Poonch Doda / Kishtwar Udhampur Reasi Ramban Total No of premises existing at the end of the Month a. Retail 2467 320 504 315 238 497 329 218 196 5084 b. Whole. 1469 21 53 12 06 29 64 04 11 1669 01(BB)/03(BS C) 01(BB) / 02 (BSC) 02 (BB) c. Manufacturing Units(Allopathic + Ayurvedic) (including Loan licensee) , Blood Banks & Blood Storage Centre Violation detected in regard to DPCO under Essential Commodities Act. No. of Shops detected being run without Qualified Person / Not maintaining / Purchase Records. Any other information related to Drug side (License Renewed) 18/06(BB)/02 (BSC) 45/01 (BB)/01(BSC) 65 / 13 (BB) / 12(BSC) 02/02(BB)/04(BSC) 0 0 02 0 0 0 01 0 03 30 03 04 07 10 07 02 02 0 65 10
11
District Wise Work Done (Drug Wing) Kashmir Division June 2013 Srinagar Budga m Anantn ag Kulgam Baramulla Kupwara Ganderbal Bandipora Pulwama Shopian Leh Kargil Mfg Total 47 14 30 08 20 12 15 15 16 09 03 02 0 191 219 46 174 71 57 33 80 80 63 40 14 05 0 882 b. Manufacturing Units - - - 04 04 No. of Prosecution Launched 01 0 0 0 02 0 0 04 No. of Cases decided by the Court 0 0 0 0 a. With Quantum of Imprisonment 0 0 0 0 b. Amount of Fine (Rs) imposed 0 0 0 0 c. Acquittal 0 0 0 0 d. Convicted 0 0 0 0 No. of Cases of pending in the Court 90 08 11 02 11 08 03 10 23 09 07 05 0 187 No. of Licenses Issued a. Retail 11 02 06 03 06 08 02 04 04 01 02 02 0 51 Samples Lifted No. of Inspections Conducted a. Sales Establishments 12

Srinagar Budgam Anant nag Kulgam Baramulla Kupwara Ganderbal Bandipora Pulwama Shopian Leh Kargil Mfg Total 11 05 08 0 01 0 02 0 0 28 c. Restricted/Mfg. 0 0 0 0 d. Homeopathic 0 0 0 0 2, 16, 500 49, 000 1, 61, 000 44, 000 62, 000 6000 15, 000 18, 000 9000 3000 0 5, 86, 50 0 223435 0 6300 7080 0 7020 0 1150 0 0 2, 44, 98 5 01 01 0 0 0 04 b. Investigated 0 0 01 01 0 0 0 03 c. Pending for Investigation 01 0 0 0 0 0 0 0 04 0 01 0 0 06 0 0 01 0 0 0 0 02 01 0 02 0 01 0 0 0 04 No of premises existing at the end of the Month a. Retail 1232 452 1176 437 723 538 202 214 551 294 45 34 0 5898 b. Whole Sale. 1308 138 816 91 275 91 26 36 313 59 07 02 0 3162 b. Whole Sale Amount of License Fee deposited in the Treasury (Rs. ) Value of the Seized Drugs (Rs. ) No. of Complaints a. Received No. of Un. Licensed Shops detected No. of Show Cause Notice issued No. of Licenses a. Suspended b. Cancelled 13
c. Manufacturing Units(Allopathic +Ayurvedic) (including Loan licensee) , Blood Banks & Blood Storage Centre Violation detected in regard to DPCO under Essential Commodities Act. No of shops detected being run without Qualified Person. No of Chemists shops not maintaining Sale / Purchase Record. Any other information related to drug side (License Renewed). Srinagar Budga m Anantnag Kulga m Baramulla Kupwara Ganderbal Bandipora Pulwama Shopian Leh Kargil Mfg Total - - - - 16 BB / 12 Mfg / 04 BSC 0 0 0 0 0 0 0 0 02 0 0 02 29 / 03 Shifting 08 08 04 05 04 0 0 03 02 02 0 0 65 / 03 Shiftin g 14

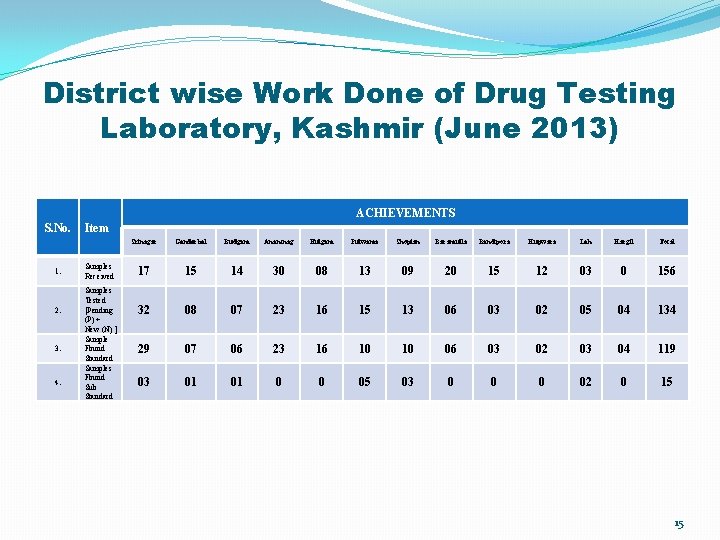

District wise Work Done of Drug Testing Laboratory, Kashmir (June 2013) ACHIEVEMENTS S. No. 1. 2. 3. 4. Item Samples Received Samples Tested [Pending (P) + New (N) ] Sample Found Standard Samples Found Sub Standard Srinagar Ganderbal Budgam Anantnag Kulgam Pulwama Shopian Baramulla Bandipora Kupwara Leh Kargil Total 17 15 14 30 08 13 09 20 15 12 03 0 156 32 08 07 23 16 15 13 06 03 02 05 04 134 29 07 06 23 16 10 10 06 03 02 03 04 119 03 01 01 0 0 05 03 0 02 0 15 15

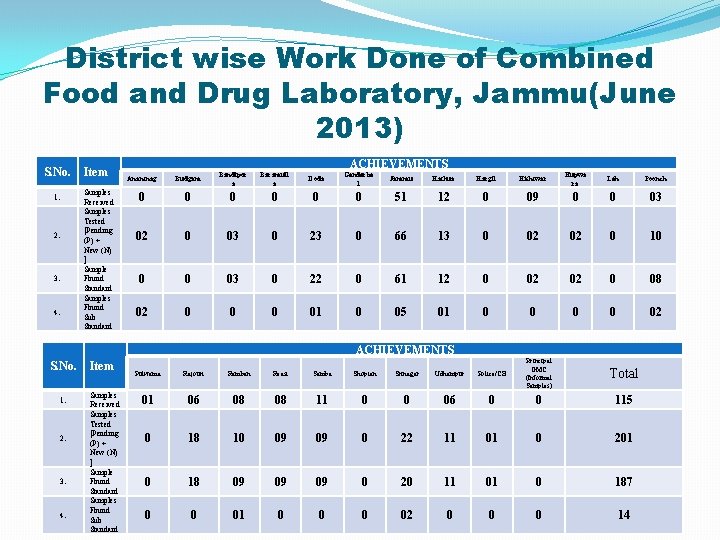

District wise Work Done of Combined Food and Drug Laboratory, Jammu(June 2013) S. No. Item Samples Received Samples Tested [Pending (P) + New (N) ] Sample Found Standard Samples Found Sub Standard 1. 2. 3. 4. ACHIEVEMENTS Anantnag Budgam Bandipor a Baramull a Doda Ganderba l Jammu Kathua Kargil Kishtwar Kupwa ra Leh Poonch 0 0 0 51 12 0 09 0 0 03 02 0 03 0 23 0 66 13 0 02 02 0 10 0 0 03 0 22 0 61 12 0 02 02 0 08 02 0 01 0 05 01 0 0 02 ACHIEVEMENTS S. No. 1. 2. 3. 4. Item Samples Received Samples Tested [Pending (P) + New (N) ] Sample Found Standard Samples Found Sub Standard Pulwama Rajouri Ramban Reasi Samba Shopian Srinagar Udhampur Police/CB Principal GMC (Informal Samples) Total 01 06 08 08 11 0 0 06 0 0 115 0 18 10 09 09 0 22 11 01 0 201 0 18 09 09 09 0 20 11 01 0 187 0 0 01 0 02 0 0 0 14 16

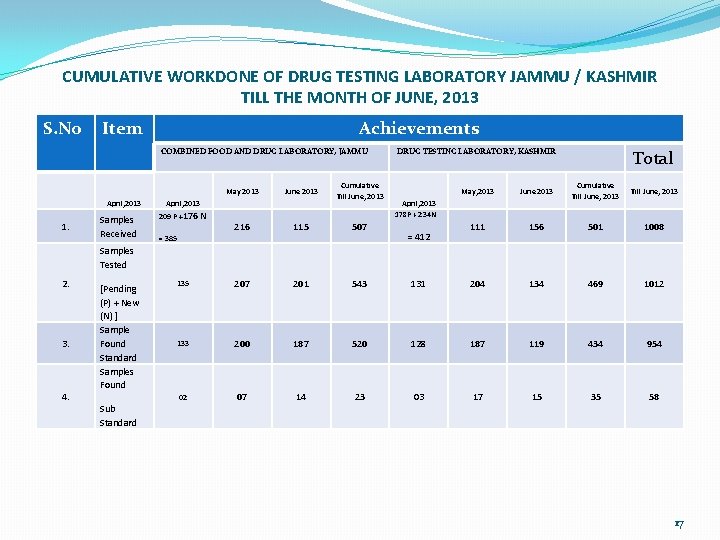

CUMULATIVE WORKDONE OF DRUG TESTING LABORATORY JAMMU / KASHMIR TILL THE MONTH OF JUNE, 2013 S. No Item Achievements COMBINED FOOD AND DRUG LABORATORY, JAMMU May 2013 April, 2013 1. Samples Received June 2013 April, 2013 209 P +176 N Cumulative Till June, 2013 Total DRUG TESTING LABORATORY, KASHMIR May, 2013 June 2013 Cumulative Till June, 2013 111 156 501 1008 April, 2013 178 P + 234 N 216 115 507 135 207 201 543 131 204 134 469 1012 133 200 187 520 128 187 119 434 954 02 07 14 23 03 17 15 35 58 = 385 = 412 Samples Tested 2. 3. 4. [Pending (P) + New (N) ] Sample Found Standard Samples Found Sub Standard 17

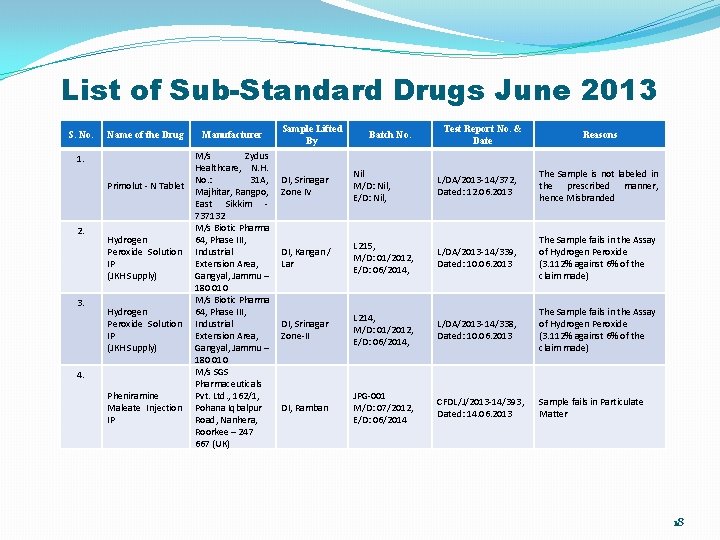

List of Sub-Standard Drugs June 2013 S. No. Name of the Drug 1. Primolut - N Tablet 2. 3. Hydrogen Peroxide Solution IP (JKH Supply) 4. Pheniramine Maleate Injection IP Manufacturer M/s Zydus Healthcare, N. H. No. : 31 A, Majhitar, Rangpo, East Sikkim 737132 M/s Biotic Pharma 64, Phase III, Industrial Extension Area, Gangyal, Jammu – 180 010 M/s SGS Pharmaceuticals Pvt. Ltd. , 162/1, Pohana Iqbalpur Road, Nanhera, Roorkee – 247 667 (UK) Sample Lifted By Batch No. Test Report No. & Date Reasons DI, Srinagar Zone IV Nil M/D: Nil, E/D: Nil, L/DA/2013 -14/372, Dated: 12. 06. 2013 The Sample is not labeled in the prescribed manner, hence Misbranded DI, Kangan / Lar L 215, M/D: 01/2012, E/D: 06/2014, L/DA/2013 -14/339, Dated: 10. 06. 2013 The Sample fails in the Assay of Hydrogen Peroxide (3. 112% against 6% of the claim made) DI, Srinagar Zone-II L 214, M/D: 01/2012, E/D: 06/2014, L/DA/2013 -14/338, Dated: 10. 06. 2013 The Sample fails in the Assay of Hydrogen Peroxide (3. 112% against 6% of the claim made) DI, Ramban JPG-001 M/D: 07/2012, E/D: 06/2014 CFDL/J/2013 -14/393, Dated: 14. 06. 2013 Sample fails in Particulate Matter 18

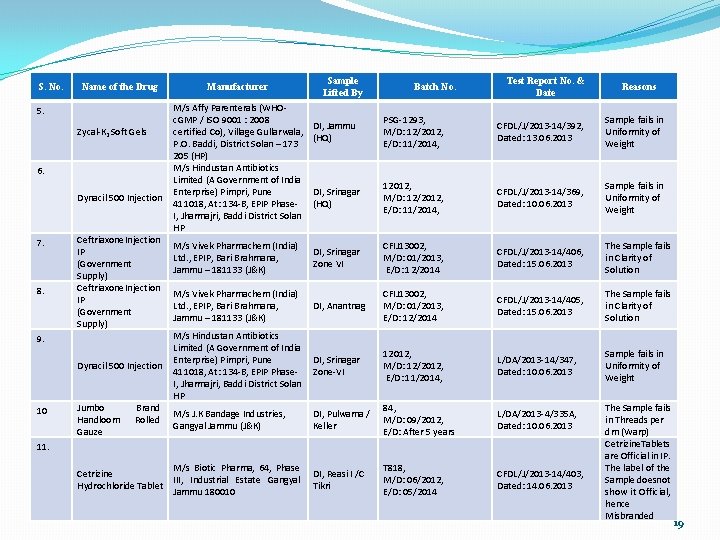

S. No. Name of the Drug 5. Zycal-K 2 Soft Gels 6. Dynacil 500 Injection 7. 8. Ceftriaxone Injection IP (Government Supply) 9. Dynacil 500 Injection 10 Jumbo Handloom Gauze Brand Rolled Manufacturer M/s Affy Parenterals (WHOc. GMP / ISO 9001 : 2008 certified Co), Village Gullarwala, P. O. Baddi, District Solan – 173 205 (HP) M/s Hindustan Antibiotics Limited (A Government of India Enterprise) Pimpri, Pune 411018, At: 134 -B, EPIP Phase. I, Jharmajri, Baddi District Solan HP Sample Lifted By Batch No. Test Report No. & Date DI, Jammu (HQ) PSG-1293, M/D: 12/2012, E/D: 11/2014, CFDL/J/2013 -14/392, Dated: 13. 06. 2013 Sample fails in Uniformity of Weight DI, Srinagar (HQ) 12012, M/D: 12/2012, E/D: 11/2014, CFDL/J/2013 -14/369, Dated: 10. 06. 2013 Sample fails in Uniformity of Weight M/s Vivek Pharmachem (India) Ltd. , EPIP, Bari Brahmana, Jammu – 181133 (J&K) DI, Srinagar Zone VI CFIJ 13002, M/D: 01/2013, E/D: 12/2014 CFDL/J/2013 -14/406, Dated: 15. 06. 2013 The Sample fails in Clarity of Solution M/s Vivek Pharmachem (India) Ltd. , EPIP, Bari Brahmana, Jammu – 181133 (J&K) DI, Anantnag CFIJ 13002, M/D: 01/2013, E/D: 12/2014 CFDL/J/2013 -14/405, Dated: 15. 06. 2013 The Sample fails in Clarity of Solution M/s Hindustan Antibiotics Limited (A Government of India Enterprise) Pimpri, Pune 411018, At: 134 -B, EPIP Phase. I, Jharmajri, Baddi District Solan HP DI, Srinagar Zone-VI 12012, M/D: 12/2012, E/D: 11/2014, L/DA/2013 -14/347, Dated: 10. 06. 2013 Sample fails in Uniformity of Weight M/s J. K Bandage Industries, Gangyal Jammu (J&K) DI, Pulwama / Keller 84, M/D: 09/2012, E/D: After 5 years L/DA/2013 -4/335 A, Dated: 10. 06. 2013 M/s Biotic Pharma, 64, Phase III, Industrial Estate Gangyal Jammu 180010 DI, Reasi I /C Tikri T 818, M/D: 06/2012, E/D: 05/2014 CFDL/J/2013 -14/403, Dated: 14. 06. 2013 11. Cetrizine Hydrochloride Tablet Reasons The Sample fails in Threads per dm (Warp) Cetrizine. Tablets are Official in IP. The label of the Sample doesnot show it Official, hence Misbranded 19

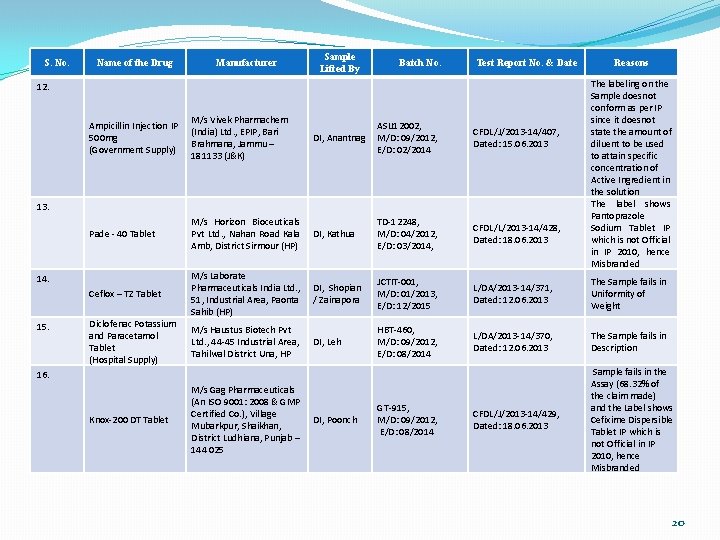

S. No. Name of the Drug Manufacturer Sample Lifted By Batch No. Test Report No. & Date 12. The labeling on the Sample doesnot conform as per IP since it doesnot state the amount of diluent to be used to attain specific concentration of Active Ingredient in the solution The label shows Pantoprazole Sodium Tablet IP which is not Official in IP 2010, hence Misbranded Ampicillin Injection IP 500 mg (Government Supply) M/s Vivek Pharmachem (India) Ltd. , EPIP, Bari Brahmana, Jammu – 181133 (J&K) DI, Anantnag ASIJ 12002, M/D: 09/2012, E/D: 02/2014 CFDL/J/2013 -14/407, Dated: 15. 06. 2013 Pade - 40 Tablet M/s Horizon Bioceuticals Pvt Ltd. , Nahan Road Kala Amb, District Sirmour (HP) DI, Kathua TD-12248, M/D: 04/2012, E/D: 03/2014, CFDL/L/2013 -14/428, Dated: 18. 06. 2013 Ceflox – TZ Tablet M/s Laborate Pharmaceuticals India Ltd. , 51, Industrial Area, Paonta Sahib (HP) DI, Shopian / Zainapora JCTIT-001, M/D: 01/2013, E/D: 12/2015 L/DA/2013 -14/371, Dated: 12. 06. 2013 The Sample fails in Uniformity of Weight M/s Haustus Biotech Pvt Ltd. , 44 -45 Industrial Area, Tahilwal District Una, HP DI, Leh HBT-460, M/D: 09/2012, E/D: 08/2014 L/DA/2013 -14/370, Dated: 12. 06. 2013 The Sample fails in Description CFDL/J/2013 -14/429, Dated: 18. 06. 2013 Sample fails in the Assay (68. 32% of the claim made) and the Label shows Cefixime Dispersible Tablet IP which is not Official in IP 2010, hence Misbranded 13. 14. 15. Reasons Diclofenac Potassium and Paracetamol Tablet (Hospital Supply) 16. Knox-200 DT Tablet M/s Gag Pharmaceuticals (An ISO 9001: 2008 & GMP Certified Co. ), Village Mubarkpur, Shaikhan, District Ludhiana, Punjab – 144 025 DI, Poonch GT-915, M/D: 09/2012, E/D: 08/2014 20

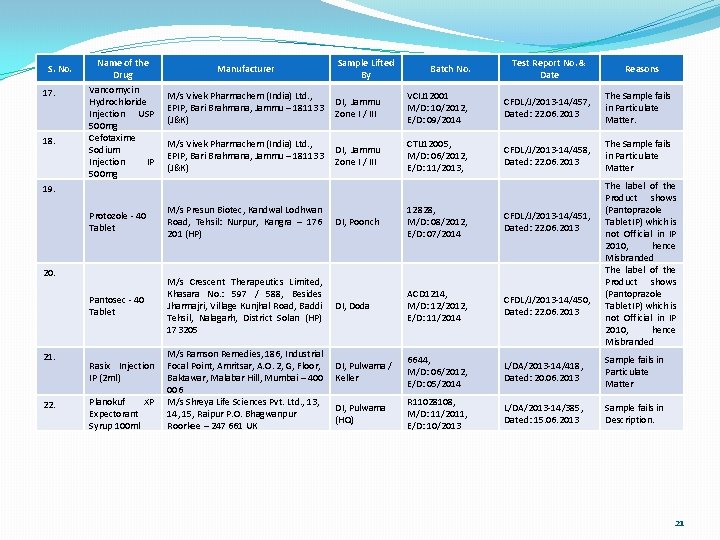

S. No. 17. 18. Name of the Drug Vancomycin Hydrochloride Injection USP 500 mg Cefotaxime Sodium Injection IP 500 mg Manufacturer Sample Lifted By Batch No. Test Report No. & Date M/s Vivek Pharmachem (India) Ltd. , EPIP, Bari Brahmana, Jammu – 181133 (J&K) DI, Jammu Zone I / III VCIJ 12001 M/D: 10/2012, E/D: 09/2014 CFDL/J/2013 -14/457, Dated: 22. 06. 2013 The Sample fails in Particulate Matter. M/s Vivek Pharmachem (India) Ltd. , EPIP, Bari Brahmana, Jammu – 181133 (J&K) DI, Jammu Zone I / III CTIJ 12005, M/D: 06/2012, E/D: 11/2013, CFDL/J/2013 -14/458, Dated: 22. 06. 2013 The Sample fails in Particulate Matter 19. 22. The label of the Product shows (Pantoprazole Tablet IP) which is not Official in IP 2010, hence Misbranded Protozole - 40 Tablet M/s Presun Biotec, Kandwal Lodhwan Road, Tehsil: Nurpur, Kangra – 176 201 (HP) DI, Poonch 12828, M/D: 08/2012, E/D: 07/2014 CFDL/J/2013 -14/451, Dated: 22. 06. 2013 Pantosec - 40 Tablet M/s Crescent Therapeutics Limited, Khasara No. : 597 / 588, Besides Jharmajri, Village Kunjhal Road, Baddi Tehsil, Nalagarh, District Solan (HP) 173205 DI, Doda ACD 1214, M/D: 12/2012, E/D: 11/2014 CFDL/J/2013 -14/450, Dated: 22. 06. 2013 DI, Pulwama / Keller 6644, M/D: 06/2012, E/D: 05/2014 L/DA/2013 -14/418, Dated: 20. 06. 2013 Sample fails in Particulate Matter DI, Pulwama (HQ) R 11028108, M/D: 11/2011, E/D: 10/2013 L/DA/2013 -14/385, Dated: 15. 06. 2013 Sample fails in Description. 20. 21. Reasons Rasix Injection IP (2 ml) Planokuf XP Expectorant Syrup 100 ml M/s Ramson Remedies, 186, Industrial Focal Point, Amritsar, A. O. 2, G, Floor, Baktawar, Malabar Hill, Mumbai – 400 006 M/s Shreya Life Sciences Pvt. Ltd. , 13, 14, 15, Raipur P. O. Bhagwanpur Roorkee – 247 661 UK 21

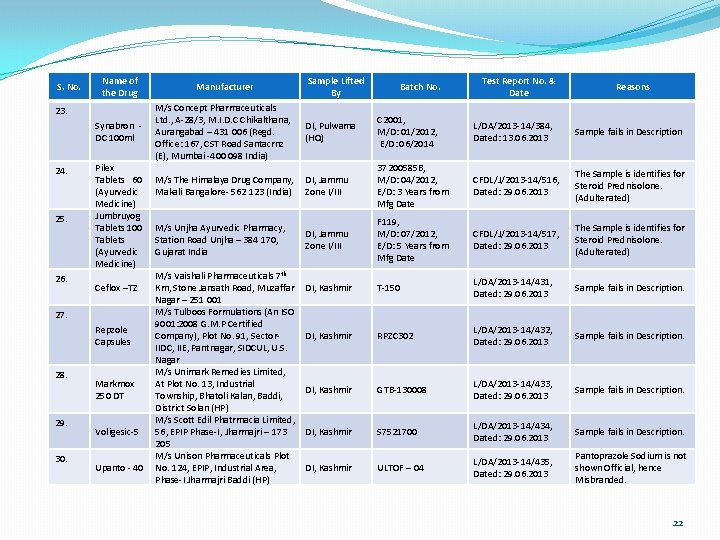

S. No. Name of the Drug Manufacturer Synabron DC 100 ml M/s Concept Pharmaceuticals Ltd. , A-28/3, M. I. D. C Chikalthana, Aurangabad – 431 006 (Regd. Office: 167, CST Road Santacrnz (E), Mumbai -400 098 India) DI, Pulwama (HQ) C 2001, M/D: 01/2012, E/D: 06/2014 L/DA/2013 -14/384, Dated: 13. 06. 2013 Sample fails in Description M/s The Himalaya Drug Company, Makali Bangalore- 562 123 (India) DI, Jammu Zone I/III 37200585 B, M/D: 04/2012, E/D: 3 Years from Mfg Date CFDL/J/2013 -14/516, Dated: 29. 06. 2013 The Sample is identifies for Steroid Prednisolone. (Adulterated) M/s Unjha Ayurvedic Pharmacy, Station Road Unjha – 384 170, Gujarat India DI, Jammu Zone I/III F 119, M/D: 07/2012, E/D: 5 Years from Mfg Date CFDL/J/2013 -14/517, Dated: 29. 06. 2013 The Sample is identifies for Steroid Prednisolone. (Adulterated) DI, Kashmir T-150 L/DA/2013 -14/431, Dated: 29. 06. 2013 Sample fails in Description. DI, Kashmir RPZC 302 L/DA/2013 -14/432, Dated: 29. 06. 2013 Sample fails in Description. DI, Kashmir GTB-130008 L/DA/2013 -14/433, Dated: 29. 06. 2013 Sample fails in Description. DI, Kashmir S 7521700 L/DA/2013 -14/434, Dated: 29. 06. 2013 Sample fails in Description. DI, Kashmir ULTOF – 04 L/DA/2013 -14/435, Dated: 29. 06. 2013 Pantoprazole Sodium is not shown Official, hence Misbranded. 23. 24. 25. 26. Pilex Tablets 60 (Ayurvedic Medicine) Jumbruyog Tablets 100 Tablets (Ayurvedic Medicine) Ceflox –TZ 27. Repzole Capsules 28. 29. 30. Markmox 250 DT Voligesic-5 Upanto - 40 M/s Vaishali Pharmaceuticals 7 th Km, Stone Jansath Road, Muzaffar Nagar – 251 001 M/s Tulboos Formulations (An ISO 9001: 2008 G. M. P Certified Company), Plot No. 91, Sector. IIDC, IIE, Pantnagar, SIDCUL, U. S. Nagar M/s Unimark Remedies Limited, At Plot No. 13, Industrial Township, Bhatoli Kalan, Baddi, District Solan (HP) M/s Scott Edil Phatrmacia Limited, 56, EPIP Phase-I, Jharmajri – 173 205 M/s Unison Pharmaceuticals Plot No. 124, EPIP, Industrial Area, Phase-I Jharmajri Baddi (HP) Sample Lifted By Batch No. Test Report No. & Date Reasons 22
Status of Licensed Blood-Banks in Jammu & Kashmir 23
Status of approved blood storage Centres in J&K 24
Status of approved blood storage centres in J&K 25
Work Done of Food wing 26
WORK DONE OF FOOD WING OF J&K FOR THE MONTH OF JUNE, 2013 27
WORK DONE OF FOOD WING OF J&K FOR THE MONTH OF JUNE, 2013 28

District Wise Consolidated Work Done Report on FSSA OF JUNE, 2013 (PUBLIC HEALTH LABORATORY, JAMMU) 29
Progress Report on COTPA , Act 2003 30
District Wise Work Done of Jammu Division (Under FSSA) 9/29/2020 31
THANKS 32
