WASA LAHORE PCGIP PROGRESS TH REVIEW WORKSHOP 5

- Slides: 21
WASA LAHORE PCGIP: PROGRESS TH REVIEW WORKSHOP 5 , Jan 2014 Disbursement Linked Indicators (DLIs) & Eligible Expenditure Program (EEPs)

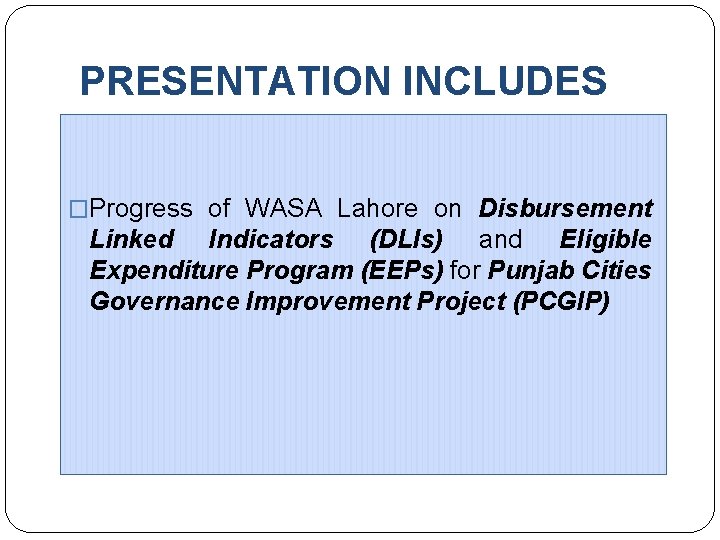

PRESENTATION INCLUDES �Progress of WASA Lahore on Disbursement Linked Indicators (DLIs) and Eligible Expenditure Program (EEPs) for Punjab Cities Governance Improvement Project (PCGIP)

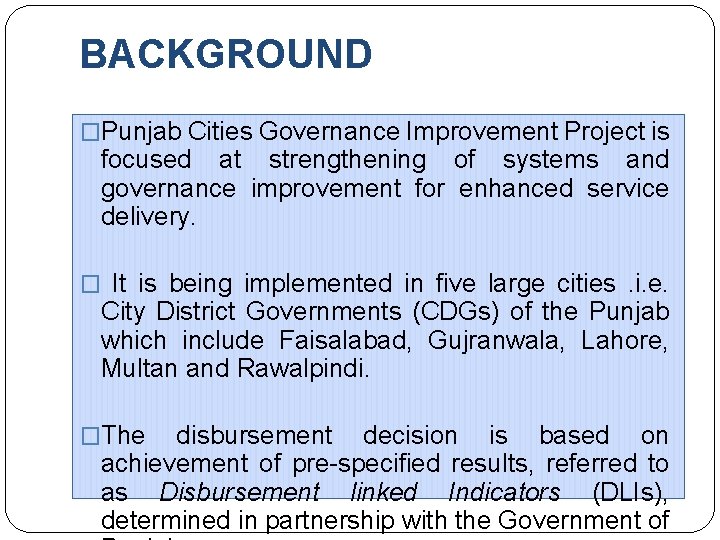

BACKGROUND �Punjab Cities Governance Improvement Project is focused at strengthening of systems and governance improvement for enhanced service delivery. � It is being implemented in five large cities. i. e. City District Governments (CDGs) of the Punjab which include Faisalabad, Gujranwala, Lahore, Multan and Rawalpindi. �The disbursement decision is based on achievement of pre-specified results, referred to as Disbursement linked Indicators (DLIs), determined in partnership with the Government of
DLIs & EEPs

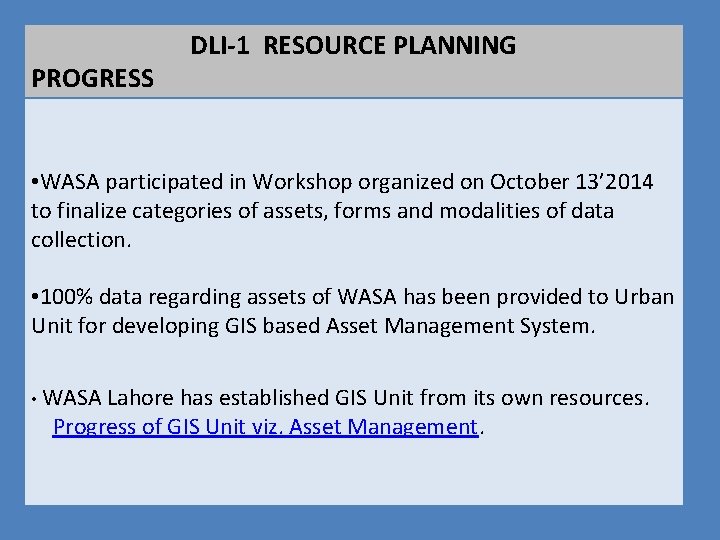

PROGRESS DLI-1 RESOURCE PLANNING DLI-1 • WASA participated in Workshop organized on October 13’ 2014 to finalize categories of assets, forms and modalities of data collection. • 100% data regarding assets of WASA has been provided to Urban Unit for developing GIS based Asset Management System. • WASA Lahore has established GIS Unit from its own resources. Progress of GIS Unit viz. Asset Management.

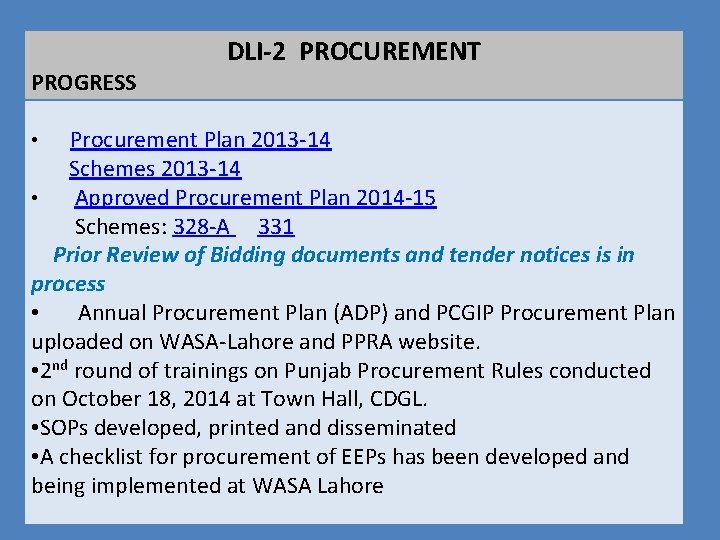

PROGRESS DLI-2 PROCUREMENT Procurement Plan 2013 -14 Schemes 2013 -14 • Approved Procurement Plan 2014 -15 Schemes: 328 -A 331 Prior Review of Bidding documents and tender notices is in process • Annual Procurement Plan (ADP) and PCGIP Procurement Plan uploaded on WASA-Lahore and PPRA website. • 2 nd round of trainings on Punjab Procurement Rules conducted on October 18, 2014 at Town Hall, CDGL. • SOPs developed, printed and disseminated • A checklist for procurement of EEPs has been developed and being implemented at WASA Lahore •

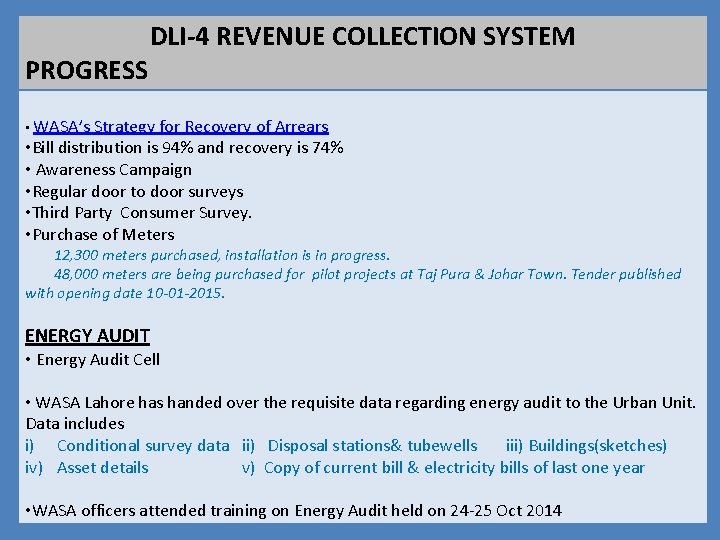

PROGRESS DLI-4 REVENUE COLLECTION SYSTEM • WASA’s Strategy for Recovery of Arrears • Bill distribution is 94% and recovery is 74% • Awareness Campaign • Regular door to door surveys • Third Party Consumer Survey. • Purchase of Meters 12, 300 meters purchased, installation is in progress. 48, 000 meters are being purchased for pilot projects at Taj Pura & Johar Town. Tender published with opening date 10 -01 -2015. ENERGY AUDIT • Energy Audit Cell • WASA Lahore has handed over the requisite data regarding energy audit to the Urban Unit. Data includes i) Conditional survey data ii) Disposal stations& tubewells iii) Buildings(sketches) iv) Asset details v) Copy of current bill & electricity bills of last one year • WASA officers attended training on Energy Audit held on 24 -25 Oct 2014

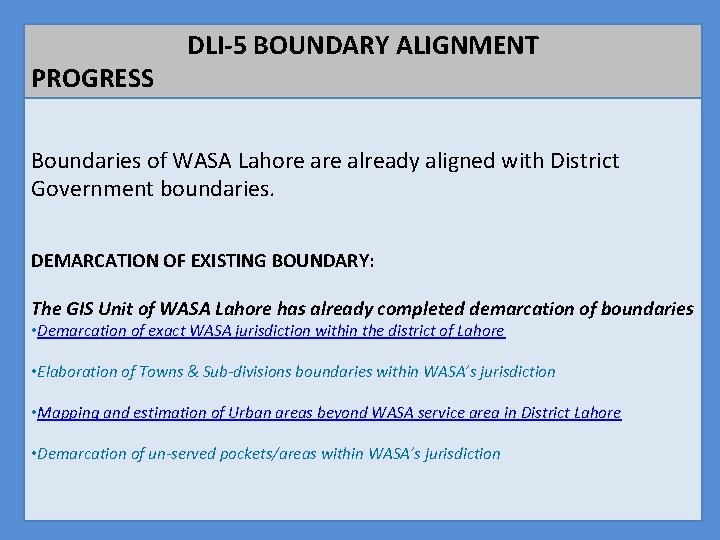

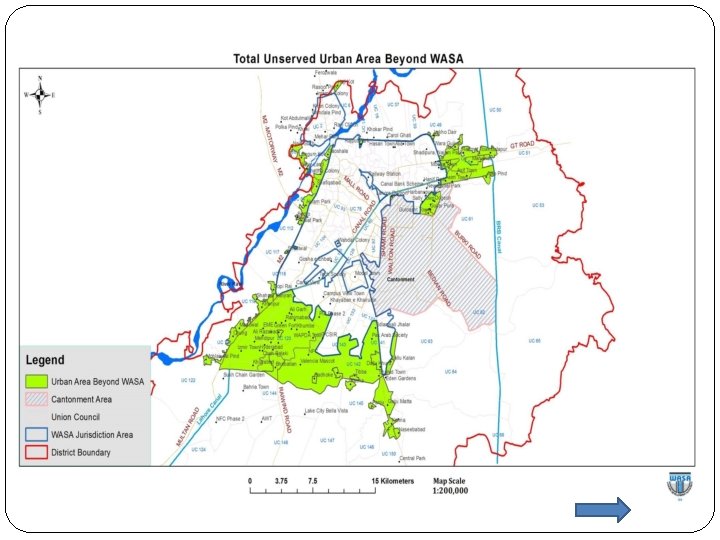

PROGRESS DLI-5 BOUNDARY ALIGNMENT Boundaries of WASA Lahore already aligned with District Government boundaries. DEMARCATION OF EXISTING BOUNDARY: The GIS Unit of WASA Lahore has already completed demarcation of boundaries • Demarcation of exact WASA jurisdiction within the district of Lahore • Elaboration of Towns & Sub-divisions boundaries within WASA’s jurisdiction • Mapping and estimation of Urban areas beyond WASA service area in District Lahore • Demarcation of un-served pockets/areas within WASA’s jurisdiction

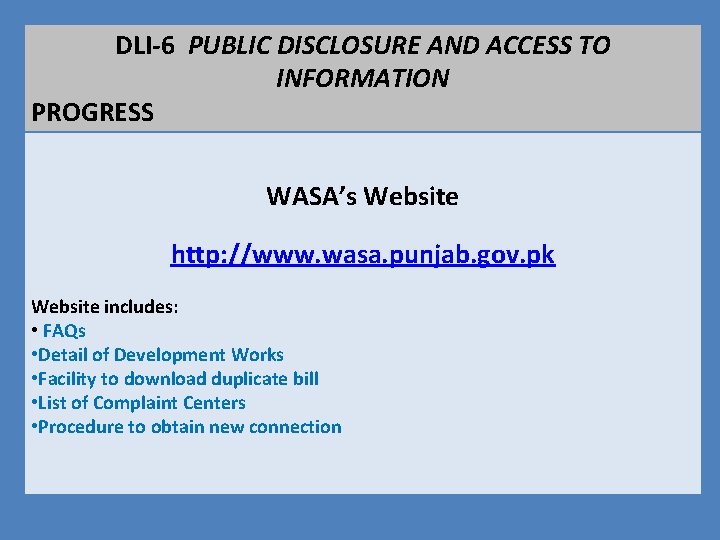

DLI-6 PUBLIC DISCLOSURE AND ACCESS TO INFORMATION PROGRESS WASA’s Website http: //www. wasa. punjab. gov. pk Website includes: • FAQs • Detail of Development Works • Facility to download duplicate bill • List of Complaint Centers • Procedure to obtain new connection

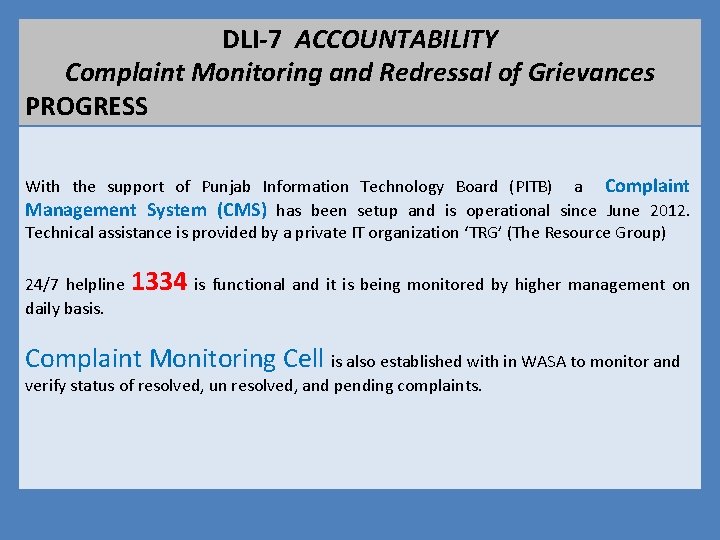

DLI-7 ACCOUNTABILITY Complaint Monitoring and Redressal of Grievances PROGRESS With the support of Punjab Information Technology Board (PITB) a Complaint Management System (CMS) has been setup and is operational since June 2012. Technical assistance is provided by a private IT organization ‘TRG’ (The Resource Group) 24/7 helpline daily basis. 1334 is functional and it is being monitored by higher management on Complaint Monitoring Cell is also established with in WASA to monitor and verify status of resolved, un resolved, and pending complaints.

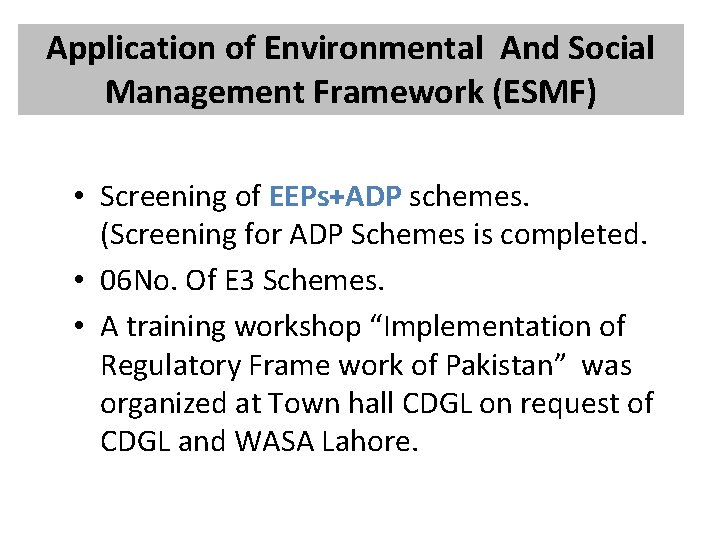

Application of Environmental And Social Management Framework (ESMF) • Screening of EEPs+ADP schemes. (Screening for ADP Schemes is completed. • 06 No. Of E 3 Schemes. • A training workshop “Implementation of Regulatory Frame work of Pakistan” was organized at Town hall CDGL on request of CDGL and WASA Lahore.
THANK YOU

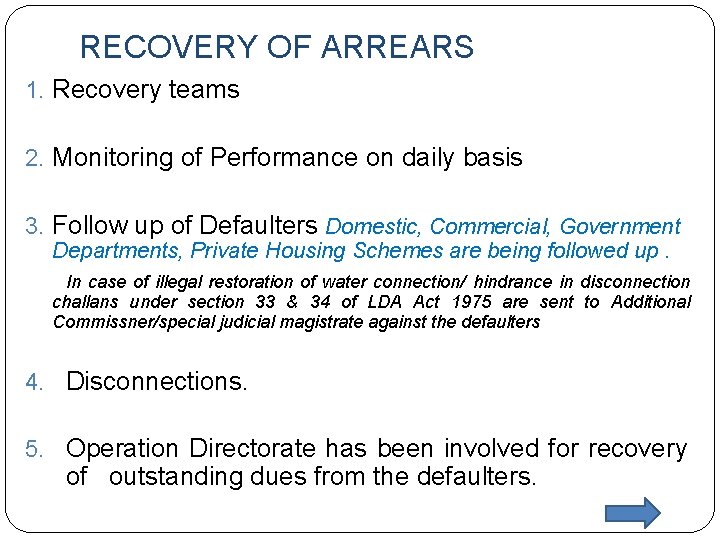

RECOVERY OF ARREARS 1. Recovery teams 2. Monitoring of Performance on daily basis 3. Follow up of Defaulters Domestic, Commercial, Government Departments, Private Housing Schemes are being followed up. In case of illegal restoration of water connection/ hindrance in disconnection challans under section 33 & 34 of LDA Act 1975 are sent to Additional Commissner/special judicial magistrate against the defaulters 4. Disconnections. 5. Operation Directorate has been involved for recovery of outstanding dues from the defaulters.

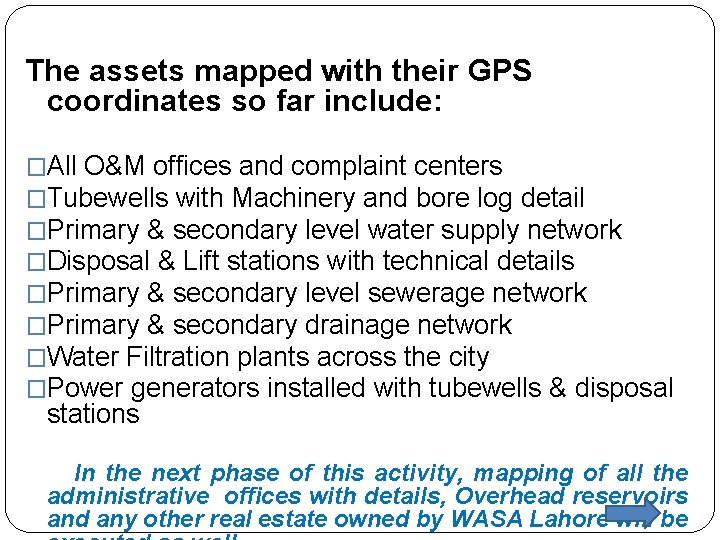

The assets mapped with their GPS coordinates so far include: �All O&M offices and complaint centers �Tubewells with Machinery and bore log detail �Primary & secondary level water supply network �Disposal & Lift stations with technical details �Primary & secondary level sewerage network �Primary & secondary drainage network �Water Filtration plants across the city �Power generators installed with tubewells & disposal stations In the next phase of this activity, mapping of all the administrative offices with details, Overhead reservoirs and any other real estate owned by WASA Lahore will be

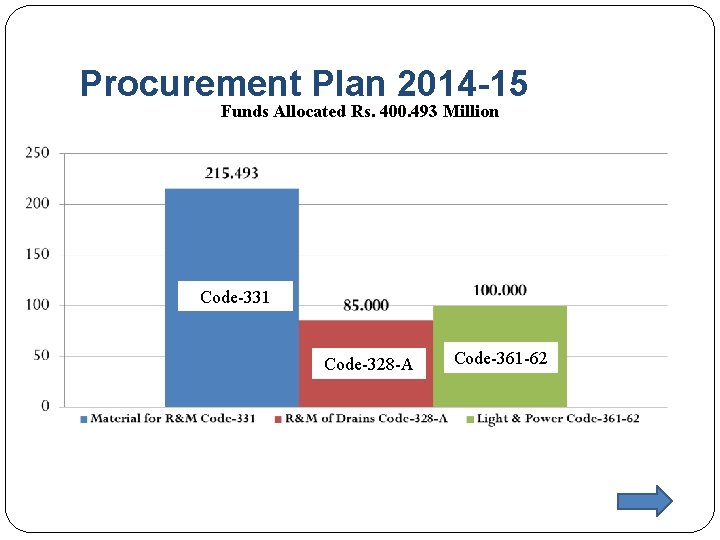

Procurement Plan 2014 -15 Funds Allocated Rs. 400. 493 Million Code-331 Code-328 -A Code-361 -62

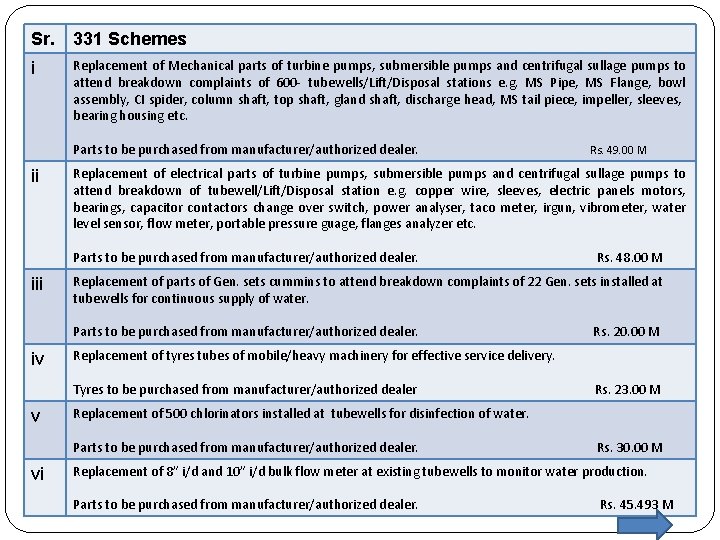

Sr. 331 Schemes i Replacement of Mechanical parts of turbine pumps, submersible pumps and centrifugal sullage pumps to attend breakdown complaints of 600 - tubewells/Lift/Disposal stations e. g. MS Pipe, MS Flange, bowl assembly, CI spider, column shaft, top shaft, gland shaft, discharge head, MS tail piece, impeller, sleeves, bearing housing etc. Parts to be purchased from manufacturer/authorized dealer. ii Replacement of electrical parts of turbine pumps, submersible pumps and centrifugal sullage pumps to attend breakdown of tubewell/Lift/Disposal station e. g. copper wire, sleeves, electric panels motors, bearings, capacitor contactors change over switch, power analyser, taco meter, irgun, vibrometer, water level sensor, flow meter, portable pressure guage, flanges analyzer etc. Parts to be purchased from manufacturer/authorized dealer. iii Rs. 23. 00 M Replacement of 500 chlorinators installed at tubewells for disinfection of water. Parts to be purchased from manufacturer/authorized dealer. vi Rs. 20. 00 M Replacement of tyres tubes of mobile/heavy machinery for effective service delivery. Tyres to be purchased from manufacturer/authorized dealer v Rs. 48. 00 M Replacement of parts of Gen. sets cummins to attend breakdown complaints of 22 Gen. sets installed at tubewells for continuous supply of water. Parts to be purchased from manufacturer/authorized dealer. iv Rs. 49. 00 M Rs. 30. 00 M Replacement of 8” i/d and 10” i/d bulk flow meter at existing tubewells to monitor water production. Parts to be purchased from manufacturer/authorized dealer. Rs. 45. 493 M
