Vance County Water District Overview and Update Jordan

  • Slides: 9
Download presentation
Vance County Water District Overview and Update Jordan Mc. Millen Director Vance County Planning

Vance County Water District Overview and Update Jordan Mc. Millen Director Vance County Planning and Development Department 156 Church St. Suite 3 Henderson, NC 27536 (252) 738 -2091

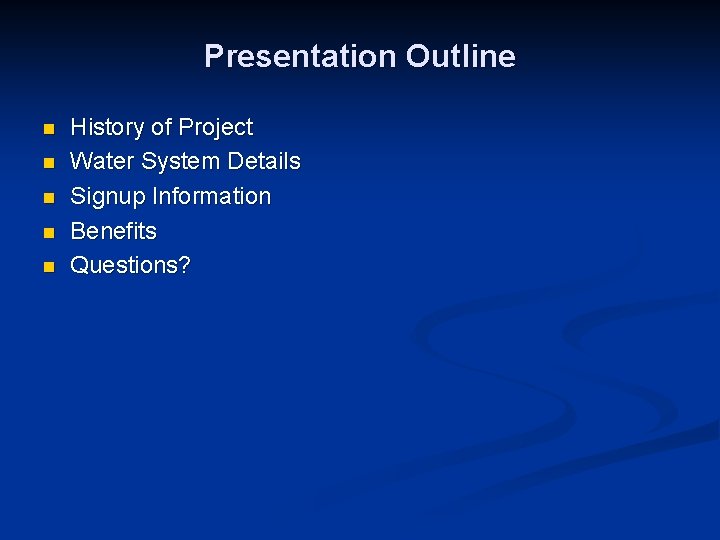

Presentation Outline n n n History of Project Water System Details Signup Information Benefits

Presentation Outline n n n History of Project Water System Details Signup Information Benefits Questions?

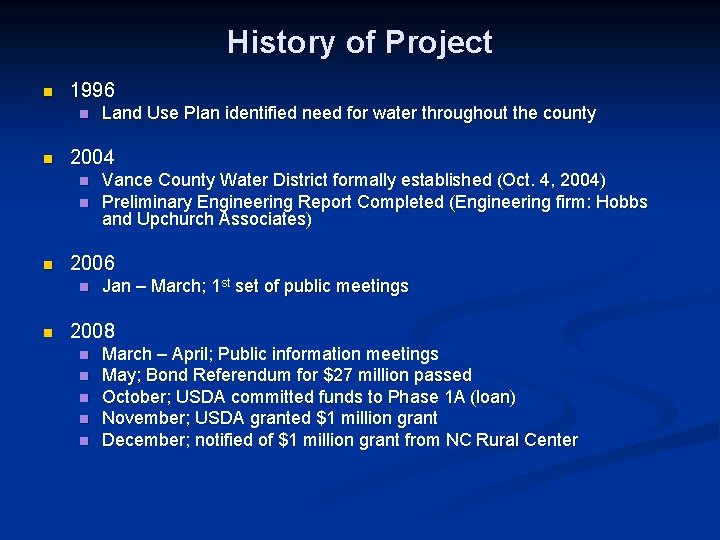

History of Project n 1996 n n 2004 n n n Vance County Water

History of Project n 1996 n n 2004 n n n Vance County Water District formally established (Oct. 4, 2004) Preliminary Engineering Report Completed (Engineering firm: Hobbs and Upchurch Associates) 2006 n n Land Use Plan identified need for water throughout the county Jan – March; 1 st set of public meetings 2008 n n n March – April; Public information meetings May; Bond Referendum for $27 million passed October; USDA committed funds to Phase 1 A (loan) November; USDA granted $1 million grant December; notified of $1 million grant from NC Rural Center

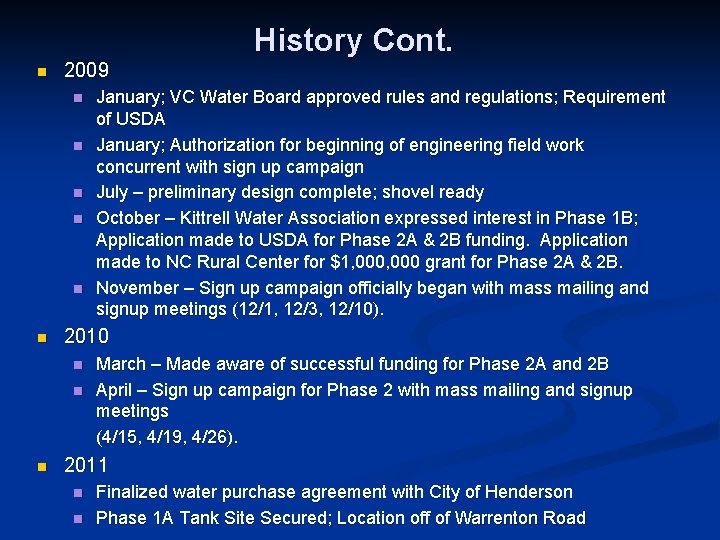

n 2009 n n n January; VC Water Board approved rules and regulations; Requirement

n 2009 n n n January; VC Water Board approved rules and regulations; Requirement of USDA January; Authorization for beginning of engineering field work concurrent with sign up campaign July – preliminary design complete; shovel ready October – Kittrell Water Association expressed interest in Phase 1 B; Application made to USDA for Phase 2 A & 2 B funding. Application made to NC Rural Center for $1, 000 grant for Phase 2 A & 2 B. November – Sign up campaign officially began with mass mailing and signup meetings (12/1, 12/3, 12/10). 2010 n n n History Cont. March – Made aware of successful funding for Phase 2 A and 2 B April – Sign up campaign for Phase 2 with mass mailing and signup meetings (4/15, 4/19, 4/26). 2011 n n Finalized water purchase agreement with City of Henderson Phase 1 A Tank Site Secured; Location off of Warrenton Road

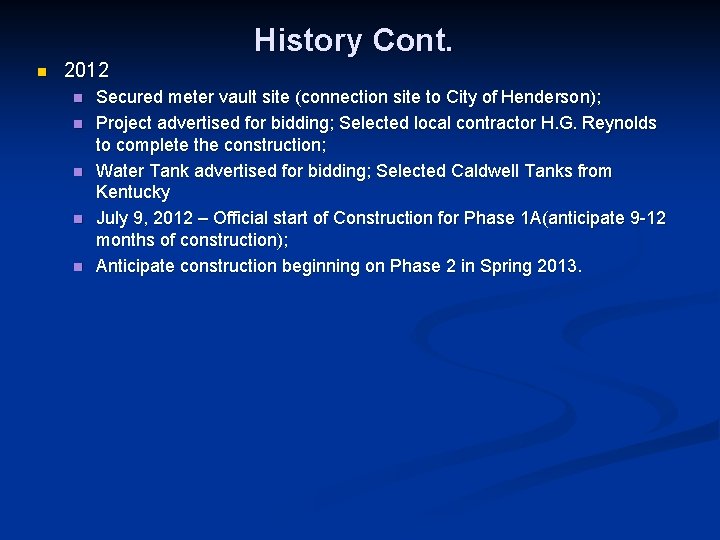

n 2012 n n n History Cont. Secured meter vault site (connection site to

n 2012 n n n History Cont. Secured meter vault site (connection site to City of Henderson); Project advertised for bidding; Selected local contractor H. G. Reynolds to complete the construction; Water Tank advertised for bidding; Selected Caldwell Tanks from Kentucky July 9, 2012 – Official start of Construction for Phase 1 A(anticipate 9 -12 months of construction); Anticipate construction beginning on Phase 2 in Spring 2013.

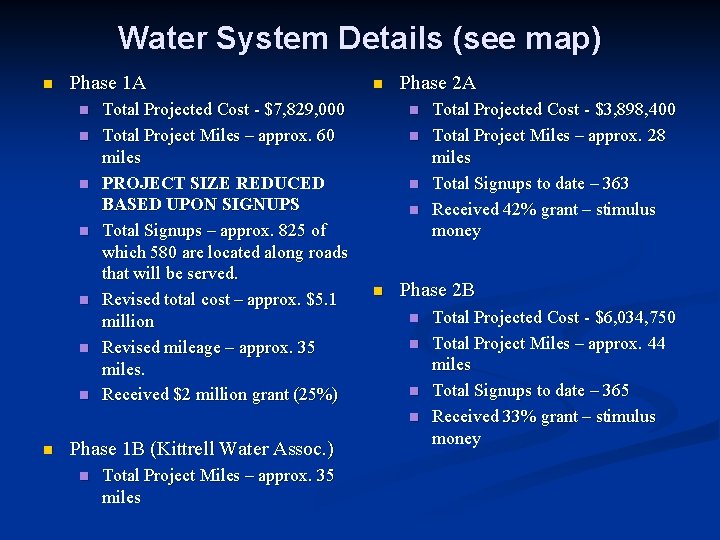

Water System Details (see map) n Phase 1 A n n n n Total

Water System Details (see map) n Phase 1 A n n n n Total Projected Cost - $7, 829, 000 Total Project Miles – approx. 60 miles PROJECT SIZE REDUCED BASED UPON SIGNUPS Total Signups – approx. 825 of which 580 are located along roads that will be served. Revised total cost – approx. $5. 1 million Revised mileage – approx. 35 miles. Received $2 million grant (25%) n Phase 2 A n n n Phase 2 B n n n Phase 1 B (Kittrell Water Assoc. ) n Total Project Miles – approx. 35 miles Total Projected Cost - $3, 898, 400 Total Project Miles – approx. 28 miles Total Signups to date – 363 Received 42% grant – stimulus money Total Projected Cost - $6, 034, 750 Total Project Miles – approx. 44 miles Total Signups to date – 365 Received 33% grant – stimulus money

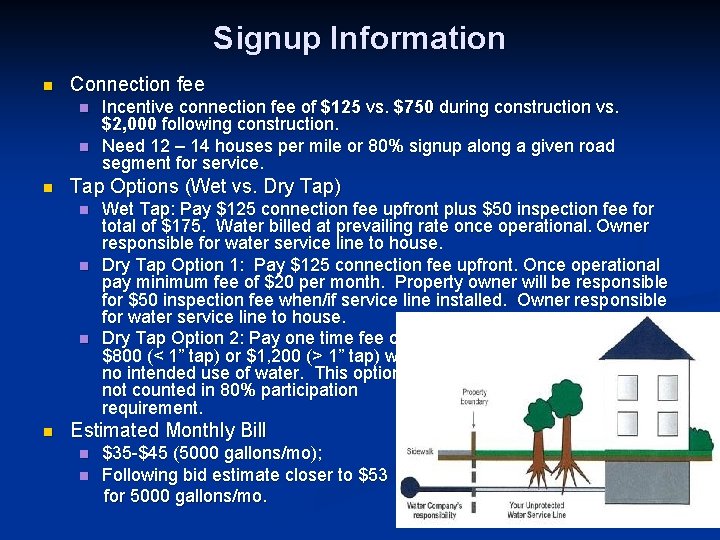

Signup Information n Connection fee n n n Tap Options (Wet vs. Dry Tap)

Signup Information n Connection fee n n n Tap Options (Wet vs. Dry Tap) n n Incentive connection fee of $125 vs. $750 during construction vs. $2, 000 following construction. Need 12 – 14 houses per mile or 80% signup along a given road segment for service. Wet Tap: Pay $125 connection fee upfront plus $50 inspection fee for total of $175. Water billed at prevailing rate once operational. Owner responsible for water service line to house. Dry Tap Option 1: Pay $125 connection fee upfront. Once operational pay minimum fee of $20 per month. Property owner will be responsible for $50 inspection fee when/if service line installed. Owner responsible for water service line to house. Dry Tap Option 2: Pay one time fee of $800 (< 1” tap) or $1, 200 (> 1” tap) with no intended use of water. This option is not counted in 80% participation requirement. Estimated Monthly Bill n n $35 -$45 (5000 gallons/mo); Following bid estimate closer to $53 for 5000 gallons/mo.

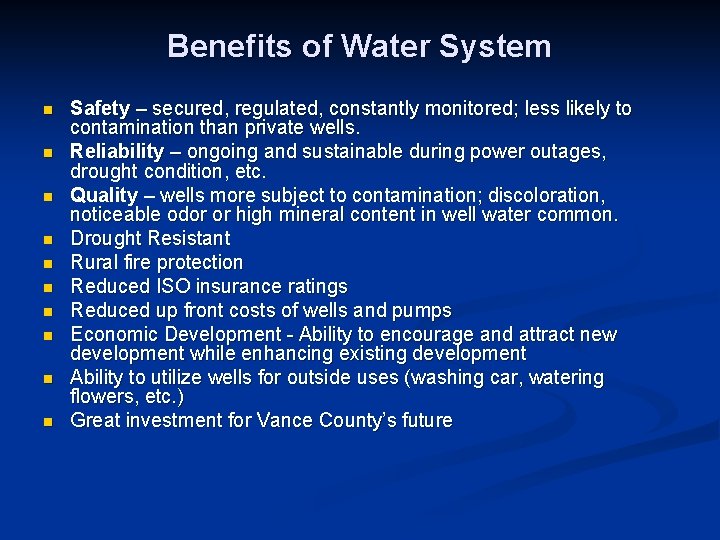

Benefits of Water System n n n n n Safety – secured, regulated, constantly

Benefits of Water System n n n n n Safety – secured, regulated, constantly monitored; less likely to contamination than private wells. Reliability – ongoing and sustainable during power outages, drought condition, etc. Quality – wells more subject to contamination; discoloration, noticeable odor or high mineral content in well water common. Drought Resistant Rural fire protection Reduced ISO insurance ratings Reduced up front costs of wells and pumps Economic Development - Ability to encourage and attract new development while enhancing existing development Ability to utilize wells for outside uses (washing car, watering flowers, etc. ) Great investment for Vance County’s future

Questions?

Questions?
