UJ 18 Preliminary integration of XSEN Pablo Santos
UJ 18 – Preliminary integration of XSEN Pablo Santos Díaz Dragoslav-Laza Lazic Reunion ICL Machines LHC – SPS (link) CERN Geneva / 28 -08 -2019 EDMS 2221067
Outline 1. Introduction 2. Preliminary integration 3. Conclusions EDMS 2221067, P. Santos Diaz – 28 th August 2019 2
1. Introduction EDMS 2221067, P. Santos Diaz – 28 th August 2019 3

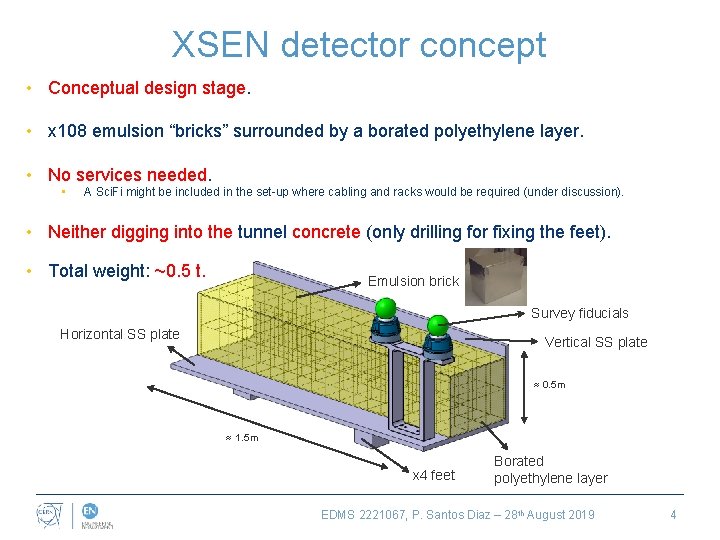

XSEN detector concept • Conceptual design stage. • x 108 emulsion “bricks” surrounded by a borated polyethylene layer. • No services needed. • A Sci. Fi might be included in the set-up where cabling and racks would be required (under discussion). • Neither digging into the tunnel concrete (only drilling for fixing the feet). • Total weight: ~0. 5 t. Emulsion brick Survey fiducials Horizontal SS plate Vertical SS plate ≈ 0. 5 m ≈ 1. 5 m x 4 feet Borated polyethylene layer EDMS 2221067, P. Santos Diaz – 28 th August 2019 4

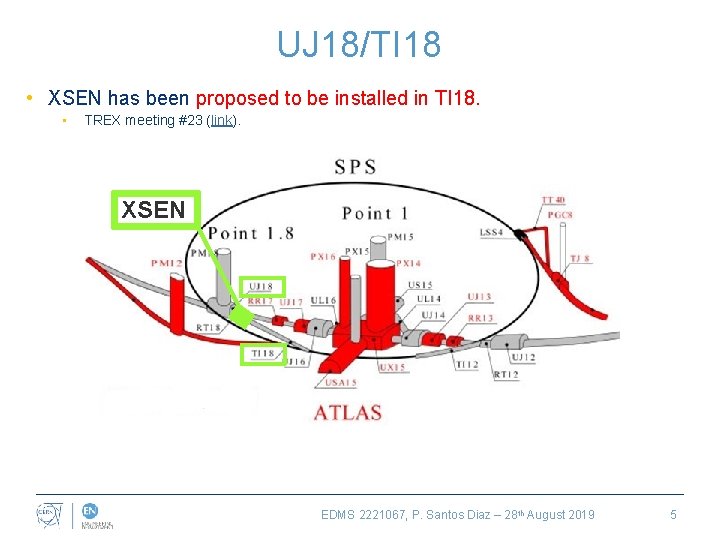

UJ 18/TI 18 • XSEN has been proposed to be installed in TI 18. • TREX meeting #23 (link). XSEN EDMS 2221067, P. Santos Diaz – 28 th August 2019 5

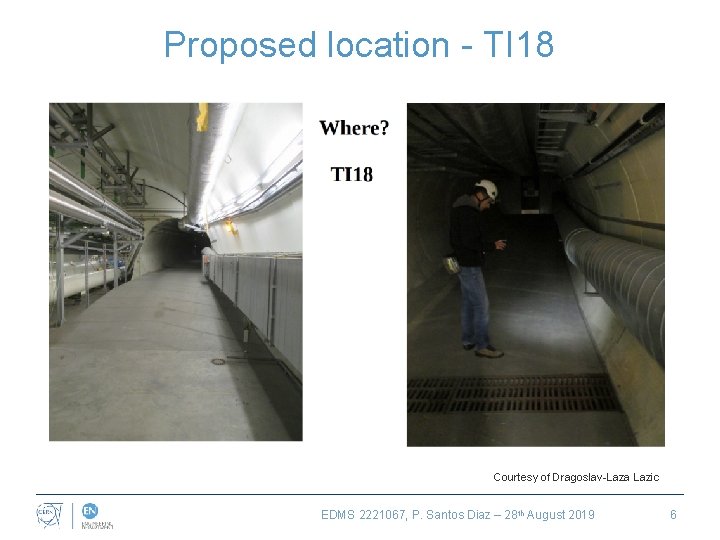

Proposed location - TI 18 Courtesy of Dragoslav-Laza Lazic EDMS 2221067, P. Santos Diaz – 28 th August 2019 6
2. Preliminary integration EDMS 2021950, P. Santos Diaz – 5 th September 2018 7

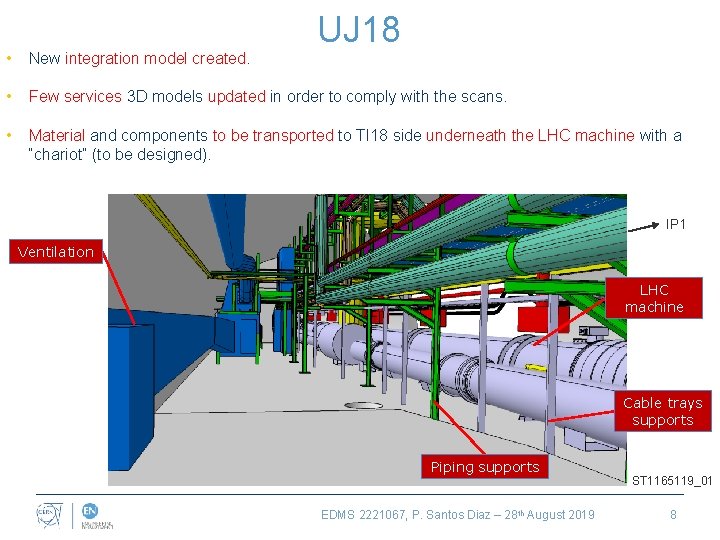

UJ 18 • New integration model created. • Few services 3 D models updated in order to comply with the scans. • Material and components to be transported to TI 18 side underneath the LHC machine with a “chariot” (to be designed). IP 1 Ventilation LHC machine Cable trays supports Piping supports EDMS 2221067, P. Santos Diaz – 28 th August 2019 ST 1165119_01 8

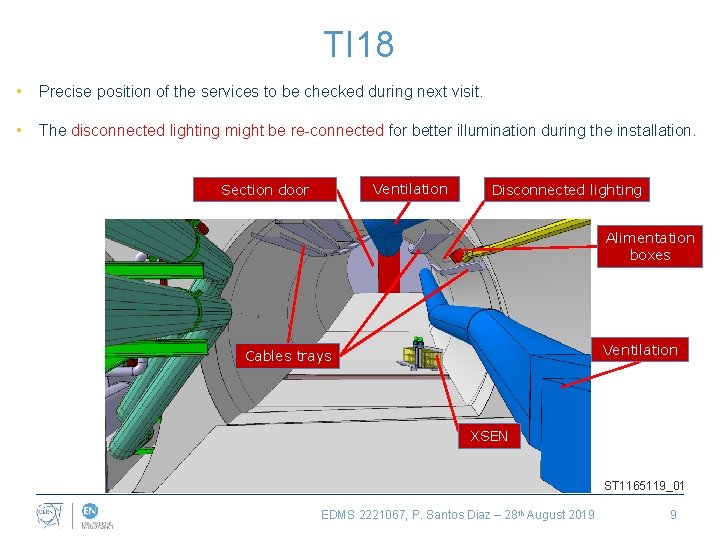

TI 18 • Precise position of the services to be checked during next visit. • The disconnected lighting might be re-connected for better illumination during the installation. Ventilation Section door Disconnected lighting Alimentation boxes Ventilation Cables trays XSEN ST 1165119_01 EDMS 2221067, P. Santos Diaz – 28 th August 2019 9
3. Conclusions EDMS 2021950, P. Santos Diaz – 5 th September 2018 10

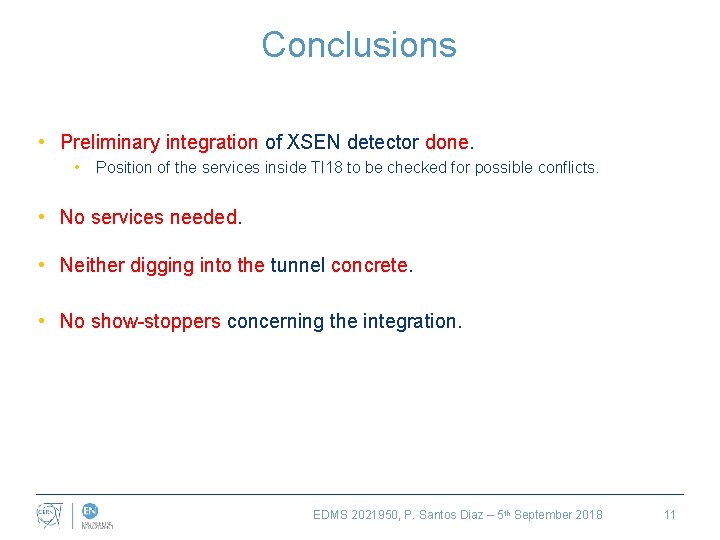

Conclusions • Preliminary integration of XSEN detector done. • Position of the services inside TI 18 to be checked for possible conflicts. • No services needed. • Neither digging into the tunnel concrete. • No show-stoppers concerning the integration. EDMS 2021950, P. Santos Diaz – 5 th September 2018 11
THANKS YOU FOR YOUR ATTENTION!
Back-up slides EDMS 2021950, P. Santos Diaz – 5 th September 2018 13

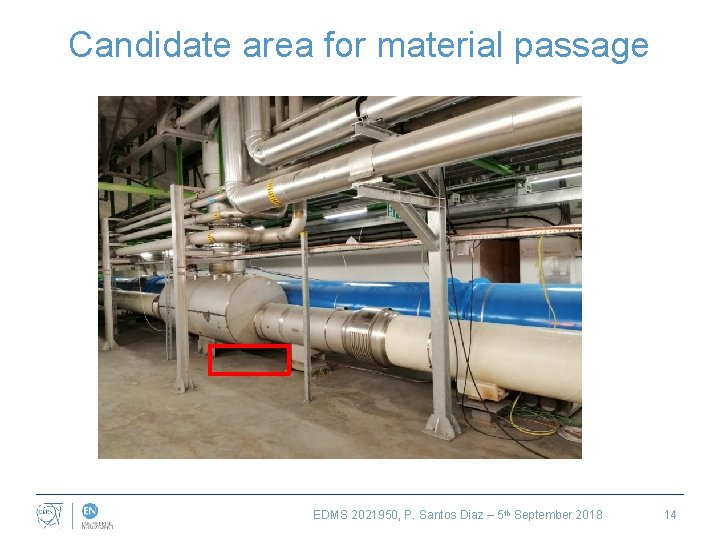

Candidate area for material passage EDMS 2021950, P. Santos Diaz – 5 th September 2018 14

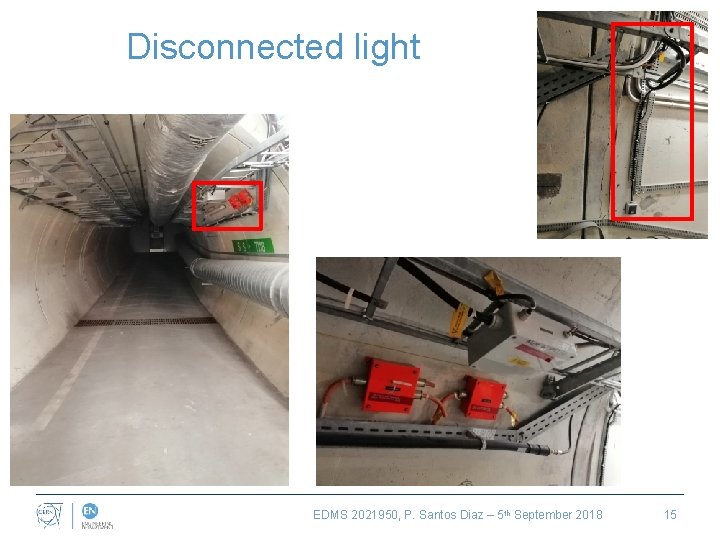

Disconnected light EDMS 2021950, P. Santos Diaz – 5 th September 2018 15

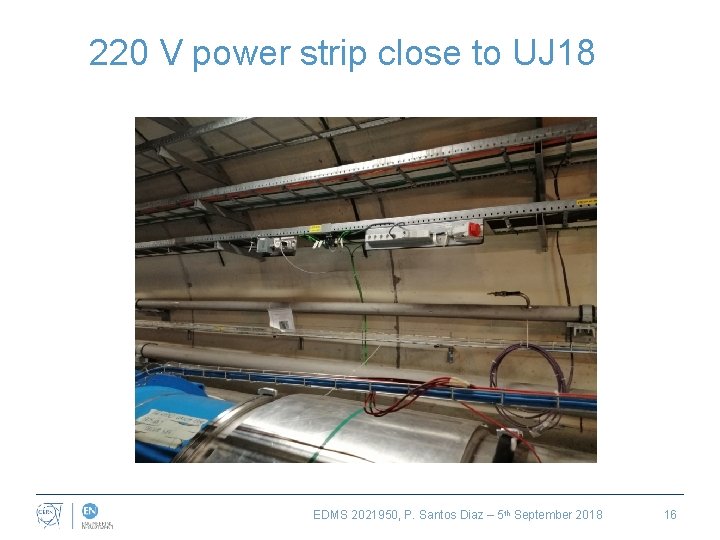

220 V power strip close to UJ 18 EDMS 2021950, P. Santos Diaz – 5 th September 2018 16
