Trincomalee Campus Eastern University Sri Lanka Progress Review






- Slides: 6
Trincomalee Campus, Eastern University, Sri Lanka Progress Review on Construction Projects as at 31. 07. 2015

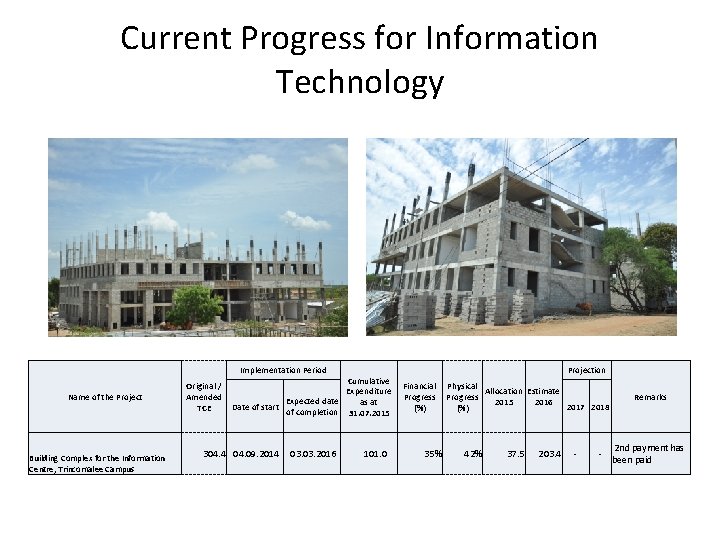

Current Progress for Information Technology Implementation Period Name of the Project Original / Amended TCE Cumulative Expenditure Expected date as at Date of start of completion 31. 07. 2015 304. 4 04. 09. 2014 03. 2016 101. 0 Building Complex for the Information Centre, Trincomalee Campus Projection Financial Progress (%) 35% Physical Allocation Estimate Progress 2015 2016 2017 2018 (%) 42% 37. 5 203. 4 - - Remarks 2 nd payment has been paid

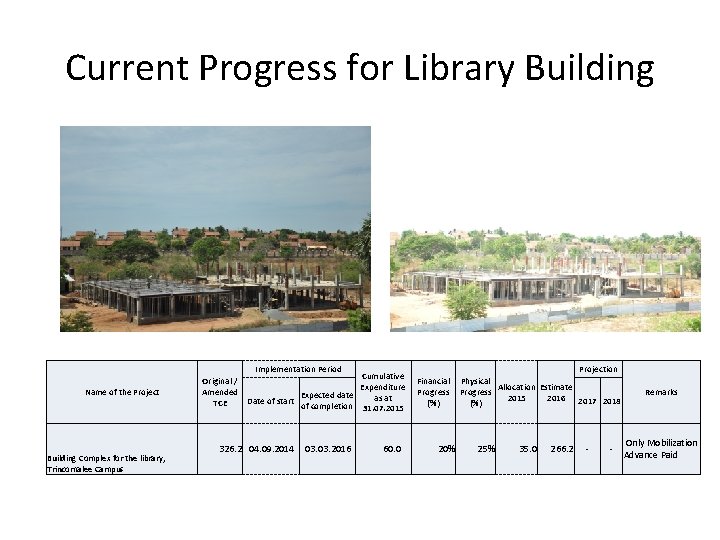

Current Progress for Library Building Implementation Period Name of the Project Building Complex for the library, Trincomalee Campus Original / Amended TCE Cumulative Expenditure Expected date as at Date of start of completion 31. 07. 2015 326. 2 04. 09. 2014 03. 2016 60. 0 Projection Financial Progress (%) 20% Physical Allocation Estimate Progress 2015 2016 2017 2018 (%) 25% 35. 0 266. 2 - - Remarks Only Mobilization Advance Paid

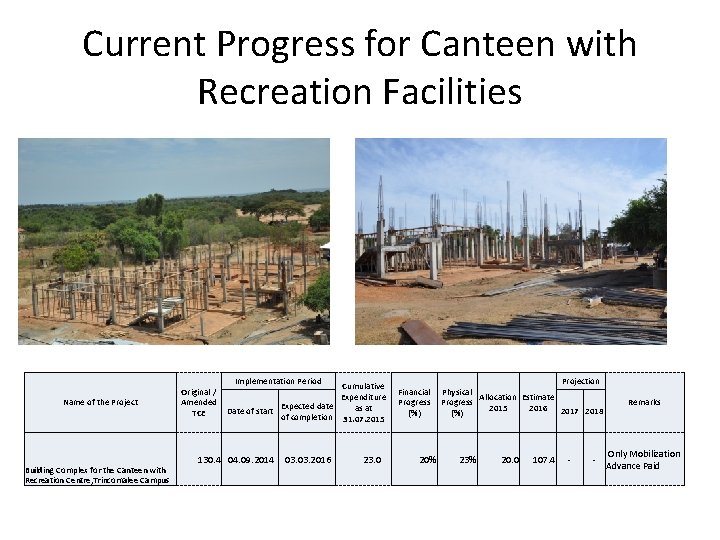

Current Progress for Canteen with Recreation Facilities Name of the Project Original / Amended TCE Implementation Period Cumulative Expenditure Expected date as at Date of start of completion 31. 07. 2015 130. 4 04. 09. 2014 03. 2016 23. 0 Building Complex for the Canteen with Recreation Centre, Trincomalee Campus Financial Progress (%) 20% Projection Physical Allocation Estimate Progress 2015 2016 2017 2018 (%) 23% 20. 0 107. 4 - - Remarks Only Mobilization Advance Paid

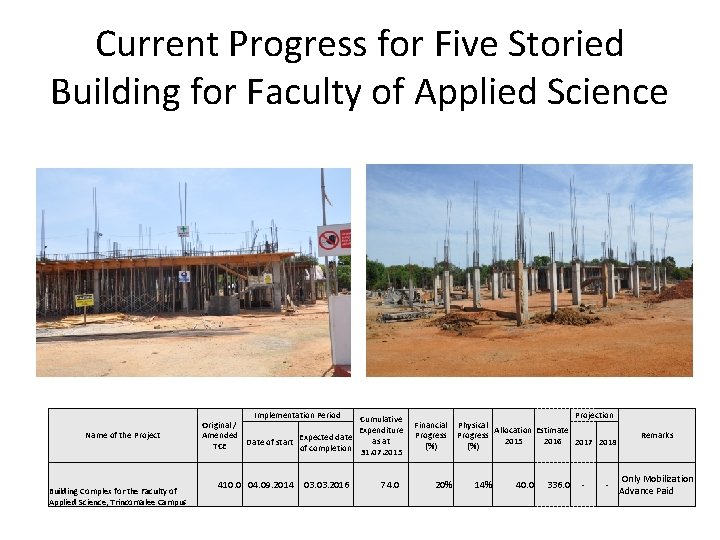

Current Progress for Five Storied Building for Faculty of Applied Science Name of the Project Implementation Period Cumulative Original / Expenditure Amended Expected date as at Date of start TCE of completion 31. 07. 2015 410. 0 04. 09. 2014 03. 2016 74. 0 Building Complex for the Faculty of Applied Science, Trincomalee Campus Financial Progress (%) 20% Projection Physical Allocation Estimate Progress 2015 2016 2017 2018 (%) 14% 40. 0 336. 0 - - Remarks Only Mobilization Advance Paid

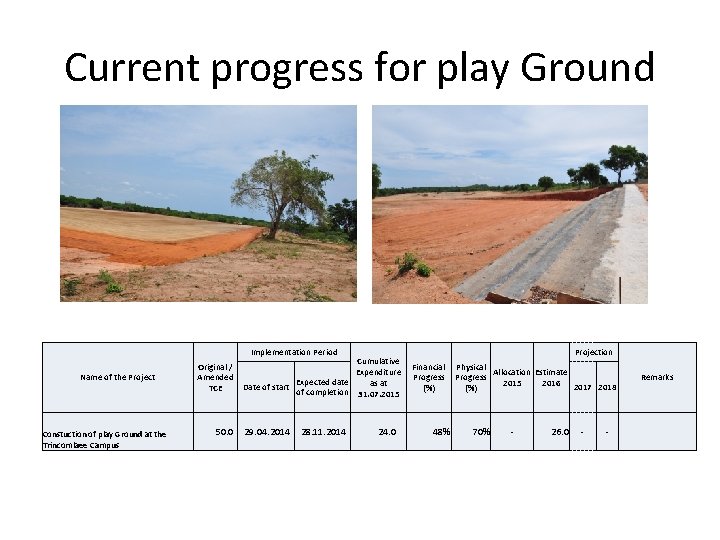

Current progress for play Ground Implementation Period Name of the Project Constuction of play Ground at the Trincomlaee Campus Original / Amended TCE Cumulative Expenditure Expected date as at Date of start of completion 31. 07. 2015 50. 0 29. 04. 2014 28. 11. 2014 24. 0 Projection Financial Progress (%) 48% Physical Allocation Estimate Progress 2015 2016 2017 2018 (%) 70% - 26. 0 - - Remarks
