THEMIS Extended Mission THEMIS ARTEMIS Mission Design Concept

  • Slides: 21
Download presentation
THEMIS Extended Mission: THEMIS & ARTEMIS Mission Design Concept (to be proposed in Senior

THEMIS Extended Mission: THEMIS & ARTEMIS Mission Design Concept (to be proposed in Senior Review, Feb 21) SWT 1 Dec 16, 2007

P 3, 4, 5, orbits for T 3/D 3/R 3 Separations >0. 5 RE

P 3, 4, 5, orbits for T 3/D 3/R 3 Separations >0. 5 RE in d. R-d. Z T 3 (2010 -04 -05) D 3 (2010 -11 -01) Y P 3 Z P 5 P 4 P 5 Y X P 3 D 3, GSE coord’s View from dawn on Ecliptic d. Z(P 3 -P 5) ~ 1000 -3000 km d. R(P 3 -P 4)~1000 km < d. Z [every day] Apogee~12 Re T 3, GSE coord’s View from dawn along NS d. Z(P 3 -P 5) ~ 600 -3000 km d. R(P 3 -P 4)~1 RE > d. Z [every 8 days] Y R 3 (Year-round) X Z P 5 P 4 P 3 R 3, GSE coord’s View from top d. Z(P 3 -P 5), as in T 3. Variable along-track separations SWT 2 Dec 16, 2007

P 3, 4, 5 orbits for T 4, D 4, R 4, T 5

P 3, 4, 5 orbits for T 4, D 4, R 4, T 5 Separations < 0. 5 RE in d. R-d. Z T 4 (2011 -05 -10) Z T 5 (2012 -06 -21) Z D 4 (2011 -12 -01) 1000 km Y Y T 4 (and T 5), GSE coord’s View from dawn along NS d. Z(P 3 -P 5) ~ 100 -500 km d. R(P 3 -P 4)~1000 km > d. Z [every day] Apogee ~ 12 R E X D 4, GSE coord’s d. Z(P 3 -P 5) ~ 1000 -3000 km d. R(P 3 -P 4)~1000 km < d. Z [every day] Apogee~12 Re X R 4 (at Dawn/dusk) P 5 P 4 P 3 R 4, GSE coord’s View from top String-of-Pearls. Variable along-track separations: 100 km-2 RE SWT 3 Dec 16, 2007

P 3, 4, 5 prime maneuvers and delta. V SWT 4 Dec 16, 2007

P 3, 4, 5 prime maneuvers and delta. V SWT 4 Dec 16, 2007

Maneuvers/Operations: THEMIS • P 3, 4, 5 have been maneuvered to close proximity before

Maneuvers/Operations: THEMIS • P 3, 4, 5 have been maneuvered to close proximity before (coast-phase experience) – Un-optimized string-of-pearls, but sufficient to build experience in clustering probes • • • Orbits are stable and shadows benign Operations are anticipated to be standard, but could get numerous (trimming) Maneuver planning is rather complex (as complex as THEMIS prime) – Contacted MMS and Cluster teams (Hughes/GSFC, Detlef Sieg/ESA) • Careful orbit design to ensure science benefits is required and will start early – Triangle (THEMIS) is easier than tetrahedron (Cluster) but orientation and scales are critical – Like for the THEMIS prime mission, we need to make careful science, delta. V and operational complexity trades to obtain a balance between science and available resources The THEMIS P 3, 4, 5 extended mission design builds on tremendous heritage in maneuver and orbit reconstruction operations and is expected to not necessitate additional operational tools except for additional science orbit optimization to ensure a balance between science and resources. SWT 5 Dec 16, 2007

Maneuvers/Operations: ARTEMIS • P 1, P 2 have sufficient fuel to raise apogee to

Maneuvers/Operations: ARTEMIS • P 1, P 2 have sufficient fuel to raise apogee to the moon: – Easier to go up than down – Lunar gravity perturbs orbits sufficiently to remove long shadows • Probes need not stay any longer in Earth orbit – Mission design and operations can become complex and expensive unless new target is found • • Use the moon as anchor to perform new tail and new Solar Wind science Permits exploration of a unique Lunar-Solar and Lunar-Tail environment like never done before Optimal use of de-orbit fuel (lunar re-entry) Design considerations for Lunar insertion, result in a robust mission: – – Spin axis at ecliptic normal throughout mission: optimal communications Equatorial Lunar orbit: stable for many years After Lunar Orbit Insertion operations are routine A 24 hr orbit guarantees: » Less than 3. 5 hr shadows, acceptable for probe design » Familiar, low risk power, thermal and operations environment – Mission design that satisfies above criteria is robust: • Under study by JPL since April 2005 • By same team which validated the THEMIS mission design in 2004 -2005 • JPL review on 2007 -Nov-02 found no technical issues – Further Navigation work to minimize fuel maintenance under way – Further cost-optimization work to minimize operations costs under way ARTEMIS mission design has undergone several iterations and reviews and is quite robust SWT 6 Dec 16, 2007

ARTEMIS “Acceleration, Reconnection, Turbulence and Electrodynamics of the Moon’s Interaction with the Sun” SWT

ARTEMIS “Acceleration, Reconnection, Turbulence and Electrodynamics of the Moon’s Interaction with the Sun” SWT 7 Dec 16, 2007

ARTEMIS Selective Orbits Phase I (Oct ’ 09 – Oct ’ 10) - placement

ARTEMIS Selective Orbits Phase I (Oct ’ 09 – Oct ’ 10) - placement SWT 8 Dec 16, 2007

ARTEMIS Selective Orbits Phase II (Oct ’ 10 – Jan ’ 11) – opposite

ARTEMIS Selective Orbits Phase II (Oct ’ 10 – Jan ’ 11) – opposite SWT 9 Dec 16, 2007

ARTEMIS Selective Orbits Phase II (Oct ’ 10 – Jan ’ 11) – opposite

ARTEMIS Selective Orbits Phase II (Oct ’ 10 – Jan ’ 11) – opposite SWT 10 Dec 16, 2007

ARTEMIS Selective Orbits Phase III (Jan ’ 11 – Apr ’ 11) – same

ARTEMIS Selective Orbits Phase III (Jan ’ 11 – Apr ’ 11) – same side SWT 11 Dec 16, 2007

Phase III (Jan ’ 11 – Apr ’ 11) – same side SWT 12

Phase III (Jan ’ 11 – Apr ’ 11) – same side SWT 12 Dec 16, 2007

Phase III (Jan ’ 11 – Apr ’ 11) – same side SWT 13

Phase III (Jan ’ 11 – Apr ’ 11) – same side SWT 13 Dec 16, 2007

ARTEMIS Wake Crossings: Phase II, III SWT 14 Dec 16, 2007

ARTEMIS Wake Crossings: Phase II, III SWT 14 Dec 16, 2007

ARTEMIS Distant Wake Crossings: A Perspective d. B SWT 15 Dec 16, 2007

ARTEMIS Distant Wake Crossings: A Perspective d. B SWT 15 Dec 16, 2007

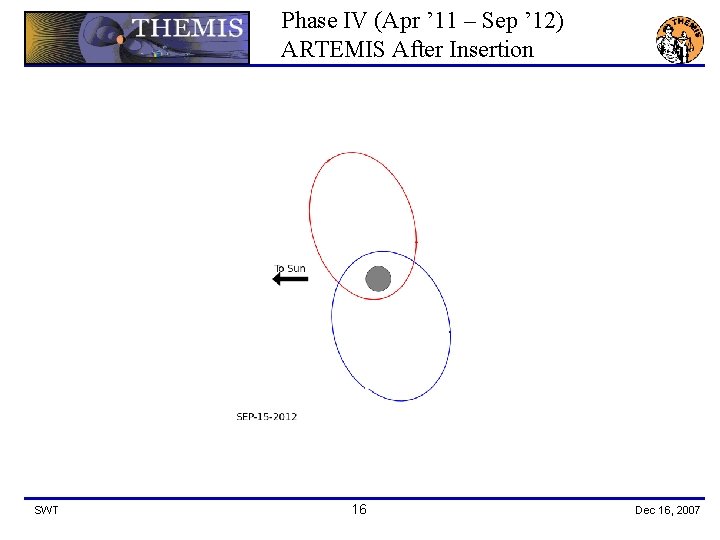

Phase IV (Apr ’ 11 – Sep ’ 12) ARTEMIS After Insertion SWT 16

Phase IV (Apr ’ 11 – Sep ’ 12) ARTEMIS After Insertion SWT 16 Dec 16, 2007

ARTEMIS Wake Crossings SWT 17 Dec 16, 2007

ARTEMIS Wake Crossings SWT 17 Dec 16, 2007

ARTEMIS Mission Profile SWT 18 Dec 16, 2007

ARTEMIS Mission Profile SWT 18 Dec 16, 2007

Trajectory Characteristics • There are 2 spacecraft (P 1 and P 2) that need

Trajectory Characteristics • There are 2 spacecraft (P 1 and P 2) that need to go from Earth orbit to Lunar Lissajous orbits to Lunar orbit. – Limited total ΔV available (P 1: ~300. 0 m/s, P 2: ~448. 5 m/s) • A low-energy trajectory is used for the Trans-lunar trajectory leg. – Spacecraft will be in orbit around opposing Lagrange points for 3 months. – Spacecraft will be in orbit around the same Lagrange point for 2 months. • Models and Assumptions – Planetary bodies • Point Bodies: Sun and Moon • Earth Including J 2 – Deterministic, impulsive maneuvers SWT 19 Dec 16, 2007

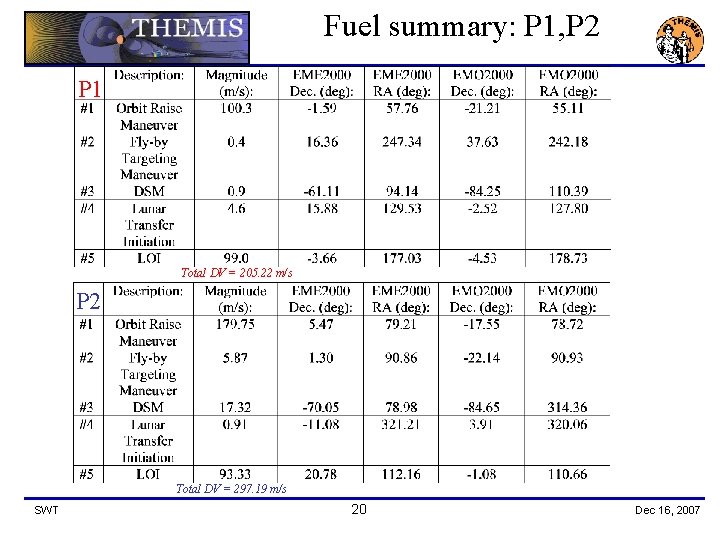

Fuel summary: P 1, P 2 P 1 Total DV = 205. 22 m/s

Fuel summary: P 1, P 2 P 1 Total DV = 205. 22 m/s P 2 Total DV = 297. 19 m/s SWT 20 Dec 16, 2007

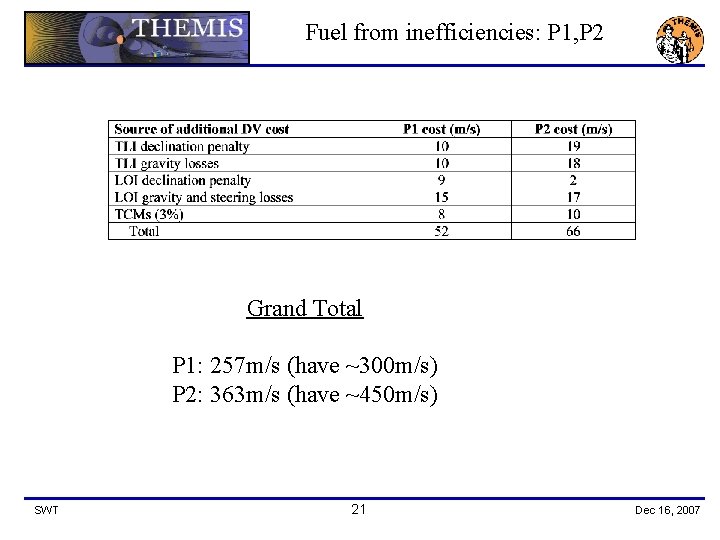

Fuel from inefficiencies: P 1, P 2 Grand Total P 1: 257 m/s (have

Fuel from inefficiencies: P 1, P 2 Grand Total P 1: 257 m/s (have ~300 m/s) P 2: 363 m/s (have ~450 m/s) SWT 21 Dec 16, 2007
