The Real Estate (Regulation and Development) Act, 2016 Presented by

The Real Estate (Regulation and Development) Act, 2016 Presented by

Session CA. Vinay Thyagaraj B. Com. , LLB Chartered Accountant Bengaluru RERA Audit –

Session CA. Vinay Thyagaraj B. Com. , LLB Chartered Accountant Bengaluru RERA Audit – Challenges and Preparedness 21 st September, Friday at 5 PM At Vasavi Vidyaniketan Trust, Bangalore Venu & Vinay, Chartered

Presentation Overview - Contents 1. Post Registration – Financial Management a. Funds collected from

Presentation Overview - Contents 1. Post Registration – Financial Management a. Funds collected from Allottees b. Utilisation of / withdrawal of funds c. Professional Certification 2. RERA Audit – Challenges and possible solutions Q & A Session Venu & Vinay, Chartered

Post Registration – Financial Management a. Funds collected from Allottees b. Utilisation of /

Post Registration – Financial Management a. Funds collected from Allottees b. Utilisation of / withdrawal of funds c. Professional Certifications Venu & Vinay, Chartered

Types of Certificates – CA’s Sl No 1 2 3 Certificate for Act /

Types of Certificates – CA’s Sl No 1 2 3 Certificate for Act / Rule Ref Ongoing Project – 1 st Karnataka RERD Rule- time Rule 4(2)(c ) On every withdrawal RERD Act – from project Bank Account 2 nd proviso to sec 4(2)(l)(D) Annual Audit under RERD Act – RERD Act 3 rd proviso to sec 4(2)(l)(D) Venu & Vinay, Chartered Certifying Extent of development carried out, pending – money collected from allottees, spent for project and balance with promoter Withdrawal of money from project bank account is in proportion to the % of completion of the project 1. Amounts collected from Allottees for a particular project have been utilised for the same project and 1. the withdrawal has been in compliance with the proportion to the % of completion of the project

Venu & Vinay, Chartered

Venu & Vinay, Chartered

Why What Whom How When Who Venu & Vinay, Chartered

Why What Whom How When Who Venu & Vinay, Chartered

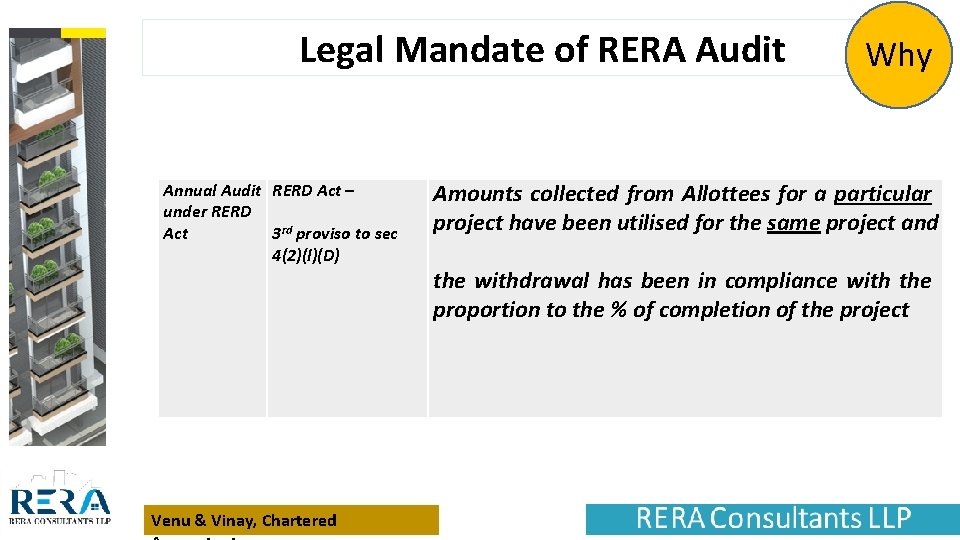

Legal Mandate of RERA Audit Annual Audit RERD Act – under RERD Act 3

Legal Mandate of RERA Audit Annual Audit RERD Act – under RERD Act 3 rd proviso to sec 4(2)(l)(D) Venu & Vinay, Chartered Why Amounts collected from Allottees for a particular project have been utilised for the same project and the withdrawal has been in compliance with the proportion to the % of completion of the project

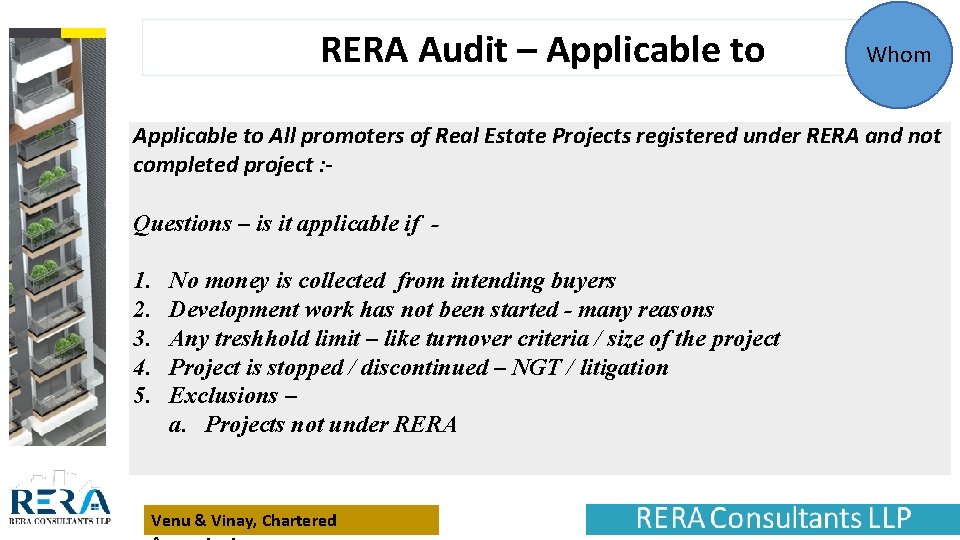

RERA Audit – Applicable to Whom Applicable to All promoters of Real Estate Projects

RERA Audit – Applicable to Whom Applicable to All promoters of Real Estate Projects registered under RERA and not completed project : Questions – is it applicable if - 1. 2. 3. 4. 5. No money is collected from intending buyers Development work has not been started - many reasons Any treshhold limit – like turnover criteria / size of the project Project is stopped / discontinued – NGT / litigation Exclusions – a. Projects not under RERA Venu & Vinay, Chartered

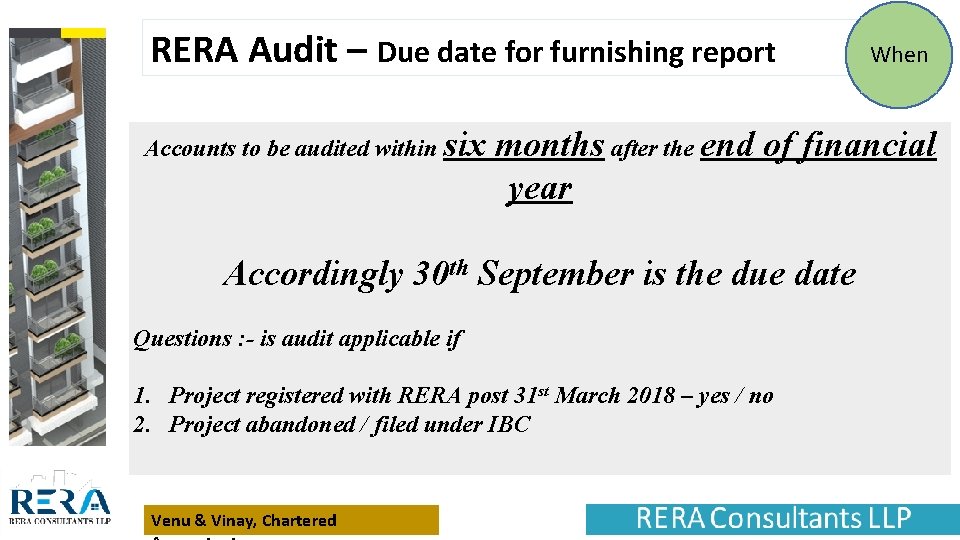

RERA Audit – Due date for furnishing report Accounts to be audited within six

RERA Audit – Due date for furnishing report Accounts to be audited within six months after the end of financial year Accordingly 30 th September is the due date Questions : - is audit applicable if 1. Project registered with RERA post 31 st March 2018 – yes / no 2. Project abandoned / filed under IBC Venu & Vinay, Chartered When

RERA Audit – who should issue report Who Chartered Accountant in practice shall issue

RERA Audit – who should issue report Who Chartered Accountant in practice shall issue audit report Questions : - 1. 2. 3. 4. 5. 6. Who is CA -is it defined in the Act – yes Can CA in employment audit / certify - no Can internal auditor audit / certify - no Can Tax Auditor certify– no Can Statutory Auditor - yes Can ? The Same CA, who issued periodical withdrawal certificate – yes / no Venu & Vinay, Chartered

RERA Audit – where to submit where 1. Act and Rules silent about method

RERA Audit – where to submit where 1. Act and Rules silent about method of submission of the Audit Report and Certificates 2. However authorities have made a provision to upload these reports online / manual submissions Venu & Vinay, Chartered

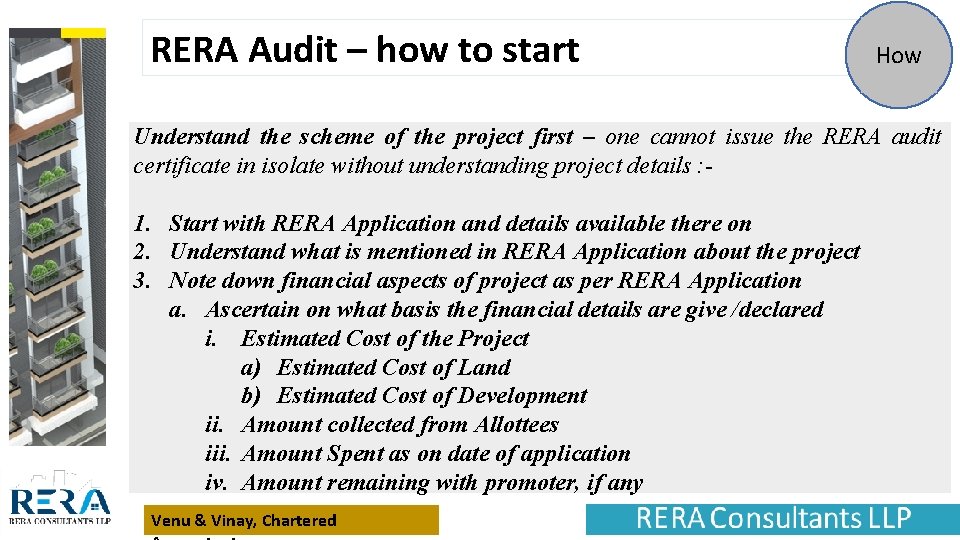

RERA Audit – how to start How Understand the scheme of the project first

RERA Audit – how to start How Understand the scheme of the project first Entity – Group – multiple entities multiple Projects Venu & Vinay, Chartered Project - multiple Phases / tower RERA Project

RERA Audit – how to start How Understand the scheme of the project first

RERA Audit – how to start How Understand the scheme of the project first – one cannot issue the RERA audit certificate in isolate without understanding project details : - 1. Start with RERA Application and details available there on 2. Understand what is mentioned in RERA Application about the project 3. Note down financial aspects of project as per RERA Application a. Ascertain on what basis the financial details are give /declared i. Estimated Cost of the Project a) Estimated Cost of Land b) Estimated Cost of Development ii. Amount collected from Allottees iii. Amount Spent as on date of application iv. Amount remaining with promoter, if any Venu & Vinay, Chartered

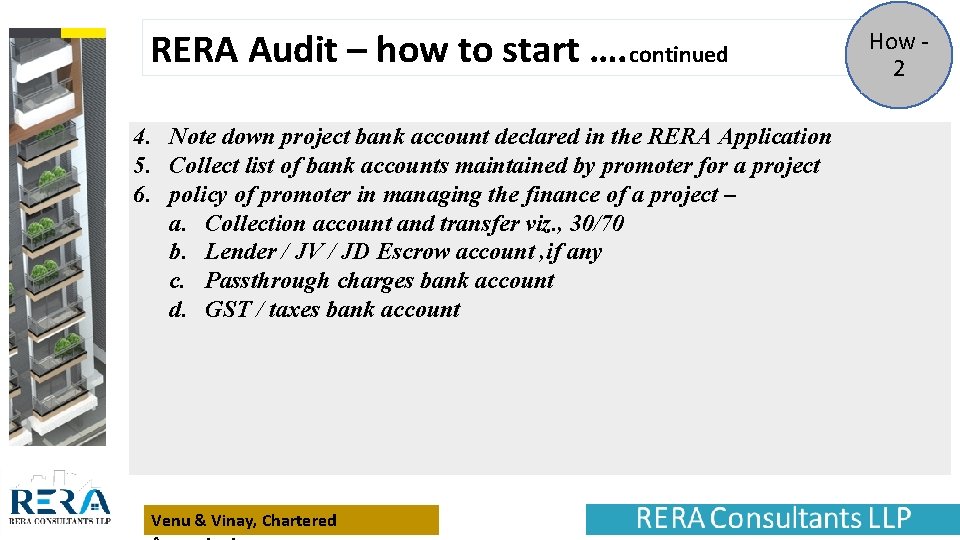

RERA Audit – how to start …. continued 4. Note down project bank account

RERA Audit – how to start …. continued 4. Note down project bank account declared in the RERA Application 5. Collect list of bank accounts maintained by promoter for a project 6. policy of promoter in managing the finance of a project – a. Collection account and transfer viz. , 30/70 b. Lender / JV / JD Escrow account , if any c. Passthrough charges bank account d. GST / taxes bank account Venu & Vinay, Chartered How - 2

RERA Audit – how to start …. continued How - 3 7. Collect professional

RERA Audit – how to start …. continued How - 3 7. Collect professional certificates till 31 st March 2018 obtained by the promoter on every withdrawal (refer Sec 4(2)(l)(D) 2 nd proviso) – A / C / E 8. First time certificate from professionals as per KA RERD Rules a. Excess money collected if any b. Deposit into project account with in 90 days from the date of application 9. Collect total money collected from allottees a. Deposit of such money in 30 / 70 10. Withdrawal of such 70 % money from project bank account a. Supported by A / C / E certificates Venu & Vinay, Chartered

RERA Audit –start …. continued How - 4 11. If receivables in an ongoing

RERA Audit –start …. continued How - 4 11. If receivables in an ongoing project are less than the estimated cost of balance construction, then the promoter shall deposit 100 per cent of the amounts to be realised in the separate account a. Check and ensure this information from application b. Check 100 % collections are deposited (without taking 30 %) Eg. , a. funds required to complete the project – 10 Crores b. Receivables as on 10 -7 -2017 are 8 Crores c. 30 / 70 is not applicable as per proviso to KRERA Rule 4(5) Venu & Vinay, Chartered

RERA Audit –start …. audit now begin Consolidate all the information / documents received

RERA Audit –start …. audit now begin Consolidate all the information / documents received till 31 st March 2018 in a Excel to arrive at conclusion on : - 1. Amounts collected for a particular project have been utilised for the same project 2. Withdrawals have been in proportion to the % of completion of the project Venu & Vinay, Chartered

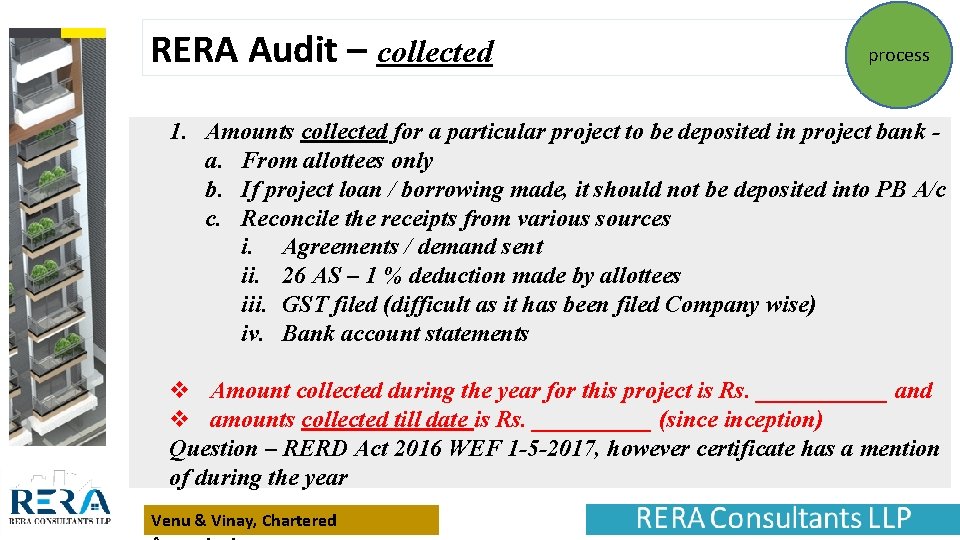

RERA Audit – collected process 1. Amounts collected for a particular project to be

RERA Audit – collected process 1. Amounts collected for a particular project to be deposited in project bank a. From allottees only b. If project loan / borrowing made, it should not be deposited into PB A/c c. Reconcile the receipts from various sources i. Agreements / demand sent ii. 26 AS – 1 % deduction made by allottees iii. GST filed (difficult as it has been filed Company wise) iv. Bank account statements v Amount collected during the year for this project is Rs. ______ and v amounts collected till date is Rs. _____ (sinception) Question – RERD Act 2016 WEF 1 -5 -2017, however certificate has a mention of during the year Venu & Vinay, Chartered

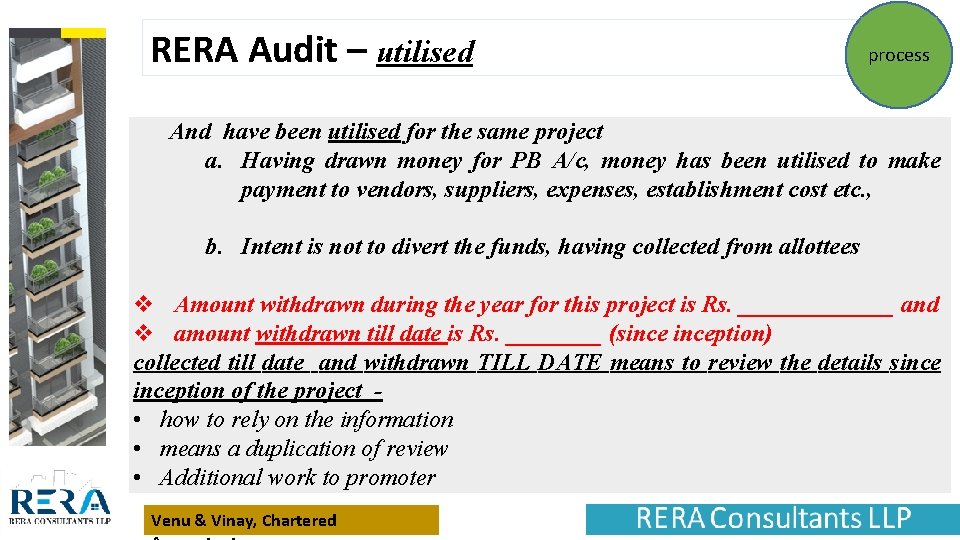

RERA Audit – utilised process And have been utilised for the same project a.

RERA Audit – utilised process And have been utilised for the same project a. Having drawn money for PB A/c, money has been utilised to make payment to vendors, suppliers, expenses, establishment cost etc. , b. Intent is not to divert the funds, having collected from allottees v Amount withdrawn during the year for this project is Rs. _______ and v amount withdrawn till date is Rs. ____ (sinception) collected till date and withdrawn TILL DATE means to review the details sinception of the project • how to rely on the information • means a duplication of review • Additional work to promoter Venu & Vinay, Chartered

RERA Audit – utilisation process Questions: - utilisation 1. 2. 3. 4. 5. 6.

RERA Audit – utilisation process Questions: - utilisation 1. 2. 3. 4. 5. 6. 7. Repayment of Loan – permitted if loan obtained is for this project Payment of penalty or fines – no restrictions as such Advance to suppliers – permitted – ensure such materials are supplied GST / Indirect Tax payments – yes Income Tax payments – NO – it is out of 30 % Refund to clients – Yes Payment to associate / related party / sister concern as advance – yes / no Venu & Vinay, Chartered

RERA Audit – proportion and % of completion process Withdrawal has been in compliance

RERA Audit – proportion and % of completion process Withdrawal has been in compliance with the proportion to the % of completion of the project : - a. Based on Architect and Engineer Certificate b. Calculate % based on financial statements / books of accounts c. Prudence to be followed (which ever is lower) + advance payments towards supply of materials and services shall be considered Venu & Vinay, Chartered

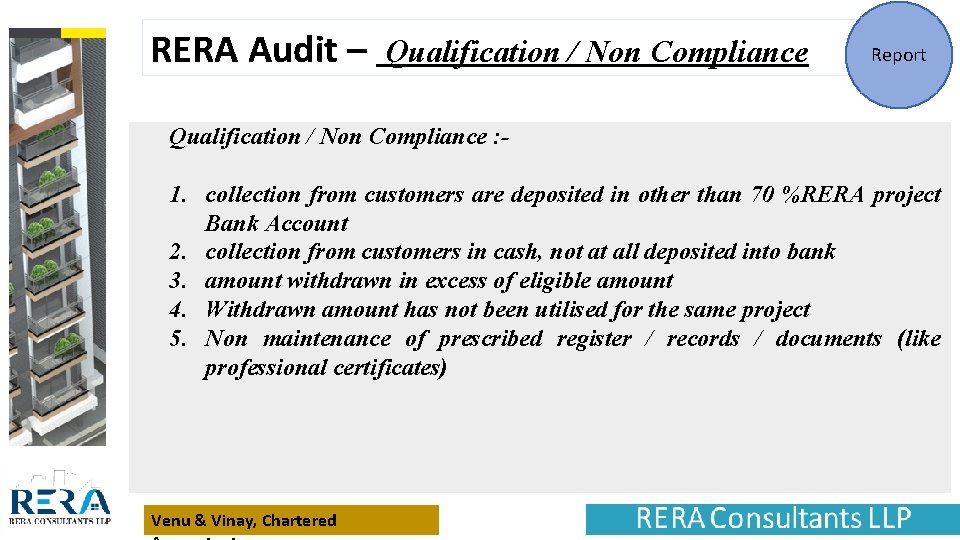

RERA Audit – Qualification / Non Compliance Report Qualification / Non Compliance : -

RERA Audit – Qualification / Non Compliance Report Qualification / Non Compliance : - 1. collection from customers are deposited in other than 70 %RERA project Bank Account 2. collection from customers in cash, not at all deposited into bank 3. amount withdrawn in excess of eligible amount 4. Withdrawn amount has not been utilised for the same project 5. Non maintenance of prescribed register / records / documents (like professional certificates) Venu & Vinay, Chartered

RERA Audit – Challenges 1. Sufficient Knowledge of Act and Rules –Both promoter and

RERA Audit – Challenges 1. Sufficient Knowledge of Act and Rules –Both promoter and professionals 2. Information filled during registration is erroneous – what stand will u take 3. Record / data / expenses maintenance a. RERA Project wise 4. Allocation of common expenses RERA project-wise a. Basis of allocation b. Loan availed and interest apportionment to RERA project-wise 5. Reconciliation at various stages and different records 6. Clarity on the statute, being new to all 7. In case of single RERA registration – information from Landlord and compliance there on under RERD (being a Co- Promoter) Venu & Vinay, Chartered

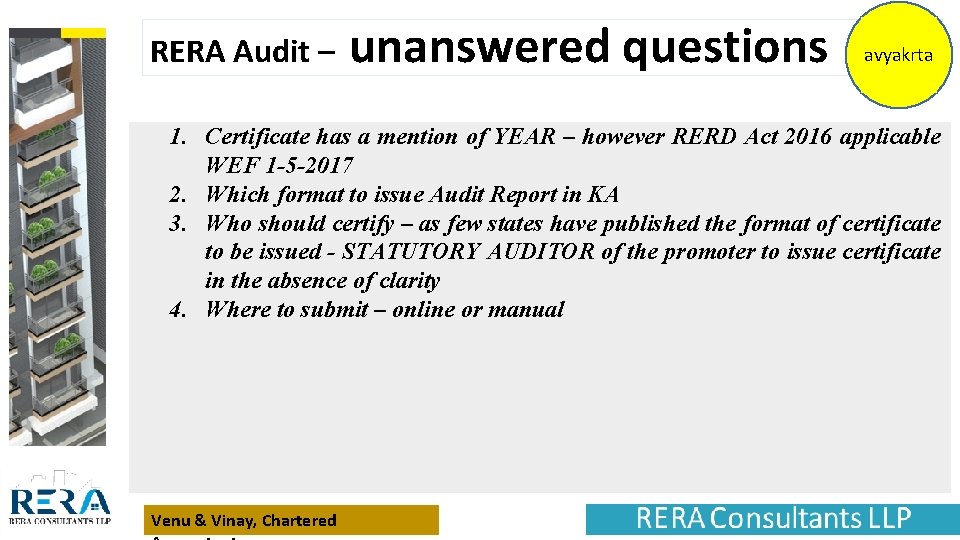

RERA Audit – unanswered questions avyakrta 1. Certificate has a mention of YEAR –

RERA Audit – unanswered questions avyakrta 1. Certificate has a mention of YEAR – however RERD Act 2016 applicable WEF 1 -5 -2017 2. Which format to issue Audit Report in KA 3. Who should certify – as few states have published the format of certificate to be issued - STATUTORY AUDITOR of the promoter to issue certificate in the absence of clarity 4. Where to submit – online or manual Venu & Vinay, Chartered

RERA Audit – Best Practices 1. 2. 3. 4. 5. 6. To Follow Don’t

RERA Audit – Best Practices 1. 2. 3. 4. 5. 6. To Follow Don’t be biased on the information and report Don’t be under the influence of Promoters Don’t be casual on report / certification Collect sufficient documents / information If you don’t know, ask others If you are not sure – report it Certificates issued may become public documents and amenable under RTI Venu & Vinay, Chartered

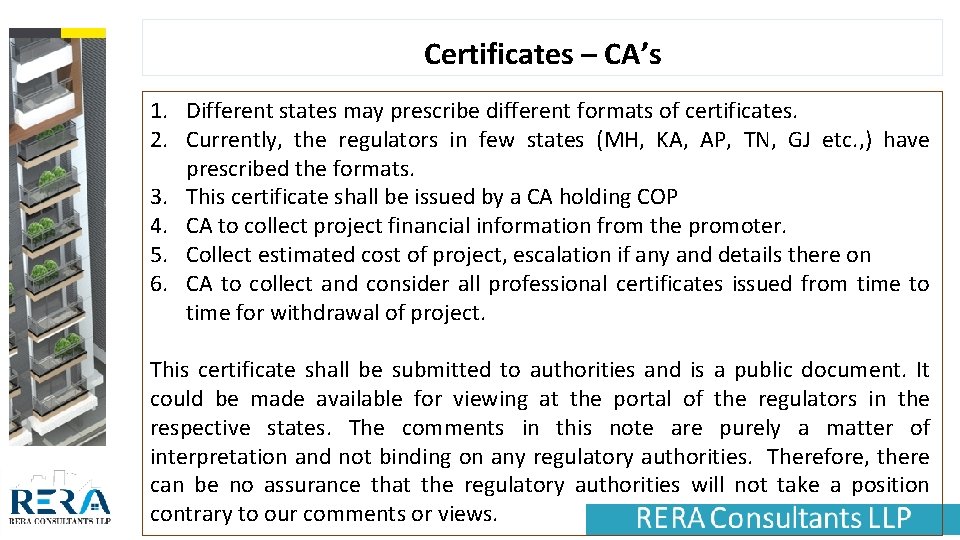

Certificates – CA’s 1. Different states may prescribe different formats of certificates. 2. Currently,

Certificates – CA’s 1. Different states may prescribe different formats of certificates. 2. Currently, the regulators in few states (MH, KA, AP, TN, GJ etc. , ) have prescribed the formats. 3. This certificate shall be issued by a CA holding COP 4. CA to collect project financial information from the promoter. 5. Collect estimated cost of project, escalation if any and details there on 6. CA to collect and consider all professional certificates issued from time to time for withdrawal of project. This certificate shall be submitted to authorities and is a public document. It could be made available for viewing at the portal of the regulators in the respective states. The comments in this note are purely a matter of interpretation and not binding on any regulatory authorities. Therefore, there can be no assurance that the regulatory authorities will not take a position contrary to our comments or views.

RERA Audit Certificate – Form Annual Report on Statement of Accounts (on the letter

RERA Audit Certificate – Form Annual Report on Statement of Accounts (on the letter head of chartered accountants who is statutory auditor of the promoter’s company/firm) To, [NAME & ADDRESS OF PROMOTER] SUBJECT: Report on Statement of Accounts on project fund utilization and withdrawal by [Promoter] for the period from ____ to ___with respect to project______ RERA Registration Number ____ 1. This certificate is issued in accordance with the provisions of the Real Estate (Regulation and Development) Act, 2016 read along with the Real Estate (Regulation and Development)(Registration of Real Estate Projects, Registration of Real Estate Agents, Rates of Interest and Disclosures on Website) Rules, 2017 Karnataka. Venu & Vinay, Chartered

RERA Audit Certificate – Form 2. I/We have obtained all necessary information and explanation

RERA Audit Certificate – Form 2. I/We have obtained all necessary information and explanation from the Promoter/ Company, during the course of our audit, which in my/our opinion are necessary for the purpose of this certificate. 3. I/We hereby confirm that I/We have examined the prescribed registers, books and documents, and the relevant records of [Promoter] for the period ended ____ and hereby certify that: i. M/s. ____ (Promoter) have completed ____% of the project titled ______ RERA Registration No. _____located at ______. ii. Amount collected during the year for this project is Rs. ______ and amounts collected till date is Rs. _____. iii. Amount withdrawn during the year for this project is Rs. _______ and amount withdrawn till date is Rs. ____. Venu & Vinay, Chartered

RERA Audit Certificate – Form 4. I/We certify that the [Name of Promoter] has

RERA Audit Certificate – Form 4. I/We certify that the [Name of Promoter] has utilized the amounts collected for___ project only for that project and the withdrawal from the designated bank account(s) of the said project has been in accordance with the proportion to the percentage of completion of the project. (If not, please specify the amount withdrawn in excess of eligible amount or any other exceptions) Signature and Stamp/Seal of the Signatory CA) Name of the Signatory: Place: Full Address: Date: Membership No. : Contact No. : E mail:

Documents 1. 2. 3. 4. 5. 6. 7. 8. 9. 10. 11. 12. 13.

Documents 1. 2. 3. 4. 5. 6. 7. 8. 9. 10. 11. 12. 13. 14. 15. Accounting records – updated books of accounts Copy of application filed for registration of project under RERD Act Details of calculations considered to arrive at estimated cost of project. All project related documents like land documents, sanctions, clearances, NOC’s Amount incurred towards acquisition of land or TDR etc All bank statements of RERA project account and other bank accounts Statement of customers, list of agreement of sales entered, advances received, balance receivables etc Money collected from allottees, 70 % deposit made to RERA project bank account All government fees challahs for all clearances etc All development expenses bills, vouchers, invoices for both onsite and offsite expenditures Advance paid for supply of materials or services vouchers, references etc Certificates from Engineer, Architect and CA for withdrawal of money based on % of completion of construction Project Loan or other loan statements Interest calculation / attribution towards the project. Indirect taxes / GST paid from time to time

Offences and Penalty – under RERA Act RERA Provision Promoter Non-registration of project/agent with

Offences and Penalty – under RERA Act RERA Provision Promoter Non-registration of project/agent with RERA and continue to do so Up to 10% of project cost and imprisonment of 3 years for continuous default False information while making an application to RERA Up to 5% of the estimated project cost Non-compliance with the order of RERA Up to 5% of the estimated project cost Up to 10% of cost and imprisonment of up to 3 years or both Agent Allottee Penalty of INR 10, 000 per day during default tenure up to 5% of property cost Non-compliance Up to 5% of the with any provision of estimated project the Act cost Up to 5% of the property cost Up to 5% of cost property cost Non-compliance with the order of the Appellate Tribunal Up to 10% of cost and imprisonment of up to 1 years or both Up to 10% of cost and imprisonment of up to 3 years or both Venu & Vinay, Chartered

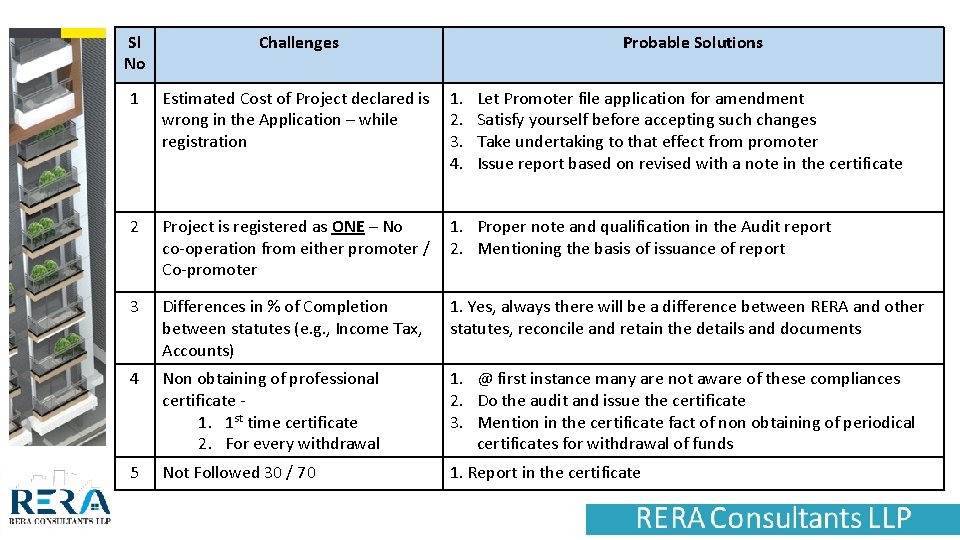

Sl No Challenges Probable Solutions 1 Estimated Cost of Project declared is 1. Let

Sl No Challenges Probable Solutions 1 Estimated Cost of Project declared is 1. Let Promoter file application for amendment wrong in the Application – while 2. Satisfy yourself before accepting such changes registration 3. Take undertaking to that effect from promoter 4. Issue report based on revised with a note in the certificate 2 Project is registered as ONE – No 1. Proper note and qualification in the Audit report co-operation from either promoter / 2. Mentioning the basis of issuance of report Co-promoter 3 Differences in % of Completion between statutes (e. g. , Income Tax, Accounts) 1. Yes, always there will be a difference between RERA and other statutes, reconcile and retain the details and documents 4 Non obtaining of professional certificate 1. 1 st time certificate 2. For every withdrawal 1. @ first instance many are not aware of these compliances 2. Do the audit and issue the certificate 3. Mention in the certificate fact of non obtaining of periodical certificates for withdrawal of funds 5 Not Followed 30 / 70 1. Report in the certificate

Sl No 6 7 8 9 10 Challenges Not Deposited 70 % of the

Sl No 6 7 8 9 10 Challenges Not Deposited 70 % of the amount collected in the RERA Designated bank account Probable Solutions 1. Report in the certificate

write to vinay@vnv. ca 080 - 23462003 consult@reraconsultants. in www. reraconsultants. in

write to vinay@vnv. ca 080 - 23462003 consult@reraconsultants. in www. reraconsultants. in

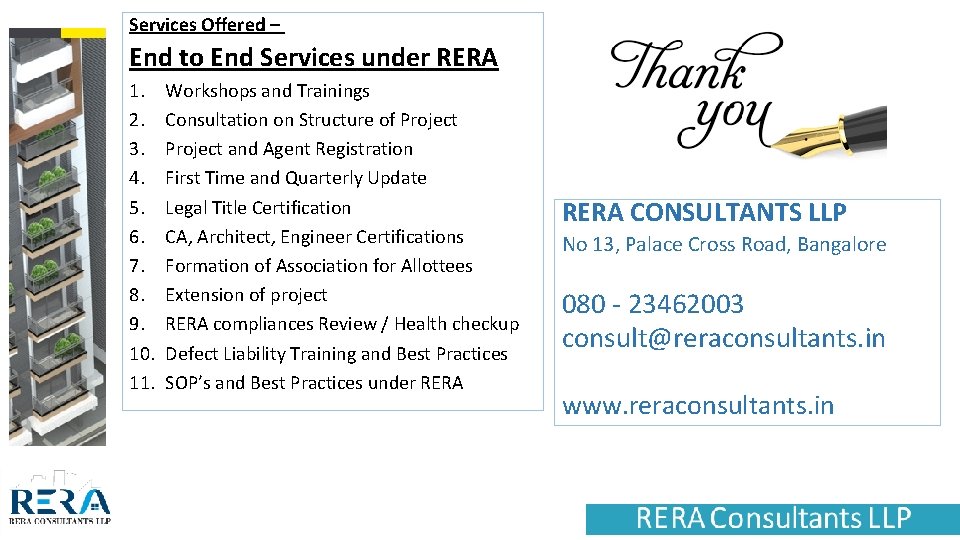

Services Offered – End to End Services under RERA 1. 2. 3. 4. 5.

Services Offered – End to End Services under RERA 1. 2. 3. 4. 5. 6. 7. 8. 9. 10. 11. Workshops and Trainings Consultation on Structure of Project and Agent Registration First Time and Quarterly Update Legal Title Certification CA, Architect, Engineer Certifications Formation of Association for Allottees Extension of project RERA compliances Review / Health checkup Defect Liability Training and Best Practices SOP’s and Best Practices under RERA CONSULTANTS LLP No 13, Palace Cross Road, Bangalore 080 - 23462003 consult@reraconsultants. in www. reraconsultants. in
