Systems Level Design Review Multidisciplinary Senior Design 1

  • Slides: 24
Download presentation
Systems Level Design Review Multidisciplinary Senior Design 1 Friday, December 21 st, 2012 P

Systems Level Design Review Multidisciplinary Senior Design 1 Friday, December 21 st, 2012 P 13051

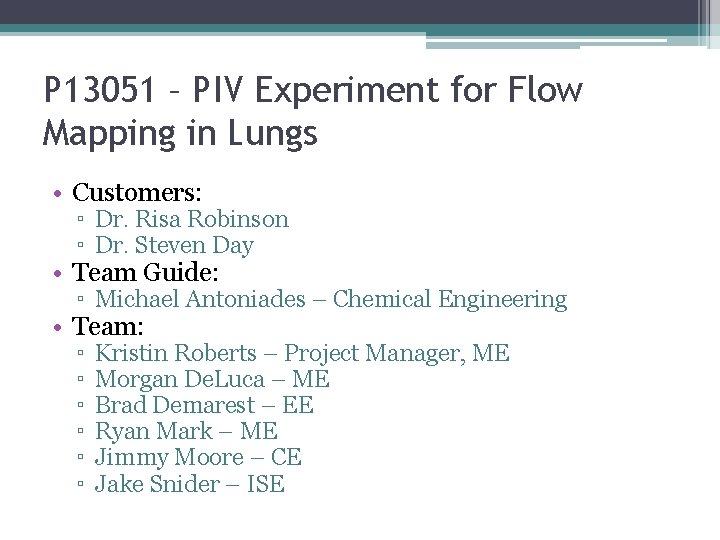

P 13051 – PIV Experiment for Flow Mapping in Lungs • Customers: ▫ Dr.

P 13051 – PIV Experiment for Flow Mapping in Lungs • Customers: ▫ Dr. Risa Robinson ▫ Dr. Steven Day • Team Guide: ▫ Michael Antoniades – Chemical Engineering • Team: ▫ ▫ ▫ Kristin Roberts – Project Manager, ME Morgan De. Luca – ME Brad Demarest – EE Ryan Mark – ME Jimmy Moore – CE Jake Snider – ISE

Agenda • • • Project Background Customer Needs Engineering Specifications Functional Analysis Concept Generation

Agenda • • • Project Background Customer Needs Engineering Specifications Functional Analysis Concept Generation & Selection ▫ Lung Model ▫ Pump ▫ Pressure Measurement & Control • Feasibility Analysis • Risk Assessment • Project Planning & WBS

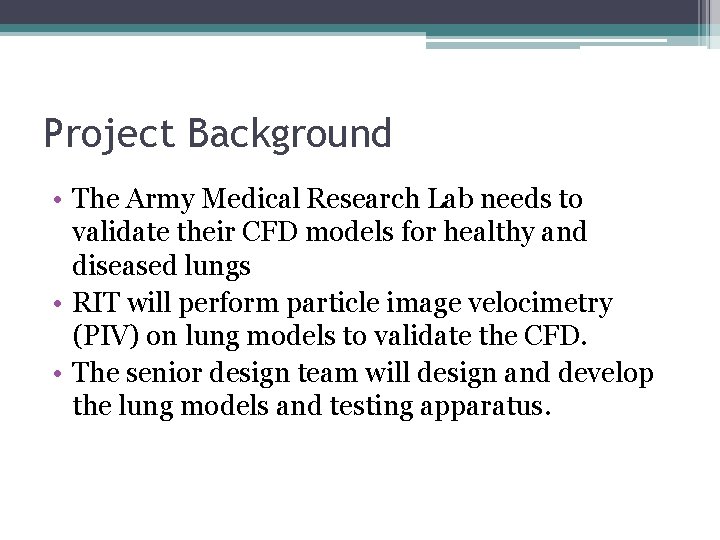

Project Background • The Army Medical Research Lab needs to validate their CFD models

Project Background • The Army Medical Research Lab needs to validate their CFD models for healthy and diseased lungs • RIT will perform particle image velocimetry (PIV) on lung models to validate the CFD. • The senior design team will design and develop the lung models and testing apparatus.

What is PIV? • Used for flow visualization and velocity measurements • Fluid is

What is PIV? • Used for flow visualization and velocity measurements • Fluid is seeded with tiny tracer particles • The particles are illuminated using a laser sheet, and a camera takes pictures of the particles. • Fluid velocity profiles can be obtained by analyzing particle movement from frame to frame.

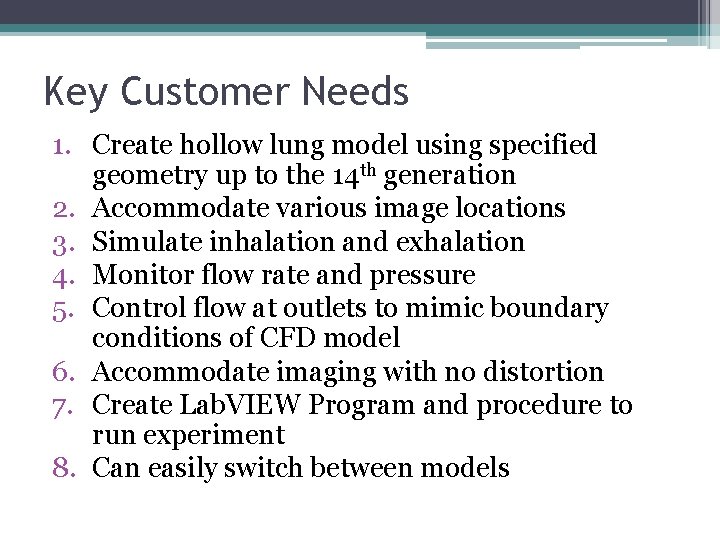

Key Customer Needs 1. Create hollow lung model using specified geometry up to the

Key Customer Needs 1. Create hollow lung model using specified geometry up to the 14 th generation 2. Accommodate various image locations 3. Simulate inhalation and exhalation 4. Monitor flow rate and pressure 5. Control flow at outlets to mimic boundary conditions of CFD model 6. Accommodate imaging with no distortion 7. Create Lab. VIEW Program and procedure to run experiment 8. Can easily switch between models

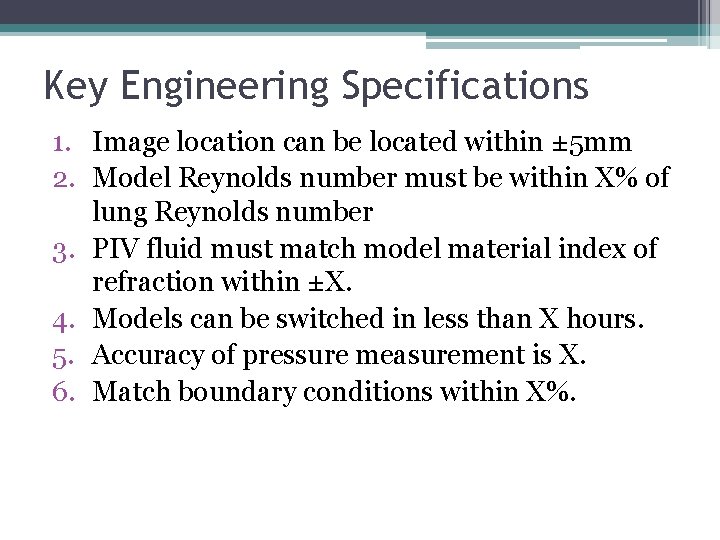

Key Engineering Specifications 1. Image location can be located within ± 5 mm 2.

Key Engineering Specifications 1. Image location can be located within ± 5 mm 2. Model Reynolds number must be within X% of lung Reynolds number 3. PIV fluid must match model material index of refraction within ±X. 4. Models can be switched in less than X hours. 5. Accuracy of pressure measurement is X. 6. Match boundary conditions within X%.

Functional Analysis

Functional Analysis

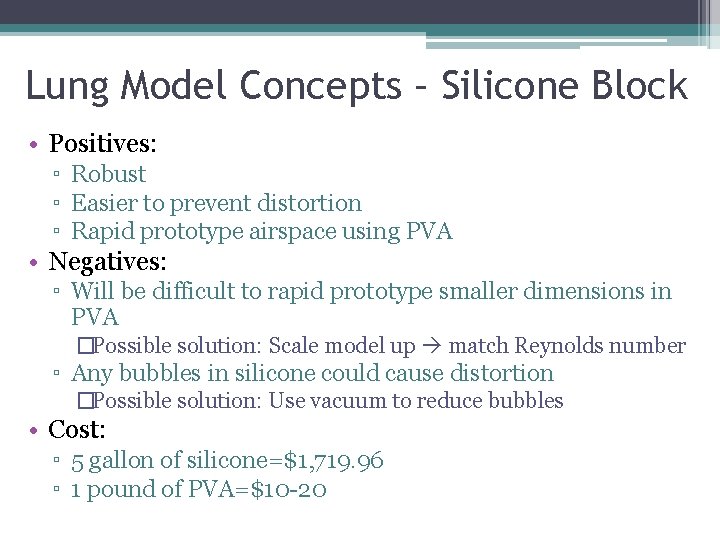

Lung Model Concepts – Silicone Block • Positives: ▫ Robust ▫ Easier to prevent

Lung Model Concepts – Silicone Block • Positives: ▫ Robust ▫ Easier to prevent distortion ▫ Rapid prototype airspace using PVA • Negatives: ▫ Will be difficult to rapid prototype smaller dimensions in PVA �Possible solution: Scale model up match Reynolds number ▫ Any bubbles in silicone could cause distortion �Possible solution: Use vacuum to reduce bubbles • Cost: ▫ 5 gallon of silicone=$1, 719. 96 ▫ 1 pound of PVA=$10 -20

Lung Model Concepts – Rapid Prototype • Positives: ▫ Can more easily model smaller

Lung Model Concepts – Rapid Prototype • Positives: ▫ Can more easily model smaller details and intricacies. ▫ Easier to access specific portions of model since it is not encased in a solid block. ▫ Prototyping all generations should not be a problem • Negatives: ▫ Fragile, especially at higher generation air passages; transporting model comes with the risk of damage. ▫ Would need to construct a container/support system prevent distortion. • Cost: ▫ High – Intricate design with small passageways increases cost to rapid prototype.

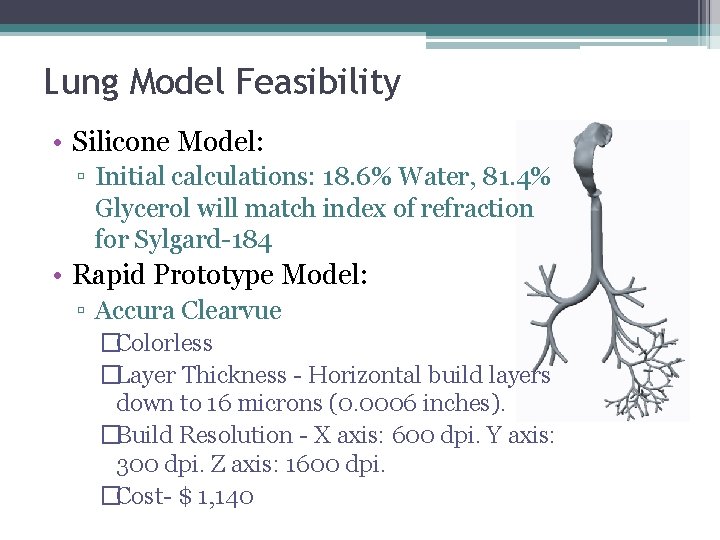

Lung Model Feasibility • Silicone Model: ▫ Initial calculations: 18. 6% Water, 81. 4%

Lung Model Feasibility • Silicone Model: ▫ Initial calculations: 18. 6% Water, 81. 4% Glycerol will match index of refraction for Sylgard-184 • Rapid Prototype Model: ▫ Accura Clearvue �Colorless �Layer Thickness - Horizontal build layers down to 16 microns (0. 0006 inches). �Build Resolution - X axis: 600 dpi. Y axis: 300 dpi. Z axis: 1600 dpi. �Cost- $ 1, 140

Pump Selection Pump Flow Rates Pressures Comments Cost (3 highest) Gear pump Acceptable, Up

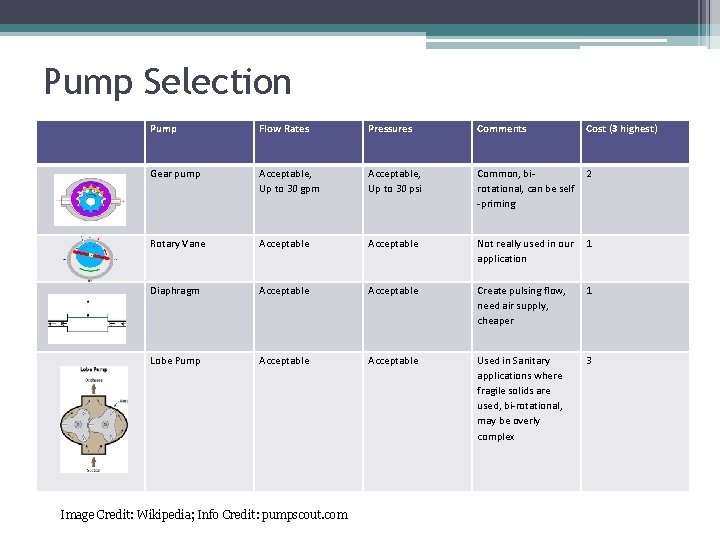

Pump Selection Pump Flow Rates Pressures Comments Cost (3 highest) Gear pump Acceptable, Up to 30 gpm Acceptable, Up to 30 psi Common, birotational, can be self -priming 2 Rotary Vane Acceptable Not really used in our application 1 Diaphragm Acceptable Create pulsing flow, need air supply, cheaper 1 Lobe Pump Acceptable Used in Sanitary applications where fragile solids are used, bi-rotational, may be overly complex 3 Image Credit: Wikipedia; Info Credit: pumpscout. com

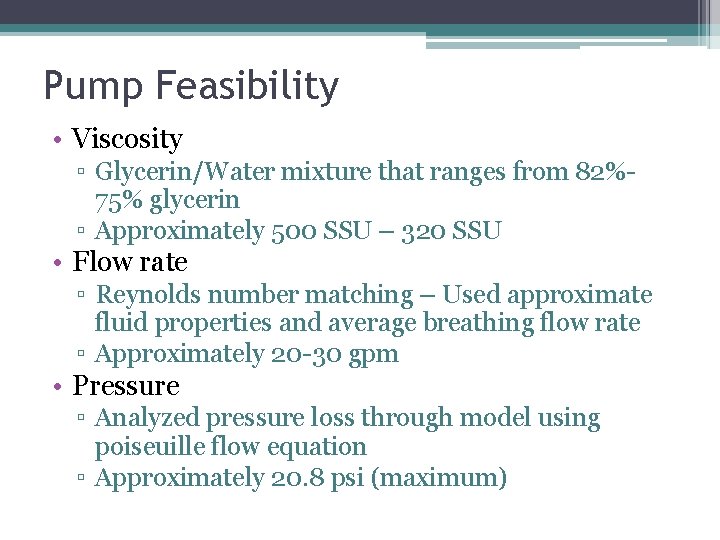

Pump Feasibility • Viscosity ▫ Glycerin/Water mixture that ranges from 82%75% glycerin ▫ Approximately

Pump Feasibility • Viscosity ▫ Glycerin/Water mixture that ranges from 82%75% glycerin ▫ Approximately 500 SSU – 320 SSU • Flow rate ▫ Reynolds number matching – Used approximate fluid properties and average breathing flow rate ▫ Approximately 20 -30 gpm • Pressure ▫ Analyzed pressure loss through model using poiseuille flow equation ▫ Approximately 20. 8 psi (maximum)

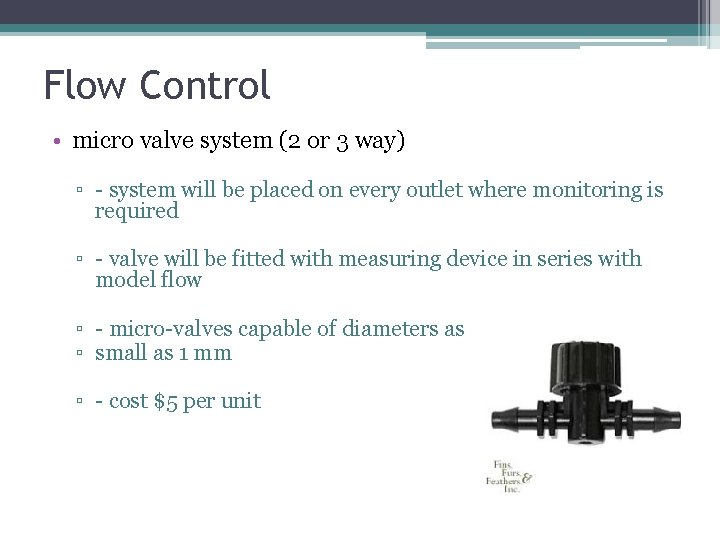

Flow Control • micro valve system (2 or 3 way) ▫ - system will

Flow Control • micro valve system (2 or 3 way) ▫ - system will be placed on every outlet where monitoring is required ▫ - valve will be fitted with measuring device in series with model flow ▫ - micro-valves capable of diameters as ▫ small as 1 mm ▫ - cost $5 per unit

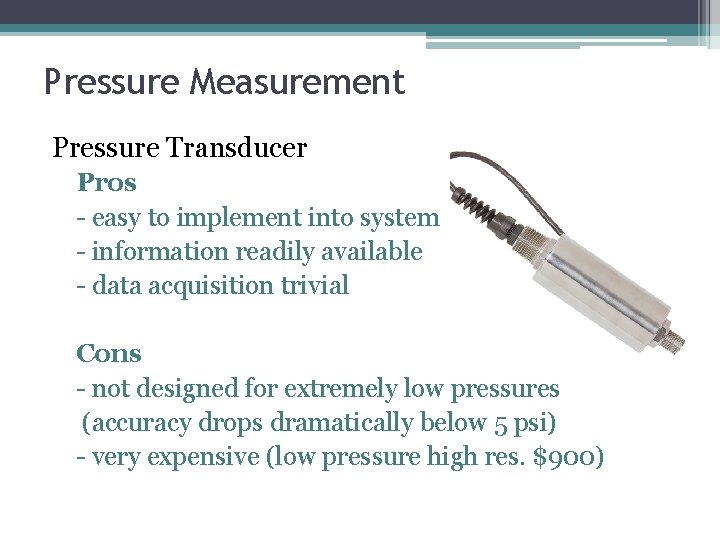

Pressure Measurement Pressure Transducer Pros - easy to implement into system - information readily

Pressure Measurement Pressure Transducer Pros - easy to implement into system - information readily available - data acquisition trivial Cons - not designed for extremely low pressures (accuracy drops dramatically below 5 psi) - very expensive (low pressure high res. $900)

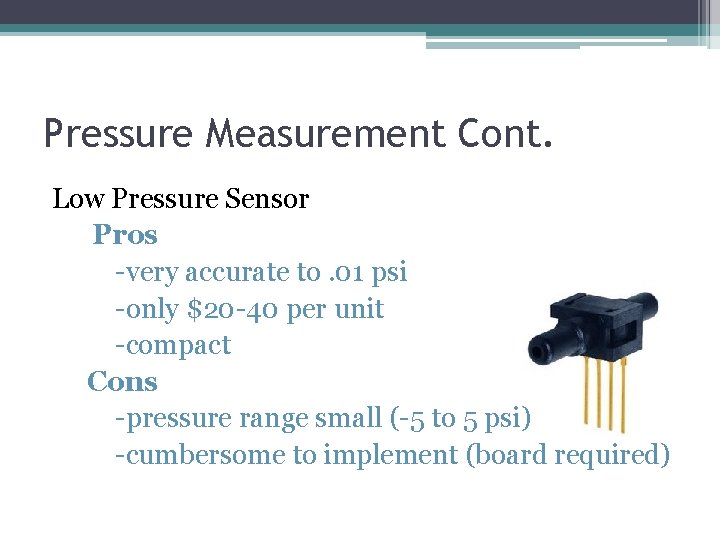

Pressure Measurement Cont. Low Pressure Sensor Pros -very accurate to. 01 psi -only $20

Pressure Measurement Cont. Low Pressure Sensor Pros -very accurate to. 01 psi -only $20 -40 per unit -compact Cons -pressure range small (-5 to 5 psi) -cumbersome to implement (board required)

Digital Input to Labview • NI USB-6008 ▫ Cost: $169 ▫ Easily interfaces with

Digital Input to Labview • NI USB-6008 ▫ Cost: $169 ▫ Easily interfaces with Labview ▫ High Sample Rate (10 k S/s)

Labview Code • Not fully completed ▫ Need all components before testing and construction

Labview Code • Not fully completed ▫ Need all components before testing and construction can occur.

System Overview

System Overview

Effect Cannot assemble test rig Cause Model is sent too late 2 Importance 1

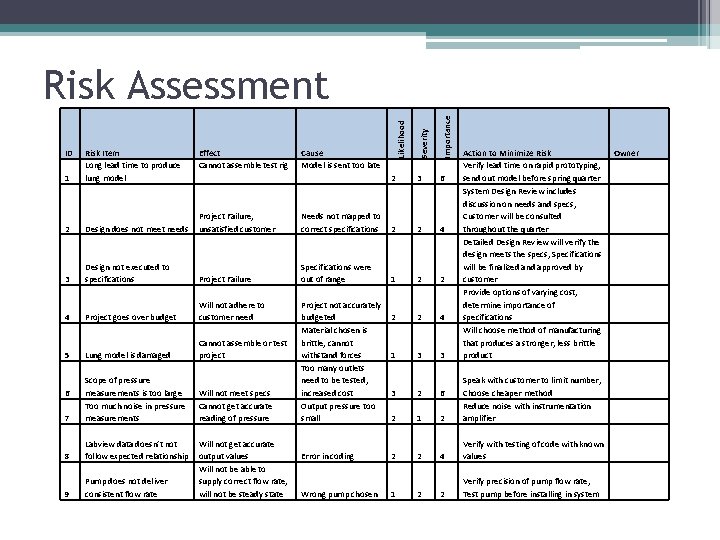

Effect Cannot assemble test rig Cause Model is sent too late 2 Importance 1 Risk Item Long lead time to produce lung model Severity ID Likelihood Risk Assessment 3 6 Action to Minimize Risk Verify lead time on rapid prototyping, send out model before spring quarter System Design Review includes discussion on needs and specs, Customer will be consulted throughout the quarter Detailed Design Review will verify the design meets the specs, Specifications will be finalized and approved by customer Provide options of varying cost, determine importance of specifications Will choose method of manufacturing that produces a stronger, less brittle product 2 Design does not meet needs Project Failure, unsatisfied customer Needs not mapped to correct specifications 2 2 4 3 Design not executed to specifications Project Failure Specifications were out of range 1 2 2 4 Project goes over budget Will not adhere to customer need 2 2 4 5 Lung model is damaged Cannot assemble or test project 1 3 3 Will not meet specs Cannot get accurate reading of pressure 3 2 6 7 Scope of pressure measurements is too large Too much noise in pressure measurements 2 1 2 Speak with customer to limit number, Choose cheaper method Reduce noise with instrumentation amplifier 8 Labview data doesn’t not follow expected relationship Error in coding 2 2 4 Verify with testing of code with known values 9 Pump does not deliver consistent flow rate Wrong pump chosen 1 2 2 Verify precision of pump flow rate, Test pump before installing in system 6 Will not get accurate output values Will not be able to supply correct flow rate, will not be steady state Project not accurately budgeted Material chosen is brittle, cannot withstand forces Too many outlets need to be tested, increased cost Output pressure too small Owner

Project Planning • Microsoft Project used to determine slack in tasks as well as

Project Planning • Microsoft Project used to determine slack in tasks as well as critical path by determining predecessors and estimated duration of tasks.

Roles and Responsibilities • Kristin Roberts – ME, Project Leader ▫ Project Organization ▫

Roles and Responsibilities • Kristin Roberts – ME, Project Leader ▫ Project Organization ▫ Fluid Mechanics • Ryan Mark - ME ▫ Pressure sensing and Control ▫ Rapid Prototyping ▫ Data Acquisition • Morgan De. Luca – ME ▫ Pump Design ▫ Fluid Mechanics

Roles and Responsibilities cont’d • Jimmy Moore - CE ▫ Camera & Model Positioning

Roles and Responsibilities cont’d • Jimmy Moore - CE ▫ Camera & Model Positioning ▫ Controls Design • Brad Demarest - EE ▫ Data Acquisition ▫ Prototype Material Choice • Jake Snider - ISE ▫ Project Planning ▫ Labview Design
