S/W Project Management Software Project Planning (POMA) Task Analysis

S/W Project Management Software Project Planning (POMA) Task Analysis

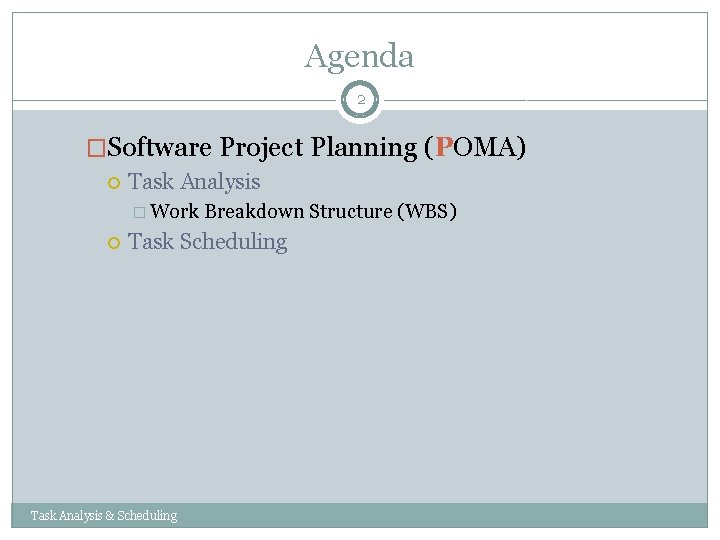

Agenda 2 �Software Project Planning (POMA) Task Analysis � Work Breakdown Structure (WBS) Task

Agenda 2 �Software Project Planning (POMA) Task Analysis � Work Breakdown Structure (WBS) Task Scheduling Task Analysis & Scheduling

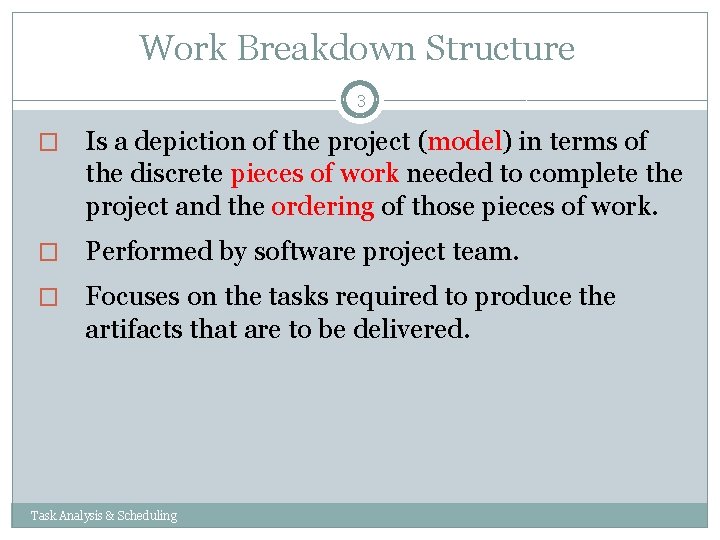

Work Breakdown Structure 3 � Is a depiction of the project (model) in terms

Work Breakdown Structure 3 � Is a depiction of the project (model) in terms of the discrete pieces of work needed to complete the project and the ordering of those pieces of work. � Performed by software project team. � Focuses on the tasks required to produce the artifacts that are to be delivered. Task Analysis & Scheduling

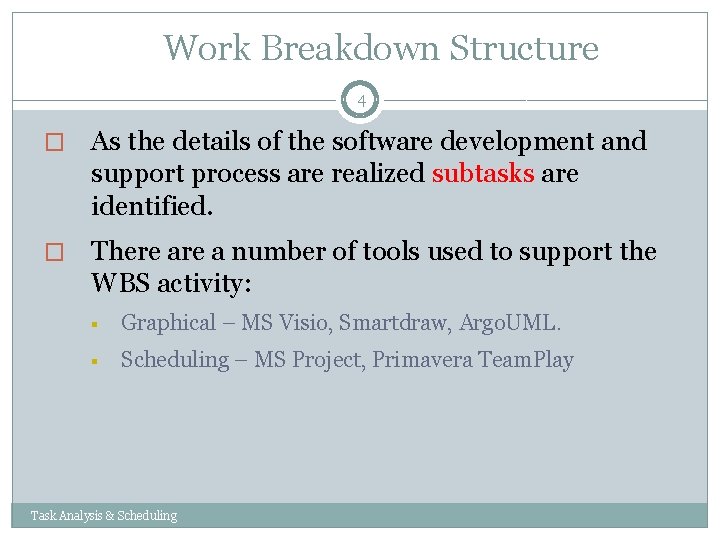

Work Breakdown Structure 4 � As the details of the software development and support

Work Breakdown Structure 4 � As the details of the software development and support process are realized subtasks are identified. � There a number of tools used to support the WBS activity: § Graphical – MS Visio, Smartdraw, Argo. UML. § Scheduling – MS Project, Primavera Team. Play Task Analysis & Scheduling

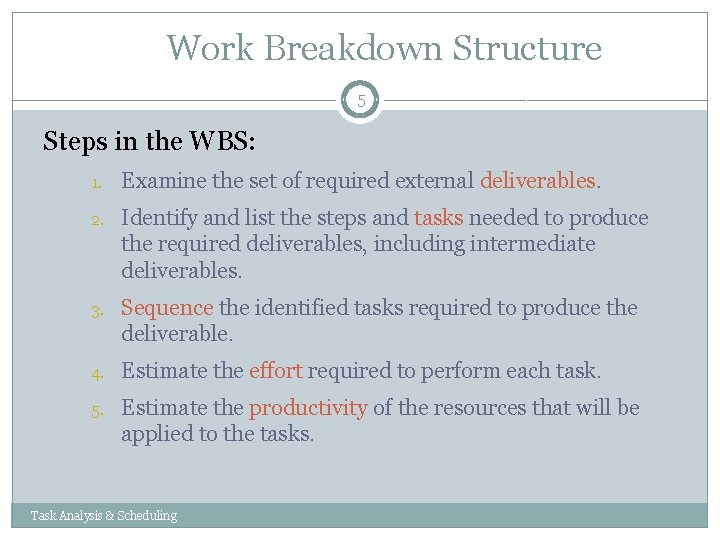

Work Breakdown Structure 5 Steps in the WBS: 1. Examine the set of required

Work Breakdown Structure 5 Steps in the WBS: 1. Examine the set of required external deliverables. 2. Identify and list the steps and tasks needed to produce the required deliverables, including intermediate deliverables. 3. Sequence the identified tasks required to produce the deliverable. 4. Estimate the effort required to perform each task. 5. Estimate the productivity of the resources that will be applied to the tasks. Task Analysis & Scheduling

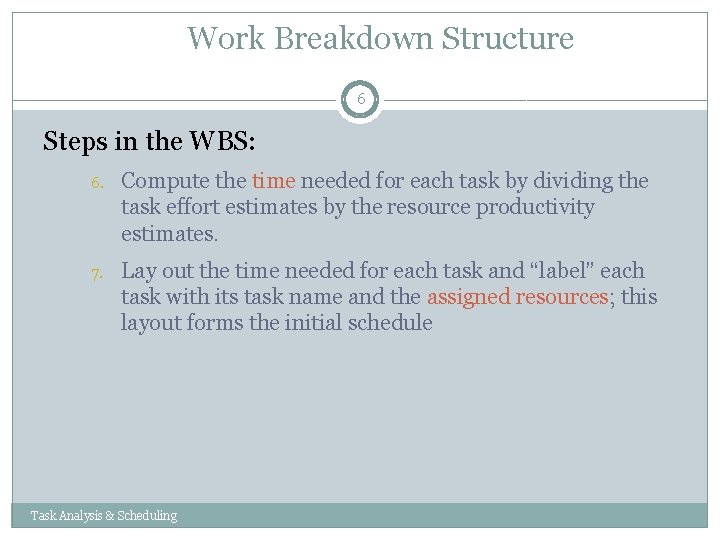

Work Breakdown Structure 6 Steps in the WBS: 6. Compute the time needed for

Work Breakdown Structure 6 Steps in the WBS: 6. Compute the time needed for each task by dividing the task effort estimates by the resource productivity estimates. 7. Lay out the time needed for each task and “label” each task with its task name and the assigned resources; this layout forms the initial schedule Task Analysis & Scheduling

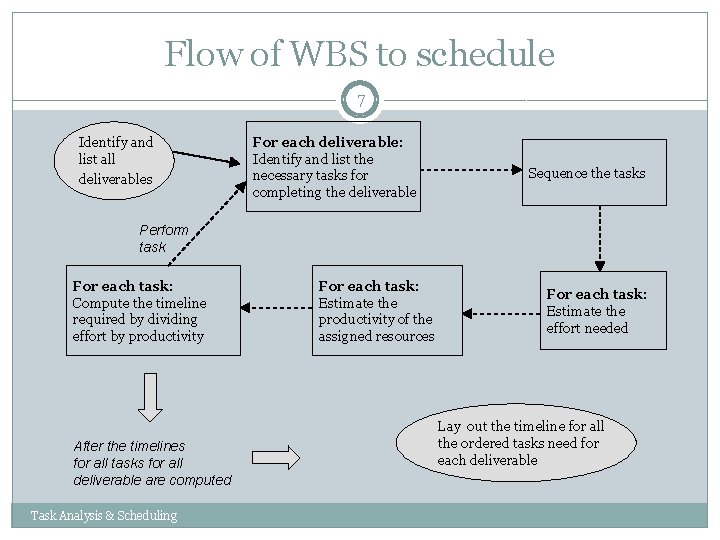

Flow of WBS to schedule 7 Identify and list all deliverables For each deliverable:

Flow of WBS to schedule 7 Identify and list all deliverables For each deliverable: Identify and list the necessary tasks for completing the deliverable Sequence the tasks Perform task For each task: Compute the timeline required by dividing effort by productivity After the timelines for all tasks for all deliverable are computed Task Analysis & Scheduling For each task: Estimate the productivity of the assigned resources For each task: Estimate the effort needed Lay out the timeline for all the ordered tasks need for each deliverable

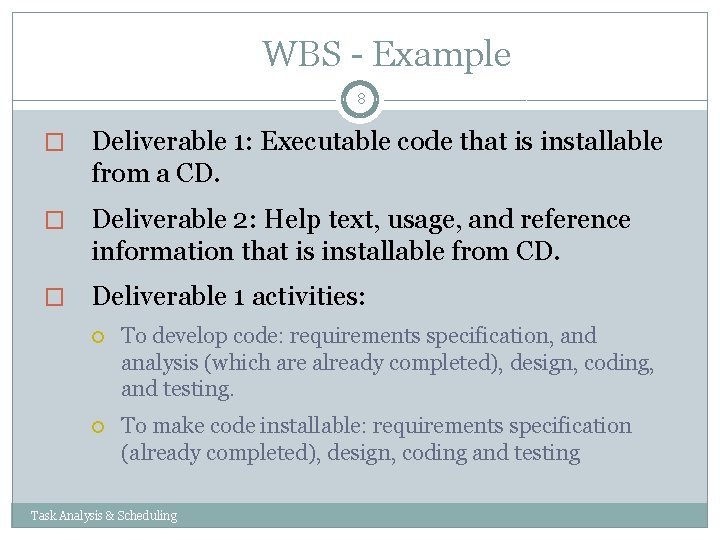

WBS - Example 8 � Deliverable 1: Executable code that is installable from a

WBS - Example 8 � Deliverable 1: Executable code that is installable from a CD. � Deliverable 2: Help text, usage, and reference information that is installable from CD. � Deliverable 1 activities: To develop code: requirements specification, and analysis (which are already completed), design, coding, and testing. To make code installable: requirements specification (already completed), design, coding and testing Task Analysis & Scheduling

WBS - Example 9 � Deliverable 2 activities: Creating help text: requirements specification and

WBS - Example 9 � Deliverable 2 activities: Creating help text: requirements specification and analysis (already completed), design, writing, and testing. Developing usage and reference information: requirements specification and analysis (already completed), design, writing, and testing. Task Analysis & Scheduling

WBS - Example 10 � � Choice of activities and sequence depends on: 1.

WBS - Example 10 � � Choice of activities and sequence depends on: 1. The size and complexity of both the problem and the solution, 2. The process and methodology that the software organization has defined and trained its people to follow, and agreed with its client to use. Sequencing the activities needed for the development of the artifacts can be a large problem for new software organizations. Task Analysis & Scheduling

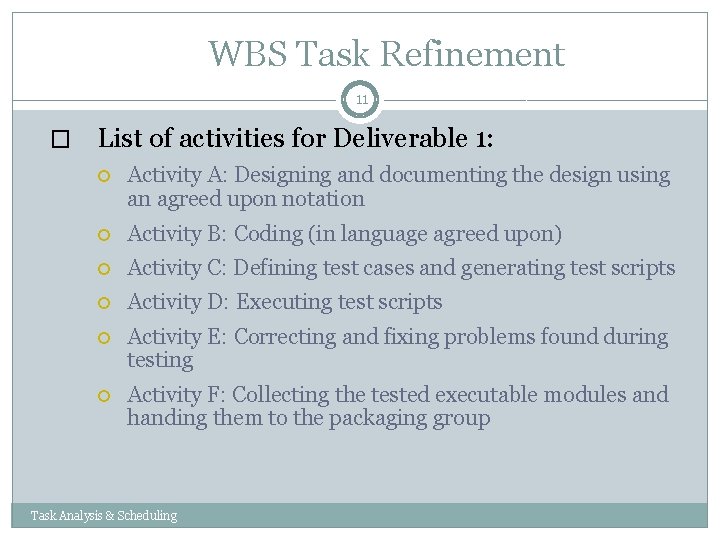

WBS Task Refinement 11 � List of activities for Deliverable 1: Activity A: Designing

WBS Task Refinement 11 � List of activities for Deliverable 1: Activity A: Designing and documenting the design using an agreed upon notation Activity B: Coding (in language agreed upon) Activity C: Defining test cases and generating test scripts Activity D: Executing test scripts Activity E: Correcting and fixing problems found during testing Activity F: Collecting the tested executable modules and handing them to the packaging group Task Analysis & Scheduling

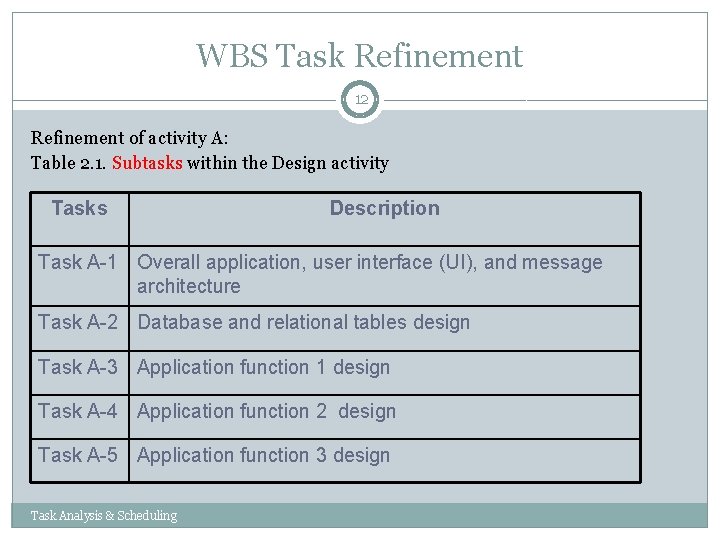

WBS Task Refinement 12 Refinement of activity A: Table 2. 1. Subtasks within the

WBS Task Refinement 12 Refinement of activity A: Table 2. 1. Subtasks within the Design activity Tasks Description Task A-1 Overall application, user interface (UI), and message architecture Task A-2 Database and relational tables design Task A-3 Application function 1 design Task A-4 Application function 2 design Task A-5 Application function 3 design Task Analysis & Scheduling

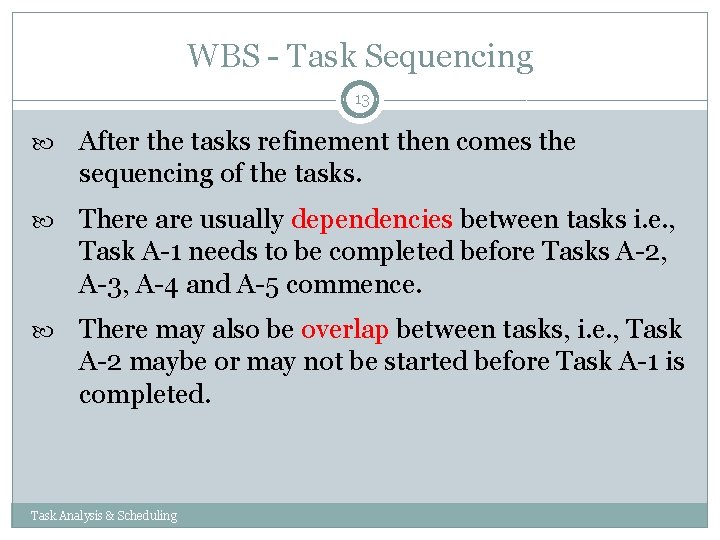

WBS - Task Sequencing 13 After the tasks refinement then comes the sequencing of

WBS - Task Sequencing 13 After the tasks refinement then comes the sequencing of the tasks. There are usually dependencies between tasks i. e. , Task A-1 needs to be completed before Tasks A-2, A-3, A-4 and A-5 commence. There may also be overlap between tasks, i. e. , Task A-2 maybe or may not be started before Task A-1 is completed. Task Analysis & Scheduling

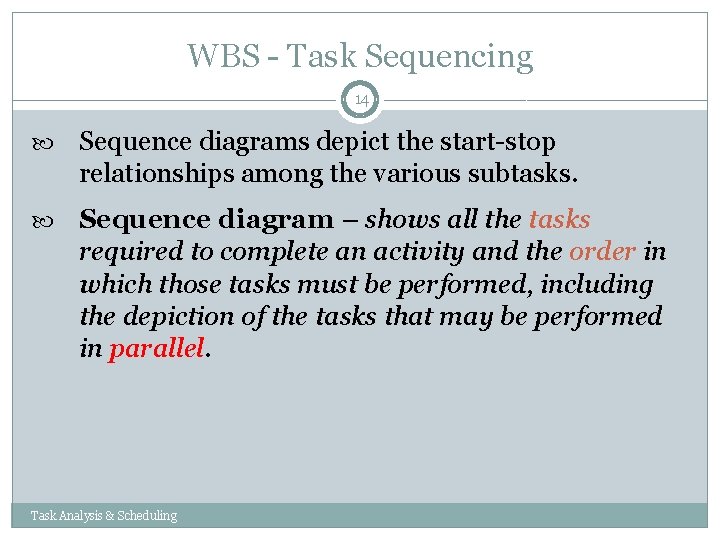

WBS - Task Sequencing 14 Sequence diagrams depict the start-stop relationships among the various

WBS - Task Sequencing 14 Sequence diagrams depict the start-stop relationships among the various subtasks. Sequence diagram – shows all the tasks required to complete an activity and the order in which those tasks must be performed, including the depiction of the tasks that may be performed in parallel. Task Analysis & Scheduling

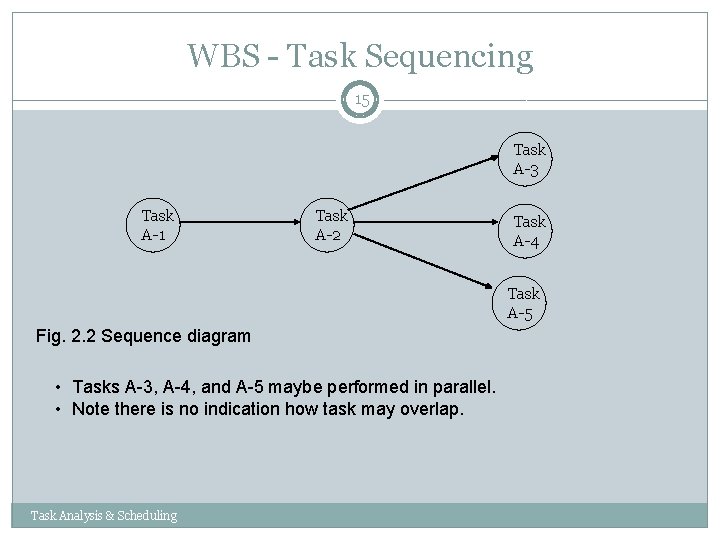

WBS - Task Sequencing 15 Task A-3 Task A-1 Task A-2 Task A-4 Task

WBS - Task Sequencing 15 Task A-3 Task A-1 Task A-2 Task A-4 Task A-5 Fig. 2. 2 Sequence diagram • Tasks A-3, A-4, and A-5 maybe performed in parallel. • Note there is no indication how task may overlap. Task Analysis & Scheduling

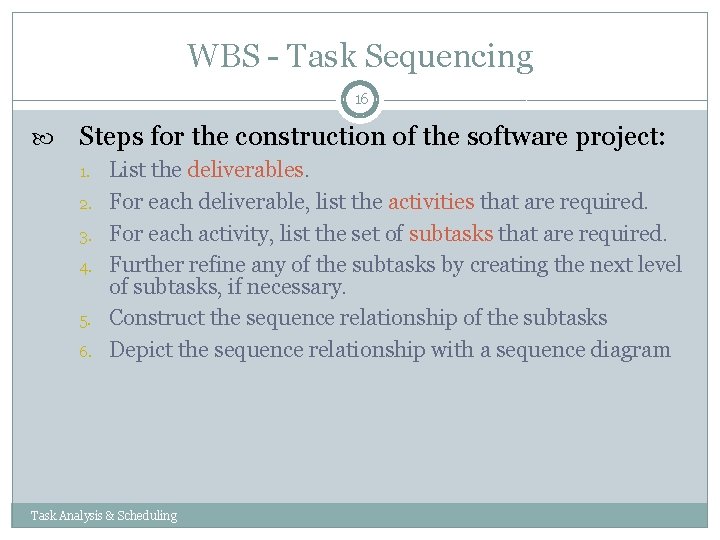

WBS - Task Sequencing 16 Steps for the construction of the software project: 1.

WBS - Task Sequencing 16 Steps for the construction of the software project: 1. 2. 3. 4. 5. 6. List the deliverables. For each deliverable, list the activities that are required. For each activity, list the set of subtasks that are required. Further refine any of the subtasks by creating the next level of subtasks, if necessary. Construct the sequence relationship of the subtasks Depict the sequence relationship with a sequence diagram Task Analysis & Scheduling

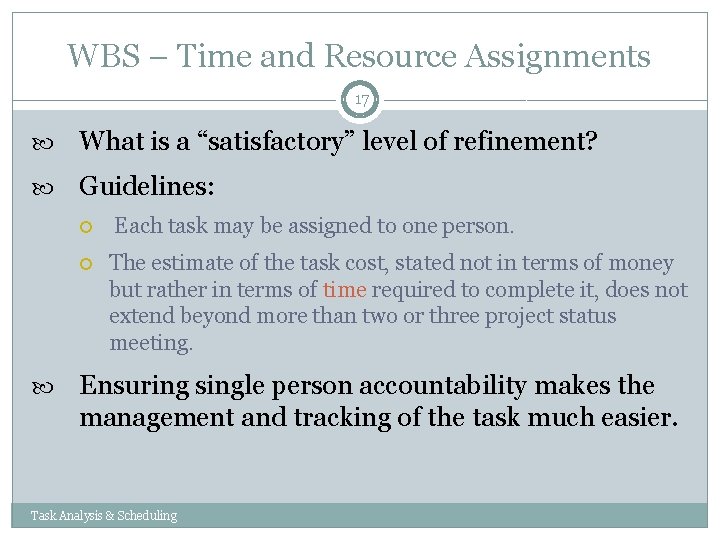

WBS – Time and Resource Assignments 17 What is a “satisfactory” level of refinement?

WBS – Time and Resource Assignments 17 What is a “satisfactory” level of refinement? Guidelines: Each task may be assigned to one person. The estimate of the task cost, stated not in terms of money but rather in terms of time required to complete it, does not extend beyond more than two or three project status meeting. Ensuring single person accountability makes the management and tracking of the task much easier. Task Analysis & Scheduling

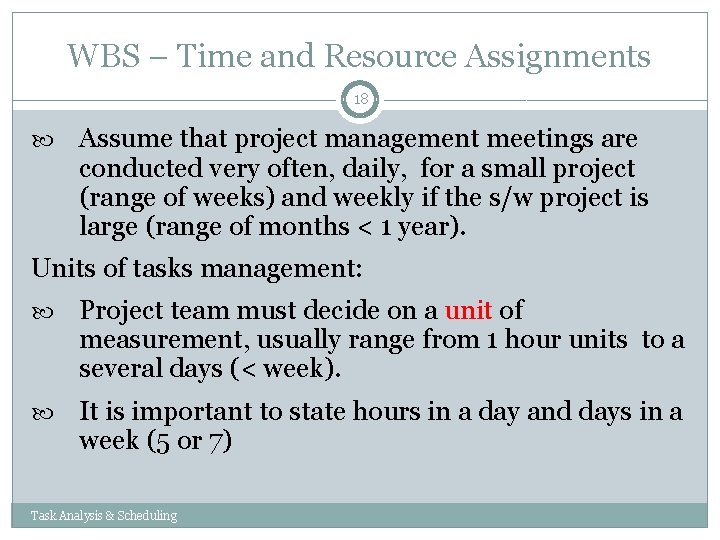

WBS – Time and Resource Assignments 18 Assume that project management meetings are conducted

WBS – Time and Resource Assignments 18 Assume that project management meetings are conducted very often, daily, for a small project (range of weeks) and weekly if the s/w project is large (range of months < 1 year). Units of tasks management: Project team must decide on a unit of measurement, usually range from 1 hour units to a several days (< week). It is important to state hours in a day and days in a week (5 or 7) Task Analysis & Scheduling

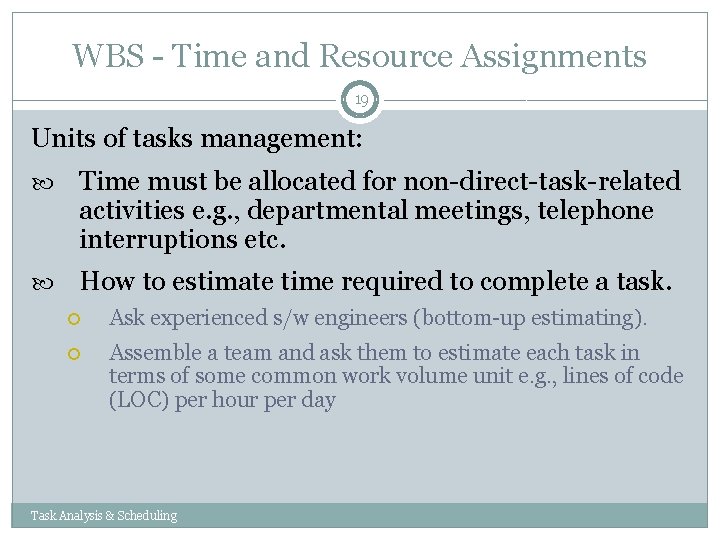

WBS - Time and Resource Assignments 19 Units of tasks management: Time must be

WBS - Time and Resource Assignments 19 Units of tasks management: Time must be allocated for non-direct-task-related activities e. g. , departmental meetings, telephone interruptions etc. How to estimate time required to complete a task. Ask experienced s/w engineers (bottom-up estimating). Assemble a team and ask them to estimate each task in terms of some common work volume unit e. g. , lines of code (LOC) per hour per day Task Analysis & Scheduling

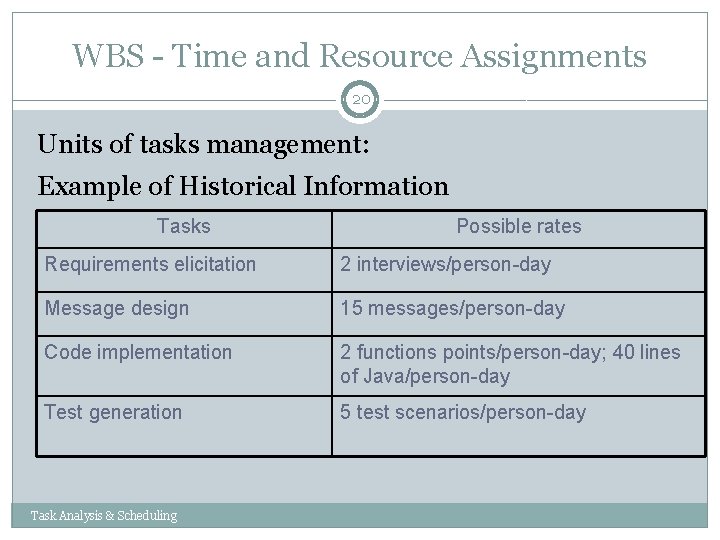

WBS - Time and Resource Assignments 20 Units of tasks management: Example of Historical

WBS - Time and Resource Assignments 20 Units of tasks management: Example of Historical Information Tasks Possible rates Requirements elicitation 2 interviews/person-day Message design 15 messages/person-day Code implementation 2 functions points/person-day; 40 lines of Java/person-day Test generation 5 test scenarios/person-day Task Analysis & Scheduling

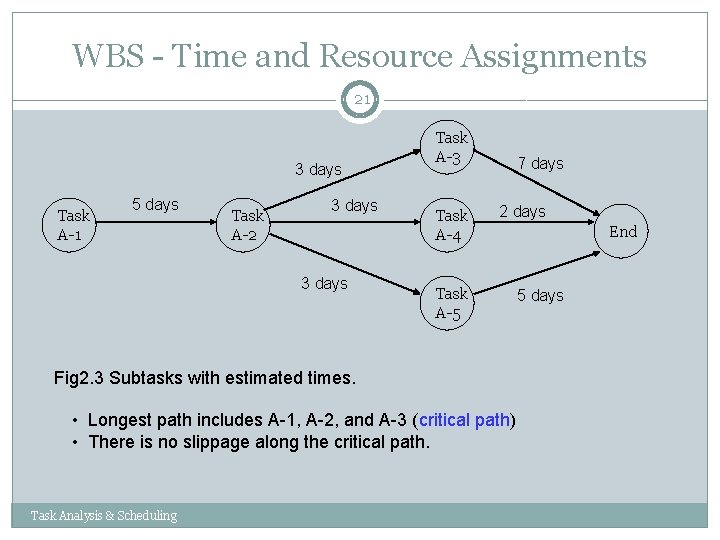

WBS - Time and Resource Assignments 21 3 days Task A-1 5 days Task

WBS - Time and Resource Assignments 21 3 days Task A-1 5 days Task A-2 3 days Task A-3 Task A-4 7 days 2 days Task A-5 Fig 2. 3 Subtasks with estimated times. • Longest path includes A-1, A-2, and A-3 (critical path) • There is no slippage along the critical path. Task Analysis & Scheduling End 5 days

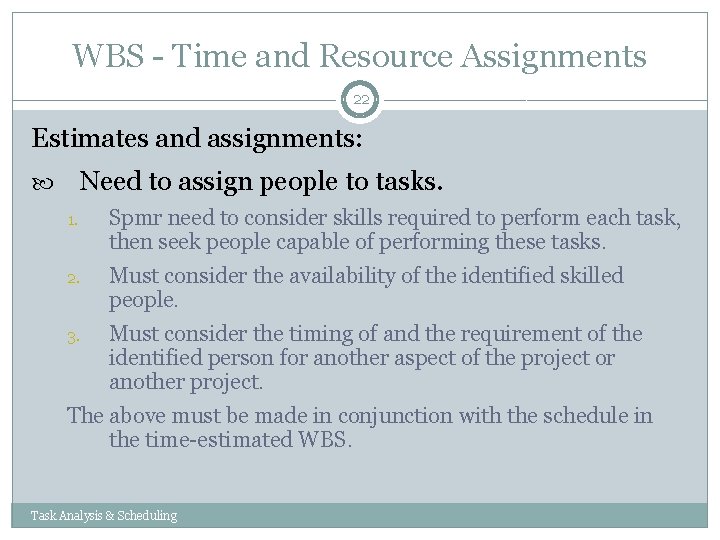

WBS - Time and Resource Assignments 22 Estimates and assignments: Need to assign people

WBS - Time and Resource Assignments 22 Estimates and assignments: Need to assign people to tasks. 1. Spmr need to consider skills required to perform each task, then seek people capable of performing these tasks. 2. Must consider the availability of the identified skilled people. 3. Must consider the timing of and the requirement of the identified person for another aspect of the project or another project. The above must be made in conjunction with the schedule in the time-estimated WBS. Task Analysis & Scheduling

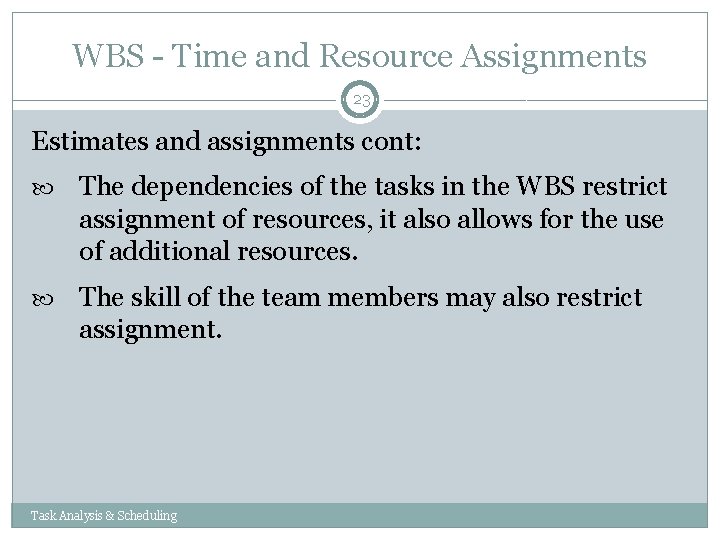

WBS - Time and Resource Assignments 23 Estimates and assignments cont: The dependencies of

WBS - Time and Resource Assignments 23 Estimates and assignments cont: The dependencies of the tasks in the WBS restrict assignment of resources, it also allows for the use of additional resources. The skill of the team members may also restrict assignment. Task Analysis & Scheduling

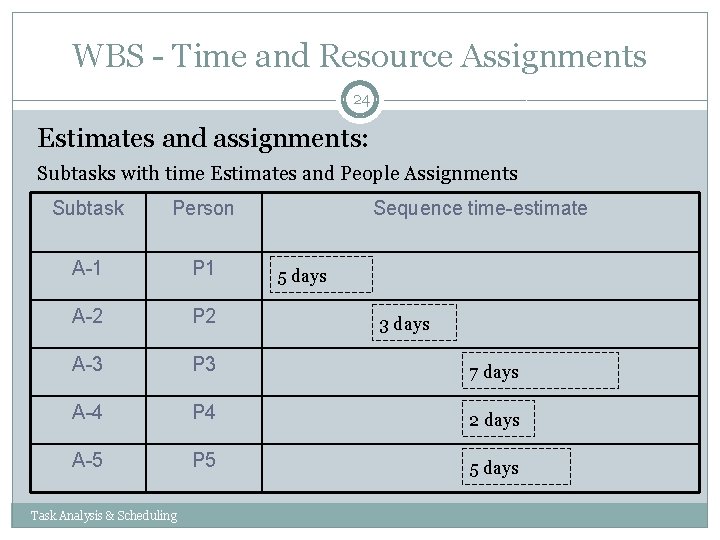

WBS - Time and Resource Assignments 24 Estimates and assignments: Subtasks with time Estimates

WBS - Time and Resource Assignments 24 Estimates and assignments: Subtasks with time Estimates and People Assignments Subtask Person A-1 P 1 A-2 P 2 A-3 P 3 7 days A-4 P 4 2 days A-5 P 5 5 days Task Analysis & Scheduling Sequence time-estimate 5 days 3 days

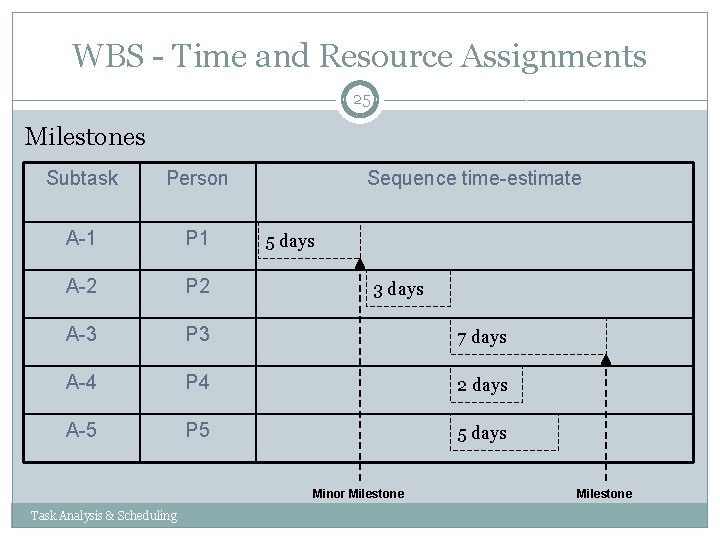

WBS - Time and Resource Assignments 25 Milestones Subtask Person Sequence time-estimate A-1 P

WBS - Time and Resource Assignments 25 Milestones Subtask Person Sequence time-estimate A-1 P 1 A-2 P 2 A-3 P 3 7 days A-4 P 4 2 days A-5 P 5 5 days 3 days Minor Milestone Task Analysis & Scheduling Milestone

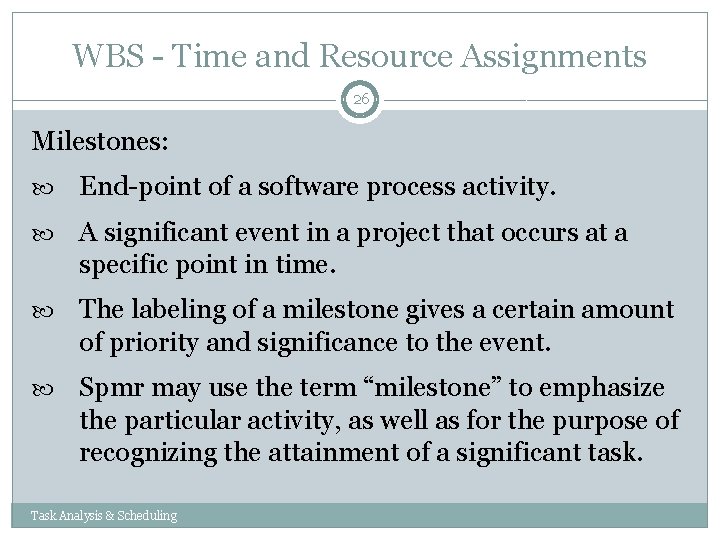

WBS - Time and Resource Assignments 26 Milestones: End-point of a software process activity.

WBS - Time and Resource Assignments 26 Milestones: End-point of a software process activity. A significant event in a project that occurs at a specific point in time. The labeling of a milestone gives a certain amount of priority and significance to the event. Spmr may use the term “milestone” to emphasize the particular activity, as well as for the purpose of recognizing the attainment of a significant task. Task Analysis & Scheduling

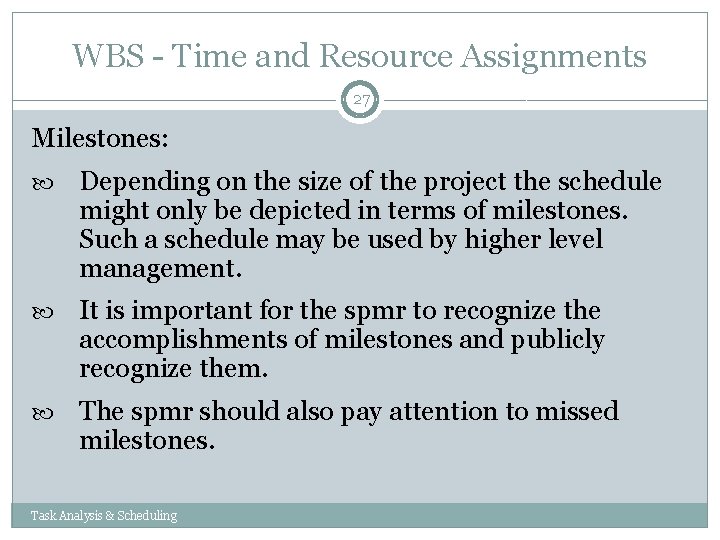

WBS - Time and Resource Assignments 27 Milestones: Depending on the size of the

WBS - Time and Resource Assignments 27 Milestones: Depending on the size of the project the schedule might only be depicted in terms of milestones. Such a schedule may be used by higher level management. It is important for the spmr to recognize the accomplishments of milestones and publicly recognize them. The spmr should also pay attention to missed milestones. Task Analysis & Scheduling

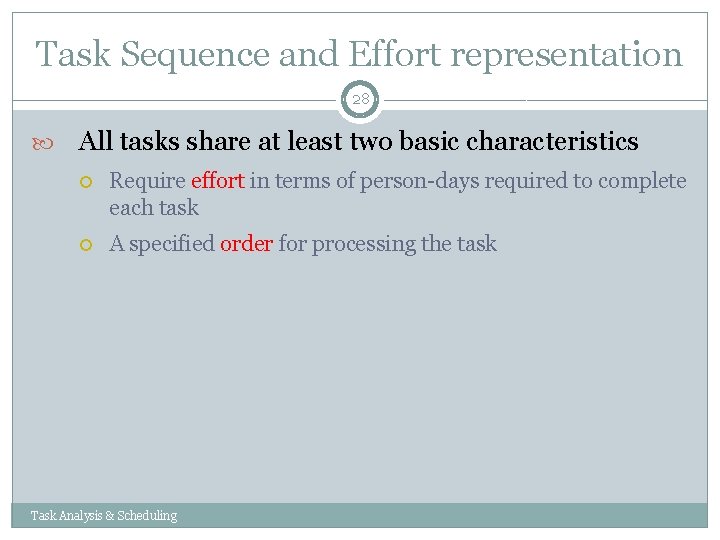

Task Sequence and Effort representation 28 All tasks share at least two basic characteristics

Task Sequence and Effort representation 28 All tasks share at least two basic characteristics Require effort in terms of person-days required to complete each task A specified order for processing the task Task Analysis & Scheduling

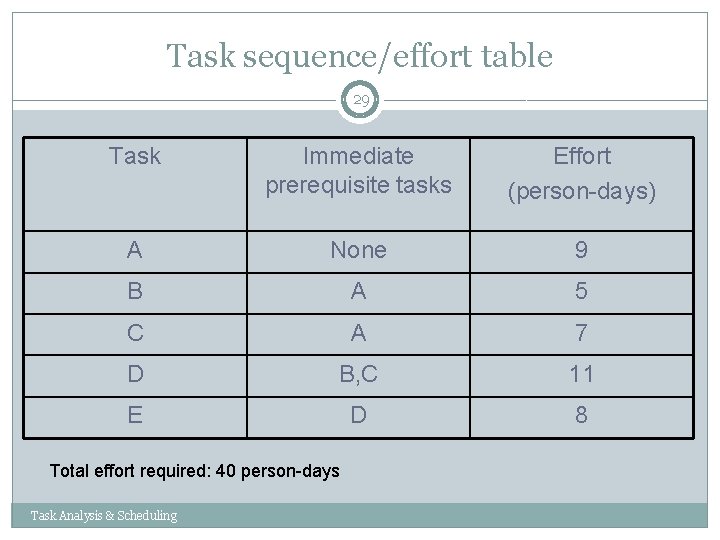

Task sequence/effort table 29 Task Immediate prerequisite tasks Effort (person-days) A None 9 B

Task sequence/effort table 29 Task Immediate prerequisite tasks Effort (person-days) A None 9 B A 5 C A 7 D B, C 11 E D 8 Total effort required: 40 person-days Task Analysis & Scheduling

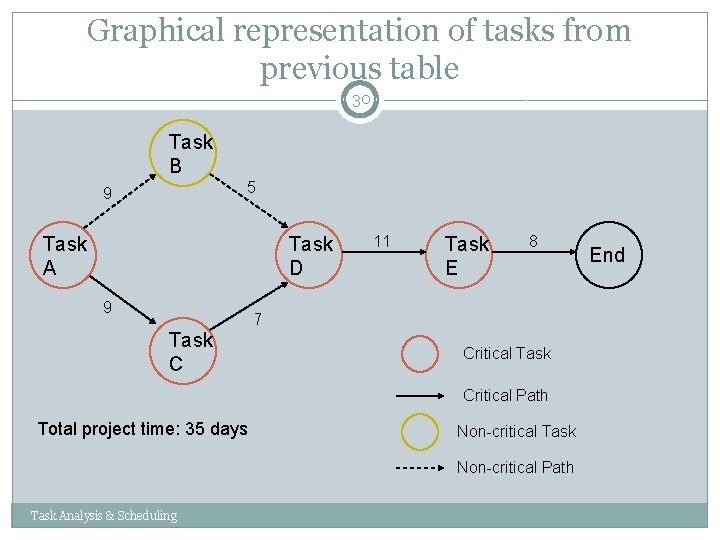

Graphical representation of tasks from previous table 30 Task B 5 9 Task A

Graphical representation of tasks from previous table 30 Task B 5 9 Task A Task D 9 11 Task E 8 7 Task C Critical Task Critical Path Total project time: 35 days Non-critical Task Non-critical Path Task Analysis & Scheduling End

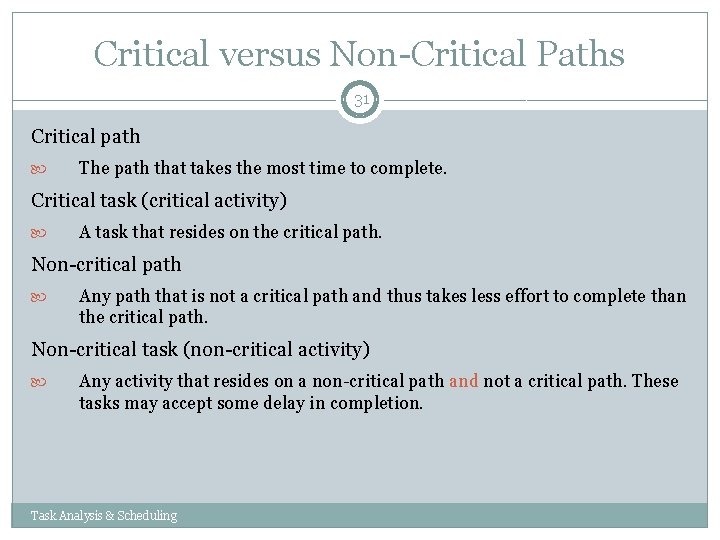

Critical versus Non-Critical Paths 31 Critical path The path that takes the most time

Critical versus Non-Critical Paths 31 Critical path The path that takes the most time to complete. Critical task (critical activity) A task that resides on the critical path. Non-critical path Any path that is not a critical path and thus takes less effort to complete than the critical path. Non-critical task (non-critical activity) Any activity that resides on a non-critical path and not a critical path. These tasks may accept some delay in completion. Task Analysis & Scheduling

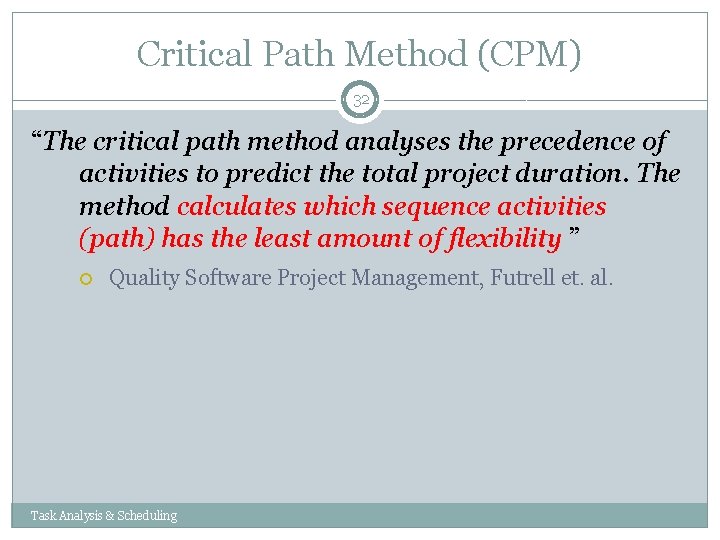

Critical Path Method (CPM) 32 “The critical path method analyses the precedence of activities

Critical Path Method (CPM) 32 “The critical path method analyses the precedence of activities to predict the total project duration. The method calculates which sequence activities (path) has the least amount of flexibility ” Quality Software Project Management, Futrell et. al. Task Analysis & Scheduling

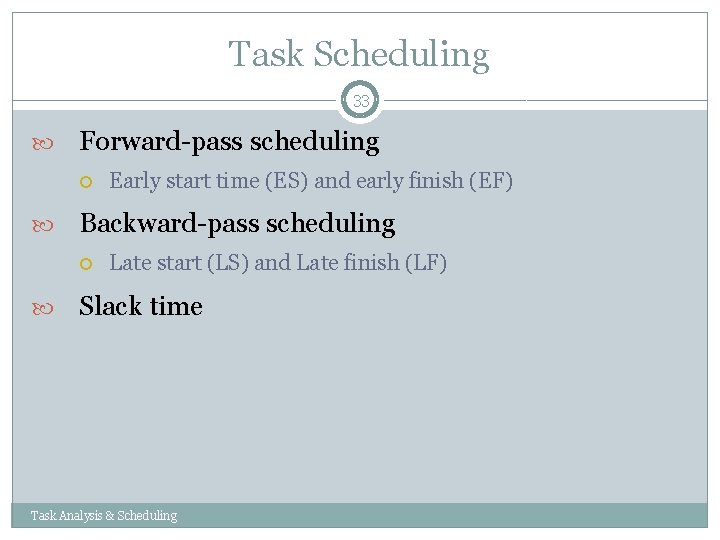

Task Scheduling 33 Forward-pass scheduling Backward-pass scheduling Early start time (ES) and early finish

Task Scheduling 33 Forward-pass scheduling Backward-pass scheduling Early start time (ES) and early finish (EF) Late start (LS) and Late finish (LF) Slack time Task Analysis & Scheduling

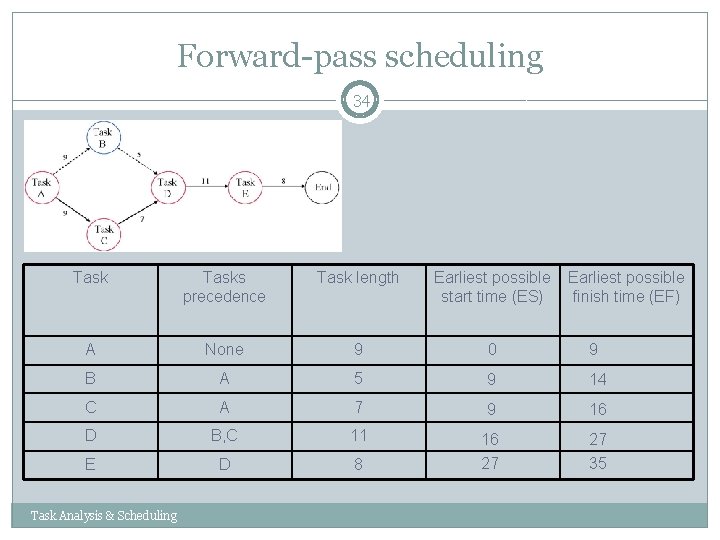

Forward-pass scheduling 34 Tasks precedence Task length Earliest possible start time (ES) A None

Forward-pass scheduling 34 Tasks precedence Task length Earliest possible start time (ES) A None 9 0 9 B A 5 9 14 C A 7 9 16 D B, C 11 E D 8 16 27 27 35 Task Analysis & Scheduling Earliest possible finish time (EF)

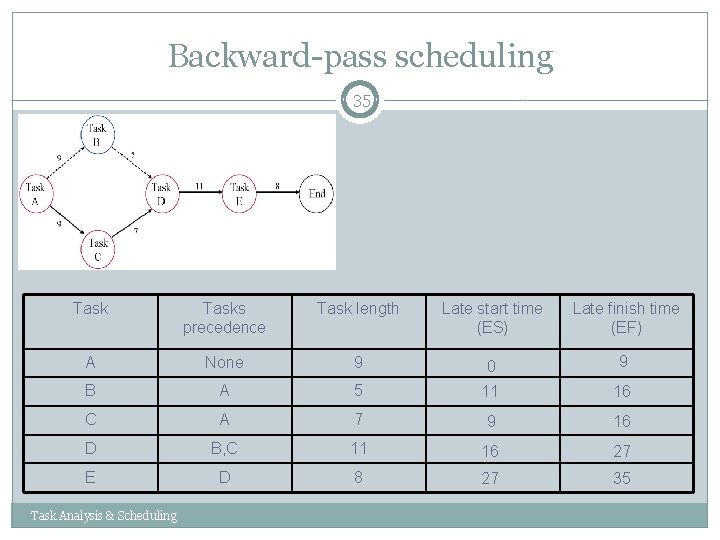

Backward-pass scheduling 35 Tasks precedence Task length Late start time (ES) Late finish time

Backward-pass scheduling 35 Tasks precedence Task length Late start time (ES) Late finish time (EF) A None 9 0 9 B A 5 11 16 C A 7 9 16 D B, C 11 16 27 E D 8 27 35 Task Analysis & Scheduling

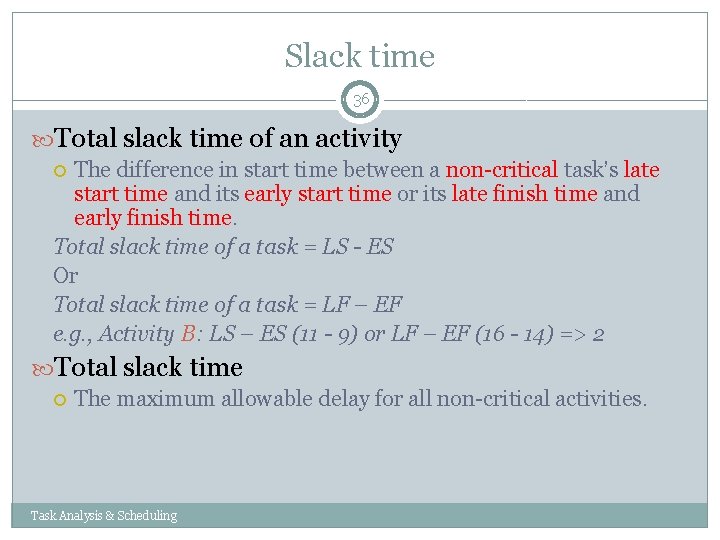

Slack time 36 Total slack time of an activity The difference in start time

Slack time 36 Total slack time of an activity The difference in start time between a non-critical task’s late start time and its early start time or its late finish time and early finish time. Total slack time of a task = LS - ES Or Total slack time of a task = LF – EF e. g. , Activity B: LS – ES (11 - 9) or LF – EF (16 - 14) => 2 Total slack time The maximum allowable delay for all non-critical activities. Task Analysis & Scheduling

Program Evaluation and Review Technique (PERT) 37 An estimating technique assumes each activity duration

Program Evaluation and Review Technique (PERT) 37 An estimating technique assumes each activity duration is subject to a range estimates uses weighting method to arrive at a specific duration. Task Analysis & Scheduling

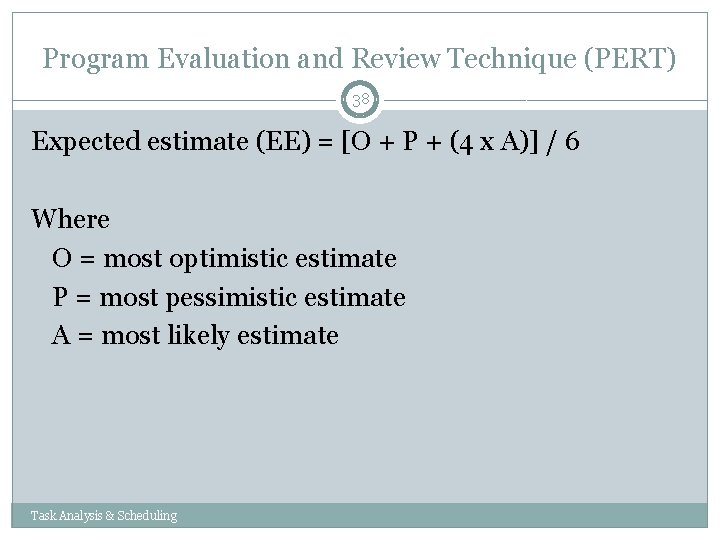

Program Evaluation and Review Technique (PERT) 38 Expected estimate (EE) = [O + P

Program Evaluation and Review Technique (PERT) 38 Expected estimate (EE) = [O + P + (4 x A)] / 6 Where O = most optimistic estimate P = most pessimistic estimate A = most likely estimate Task Analysis & Scheduling

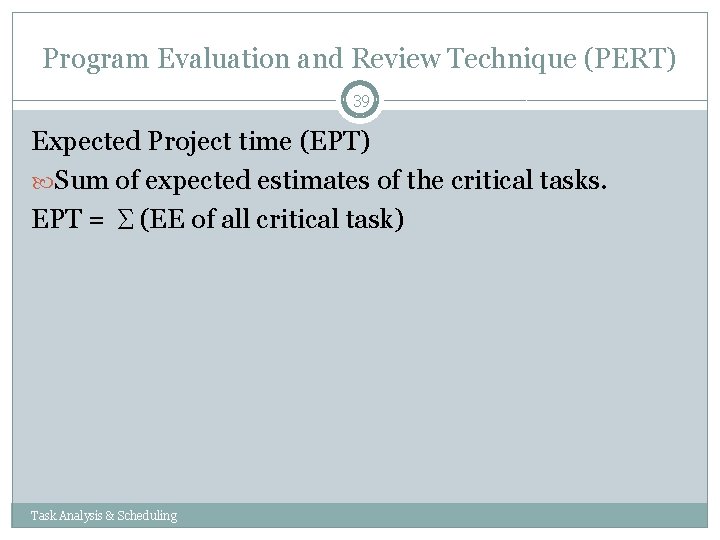

Program Evaluation and Review Technique (PERT) 39 Expected Project time (EPT) Sum of expected

Program Evaluation and Review Technique (PERT) 39 Expected Project time (EPT) Sum of expected estimates of the critical tasks. EPT = Σ(EE of all critical task) Task Analysis & Scheduling

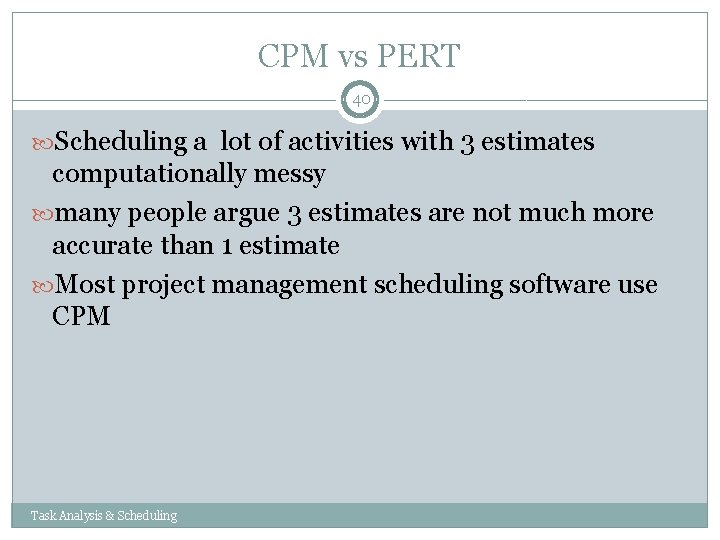

CPM vs PERT 40 Scheduling a lot of activities with 3 estimates computationally messy

CPM vs PERT 40 Scheduling a lot of activities with 3 estimates computationally messy many people argue 3 estimates are not much more accurate than 1 estimate Most project management scheduling software use CPM Task Analysis & Scheduling
