Suvarnabhumi Airport Development Operational Readiness Airport Transfer ORAT
Suvarnabhumi Airport Development Operational Readiness & Airport Transfer ( ORAT. II ) March. 30, 2004 KOICA (NESDB)
ORAT CONCEPT F Airport Transfer I S H Construction Phase Operation Phase

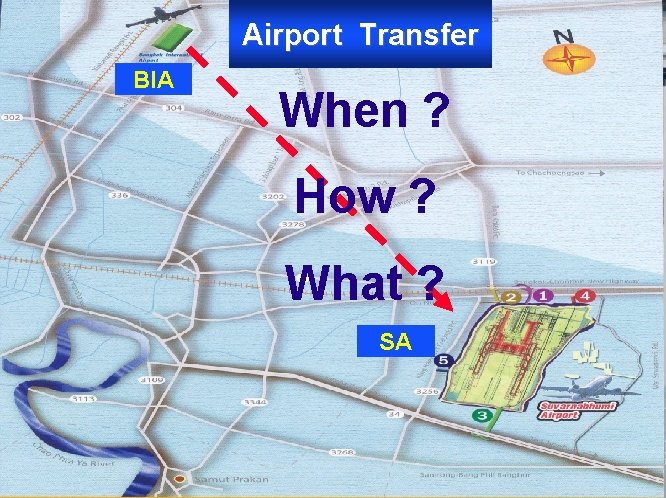

Airport Transfer BIA When ? How ? What ? SA
Airport Transfer Schedule Review 7 days

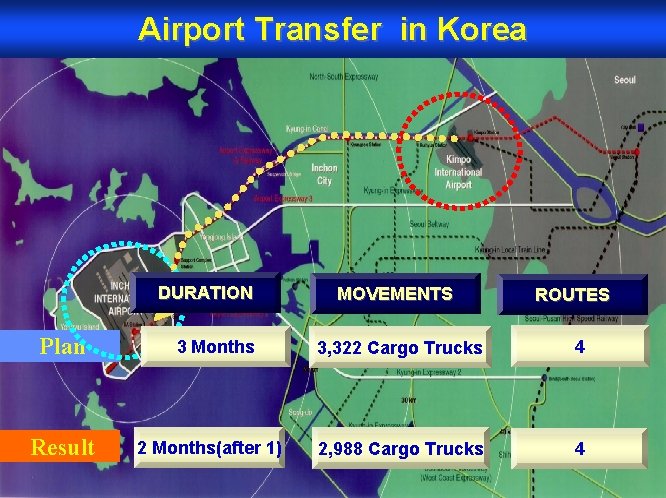

Airport Transfer in Korea DURATION Plan Result 3 Months 2 Months(after 1) MOVEMENTS ROUTES 3, 322 Cargo Trucks 4 2, 988 Cargo Trucks 4

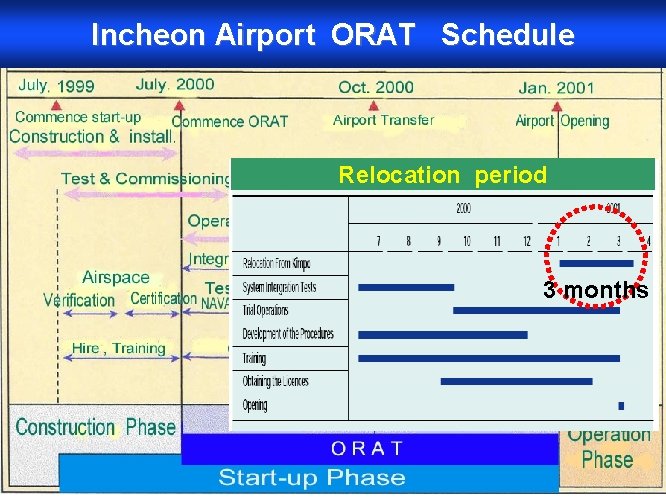

Incheon Airport ORAT Schedule Relocation period 3 months
Incheon Airport Transfer Phase
IIA Airport Transfer Outcome Airport Relocation Unit D-60 D-7 D-1 D+ Period Unit Sum Remark ~03/21 03/22~ 03/27 03/28 03/29~ 04/15 Sch 787 1, 143 1, 015 377 Act 409 1, 200 1, 076 303 Act/Sch 52% 105% 106% 80% Sch 787 1, 930 2, 945 3, 322 Act 409 1, 609 2, 685 2, 988 Act/Sch 52% 83% 91% 90% Include 37 Ferry Flight (About 200 Truck)

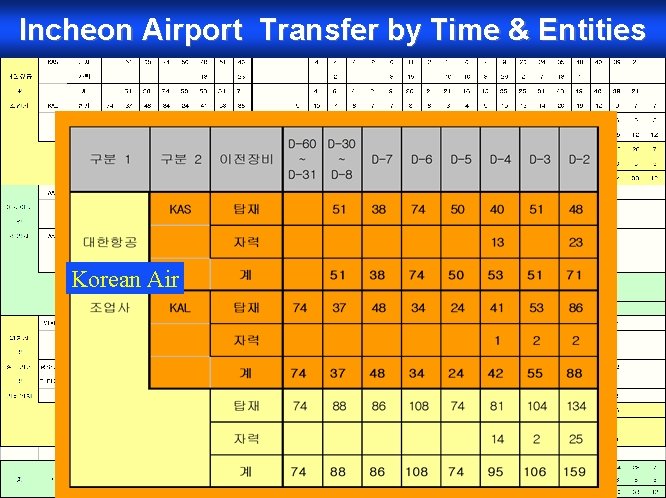

Incheon Airport Transfer by Time & Entities Korean Air
IIA Transfer Summary by Entities EQUIPMENT AIRLINERS GOV’T OTHERS MATERIALS
D-1 Transfer Summary
Total Transfer Summary Major-stage Pre-stage Intensive-stage Post-stage

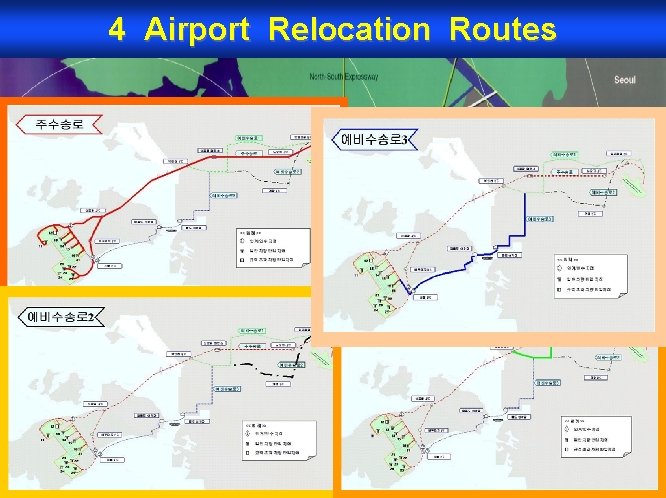

4 Airport Relocation Routes
Access Road for extra-heavy equipment special relocation route OVERWEIGHT: 26 UNITS OVERSIZE: 28 UNITS OTHER: 20 UNITS
Transfer Level and Control Process

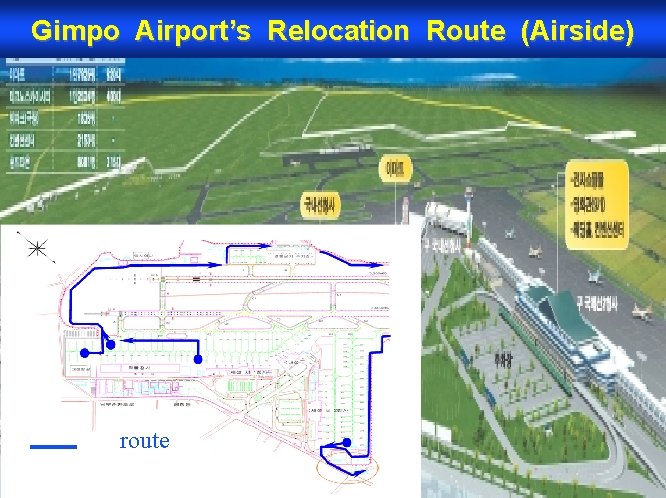

Gimpo Airport’s Relocation Route (Airside) route

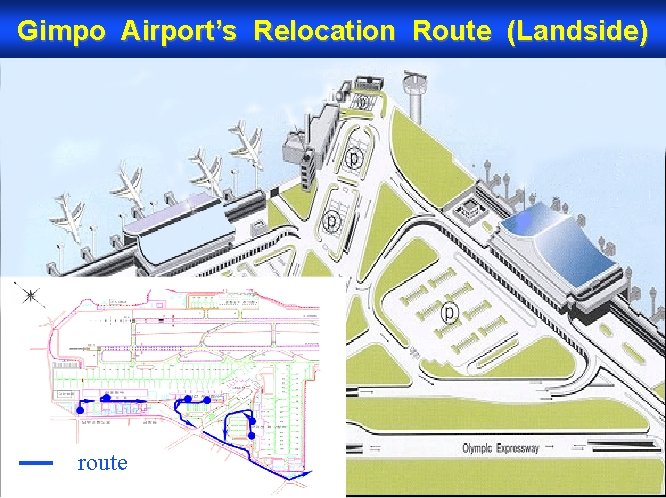

Gimpo Airport’s Relocation Route (Landside) route

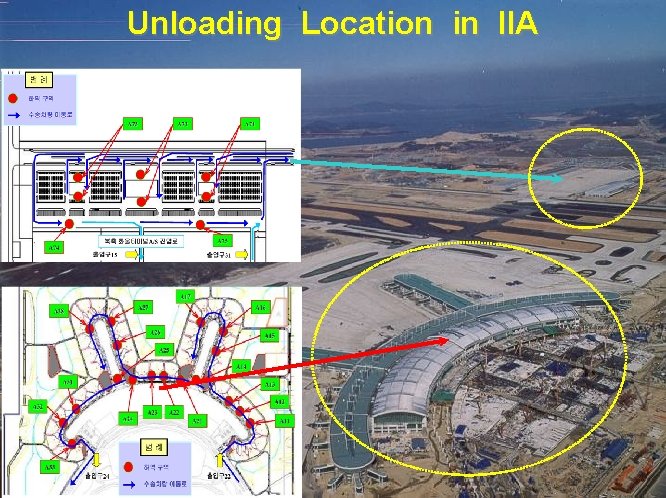

Unloading Location in IIA

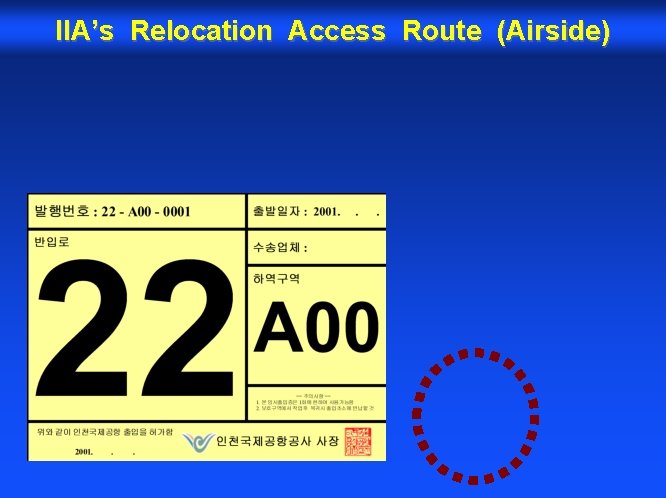

IIA’s Relocation Access Route (Airside)

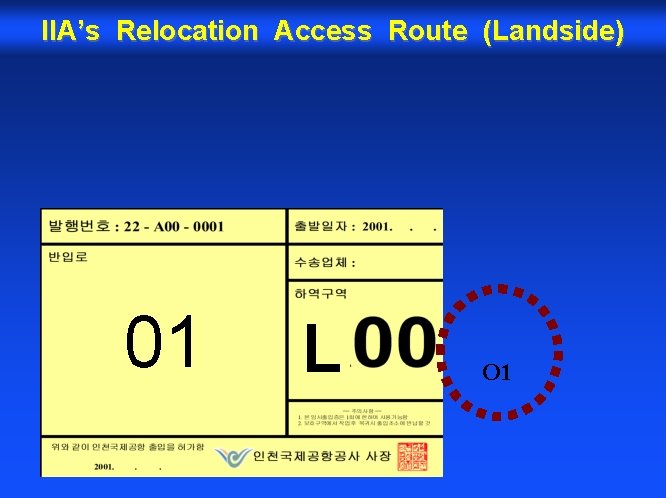

IIA’s Relocation Access Route (Landside) 01 L O 1

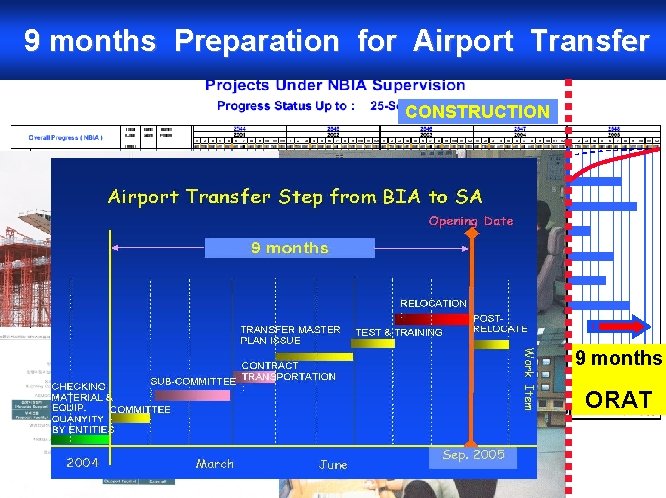

9 months Preparation for Airport Transfer CONSTRUCTION F S I H 9 months ORAT
Airport Transfer Step from BIA to SA Opening Date 9 months RELOCATION : POSTRELOCATE TRANSFER MASTER PLAN TEST & TRAINING ISSUE Work Item CONTRACT SUB-COMMITTEE TRANSPORTATION : : CHECKING MATERIAL & EQUIP. COMMITTEE QUANYITY : BY ENTITIES 2004 March June Sep. 2005
Conclusion and Recommendation - AIRPORT TRANSFER has 4 stages (Pre-stage, Intensivestage, Major stage, Post-stage). Normally 65% of equipment and materials should be removed into new airport during 7 days. Critical and important equipment should be transferred during 1 day. Minor equipment can be removed after airport opening. Therefore 2 months of AIRPORT TRANSFER are reasonable. - TRANSFER MASTER PLAN should be prepared by AOT and consultant about 6 months before real relocation. And the PLAN should be issued committee and acting sub-committee.

Airport Transfer from BIA to SA Thank you
