Status of PEG Krzysztof Czuba ESS LLRF Quarterly
Status of PEG Krzysztof Czuba ESS LLRF Quarterly Meeting 08. 11. 2018
Overall Schedule On following slides there are no milestones related directly to Teststand (Task 7). Need separate discussion. 08. 11. 2018, Łódź ESS PEG Progress Meeting, K. Czuba
Milestones 1 -21 # MS Short description 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 Kick-off meeting Progress meeting Final System Architecture Specification LO RTM PDR (Preliminary Design Review) Initial software from ESS ERIC for design verification LO RTM first prototype finished Piezo Driver PDR (Preliminary Design Review) Piezo Driver first prototype finished RTM Carrier AMC PDR (Preliminary Design Review) RTM Carrier AMC first prototype finished Final Solution from ESS ERIC for design verification Cabling and Installation planning for M-Beta finished Cabling and Installation planning for H-Beta finished LO RTM M-Beta prototype LO RTM for M-Beta CDR (Critical Design Review) Piezo Driver M-Beta prototype Piezo Driver for M-Beta CDR RTM Carrier AMC M-Beta prototype RTM Carrier AMC for M-Beta CDR Cavity Simulator prototype and preliminary firmware Cavity Simulator final firmware and documentation 08. 11. 2018, Łódź Planned / Baseline date Every 3 months 11. 2016 12. 2016 06. 2017 07. 2017 12. 2016 07. 2017 12. 2017 06. 2018 12. 2020 03. 2018 07. 2018 01. 2020 Location Responsible WUT ALL ESS ERIC WUT ESS ERIC DMCS ESS ERIC NCBJ ESS ERIC WUT WUT Partner/ESS ERIC Partner ESS ERIC Partner ESS ERIC Partner ESS PEG Progress Meeting, K. Czuba Status/Comments Closed by PDR in May 2017 Produced 08. 2017 (CS-LOG) Closed by PDR in May 2017 Produced 12. 2017 Delayed – expected Q 1 -Q 2 2019 Produced and tested. Done 04. 2018 Produced (04. 2018) and tested with H-Beta Done 04. 2018 Produced 08. 2018 Done 04. 2018 Ready. All Units shipped.

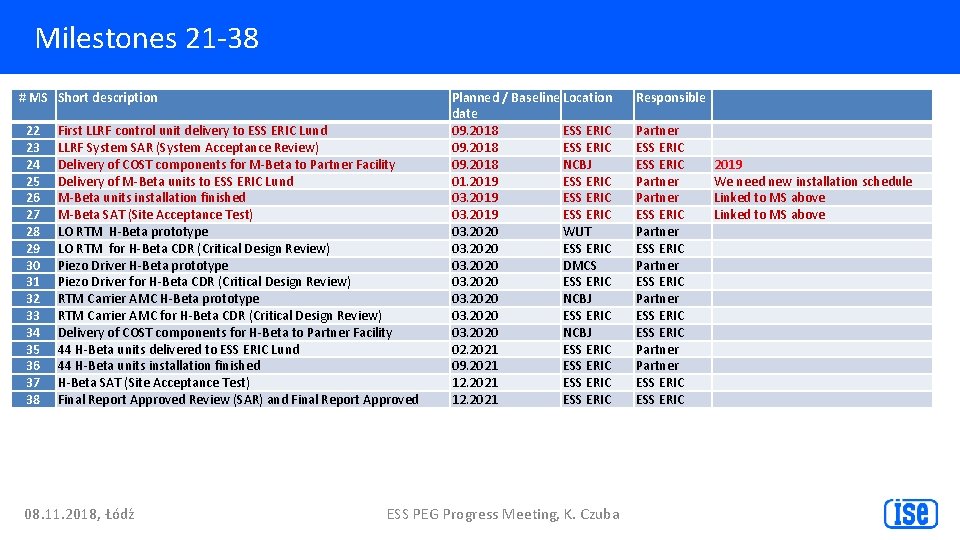

Milestones 21 -38 # MS Short description 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 First LLRF control unit delivery to ESS ERIC Lund LLRF System SAR (System Acceptance Review) Delivery of COST components for M-Beta to Partner Facility Delivery of M-Beta units to ESS ERIC Lund M-Beta units installation finished M-Beta SAT (Site Acceptance Test) LO RTM H-Beta prototype LO RTM for H-Beta CDR (Critical Design Review) Piezo Driver H-Beta prototype Piezo Driver for H-Beta CDR (Critical Design Review) RTM Carrier AMC H-Beta prototype RTM Carrier AMC for H-Beta CDR (Critical Design Review) Delivery of COST components for H-Beta to Partner Facility 44 H-Beta units delivered to ESS ERIC Lund 44 H-Beta units installation finished H-Beta SAT (Site Acceptance Test) Final Report Approved Review (SAR) and Final Report Approved 08. 11. 2018, Łódź Planned / Baseline Location date 09. 2018 ESS ERIC 09. 2018 NCBJ 01. 2019 ESS ERIC 03. 2020 WUT 03. 2020 ESS ERIC 03. 2020 DMCS 03. 2020 ESS ERIC 03. 2020 NCBJ 02. 2021 ESS ERIC 09. 2021 ESS ERIC 12. 2021 ESS ERIC ESS PEG Progress Meeting, K. Czuba Responsible Partner ESS ERIC Partner ESS ERIC Partner ESS ERIC 2019 We need new installation schedule Linked to MS above
Milestones 39 -56 # MS Short description 39 40 41 42 43 44 45 46 47 Electron Pick-up CDR Delivery of Electron Pick-up Design from ESS ERIC Delivery of 38 (RFQ and Spoke) Electron Pick-ups with test reports Delivery of 36 (MB) Electron Pick-ups with test reports Delivery of 44 (HB) Electron Pick-ups with test reports Delivery of 36 Piezo Power Supplies Delivery of 84 Piezo Power Supplies RF Split Box CDR Delivery of 87 RF Split Boxes (RFQ, MEBT, DTL, Spoke and MB) ) Planned / Baseline Location date 01. 2018 ESS ERIC 10. 2017 ESS ERIC 07. 2018 ESS ERIC 03. 2019 ESS ERIC 02. 2021 ESS ERIC 02. 2018 ESS ERIC 07. 2018 ESS ERIC 48 49 50 51 52 Delivery of 44 RF Split Boxes (HB) PIN Diode CDR Delivery of 81 PIN Diodes (RFQ, MEBT, DTL, Spoke and MB Delivery of 44 PIN Diodes (HB) Delivery of 81 PSS Switches (RFQ, MEBT, DTL, Spoke and MB) 02. 2021 01. 2018 07. 2018 02. 2021 07. 2018 ESS ERIC ESS ERIC Partner Partner 53 54 55 56 Delivery of 44 PSS Switches (HB) Delivery of 120 Patch Panels Initial Firmware/Software delivery for the RTM Carrier Final Firmware/Software delivery for the RTM Carrier 02. 2021 07. 2018 03. 2018 01. 2019 ESS ERIC Partner 08. 11. 2018, Łódź ESS PEG Progress Meeting, K. Czuba Responsible ESS ERIC Partner Partner ESS ERIC Partner Done 04. 2018 Design changed 08. 2018 Postponed to March 2019 Probably will be delayed Done 04. 2018 Delayed due to measurement problem and missing attenuator configuration from ESS. Investigations in progress Done 04. 2018 Delayed Production lauchd. Delivery expected Q 1 2019 Delayed. Possible Q 2 2019 Delayed
Action List from CDR 1 Module RTM carrier, LO RTM Description Responsible Status Finalise modifications PEG Done 2 All Review prototype availability and production volumes PEG/ESS Draft 3 Piezo RTM Confirm Fischer connector type ESS/AJJ Done 4 Piezo RTM PEG Done 5 Piezo RTM ESS Not ready 6 7 8 9 Piezo RTM All Reconsider LED color coding Confirm Pz controller cable lengths for M-Beta and H-Beta Verify PSU cable length Clarify Spoke Pz stack up Share MB rack layout Use CHESS ESS/AJJ ESS/ASV Not ready TBA Done 10 a QA Add/update test&inspection plan PEG to be done 10 b QA Add/update verification plan PEG to be done 10 c QA Add/update FAT document PEG to be done 08. 11. 2018, Łódź Due date Quarterly meeting in Łódź Details Including Freia and other TS, see separate doc Connector changed Fisher 103 Piezo actuator green LED Suggested 35 -45 meters. End of Sept. 2018 To be rechecked by ESS End of Sept. 2018 See rack layout mid. 2019? Not urgent Still needs some details General recommendation up to finishing of Concerns also prototypes. October Review it on Quarterly 16 th meeting in October up to finishing of Review it on Quarterly prototypes meeting in October ESS PEG Quarterly Meeting, K. Czuba
Module Description 11 CS Test LLRF system with cavity and provide data 12 All Update risk register 13 All Schedule replanning in August 14 a 14 b E-pickup 15 PIN diode LED's inconsistence with LPS status Review component placement Verify how power outage will influence control signal 16 E-pickup & PIN Produce front panel layout for all combinations 17 E-pickup & PIN Provide configuration 08. 11. 2018, Łódź Responsible Status Due date Details 2 months after In teststand 2 Needed for final CS design. Tests ESS progress ready with M- with H-Beta Cavity done in Freia Beta cavity Quarterly PEG/ESS meeting in Current verson needs update. Łódź Latest during Quarterly PEG/ESS meeting in Łódź ESS/Bruno Done wk 35 in ESS/Bruno progress ? ? Wait for modifications PEG Not ready Three different combinations of the PIN diode ESS Done Three different combinations ESS PEG Quarterly Meeting, K. Czuba

18 Module PSS switch x 31 Split. Box x 32 Split. Box x 33 PIN diode x 34 PSS switch x 35 x 36 Description Responsible Status Make mechanical enclosure larger PEG/ESS Done Change mechanics to have rear connectors optimized for rack layout PEG Done PEG/ESS Done ESS/Bruno Done Production test at 24 V-10% (21. 6 V) ESS/Bruno Done PIN diode Decide if separate variants for 352 and 704 MHz ESS/Bruno Done Patch panel Talk to ICS and LPS about card placement in MTCA Crate ESS/ASV 08. 11. 2018, Łódź Postpone delivery date (not time critical) Switch diode outside spec at 352 MHz Due date Details Request by Morteza, PSS ESS to review new proposal. MG will send the design and prototype in September Discuss during To gain experience from TS 2. PEG the QM needs a list of attenuators. Perfomance is OK. Confirm with wk 33 Bruno. Update test specification. 3 wk 39 pieces working at 17 V. Seems that the same RF wk 37 matching will be needed for both variants. In end of 2018 progress ESS PEG Quarterly Meeting, K. Czuba Test rack in preparation
Thank you for your attention 08. 11. 2018, Łódź ESS PEG Progress Meeting, K. Czuba
