SPS BPM system renovation Roadmap Milestones June End
SPS BPM system renovation Roadmap & Milestones
June End of production April February End of HW commissioning 2020 End of commissioning with Beam August End of Tunnel Installation February March Pre-production batch 2019 End of modules tests January Production start Production and installation in LS 2 2021
1 Technician/FSU 1 Expert 20% for debug June End of production 1 Technician/FSU 1 Expert x tunnel 1 Expert Surface 1 Expert April February August 2020 End of commissioning with Beam End of HW commissioning End of Tunnel Installation February March Pre-production batch 2019 End of modules tests January Production start Production and installation in LS 2 2021
End of 2016 – 2017: issues and delays • November 2016: observed saturation with high intensity trains ØRedesign of the analogue front end (see Manfred presentation) • February 2017: confirmation that the expected radiation level is increased ØSplit of the GEFE in L-GEFE and C-GEFE • July 2017: crosstalk on the input LP filters of the BDF (ADC) ØFilters moved outside the board

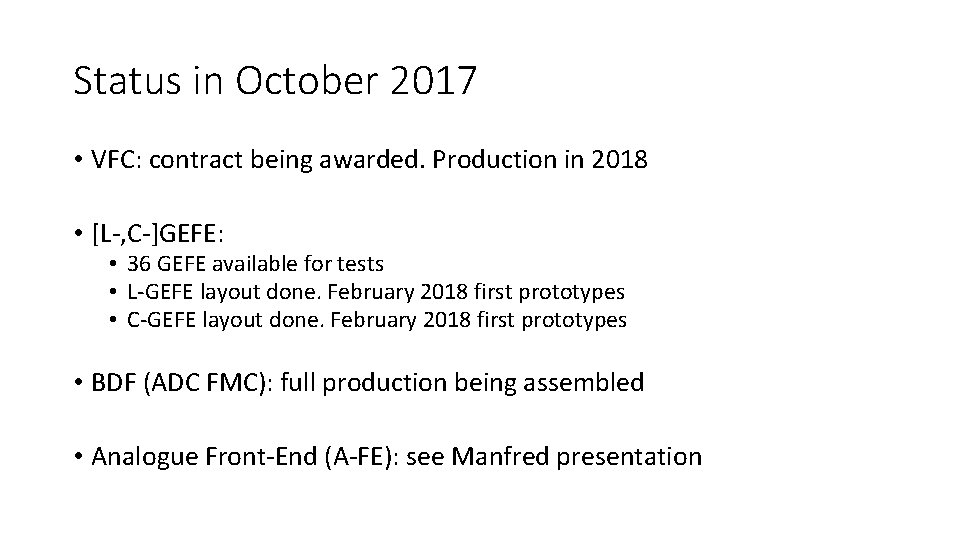

Status in October 2017 • VFC: contract being awarded. Production in 2018 • [L-, C-]GEFE: • 36 GEFE available for tests • L-GEFE layout done. February 2018 first prototypes • C-GEFE layout done. February 2018 first prototypes • BDF (ADC FMC): full production being assembled • Analogue Front-End (A-FE): see Manfred presentation
November June Start of production A-FE V 2 (30) End of qualification with Beam May End of Validation with beam of the A-FE September March Installation of 2 A-FE and D-FE in BA 4 2018 Installation of as many systems as possible February December October 2017 A-FE prototypes (10) A-FE Layout review and approval A-FE Layout start End 2017 – 2018: roadmap to LS 2 2019
November End of qualification with Beam June Start of production A-FE V 2 (30) September May End of Validation with beam of the A-FE GW ready End of Radiation Qualification Installation of as many systems as possible March Installation of 2 A-FE and D-FE in BA 4 2018 February December October 2017 A-FE prototypes (10) A-FE Layout review and approval A-FE Layout start End 2017 – 2018: roadmap to LS 2 FESA SW available FE automated test bench ready 2019
