Spending money saving money A 4 section Zgorzelec

  • Slides: 15
Download presentation
Spending money, saving money A 4 section Zgorzelec – Krzyżowa business case Monika Milwicz

Spending money, saving money A 4 section Zgorzelec – Krzyżowa business case Monika Milwicz EU Projects Department

Goals of motorway construction: • Cohesion of European TENT network (all motorways in Poland

Goals of motorway construction: • Cohesion of European TENT network (all motorways in Poland are part of TENT) • Shorter travel times • Improved road safty

A 4 Motorway Basic information on A 4 Motorway: Part of 3 rd TENT

A 4 Motorway Basic information on A 4 Motorway: Part of 3 rd TENT corridor Part of E 40; Ostenda (Brusselss_ Aachen – Koln – Dresden – Wrocław – Kraków - Kijev

A 4 Motorway; section Zgorzelec - Krzyżowa Basic information on A 4 Motorway; section

A 4 Motorway; section Zgorzelec - Krzyżowa Basic information on A 4 Motorway; section Zgorzelec – Krzyżowa: • Length – 51, 4 km • Number of motorway junctions – 4 • Designed speed – 120 km/h • Cement concrete pavement • Number of carriageways – 2 • Number of traffic lanes – 2 x 2 (target 2 x 3) • Maximum axle load – 115 k. N

Short history of construction section Zgorzelec - Krzyżowa The history of A 4 section

Short history of construction section Zgorzelec - Krzyżowa The history of A 4 section Zgorzelec - Krzyżowa construction: 1930 s – Preliminary design and preparation work. (earth works for German Wrocław – Dresden motorway still exist) 1997 – Preliminary design completed 1998 – Administrative decisions on the motorway route 2005 – Final administrative decision on the motorway route 2007 – Environmental impact study approval 2007 – Construction permit 2007 – 2009 Construction 14/08/2009 Grand opening

Project 2 projects implemented with EU co-financing 2002/PL/16/P/PA/007 Development of the project: Construction of

Project 2 projects implemented with EU co-financing 2002/PL/16/P/PA/007 Development of the project: Construction of A 4 motorway; section Zgorzelec – Krzyżowa Project budget according to the Financing Memorandum: 6 625 000 EURO Cohesion Fund contribution: 4 968 750 EURO 2004/PL/16/P/PT/004 Construction of Ar motorway; section Zgorzelec – Krzyżowa Project budget according to the Financing Memorandum: 317 567 000 Euro Cohesion Fund contribution: 252 040 940 EURO

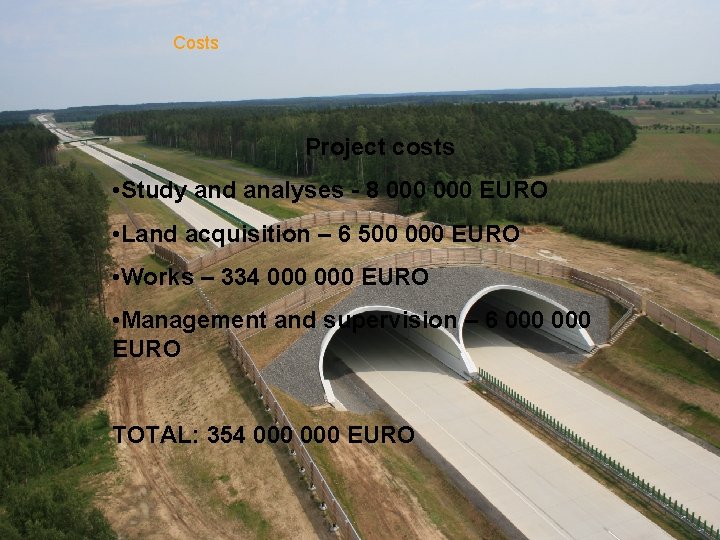

Costs Project costs • Study and analyses - 8 000 EURO • Land acquisition

Costs Project costs • Study and analyses - 8 000 EURO • Land acquisition – 6 500 000 EURO • Works – 334 000 EURO • Management and supervision – 6 000 EURO TOTAL: 354 000 EURO

Costs Economical costs • Traffic jam on the existing national road number 4 (DK

Costs Economical costs • Traffic jam on the existing national road number 4 (DK 4) • Accidents (only in 2006 – 2008 there were 100 accidents with 27 killed and 124 injured)

Benefits Project benefits according to the feasibility study: • Savings in vehicle operating costs

Benefits Project benefits according to the feasibility study: • Savings in vehicle operating costs • Savings of time • Savings due to lower accident frequency • Management and supervision

Benefits Results of economic analyse: Pessimistic scenario: NPV – 452. 000, 00 EURO (8%)

Benefits Results of economic analyse: Pessimistic scenario: NPV – 452. 000, 00 EURO (8%) IRR- 22, 4% Optimistic scenario: NPV – 1. 196. 000, 00 EURO (8%) IRR – 39, 3%

Verified Benefits of the new motorway construction 17 500 000 EURO per year The

Verified Benefits of the new motorway construction 17 500 000 EURO per year The economic benefits include: • savings on fuel and vehicle maintenance – 5 700 000 EURO • savings on time of freeway users – 9 100 000 EURO • savings on traffic accidents costs – 400 000 EURO • cost on emissions + 100 000 EURO

Spending money – Saving money Spending money: Bad menagement argument by the Cmmision: -

Spending money – Saving money Spending money: Bad menagement argument by the Cmmision: - cost over-runs on the PA/007 project preparation around 800 000 EURO - cost over-runs on the PT/004 (construction of motorwa) around 30 000 EURO Saving money: (and time) -17 500 000 EURO per year – total economical savings - shorten time of journey – to 30 minute-drive

Thank you

Thank you

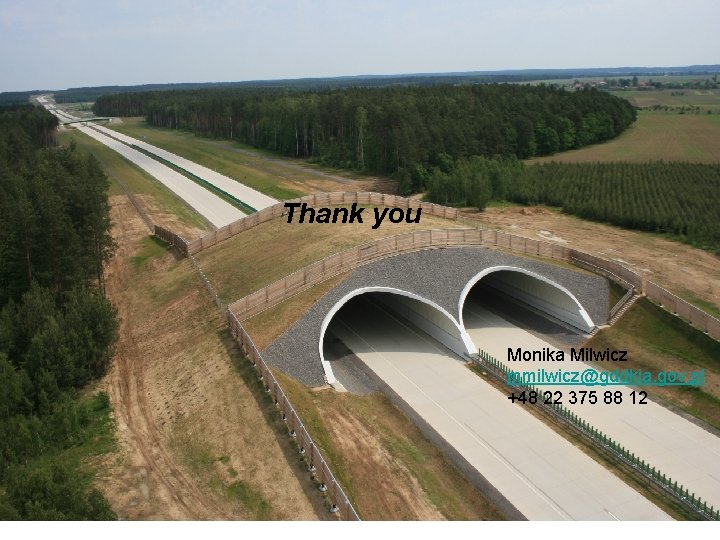

Thank you Monika Milwicz mmilwicz@gddkia. gov. pl +48 22 375 88 12

Thank you Monika Milwicz mmilwicz@gddkia. gov. pl +48 22 375 88 12
