Scheduling Chapter 16 2007 Pearson Education Scheduling Scheduling

  • Slides: 49
Download presentation
Scheduling Chapter 16 © 2007 Pearson Education

Scheduling Chapter 16 © 2007 Pearson Education

Scheduling Ø Scheduling: The allocation of resources over time to accomplish specific tasks. Ø

Scheduling Ø Scheduling: The allocation of resources over time to accomplish specific tasks. Ø Demand scheduling: A type of scheduling whereby customers are assigned to a definite time for order fulfillment. Ø Workforce scheduling: A type of scheduling that determines when employees work. Ø Operations scheduling: A type of scheduling in which jobs are assigned to workstations or employees are assigned to jobs for specified time periods. © 2007 Pearson Education

Scheduling Service and Manufacturing Processes Ø The scheduling techniques cut across the various process

Scheduling Service and Manufacturing Processes Ø The scheduling techniques cut across the various process types found in services and manufacturing Ø Front-office process with high customer contact, divergent work flows, customization, and a complex scheduling environment Ø Back-office process has low customer involvement, uses more line work flows, and provides standardized services © 2007 Pearson Education

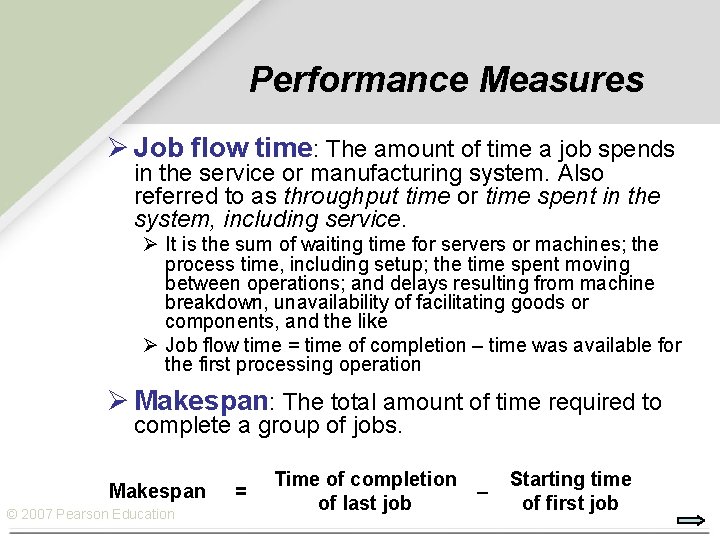

Performance Measures Ø Job flow time: The amount of time a job spends in

Performance Measures Ø Job flow time: The amount of time a job spends in the service or manufacturing system. Also referred to as throughput time or time spent in the system, including service. Ø It is the sum of waiting time for servers or machines; the process time, including setup; the time spent moving between operations; and delays resulting from machine breakdown, unavailability of facilitating goods or components, and the like Ø Job flow time = time of completion – time was available for the first processing operation Ø Makespan: The total amount of time required to complete a group of jobs. Makespan © 2007 Pearson Education = Time of completion of last job – Starting time of first job

Performance Measures Ø Past due (Tardiness): The amount of time by which a job

Performance Measures Ø Past due (Tardiness): The amount of time by which a job missed its due date or the percentage of total jobs processed over some period of time that missed their due dates. Ø Work-in-process (WIP) inventory: Any job that is waiting in line, moving from one operation to the next, being delayed, being processed, or residing in a semi-finished state. Ø Average WIP inventory = sum of flow times Makespan © 2007 Pearson Education

Performance Measures… ØTotal inventory: The sum of scheduled receipts and on-hand inventories. Total Scheduled

Performance Measures… ØTotal inventory: The sum of scheduled receipts and on-hand inventories. Total Scheduled receipts On-hand inventories = + Inventory for all items of all items Ø Average total inventory = sum of time in system Makespan ØUtilization: The percentage of work time that is productively spent by an employee or machine. © 2007 Pearson Education

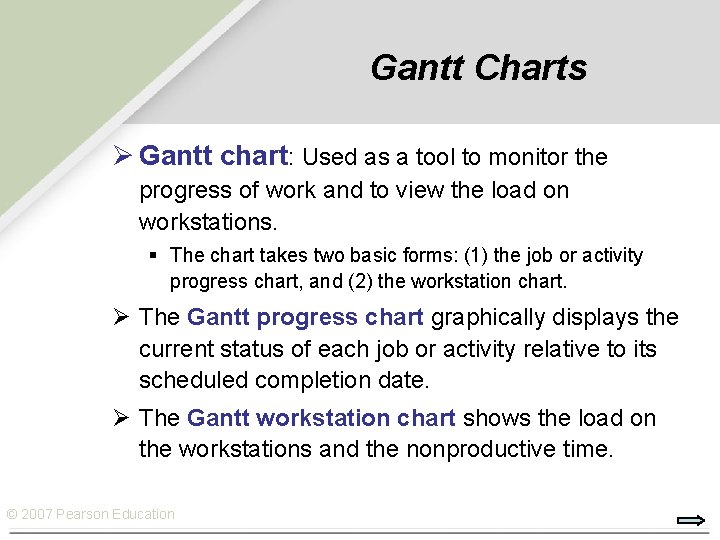

Gantt Charts Ø Gantt chart: Used as a tool to monitor the progress of

Gantt Charts Ø Gantt chart: Used as a tool to monitor the progress of work and to view the load on workstations. § The chart takes two basic forms: (1) the job or activity progress chart, and (2) the workstation chart. Ø The Gantt progress chart graphically displays the current status of each job or activity relative to its scheduled completion date. Ø The Gantt workstation chart shows the load on the workstations and the nonproductive time. © 2007 Pearson Education

Gantt Progress Chart for an Auto Parts Company Start activity Finish activity Nonproductive time

Gantt Progress Chart for an Auto Parts Company Start activity Finish activity Nonproductive time Job Scheduled activity time Current date Actual progress 4/17 4/18 4/19 4/20 4/21 4/22 4/23 4/24 4/25 4/26 Ford Plymouth Pontiac © 2007 Pearson Education

Gantt Workstation Chart for Hospital Operating Rooms © 2007 Pearson Education

Gantt Workstation Chart for Hospital Operating Rooms © 2007 Pearson Education

1) Scheduling Customer Demand Ø Three methods are commonly used to schedule customer demand:

1) Scheduling Customer Demand Ø Three methods are commonly used to schedule customer demand: (1) Appointments assign specific times for service to customers. (2) Reservations are used when the customer actually occupies or uses facilities associated with the service. (3) Backlogs: • The customer is given a due date for the fulfillment a product order, or • Allow a backlog to develop as customers arrive at the system. Customers may never know exactly when their orders will be fulfilled © 2007 Pearson Education

2) Scheduling Employees Ø Rotating schedule: A schedule that rotates employees through a series

2) Scheduling Employees Ø Rotating schedule: A schedule that rotates employees through a series of workdays or hours. Ø Fixed schedule: A schedule that calls for each employee to work the same days and hours each week. Ø Constraints: The technical constraints imposed on the workforce schedule are the resources provided by the staffing plan and the requirements placed on the operating system. Ø Other constraints, including legal and behavioral considerations, also can be imposed. © 2007 Pearson Education

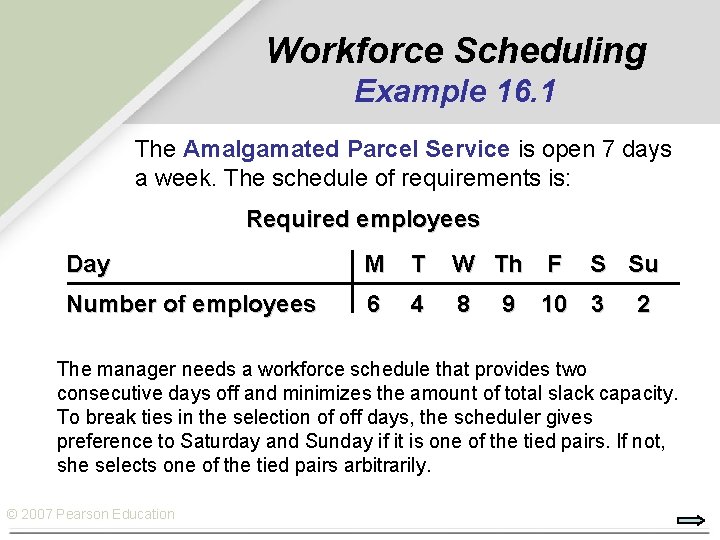

Workforce Scheduling Example 16. 1 The Amalgamated Parcel Service is open 7 days a

Workforce Scheduling Example 16. 1 The Amalgamated Parcel Service is open 7 days a week. The schedule of requirements is: Required employees Day M T W Th F Number of employees 6 4 8 9 S Su 10 3 2 The manager needs a workforce schedule that provides two consecutive days off and minimizes the amount of total slack capacity. To break ties in the selection of off days, the scheduler gives preference to Saturday and Sunday if it is one of the tied pairs. If not, she selects one of the tied pairs arbitrarily. © 2007 Pearson Education

Workforce Scheduling Example 16. 1 Steps 1 & 2 Required employees Day M T

Workforce Scheduling Example 16. 1 Steps 1 & 2 Required employees Day M T Number of employees Employee 1 6 4 X X W Th F 8 X S Su 9 10* 3 X X 2 Step 1. Find all the pairs of consecutive days that exclude the maximum daily requirements. Select the unique pair that has the lowest total requirements for the 2 days. Friday contains the maximum requirements (10), and the pair S–Su has the lowest total requirements. Therefore, Employee 1 is scheduled to work Monday through Friday. Step 2. If a tie occurs, choose one of the tied pairs or ask the employee to make a choice. © 2007 Pearson Education

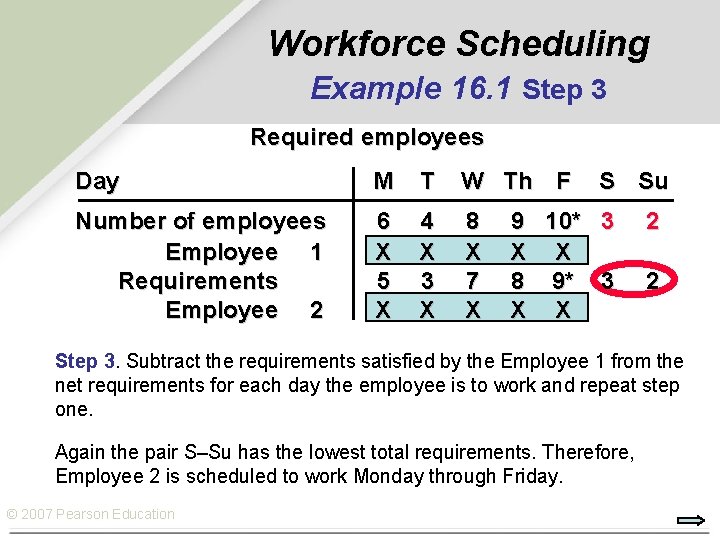

Workforce Scheduling Example 16. 1 Step 3 Required employees Day M T W Th

Workforce Scheduling Example 16. 1 Step 3 Required employees Day M T W Th F Number of employees Employee 1 Requirements Employee 2 6 X 5 X 4 X 3 X 8 X 7 X S Su 9 10* 3 X X 8 9* 3 X X 2 2 Step 3. Subtract the requirements satisfied by the Employee 1 from the net requirements for each day the employee is to work and repeat step one. Again the pair S–Su has the lowest total requirements. Therefore, Employee 2 is scheduled to work Monday through Friday. © 2007 Pearson Education

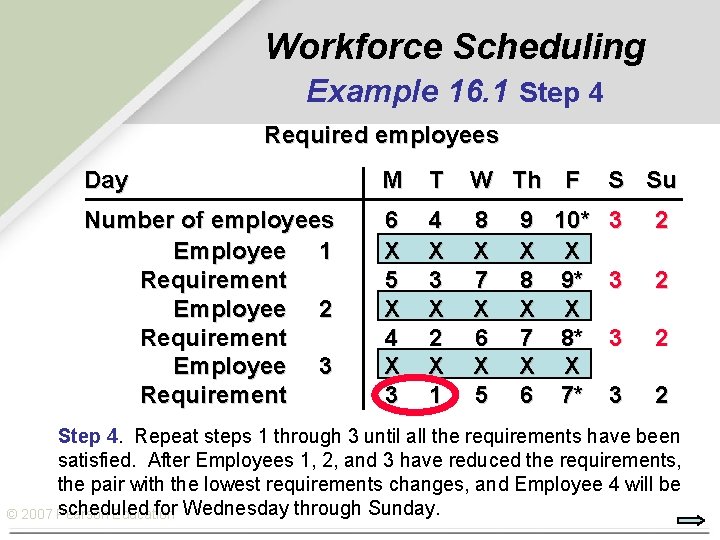

Workforce Scheduling Example 16. 1 Step 4 Required employees Day M T W Th

Workforce Scheduling Example 16. 1 Step 4 Required employees Day M T W Th F Number of employees Employee 1 Requirement Employee 2 Requirement Employee 3 Requirement 6 X 5 X 4 X 3 X 2 X 1 8 X 7 X 6 X 5 S Su 9 10* 3 X X 8 9* 3 X X 7 8* 3 X X 6 7* 3 2 2 Step 4. Repeat steps 1 through 3 until all the requirements have been satisfied. After Employees 1, 2, and 3 have reduced the requirements, the pair with the lowest requirements changes, and Employee 4 will be scheduled for Wednesday through Sunday. © 2007 Pearson Education

Workforce Scheduling Example 16. 1 Step 4 continued Required employees Day M T W

Workforce Scheduling Example 16. 1 Step 4 continued Required employees Day M T W Th F Number of employees Employee 1 Requirement Employee 2 Requirement Employee 3 Requirement Employee 4 Requirement Employee 5 6 X 5 X 4 X 3 X 2 X 1 3 X 1 X 8 X 7 X 6 X 5 X 4 X © 2007 Pearson Education S Su 9 10* 3 X X 8 9* 3 X X 7 8* 3 X X 6 7* 3 X X X 5 6* 2 X X 2 2 X 1

Workforce Scheduling Example 16. 1 Step 4 continued Required employees Day Requirement Employee 6

Workforce Scheduling Example 16. 1 Step 4 continued Required employees Day Requirement Employee 6 Requirement Employee 7 Requirement Employee 8 Requirement Employee 9 Requirement Employee 10 © 2007 Pearson Education M T W Th F 2 0 2 X 1 X 0 0 X 0 X 3 X 2 X 1 X 0 X 0 X 4 X 3 X 2 X 1 X 0 X S Su 5* 2 X X 4* 1 X 3* 1 X 2* 1 X X 1* 0 X 1 X 0 0

Workforce Scheduling Example 16. 1 Final Schedule Day Employee 1 Employee 2 Employee 3

Workforce Scheduling Example 16. 1 Final Schedule Day Employee 1 Employee 2 Employee 3 Employee 4 Employee 5 Employee 6 Employee 7 Employee 8 Employee 9 Employee 10 © 2007 Pearson Education M T W Th F S Su X X X off off X X off off X X X X X off off X X X X X X

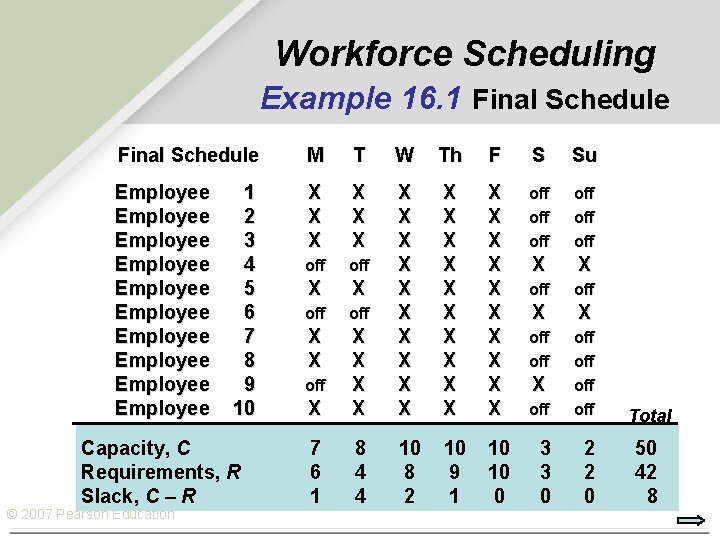

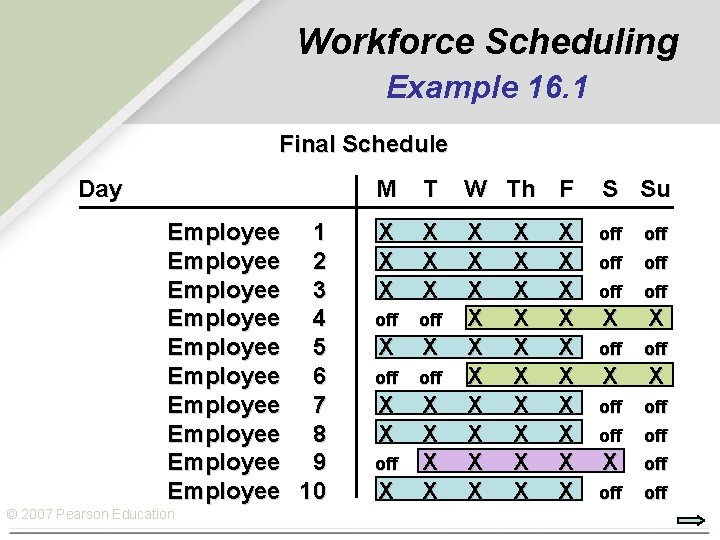

Workforce Scheduling Example 16. 1 Final Schedule M T W Th F S Su

Workforce Scheduling Example 16. 1 Final Schedule M T W Th F S Su Employee Employee Employee X X X X X off off off off X X X X X X X X X X off off 7 6 1 8 4 4 10 8 2 10 9 1 10 10 0 3 3 0 2 2 0 1 2 3 4 5 6 7 8 9 10 Capacity, C Requirements, R Slack, C – R © 2007 Pearson Education off Total 50 42 8

3) Operations Scheduling Ø Operations schedules are short-term plans designed to implement the master

3) Operations Scheduling Ø Operations schedules are short-term plans designed to implement the master production schedule. § Operations scheduling focuses on how best to use existing capacity. § Often, several jobs must be processed at one or more workstations. Typically, a variety of tasks can be performed at each workstation. Ø Job shop: A firm that specializes in low- to medium -volume production and utilizes job or batch processes. Ø Flow shop: A firm that specializes in medium- to high-volume production and utilizes line or continuous processes. © 2007 Pearson Education

Raw Materials Shipping Department Manufacturing Process Legend: © 2007 Pearson Education Batch of parts

Raw Materials Shipping Department Manufacturing Process Legend: © 2007 Pearson Education Batch of parts Workstation

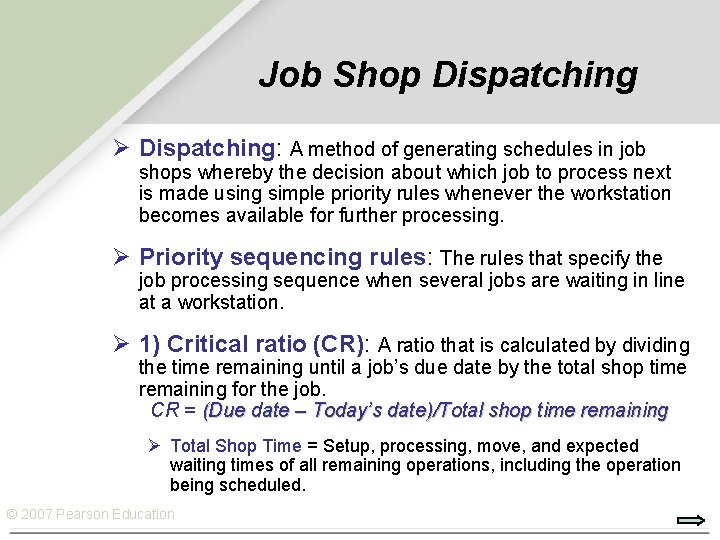

Job Shop Dispatching Ø Dispatching: A method of generating schedules in job shops whereby

Job Shop Dispatching Ø Dispatching: A method of generating schedules in job shops whereby the decision about which job to process next is made using simple priority rules whenever the workstation becomes available for further processing. Ø Priority sequencing rules: The rules that specify the job processing sequence when several jobs are waiting in line at a workstation. Ø 1) Critical ratio (CR): A ratio that is calculated by dividing the time remaining until a job’s due date by the total shop time remaining for the job. CR = (Due date – Today’s date)/Total shop time remaining Ø Total Shop Time = Setup, processing, move, and expected waiting times of all remaining operations, including the operation being scheduled. © 2007 Pearson Education

Priority sequencing rules u Critical ratio (CR): u A ratio less than 1. 0

Priority sequencing rules u Critical ratio (CR): u A ratio less than 1. 0 implies that the job is behind schedule u A ratio greater than 1. 0 implies the job is ahead of schedule u The job with the lowest CR is scheduled next Ø 2) Earliest due date (EDD): A priority sequencing rule that specifies that the job with the earliest due date is the next job to be processed. © 2007 Pearson Education

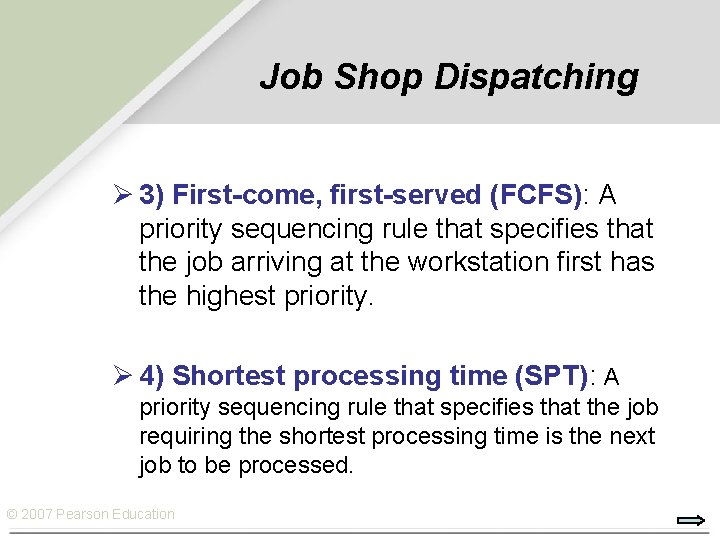

Job Shop Dispatching Ø 3) First-come, first-served (FCFS): A priority sequencing rule that specifies

Job Shop Dispatching Ø 3) First-come, first-served (FCFS): A priority sequencing rule that specifies that the job arriving at the workstation first has the highest priority. Ø 4) Shortest processing time (SPT): A priority sequencing rule that specifies that the job requiring the shortest processing time is the next job to be processed. © 2007 Pearson Education

Job Shop Dispatching Ø 5) Slack per remaining operations (S/RO): A priority sequencing rule

Job Shop Dispatching Ø 5) Slack per remaining operations (S/RO): A priority sequencing rule that determines priority by dividing the slack by the number of operations that remain, including the one being scheduled. S/RO = ((Due date – Today’s date) – Total shop time remaining) Number of operations remaining The job with the lowest S/RO is scheduled next © 2007 Pearson Education

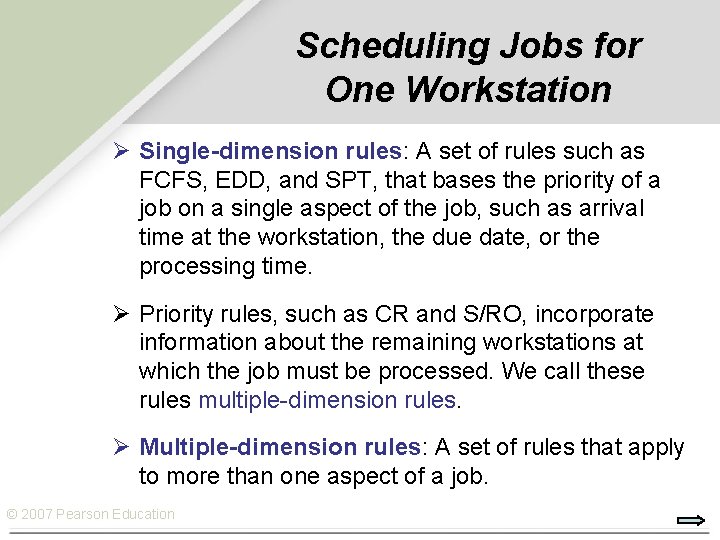

Scheduling Jobs for One Workstation Ø Single-dimension rules: A set of rules such as

Scheduling Jobs for One Workstation Ø Single-dimension rules: A set of rules such as FCFS, EDD, and SPT, that bases the priority of a job on a single aspect of the job, such as arrival time at the workstation, the due date, or the processing time. Ø Priority rules, such as CR and S/RO, incorporate information about the remaining workstations at which the job must be processed. We call these rules multiple-dimension rules. Ø Multiple-dimension rules: A set of rules that apply to more than one aspect of a job. © 2007 Pearson Education

Example 16. 2 Single-Dimension Rule Sequencing Five engine blocks are waiting for processing. The

Example 16. 2 Single-Dimension Rule Sequencing Five engine blocks are waiting for processing. The processing times have been estimated. Expected completion times have been agreed. The table shows the situation as of Monday morning. Customer pickup times are measured in business hours from Monday morning. Determine the schedule by using the EDD rule and then the SPT rule. Calculate the average hours early, hours past due, WIP inventory, and total inventory for each method. If low job flow times and WIP inventories are critical, which rule should be chosen? © 2007 Pearson Education

Example 16. 2 Single-Dimension Rule – EDD Engine Block Sequence Ranger Explorer Econoline 150

Example 16. 2 Single-Dimension Rule – EDD Engine Block Sequence Ranger Explorer Econoline 150 Bronco Thunderbird Processing Begin Time Work (hr) 0 8 14 17 32 + + + 8 6 3 15 12 = = = Job Flow Time (hr) 8 14 17 32 44 Average job flow time = 23 hours Average hours past due = 7. 2 hours Scheduled Customer Pickup Time 10 12 18 20 22 Actual Customer Hours Pickup Hours Past Time Early Due 10 14 18 32 44 2 2 1 12 22 Average hours early = 0. 6 hour Average WIP = 2. 61 blocks + 14 32 + 44 10 + 14 +8 18 + +3217++44 Average total inventory = 2. 68 engine blocks 44 44 © 2007 Pearson Education

Example 16. 2 Single-Dimension Rule – SPT Engine Block Sequence Ranger Econoline 150 Explorer

Example 16. 2 Single-Dimension Rule – SPT Engine Block Sequence Ranger Econoline 150 Explorer Econoline Ranger 150 Bronco Thunderbird Processing Begin Time Work (hr) 00 83 149 17 17 29 29 + + + 83 66 38 12 15 15 12 Job Flow Time (hr) = = = 3 9 17 29 44 Average job flow time = 20. 4 hours Average hours past due = 7. 6 hours Scheduled Customer Pickup Time 10 18 12 12 18 10 22 20 20 22 Actual Customer Hours Pickup Hours Past Time Early Due 18 12 17 29 44 15 3 7 7 24 Average hours early = 3. 6 hour Average WIP = 2. 32 blocks + 9++20 17++ 44 29 + 44 18 + 12 +317 Average total inventory = 2. 73 engine blocks 44 44 © 2007 Pearson Education

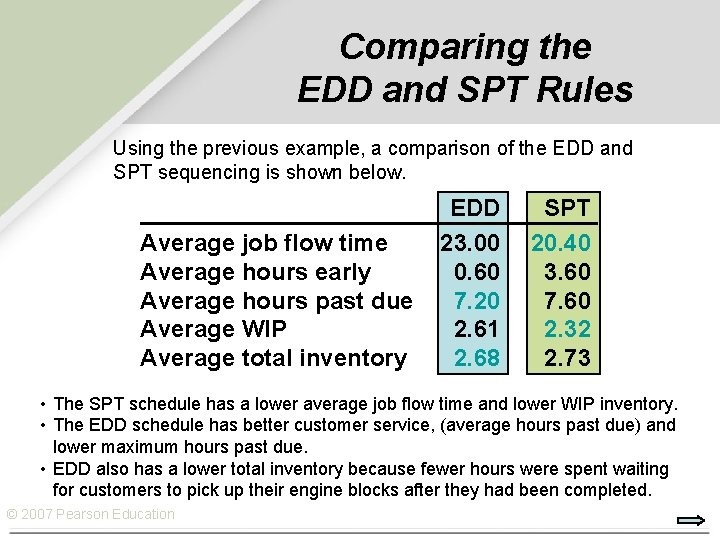

Comparing the EDD and SPT Rules Using the previous example, a comparison of the

Comparing the EDD and SPT Rules Using the previous example, a comparison of the EDD and SPT sequencing is shown below. Average job flow time Average hours early Average hours past due Average WIP Average total inventory EDD 23. 00 0. 60 7. 20 2. 61 2. 68 SPT 20. 40 3. 60 7. 60 2. 32 2. 73 • The SPT schedule has a lower average job flow time and lower WIP inventory. • The EDD schedule has better customer service, (average hours past due) and lower maximum hours past due. • EDD also has a lower total inventory because fewer hours were spent waiting for customers to pick up their engine blocks after they had been completed. © 2007 Pearson Education

Example 16. 3 Multiple-Dimension Rule – CR Job 1 2 3 4 Operation Time

Example 16. 3 Multiple-Dimension Rule – CR Job 1 2 3 4 Operation Time at Remaining Engine to Due Date Lathe (hr) (hrs) 2. 3 10. 5 6. 2 15. 6 15 10 20 8 Number of Operations Remaining Shop Time Remaining CR 10 2 12 5 6. 1 7. 8 14. 5 10. 2 2. 46 1. 28 1. 38. 78 Time remaining to due date CR = Shop time remaining © 2007 Pearson Education S/RO

Example 16. 3 Multiple-Dimension Rule – S/RO Job 1 2 3 4 Operation Time

Example 16. 3 Multiple-Dimension Rule – S/RO Job 1 2 3 4 Operation Time at Remaining Engine to Due Date Lathe (hr) (hrs) 2. 3 10. 5 6. 2 15. 6 S/RO = 15 10 20 8 Number of Operations Remaining Shop Time Remaining 10 2 12 5 6. 1 7. 8 14. 5 10. 2 CR S/RO 2. 46 0. 89 1. 28 1. 10 1. 38 0. 46. 78 – 0. 44 Time remaining to due date – Shop time remaining Number of operations remaining © 2007 Pearson Education

Comparing the CR and S/RO Rules Job 1 2 3 4 Operation Time at

Comparing the CR and S/RO Rules Job 1 2 3 4 Operation Time at Remaining Engine to Due Date Lathe (hr) (hrs) 2. 3 10. 5 6. 2 15. 6 15 10 20 8 Number of Operations Remaining Shop Time Remaining 10 2 12 5 6. 1 7. 8 14. 5 10. 2 CR Sequence = 4– 2– 3– 1 S/RO Sequence = 4 – 3 – 1 – 2 © 2007 Pearson Education CR S/RO 2. 46 0. 89 1. 28 1. 10 1. 38 0. 46. 78 – 0. 44

Priority Rule Summary • The S/RO rule is better than the EDD rule and

Priority Rule Summary • The S/RO rule is better than the EDD rule and the CR rule but it is much worse than the SPT rule and the FCFS rule for this example. • S/RO has the advantage of allowing schedule changes when due dates change. These results cannot be generalized to other situations because only four jobs are being processed. FCFS Avg Flow Time Avg Early Time Avg Past Due Avg WIP Avg Total Inv © 2007 Pearson Education 17. 175 3. 425 7. 350 1. 986 2. 382 FCFS SPT EDD CR S/RO Shortest Processing Earliest Time Due Date 16. 100 6. 050 8. 900 1. 861 2. 561 26. 175 0 12. 925 3. 026 = = = 1– 2– 3– 4 1– 3– 2– 4 4– 2– 1– 3 4– 2– 3– 1 4– 3– 1– 2 Critical Ratio Slack per Remaining Operation 27. 150 0 13. 900 3. 129 24. 025 0 10. 775 2. 777

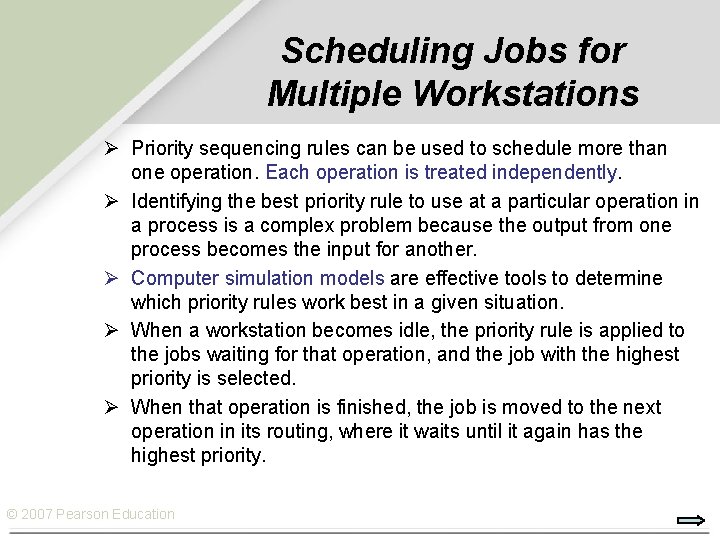

Scheduling Jobs for Multiple Workstations Ø Priority sequencing rules can be used to schedule

Scheduling Jobs for Multiple Workstations Ø Priority sequencing rules can be used to schedule more than one operation. Each operation is treated independently. Ø Identifying the best priority rule to use at a particular operation in a process is a complex problem because the output from one process becomes the input for another. Ø Computer simulation models are effective tools to determine which priority rules work best in a given situation. Ø When a workstation becomes idle, the priority rule is applied to the jobs waiting for that operation, and the job with the highest priority is selected. Ø When that operation is finished, the job is moved to the next operation in its routing, where it waits until it again has the highest priority. © 2007 Pearson Education

Johnson’s Rule Ø Johnson’s rule: A procedure that minimizes makespan when scheduling a group

Johnson’s Rule Ø Johnson’s rule: A procedure that minimizes makespan when scheduling a group of jobs on two workstations. Ø Step 1. Find the shortest processing time among the jobs not yet scheduled. If two or more jobs are tied, choose one job arbitrarily. Ø Step 2. If the shortest processing time is on workstation 1, schedule the corresponding job as early as possible. If the shortest processing time is on workstation 2, schedule the corresponding job as late as possible. Ø Step 3. Eliminate the last job scheduled from further consideration. Repeat steps 1 and 2 until all jobs have been scheduled. © 2007 Pearson Education

Example 16. 5 Ø The Morris machine company just received an order to refurbish

Example 16. 5 Ø The Morris machine company just received an order to refurbish five motors for materials handling equipment that were damaged in a fire. The motors will be repaired at two workstations in the following manner. Ø Workstation 1 dismantle the motor and clean the parts. Ø Workstation 2 replace the parts as necessary, test the motor, and make adjustments. Ø The customer shop will be inoperable until all the motors have been repaired, so the plant manager is interested in developing a schedule that minimizes the makespan. © 2007 Pearson Education

Example 16. 5 Johnson’s Rule at the Morris Machine Co. Time (hr) Motor M

Example 16. 5 Johnson’s Rule at the Morris Machine Co. Time (hr) Motor M 1 M 2 M 3 M 4 M 5 Workstation 1 12 4 5 15 10 Workstation 2 22 5 3 16 8 Eliminate M 3 from consideration. The next shortest time Eliminate M 1 and the only job remaining to be Eliminate M 5 from consideration. The next shortest time is Eliminate M 2 from consideration. The next shortest time is Shortest time is 3 hours at workstation 2, so isat M 2 at Workstation 1, schedule so schedule M 2 first. scheduled is M 4. M 1 at workstation #1, so schedule M 1 next. M 5 workstation #2, so M 5 next to last. schedule job M 3 last. © 2007 Pearson Education Sequence = M 2 M 1 M 4 M 5 M 3

Example 16. 5 Johnson’s Rule at the Morris Machine Co. The schedule minimizes the

Example 16. 5 Johnson’s Rule at the Morris Machine Co. The schedule minimizes the idle time of workstation 2 and gives the fastest repair time for all five motors. No other sequence will produce a lower makespan. Gantt Chart for the Morris Machine Company Repair Schedule Workstation M 2 (4) 1 2 M 1 (12) Idle M 2 (5) 0 5 © 2007 Pearson Education M 4 (15) M 3 (5) M 1 (22) Idle 10 M 5 (10) 15 20 25 Idle—available for further work M 4 (16) 30 35 Day 40 45 M 5 (8) 50 55 M 3 (3) 60 65

Labor-limited Environments Ø The limiting resource thus far has been the number of machines

Labor-limited Environments Ø The limiting resource thus far has been the number of machines or workstations available. A more typical constraint is the amount of labor available. Ø Labor-limited environment: An environment in which 1. 2. 3. 4. the resource constraint is the amount of labor available, not the number of machines or workstations. Assign personnel to the workstation with the job that has been in the system longest. Assign personnel to the workstation with the most jobs waiting for processing. Assign personnel to the workstation with the largest standard work content. Assign personnel to the workstation with the job that has the earliest due date. © 2007 Pearson Education

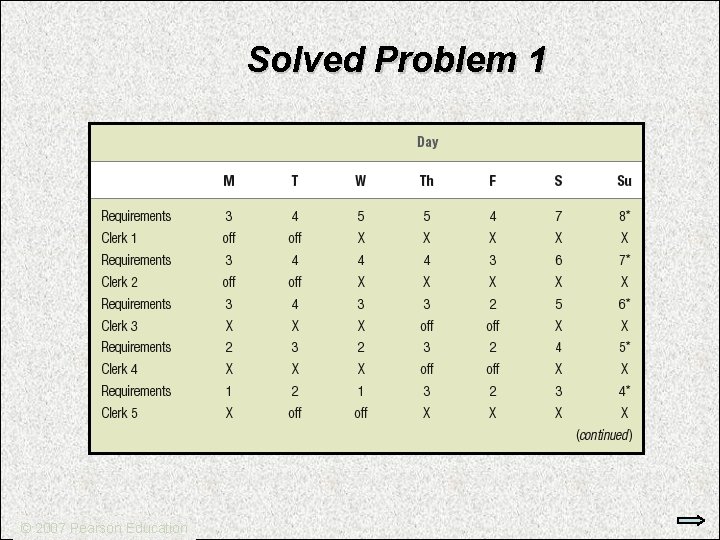

Solved Problem 1 Ø The Food Bin grocery store operates 24 hours per day,

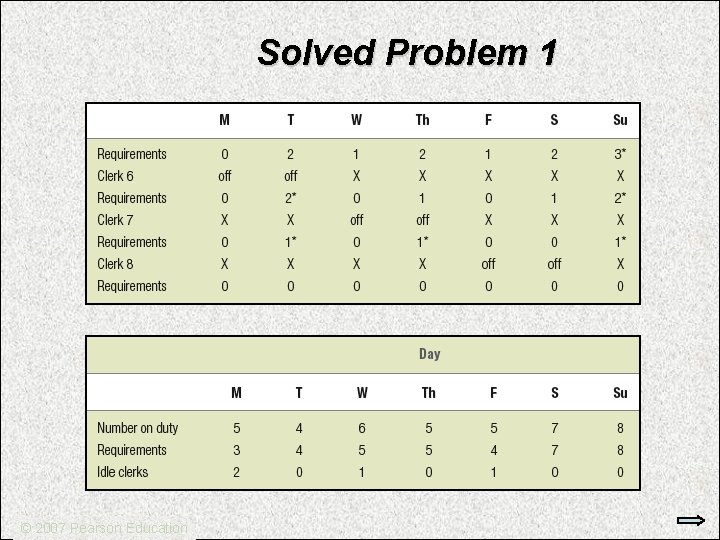

Solved Problem 1 Ø The Food Bin grocery store operates 24 hours per day, 7 days per week. At the end of the month, they calculated the average number of checkout registers that should be open during the first shift each day. Results showed peak needs on Saturdays and Sundays. 1. Develop a schedule that covers all requirements while giving two consecutive days off to each clerk. How many clerks are needed? 2. Plans can be made to use the clerks for other duties if slack or idle time resulting from this schedule can be determined. How much idle time will result from this schedule, and on what days? © 2007 Pearson Education

Solved Problem 1 © 2007 Pearson Education

Solved Problem 1 © 2007 Pearson Education

Solved Problem 1 © 2007 Pearson Education

Solved Problem 1 © 2007 Pearson Education

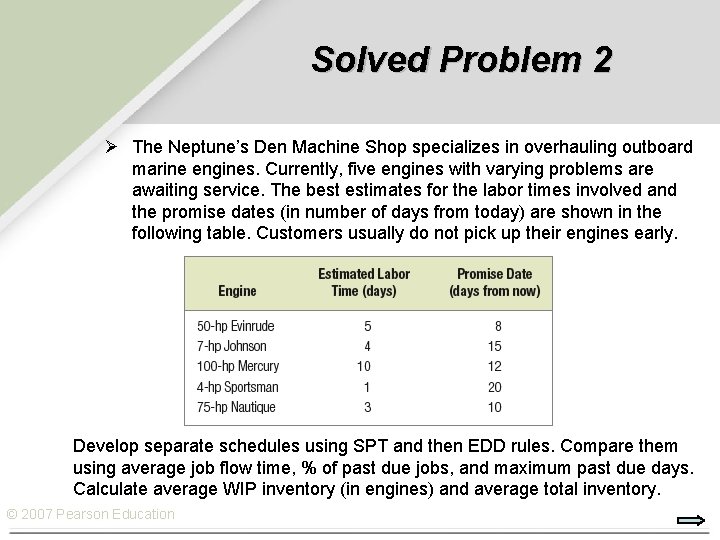

Solved Problem 2 Ø The Neptune’s Den Machine Shop specializes in overhauling outboard marine

Solved Problem 2 Ø The Neptune’s Den Machine Shop specializes in overhauling outboard marine engines. Currently, five engines with varying problems are awaiting service. The best estimates for the labor times involved and the promise dates (in number of days from today) are shown in the following table. Customers usually do not pick up their engines early. Develop separate schedules using SPT and then EDD rules. Compare them using average job flow time, % of past due jobs, and maximum past due days. Calculate average WIP inventory (in engines) and average total inventory. © 2007 Pearson Education

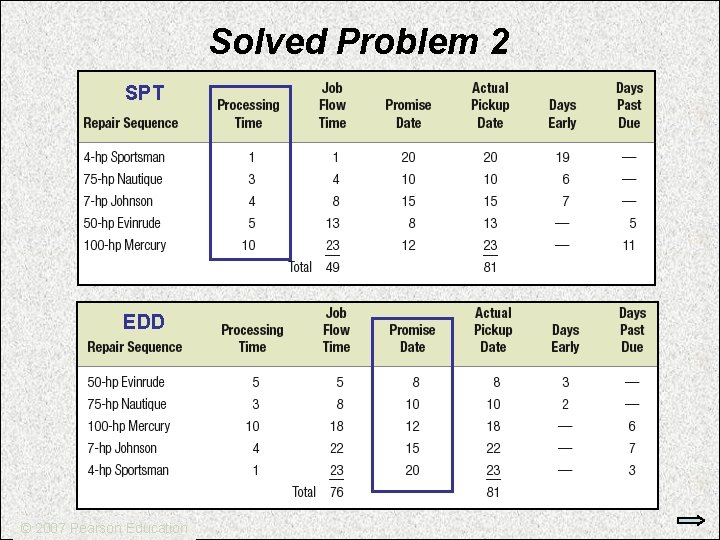

Solved Problem 2 SPT EDD © 2007 Pearson Education

Solved Problem 2 SPT EDD © 2007 Pearson Education

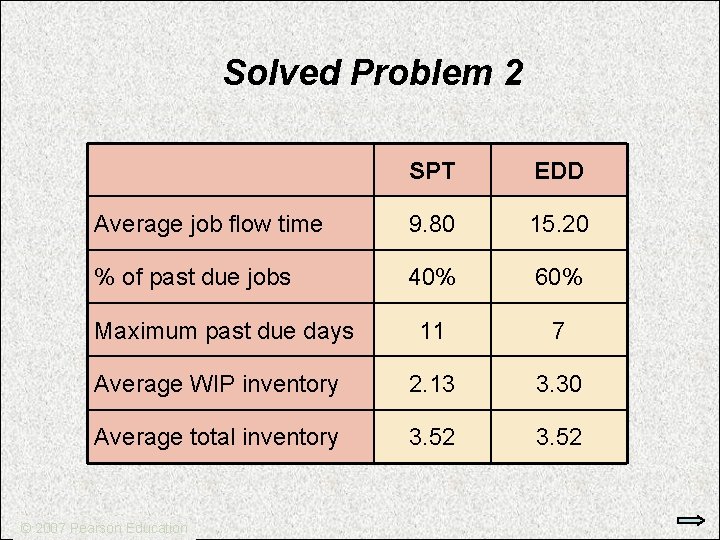

Solved Problem 2 SPT EDD Average job flow time 9. 80 15. 20 %

Solved Problem 2 SPT EDD Average job flow time 9. 80 15. 20 % of past due jobs 40% 60% 11 7 Average WIP inventory 2. 13 3. 30 Average total inventory 3. 52 Maximum past due days © 2007 Pearson Education

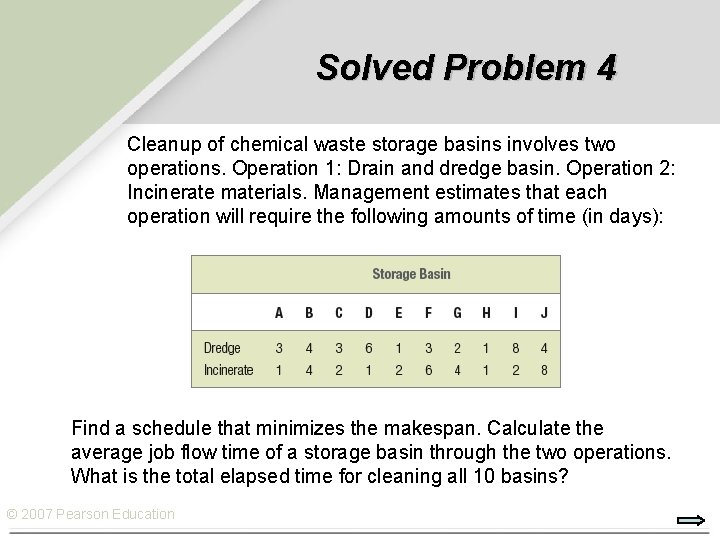

Solved Problem 4 Cleanup of chemical waste storage basins involves two operations. Operation 1:

Solved Problem 4 Cleanup of chemical waste storage basins involves two operations. Operation 1: Drain and dredge basin. Operation 2: Incinerate materials. Management estimates that each operation will require the following amounts of time (in days): Find a schedule that minimizes the makespan. Calculate the average job flow time of a storage basin through the two operations. What is the total elapsed time for cleaning all 10 basins? © 2007 Pearson Education

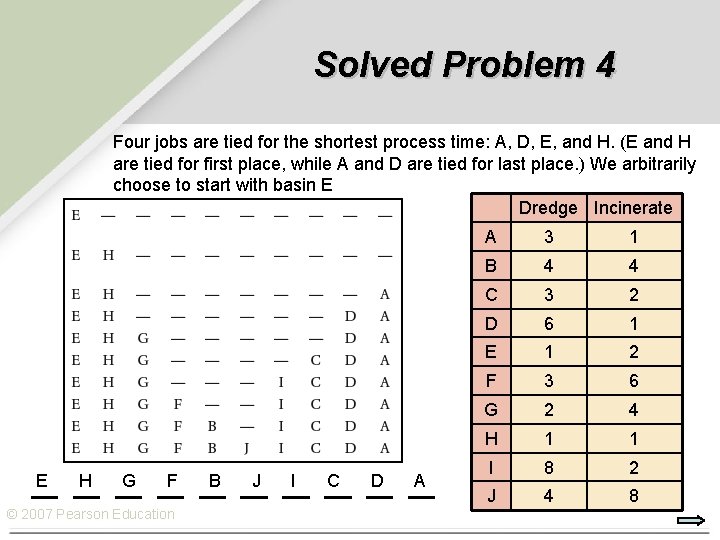

Solved Problem 4 Four jobs are tied for the shortest process time: A, D,

Solved Problem 4 Four jobs are tied for the shortest process time: A, D, E, and H. (E and H are tied for first place, while A and D are tied for last place. ) We arbitrarily choose to start with basin E Dredge Incinerate E H G F © 2007 Pearson Education B J I C D A A 3 1 B 4 4 C 3 2 D 6 1 E 1 2 F 3 6 G 2 4 H 1 1 I 8 2 J 4 8

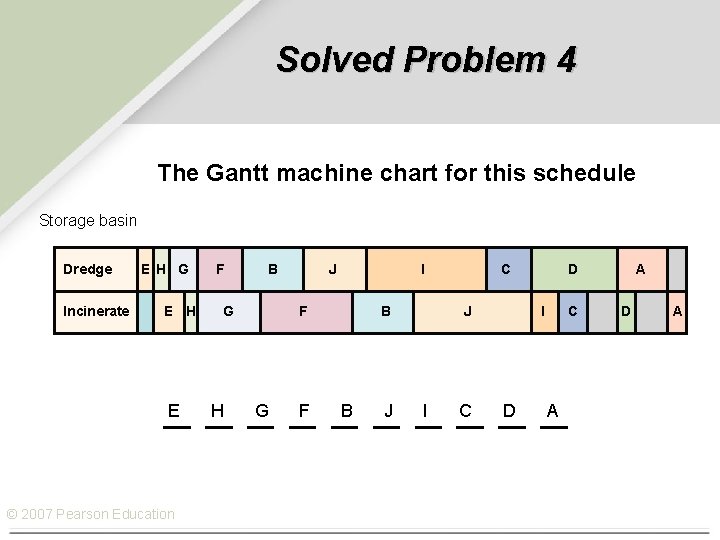

Solved Problem 4 The Gantt machine chart for this schedule Storage basin Dredge Incinerate

Solved Problem 4 The Gantt machine chart for this schedule Storage basin Dredge Incinerate EH G E H E © 2007 Pearson Education F B G H J I F G F B B J C J I C D I D C A A D A
