Schedule Project Schedule includes three major phases RD
- Slides: 4
Schedule • Project Schedule includes three major phases: — R&D Phase: begins in FY 09 and continues to Q 1 -FY 11 — Construction Phase: begins in Q 2 -FY 11 (CD-0) and continues to Q 4 - FY 14 (CD-4) — Operations Phase: 6 years of instrument operations with data analysis followed by an 18 month period after telescope operations have ceased for the completion of the data analysis • 2 year R&D Phase, includes: — Telescope optics design refined and optimized — Prototype of 3 -arm spectrograph fabricated and tested — Fiber positioner prototype further tested and optimized • Note: CD-2 is combined with CD-3 a to accommodate the long lead time required to manufacture the 1. 5 meter secondary mirror

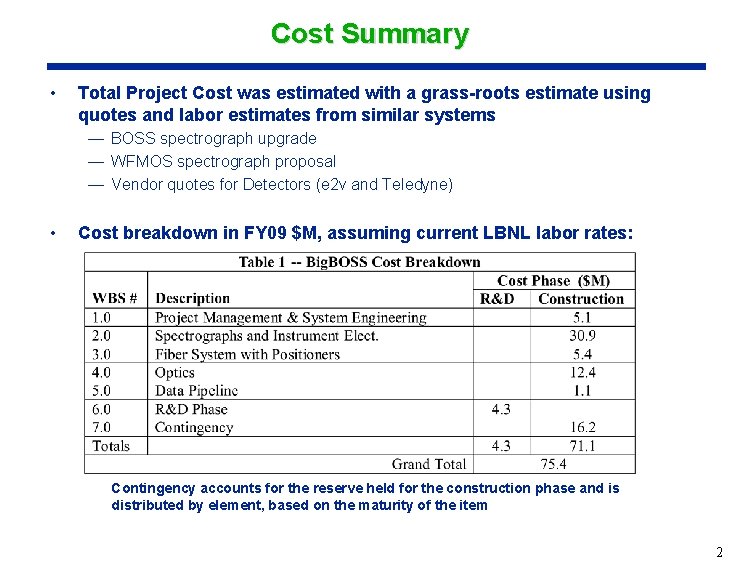

Cost Summary • Total Project Cost was estimated with a grass-roots estimate using quotes and labor estimates from similar systems — BOSS spectrograph upgrade — WFMOS spectrograph proposal — Vendor quotes for Detectors (e 2 v and Teledyne) • Cost breakdown in FY 09 $M, assuming current LBNL labor rates: Contingency accounts for the reserve held for the construction phase and is distributed by element, based on the maturity of the item 2

Top-Level WBS 1. 0 Project Management WBS 2. 0 Spectrographs and Instrument Electronics WBS 3. 0 Fiber System with Positioners WBS 4. 0 Optics $5. 1 M $30. 9 M $5. 4 M $12. 4 M 5 FTEs, $XK M&S X FTEs, $XK M&S 1. 1 Project Management 1. 2 Systems Engineering 2. 1 Structure and Bench 2. 2 Optics 2. 3 Detector Assy 1 2. 4 Detector Assy 2 2. 5 Detector Assy 3 2. 6 Digital Electronics System 3. 1 Fiber Assembly 3. 2 Positioner Assembly 3. 3 Fiber Support Tray More details on next page 4. 1 Upper Mechanical Structure 4. 2 Secondary Mirror 4. 3 Fiber Position Camera Assy 4. 4 Lower Mechanical Structure 4. 5 Cassigrain Cell Assy WBS 7. 0 4. 6 ADC Assy Contingency 4. 7 Focal Plane Assy WBS 5. 0 Data Pipeline WBS 6. 0 R&D Phase $1. 1 M $4. 3 M $16. 2 M X FTEs, $XK M&S 4. 5 FTEs, $550 K M&S N/A 6. 1 Optics Design 6. 2 Spectrograph Prototype 6. 3 Fiber Positioner Prototype 3

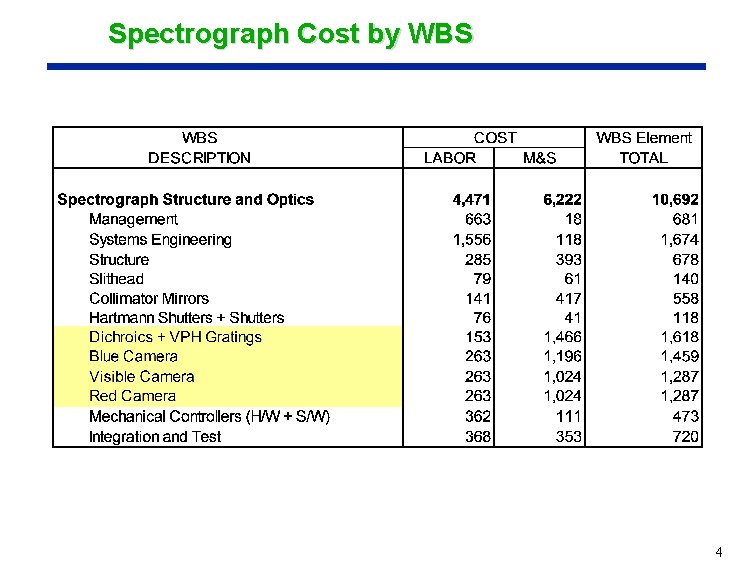

Spectrograph Cost by WBS 4
