Safety System Testing DESCRIPTION OF WORK BEING DONE
Safety System Testing DESCRIPTION OF WORK BEING DONE Can we have a Store? Stash? LOCATION TIME NEEDED # OF KEYS LIST OF PEOPLE GOING IN TUNNEL TEST DATE (including 30 day grace period) Main Injector A 150 CDC YES MI 1 hr All None 5/13/2007 Main Injector P 150 CDC YES MI 1 hr All None 5/13/2007 MI / Tev Crossover ESS No No MI / Tev 1 hr All Interlock Techs 5/13/2007 Tev F Sector ESS No No Tev 2. 5 hr All Interlock Techs 5/13/2007 Main Injector Logic Module YES No MI 1 hr All None 5/17/2007 Recycler CDC YES MI 1 hr All None 5/17/2007 Recycler Coasting CDC No No MI 1. 5 hr All Interlock Techs 5/17/2007 Tev A-E Sector ESS No YES Tev 4. 5 hr All Interlock Techs 5/17/2007 Tev Coasting Beam No YES Tev 1 hr All None 5/17/2007 Tev Logic Module No No Tev 1 hr All None 5/17/2007 Tev Transfer hall Sector ESS No YES Tev 1. 5 hr All Interlock Techs 5/17/2007 Tev B 0 Enclosure ESS No YES Tev/B 0 1. 5 hr All Interlock Techs 5/18/2007 Tev C 0 Enclosure ESS No YES Tev/C 0 1. 5 hr All Interlock Techs 5/18/2007 Booster ESS YES Booster 2 hr All Interlock Techs 5/20/2007 Main Injector ESS YES No MI 5 hr All Interlock Techs 5/20/2007 Tev CDC No YES Tev 1. 5 hr All None 5/25/2007

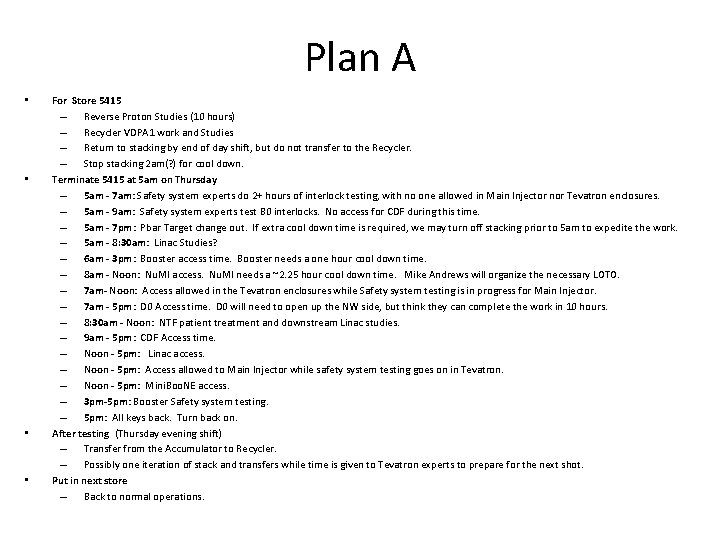

Plan A • • For Store 5415 – Reverse Proton Studies (10 hours) – Recycler VDPA 1 work and Studies – Return to stacking by end of day shift, but do not transfer to the Recycler. – Stop stacking 2 am(? ) for cool down. Terminate 5415 at 5 am on Thursday – 5 am - 7 am: Safety system experts do 2+ hours of interlock testing, with no one allowed in Main Injector nor Tevatron enclosures. – 5 am - 9 am: Safety system experts test B 0 interlocks. No access for CDF during this time. – 5 am - 7 pm: Pbar Target change out. If extra cool down time is required, we may turn off stacking prior to 5 am to expedite the work. – 5 am - 8: 30 am: Linac Studies? – 6 am - 3 pm: Booster access time. Booster needs a one hour cool down time. – 8 am - Noon: Nu. MI access. Nu. MI needs a ~2. 25 hour cool down time. Mike Andrews will organize the necessary LOTO. – 7 am- Noon: Access allowed in the Tevatron enclosures while Safety system testing is in progress for Main Injector. – 7 am - 5 pm: D 0 Access time. D 0 will need to open up the NW side, but think they can complete the work in 10 hours. – 8: 30 am - Noon: NTF patient treatment and downstream Linac studies. – 9 am - 5 pm: CDF Access time. – Noon - 5 pm: Linac access. – Noon - 5 pm: Access allowed to Main Injector while safety system testing goes on in Tevatron. – Noon - 5 pm: Mini. Boo. NE access. – 3 pm-5 pm: Booster Safety system testing. – 5 pm: All keys back. Turn back on. After testing (Thursday evening shift) – Transfer from the Accumulator to Recycler. – Possibly one iteration of stack and transfers while time is given to Tevatron experts to prepare for the next shot. Put in next store – Back to normal operations.
- Slides: 2
