Revised Department of Defense Earned Value Management Policy Deborah A. Tomsic Senior Program Analyst

Revised Department of Defense Earned Value Management Policy Deborah A. Tomsic Senior Program Analyst Office of the Under Secretary of Defense (Acquisition, Technology and Logistics) Acquisition Resources and Analysis May 3, 2005

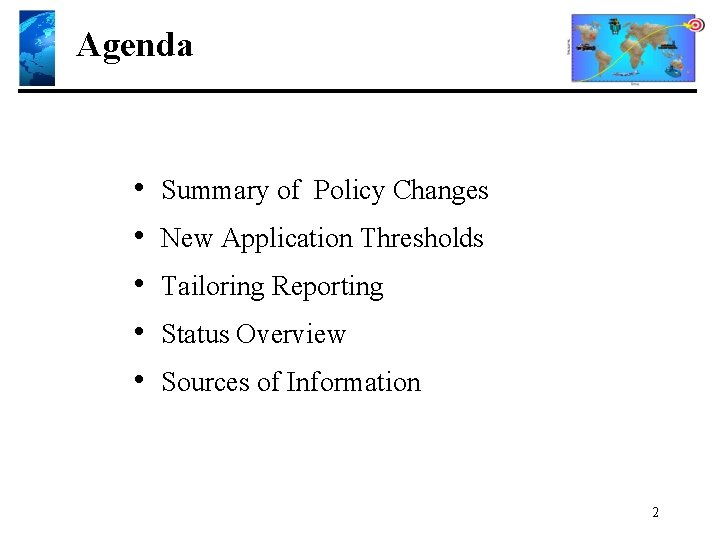

Agenda • • • Summary of Policy Changes New Application Thresholds Tailoring Reporting Status

Agenda • • • Summary of Policy Changes New Application Thresholds Tailoring Reporting Status Overview Sources of Information 2

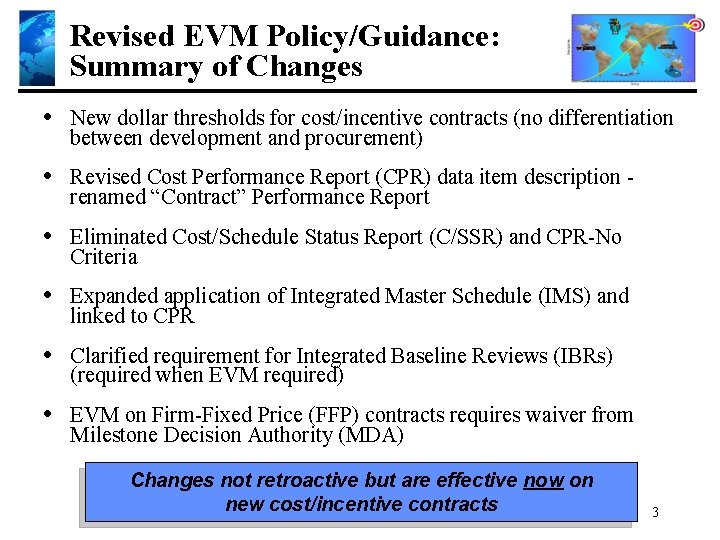

Revised EVM Policy/Guidance: Summary of Changes • New dollar thresholds for cost/incentive contracts (no

Revised EVM Policy/Guidance: Summary of Changes • New dollar thresholds for cost/incentive contracts (no differentiation between development and procurement) • Revised Cost Performance Report (CPR) data item description renamed “Contract” Performance Report • Eliminated Cost/Schedule Status Report (C/SSR) and CPR-No Criteria • Expanded application of Integrated Master Schedule (IMS) and linked to CPR • Clarified requirement for Integrated Baseline Reviews (IBRs) (required when EVM required) • EVM on Firm-Fixed Price (FFP) contracts requires waiver from Milestone Decision Authority (MDA) Changes not retroactive but are effective now on new cost/incentive contracts 3

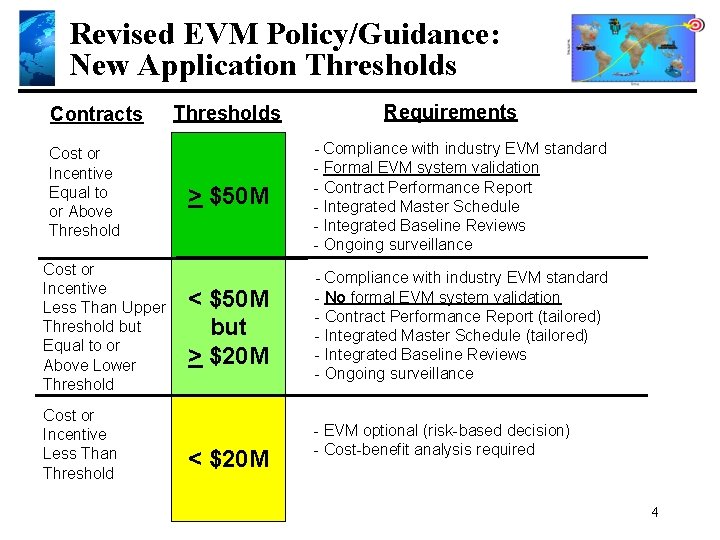

Revised EVM Policy/Guidance: New Application Thresholds Contracts Cost or Incentive Equal to or Above

Revised EVM Policy/Guidance: New Application Thresholds Contracts Cost or Incentive Equal to or Above Threshold Cost or Incentive Less Than Upper Threshold but Equal to or Above Lower Threshold Cost or Incentive Less Than Thresholds Requirements > $50 M - Compliance with industry EVM standard - Formal EVM system validation - Contract Performance Report - Integrated Master Schedule - Integrated Baseline Reviews - Ongoing surveillance < $50 M but > $20 M - Compliance with industry EVM standard - No formal EVM system validation - Contract Performance Report (tailored) - Integrated Master Schedule (tailored) - Integrated Baseline Reviews - Ongoing surveillance < $20 M - EVM optional (risk-based decision) - Cost-benefit analysis required 4

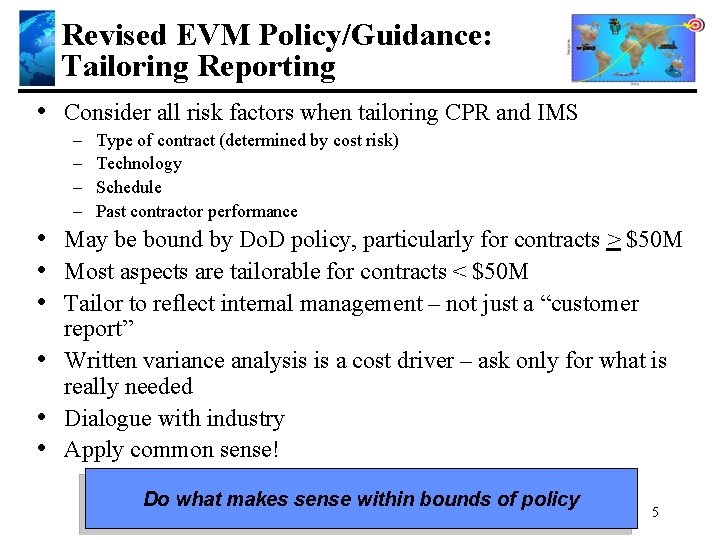

Revised EVM Policy/Guidance: Tailoring Reporting • Consider all risk factors when tailoring CPR and

Revised EVM Policy/Guidance: Tailoring Reporting • Consider all risk factors when tailoring CPR and IMS – – Type of contract (determined by cost risk) Technology Schedule Past contractor performance • May be bound by Do. D policy, particularly for contracts > $50 M • Most aspects are tailorable for contracts < $50 M • Tailor to reflect internal management – not just a “customer • • • report” Written variance analysis is a cost driver – ask only for what is really needed Dialogue with industry Apply common sense! Do what makes sense within bounds of policy 5

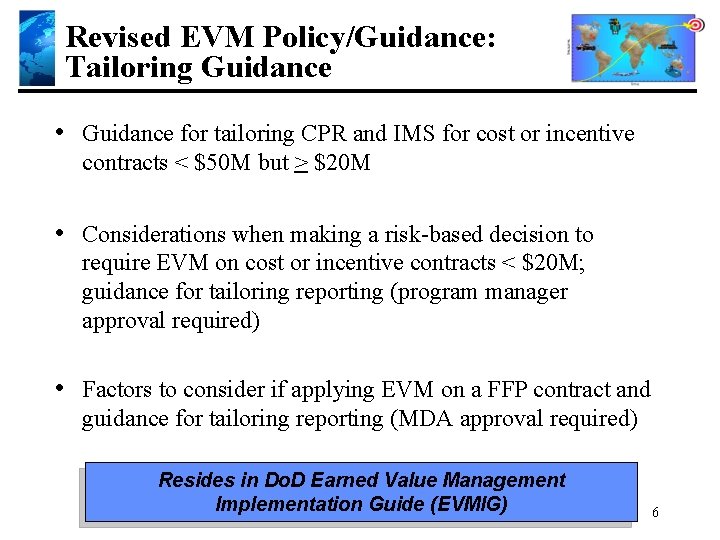

Revised EVM Policy/Guidance: Tailoring Guidance • Guidance for tailoring CPR and IMS for cost

Revised EVM Policy/Guidance: Tailoring Guidance • Guidance for tailoring CPR and IMS for cost or incentive contracts < $50 M but > $20 M • Considerations when making a risk-based decision to require EVM on cost or incentive contracts < $20 M; guidance for tailoring reporting (program manager approval required) • Factors to consider if applying EVM on a FFP contract and guidance for tailoring reporting (MDA approval required) Resides in Do. D Earned Value Management Implementation Guide (EVMIG) 6

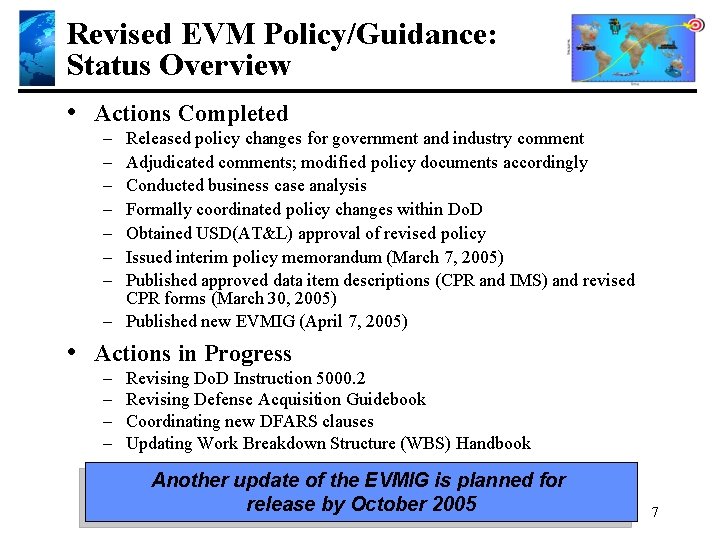

Revised EVM Policy/Guidance: Status Overview • Actions Completed – – – – Released policy

Revised EVM Policy/Guidance: Status Overview • Actions Completed – – – – Released policy changes for government and industry comment Adjudicated comments; modified policy documents accordingly Conducted business case analysis Formally coordinated policy changes within Do. D Obtained USD(AT&L) approval of revised policy Issued interim policy memorandum (March 7, 2005) Published approved data item descriptions (CPR and IMS) and revised CPR forms (March 30, 2005) – Published new EVMIG (April 7, 2005) • Actions in Progress – – Revising Do. D Instruction 5000. 2 Revising Defense Acquisition Guidebook Coordinating new DFARS clauses Updating Work Breakdown Structure (WBS) Handbook Another update of the EVMIG is planned for release by October 2005 7

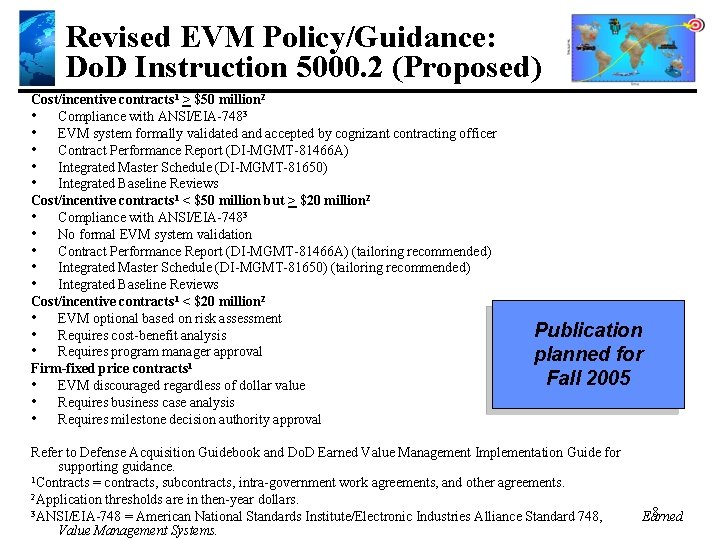

Revised EVM Policy/Guidance: Do. D Instruction 5000. 2 (Proposed) Cost/incentive contracts 1 > $50

Revised EVM Policy/Guidance: Do. D Instruction 5000. 2 (Proposed) Cost/incentive contracts 1 > $50 million 2 • Compliance with ANSI/EIA-7483 • EVM system formally validated and accepted by cognizant contracting officer • Contract Performance Report (DI-MGMT-81466 A) • Integrated Master Schedule (DI-MGMT-81650) • Integrated Baseline Reviews Cost/incentive contracts 1 < $50 million but > $20 million 2 • Compliance with ANSI/EIA-7483 • No formal EVM system validation • Contract Performance Report (DI-MGMT-81466 A) (tailoring recommended) • Integrated Master Schedule (DI-MGMT-81650) (tailoring recommended) • Integrated Baseline Reviews Cost/incentive contracts 1 < $20 million 2 • EVM optional based on risk assessment • Requires cost-benefit analysis • Requires program manager approval Firm-fixed price contracts 1 • EVM discouraged regardless of dollar value • Requires business case analysis • Requires milestone decision authority approval Publication planned for Fall 2005 Refer to Defense Acquisition Guidebook and Do. D Earned Value Management Implementation Guide for supporting guidance. 1 Contracts = contracts, subcontracts, intra-government work agreements, and other agreements. 2 Application thresholds are in then-year dollars. 3 ANSI/EIA-748 = American National Standards Institute/Electronic Industries Alliance Standard 748, Value Management Systems. 8 Earned

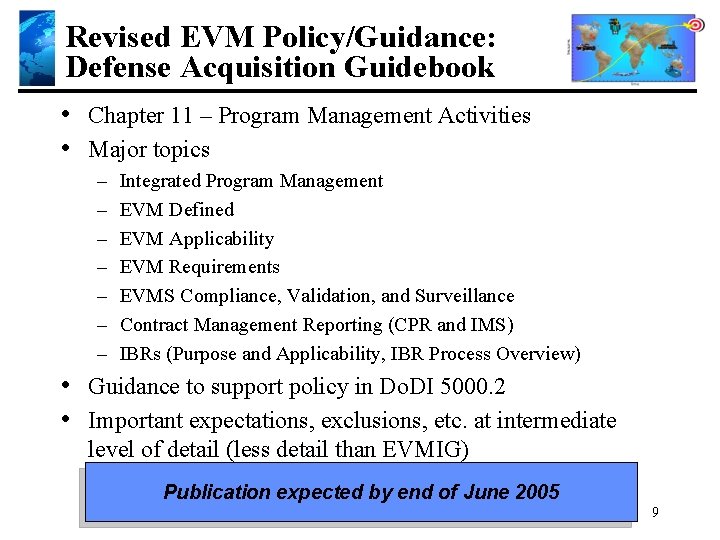

Revised EVM Policy/Guidance: Defense Acquisition Guidebook • Chapter 11 – Program Management Activities •

Revised EVM Policy/Guidance: Defense Acquisition Guidebook • Chapter 11 – Program Management Activities • Major topics – – – – Integrated Program Management EVM Defined EVM Applicability EVM Requirements EVMS Compliance, Validation, and Surveillance Contract Management Reporting (CPR and IMS) IBRs (Purpose and Applicability, IBR Process Overview) • Guidance to support policy in Do. DI 5000. 2 • Important expectations, exclusions, etc. at intermediate level of detail (less detail than EVMIG) Publication expected by end of June 2005 9

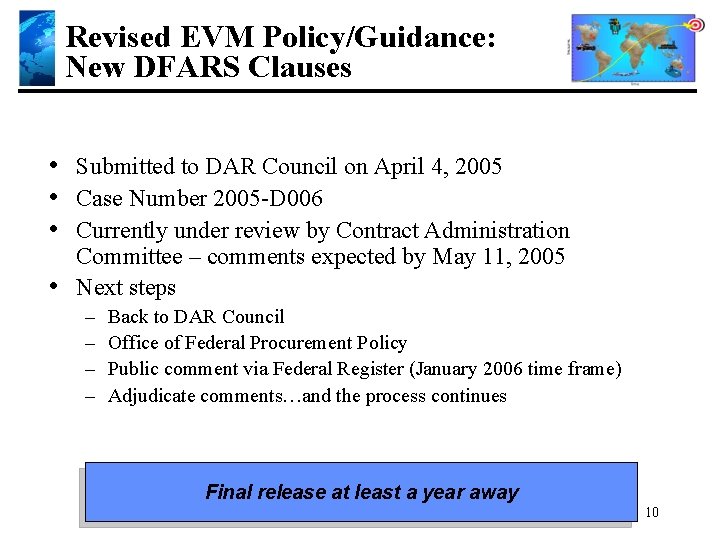

Revised EVM Policy/Guidance: New DFARS Clauses • Submitted to DAR Council on April 4,

Revised EVM Policy/Guidance: New DFARS Clauses • Submitted to DAR Council on April 4, 2005 • Case Number 2005 -D 006 • Currently under review by Contract Administration • Committee – comments expected by May 11, 2005 Next steps – – Back to DAR Council Office of Federal Procurement Policy Public comment via Federal Register (January 2006 time frame) Adjudicate comments…and the process continues Final release at least a year away 10

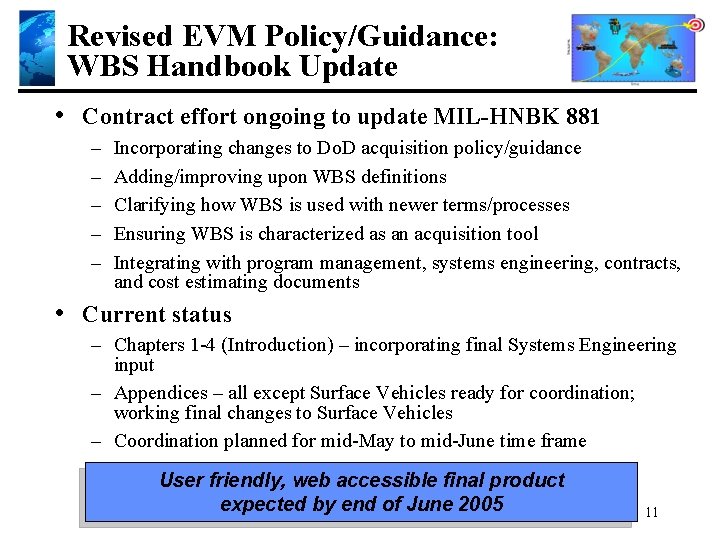

Revised EVM Policy/Guidance: WBS Handbook Update • Contract effort ongoing to update MIL-HNBK 881

Revised EVM Policy/Guidance: WBS Handbook Update • Contract effort ongoing to update MIL-HNBK 881 – – – Incorporating changes to Do. D acquisition policy/guidance Adding/improving upon WBS definitions Clarifying how WBS is used with newer terms/processes Ensuring WBS is characterized as an acquisition tool Integrating with program management, systems engineering, contracts, and cost estimating documents • Current status – Chapters 1 -4 (Introduction) – incorporating final Systems Engineering input – Appendices – all except Surface Vehicles ready for coordination; working final changes to Surface Vehicles – Coordination planned for mid-May to mid-June time frame User friendly, web accessible final product expected by end of June 2005 11

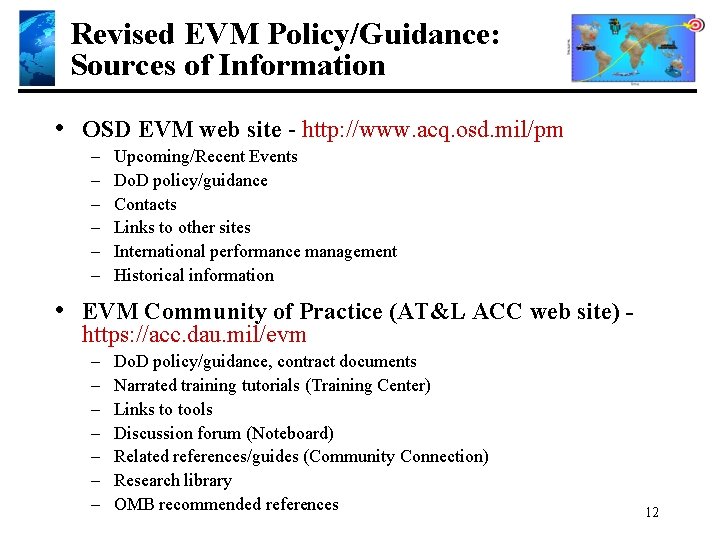

Revised EVM Policy/Guidance: Sources of Information • OSD EVM web site - http: //www.

Revised EVM Policy/Guidance: Sources of Information • OSD EVM web site - http: //www. acq. osd. mil/pm – – – Upcoming/Recent Events Do. D policy/guidance Contacts Links to other sites International performance management Historical information • EVM Community of Practice (AT&L ACC web site) https: //acc. dau. mil/evm – – – – Do. D policy/guidance, contract documents Narrated training tutorials (Training Center) Links to tools Discussion forum (Noteboard) Related references/guides (Community Connection) Research library OMB recommended references 12

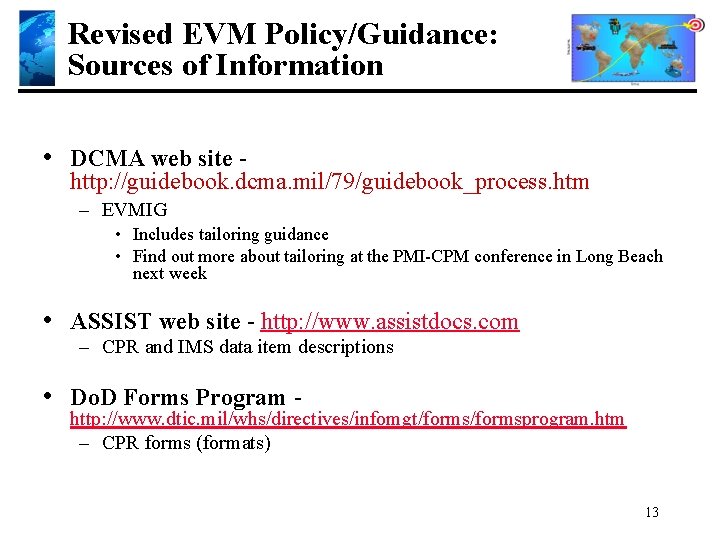

Revised EVM Policy/Guidance: Sources of Information • DCMA web site - http: //guidebook. dcma.

Revised EVM Policy/Guidance: Sources of Information • DCMA web site - http: //guidebook. dcma. mil/79/guidebook_process. htm – EVMIG • Includes tailoring guidance • Find out more about tailoring at the PMI-CPM conference in Long Beach next week • ASSIST web site - http: //www. assistdocs. com – CPR and IMS data item descriptions • Do. D Forms Program - http: //www. dtic. mil/whs/directives/infomgt/formsprogram. htm – CPR forms (formats) 13

Closing Thoughts • OSD continues to make EVM a priority and plans to stay

Closing Thoughts • OSD continues to make EVM a priority and plans to stay actively engaged • EVM working groups will continue to work issues, share improvement ideas, and recommend and implement solutions • Goal = to ensure performance management processes are effective, consistent, and reflective of industry best practice Working together is the key to success! 14

Back-Up Slides 15

Back-Up Slides 15

Impetus for Change • Contemporary EVM is the product of a technique formalized by

Impetus for Change • Contemporary EVM is the product of a technique formalized by Do. D in the 1960 s • Cost/Schedule Control Systems Criteria (C/SCSC) used in Do. D for more than 35 years – 35 criteria (Do. D 5000 series) – Government ownership – Financial orientation – a cost reporting tool • 1996 - Transitioned from C/SCSC to EVM – 32 guidelines (ANSI/EIA-748) – Industry ownership – Program management orientation – an integrated management tool • 2003 - Concerns raised by industry and Do. D and presented to Defense Acquisition Excellence Council (DAEC) • OSD actions in response to concerns – Established EVM working groups – Developed revised EVM policy 16

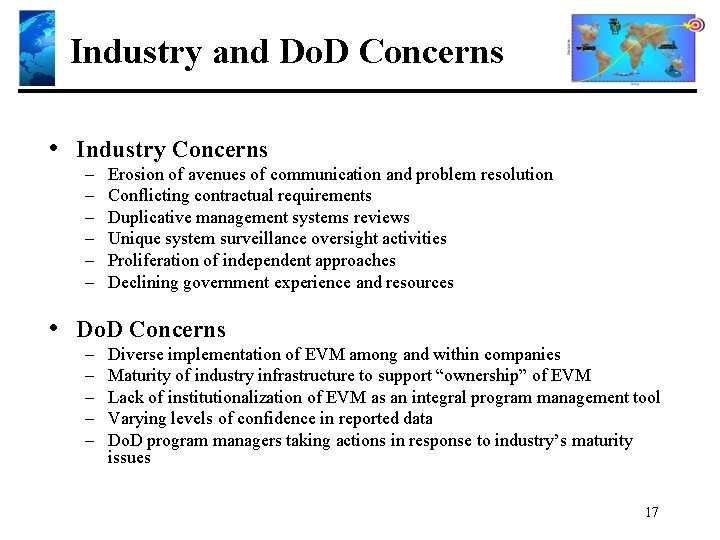

Industry and Do. D Concerns • Industry Concerns – – – Erosion of avenues

Industry and Do. D Concerns • Industry Concerns – – – Erosion of avenues of communication and problem resolution Conflicting contractual requirements Duplicative management systems reviews Unique system surveillance oversight activities Proliferation of independent approaches Declining government experience and resources • Do. D Concerns – – – Diverse implementation of EVM among and within companies Maturity of industry infrastructure to support “ownership” of EVM Lack of institutionalization of EVM as an integral program management tool Varying levels of confidence in reported data Do. D program managers taking actions in response to industry’s maturity issues 17

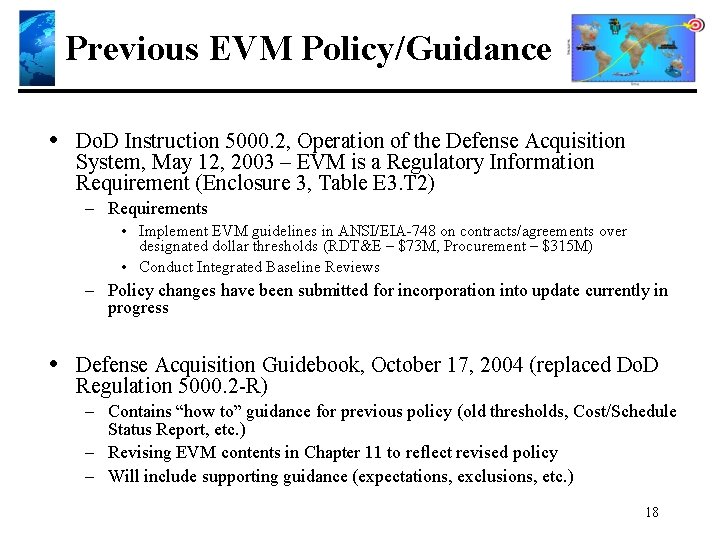

Previous EVM Policy/Guidance • Do. D Instruction 5000. 2, Operation of the Defense Acquisition

Previous EVM Policy/Guidance • Do. D Instruction 5000. 2, Operation of the Defense Acquisition System, May 12, 2003 – EVM is a Regulatory Information Requirement (Enclosure 3, Table E 3. T 2) – Requirements • Implement EVM guidelines in ANSI/EIA-748 on contracts/agreements over designated dollar thresholds (RDT&E – $73 M, Procurement – $315 M) • Conduct Integrated Baseline Reviews – Policy changes have been submitted for incorporation into update currently in progress • Defense Acquisition Guidebook, October 17, 2004 (replaced Do. D Regulation 5000. 2 -R) – Contains “how to” guidance for previous policy (old thresholds, Cost/Schedule Status Report, etc. ) – Revising EVM contents in Chapter 11 to reflect revised policy – Will include supporting guidance (expectations, exclusions, etc. ) 18

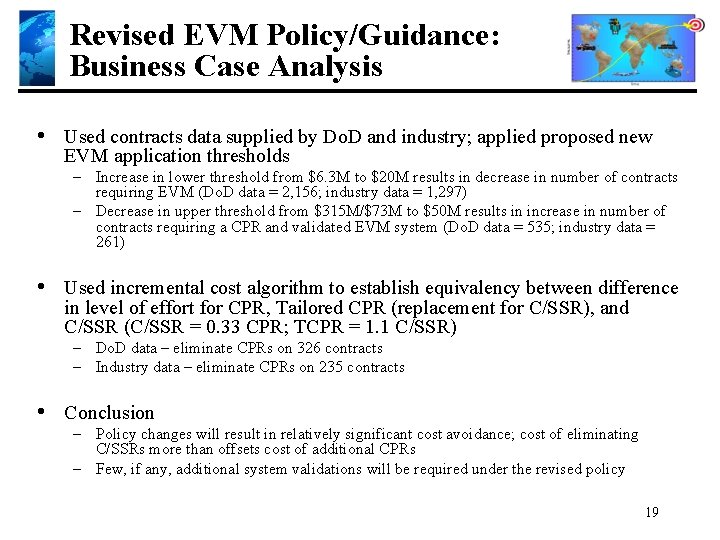

Revised EVM Policy/Guidance: Business Case Analysis • Used contracts data supplied by Do. D

Revised EVM Policy/Guidance: Business Case Analysis • Used contracts data supplied by Do. D and industry; applied proposed new EVM application thresholds – Increase in lower threshold from $6. 3 M to $20 M results in decrease in number of contracts requiring EVM (Do. D data = 2, 156; industry data = 1, 297) – Decrease in upper threshold from $315 M/$73 M to $50 M results in increase in number of contracts requiring a CPR and validated EVM system (Do. D data = 535; industry data = 261) • Used incremental cost algorithm to establish equivalency between difference in level of effort for CPR, Tailored CPR (replacement for C/SSR), and C/SSR (C/SSR = 0. 33 CPR; TCPR = 1. 1 C/SSR) – Do. D data – eliminate CPRs on 326 contracts – Industry data – eliminate CPRs on 235 contracts • Conclusion – Policy changes will result in relatively significant cost avoidance; cost of eliminating C/SSRs more than offsets cost of additional CPRs – Few, if any, additional system validations will be required under the revised policy 19
