Purple Line Steering Committee MTJV Progress Update Target

  • Slides: 47
Download presentation

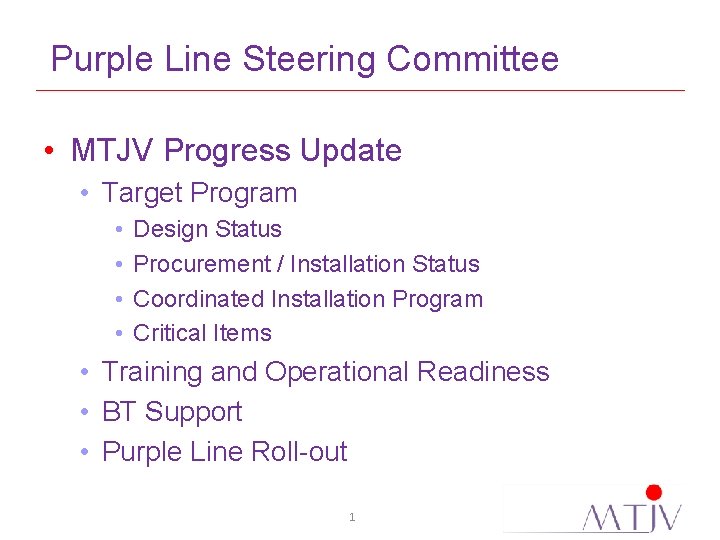

Purple Line Steering Committee • MTJV Progress Update • Target Program • • Design

Purple Line Steering Committee • MTJV Progress Update • Target Program • • Design Status Procurement / Installation Status Coordinated Installation Program Critical Items • Training and Operational Readiness • BT Support • Purple Line Roll-out 1

Purple Line Steering Committee • Target Program • Design Status • First submission Definitive

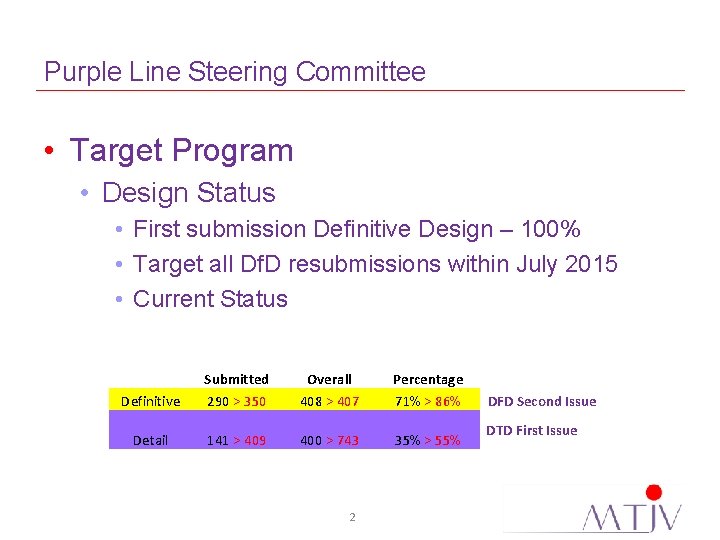

Purple Line Steering Committee • Target Program • Design Status • First submission Definitive Design – 100% • Target all Df. D resubmissions within July 2015 • Current Status Definitive Submitted 290 > 350 Overall 408 > 407 Percentage 71% > 86% Detail 141 > 409 400 > 743 35% > 55% 2 DFD Second Issue DTD First Issue

Purple Line Steering Committee • Target Program • Design Status Sub-System AFC COM SIM

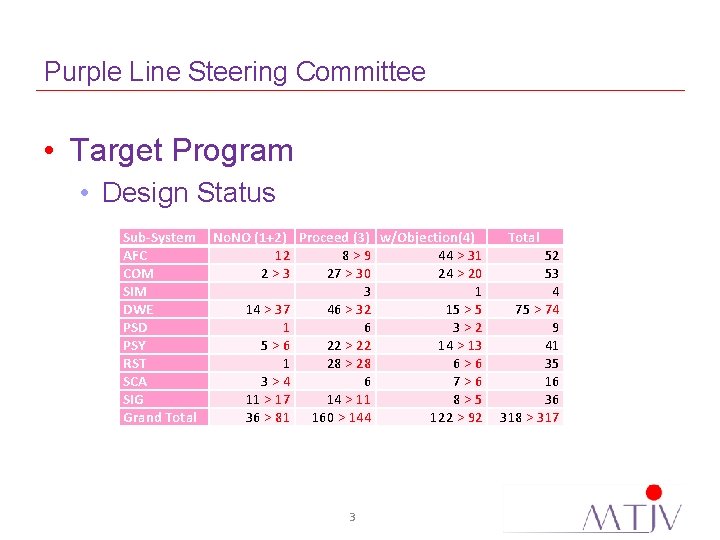

Purple Line Steering Committee • Target Program • Design Status Sub-System AFC COM SIM DWE PSD PSY RST SCA SIG Grand Total No. NO (1+2) Proceed (3) w/Objection(4) 12 8>9 44 > 31 2>3 27 > 30 24 > 20 3 1 14 > 37 46 > 32 15 > 5 1 6 3>2 5>6 22 > 22 14 > 13 1 28 > 28 6>6 3>4 6 7>6 11 > 17 14 > 11 8>5 36 > 81 160 > 144 122 > 92 3 Total 52 53 4 75 > 74 9 41 35 16 36 318 > 317

Purple Line Steering Committee • Target Program • Design Status • System Assurance Sub-System

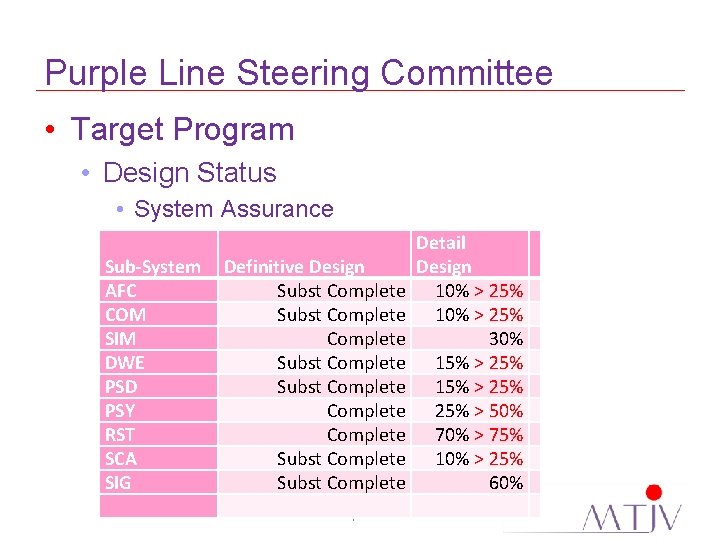

Purple Line Steering Committee • Target Program • Design Status • System Assurance Sub-System AFC COM SIM DWE PSD PSY RST SCA SIG Definitive Design Subst Complete Complete Subst Complete 4 Detail Design 10% > 25% 30% 15% > 25% 25% > 50% 70% > 75% 10% > 25% 60%

Purple Line Steering Committee • Target Program – Procurement Status • Concerns • Rolling

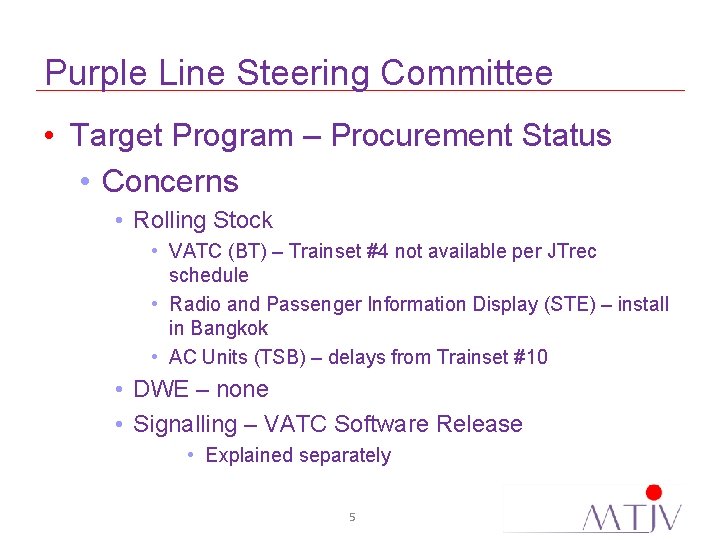

Purple Line Steering Committee • Target Program – Procurement Status • Concerns • Rolling Stock • VATC (BT) – Trainset #4 not available per JTrec schedule • Radio and Passenger Information Display (STE) – install in Bangkok • AC Units (TSB) – delays from Trainset #10 • DWE – none • Signalling – VATC Software Release • Explained separately 5

Purple Line Steering Committee • Target Program – Procurement Status • Concerns • STE

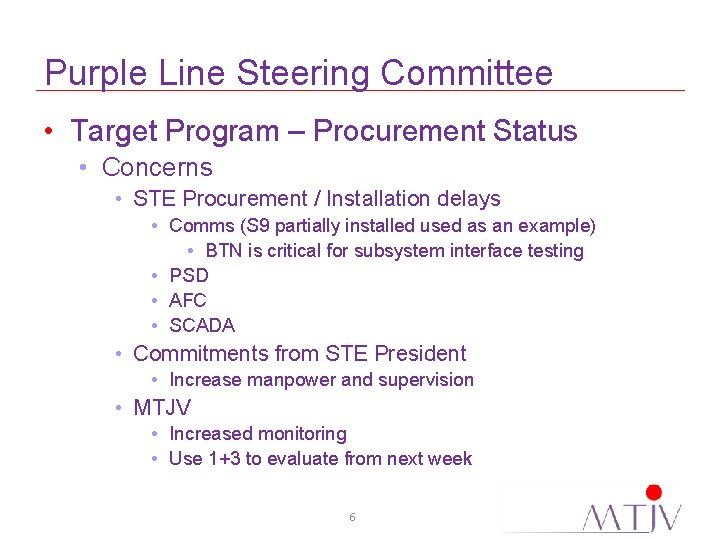

Purple Line Steering Committee • Target Program – Procurement Status • Concerns • STE Procurement / Installation delays • Comms (S 9 partially installed used as an example) • BTN is critical for subsystem interface testing • PSD • AFC • SCADA • Commitments from STE President • Increase manpower and supervision • MTJV • Increased monitoring • Use 1+3 to evaluate from next week 6

Purple Line Steering Committee • Target Program – CIP • Installation • HSE (Site)

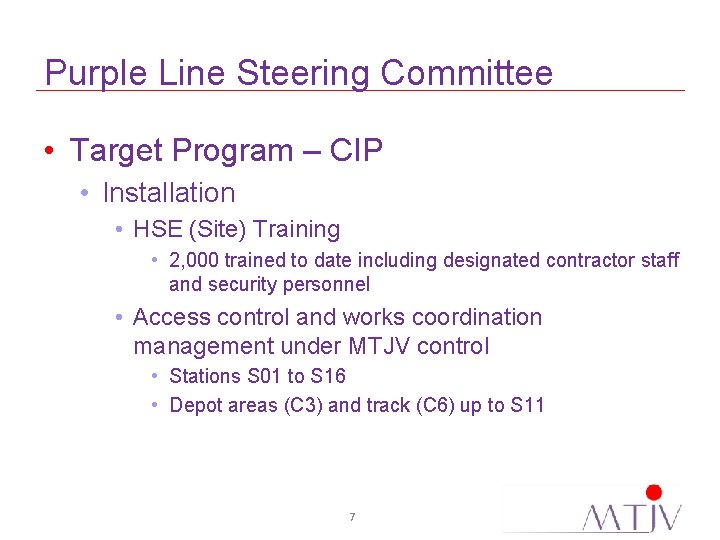

Purple Line Steering Committee • Target Program – CIP • Installation • HSE (Site) Training • 2, 000 trained to date including designated contractor staff and security personnel • Access control and works coordination management under MTJV control • Stations S 01 to S 16 • Depot areas (C 3) and track (C 6) up to S 11 7

Purple Line Steering Committee • Target Program – CIP • Overview – highlights •

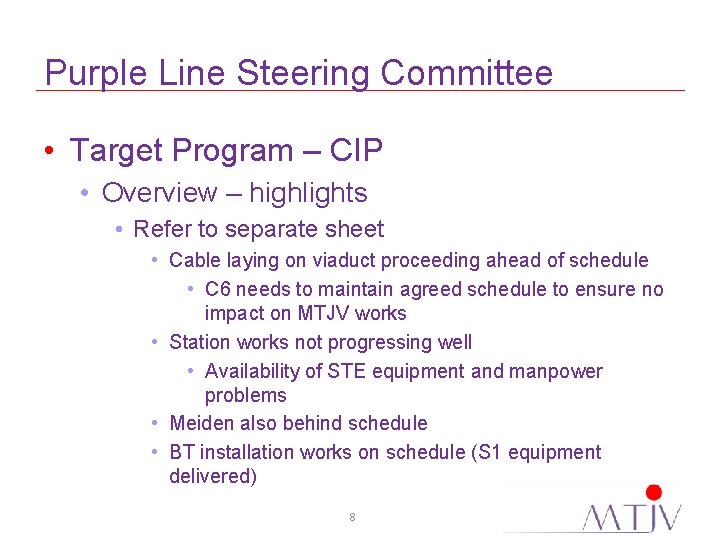

Purple Line Steering Committee • Target Program – CIP • Overview – highlights • Refer to separate sheet • Cable laying on viaduct proceeding ahead of schedule • C 6 needs to maintain agreed schedule to ensure no impact on MTJV works • Station works not progressing well • Availability of STE equipment and manpower problems • Meiden also behind schedule • BT installation works on schedule (S 1 equipment delivered) 8

Purple Line Steering Committee • Target Program – CIP • Overview – highlights •

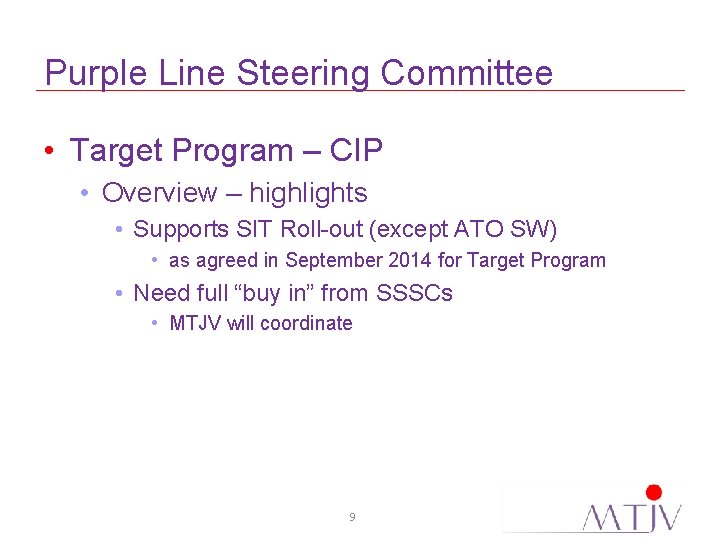

Purple Line Steering Committee • Target Program – CIP • Overview – highlights • Supports SIT Roll-out (except ATO SW) • as agreed in September 2014 for Target Program • Need full “buy in” from SSSCs • MTJV will coordinate 9

Purple Line Steering Committee • Target Program • Critical Items General • Design submission

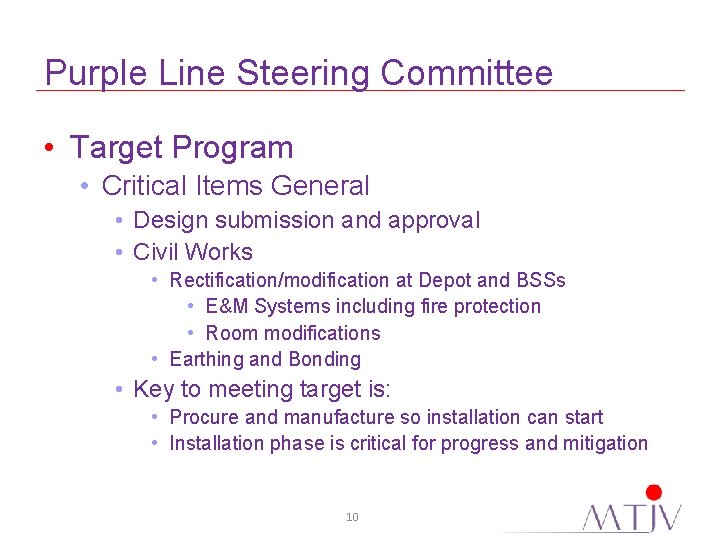

Purple Line Steering Committee • Target Program • Critical Items General • Design submission and approval • Civil Works • Rectification/modification at Depot and BSSs • E&M Systems including fire protection • Room modifications • Earthing and Bonding • Key to meeting target is: • Procure and manufacture so installation can start • Installation phase is critical for progress and mitigation 10

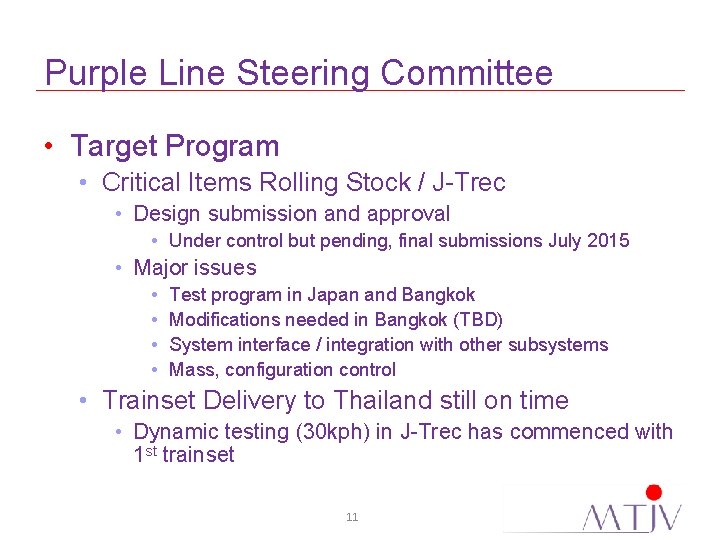

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock / J-Trec

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock / J-Trec • Design submission and approval • Under control but pending, final submissions July 2015 • Major issues • • Test program in Japan and Bangkok Modifications needed in Bangkok (TBD) System interface / integration with other subsystems Mass, configuration control • Trainset Delivery to Thailand still on time • Dynamic testing (30 kph) in J-Trec has commenced with 1 st trainset 11

Purple Line Steering Committee 12

Purple Line Steering Committee 12

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock • Carbody

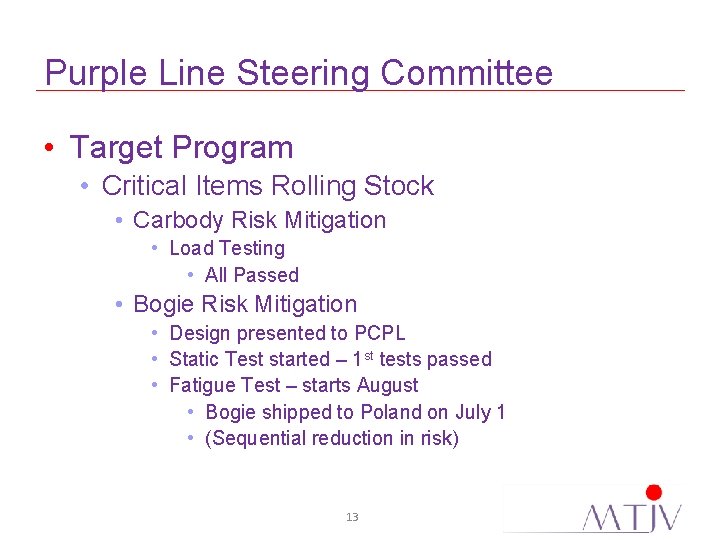

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock • Carbody Risk Mitigation • Load Testing • All Passed • Bogie Risk Mitigation • Design presented to PCPL • Static Test started – 1 st tests passed • Fatigue Test – starts August • Bogie shipped to Poland on July 1 • (Sequential reduction in risk) 13

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock • Testing

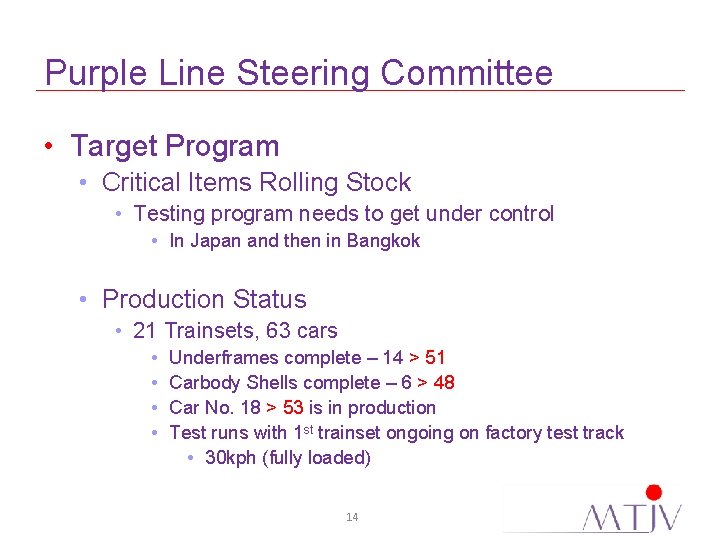

Purple Line Steering Committee • Target Program • Critical Items Rolling Stock • Testing program needs to get under control • In Japan and then in Bangkok • Production Status • 21 Trainsets, 63 cars • • Underframes complete – 14 > 51 Carbody Shells complete – 6 > 48 Car No. 18 > 53 is in production Test runs with 1 st trainset ongoing on factory test track • 30 kph (fully loaded) 14

Purple Line Steering Committee • J-TREC (Improvements) - implemented • Systematic Approach to manage

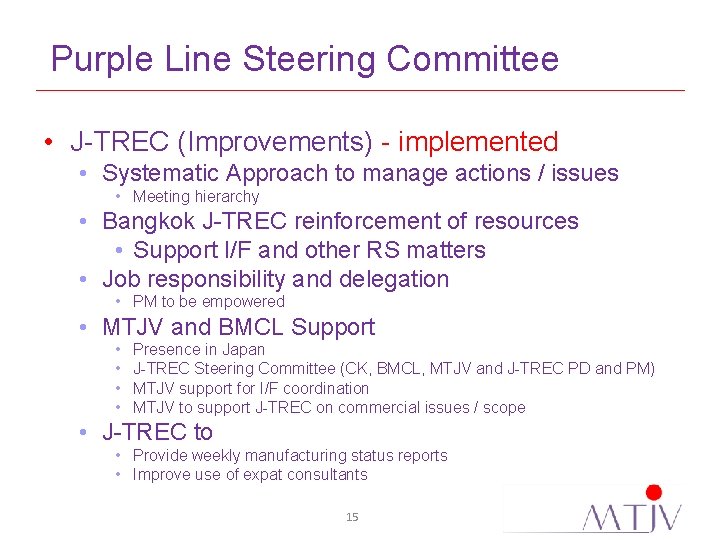

Purple Line Steering Committee • J-TREC (Improvements) - implemented • Systematic Approach to manage actions / issues • Meeting hierarchy • Bangkok J-TREC reinforcement of resources • Support I/F and other RS matters • Job responsibility and delegation • PM to be empowered • MTJV and BMCL Support • • Presence in Japan J-TREC Steering Committee (CK, BMCL, MTJV and J-TREC PD and PM) MTJV support for I/F coordination MTJV to support J-TREC on commercial issues / scope • J-TREC to • Provide weekly manufacturing status reports • Improve use of expat consultants 15

Purple Line Steering Committee • J-TREC (MTJV Actions) - implemented • MTJV PM Monthly

Purple Line Steering Committee • J-TREC (MTJV Actions) - implemented • MTJV PM Monthly Trips to J-TREC • Support J-TREC PM • Implement • management philosophy • suggested improvements • MTJV Subsystem Team • Monthly trips (or more) to J-TREC (overlap PM trips) • Maintain consistent approach as PM • Solve problems on site with J-TREC and BMCL (Re-evaluate above plan once program is stable) 16

Purple Line Steering Committee • J-TREC (Problems remain) • Consultants not available full time

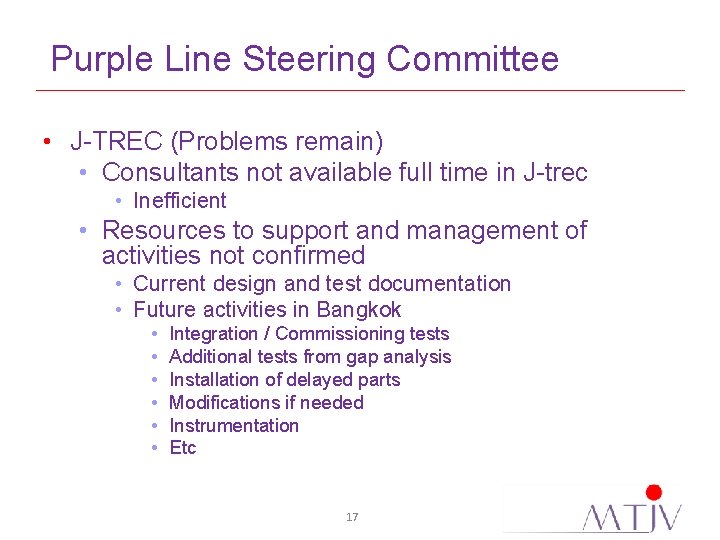

Purple Line Steering Committee • J-TREC (Problems remain) • Consultants not available full time in J-trec • Inefficient • Resources to support and management of activities not confirmed • Current design and test documentation • Future activities in Bangkok • • • Integration / Commissioning tests Additional tests from gap analysis Installation of delayed parts Modifications if needed Instrumentation Etc 17

Purple Line Steering Committee • Target Program • Critical Items Power • Design submission

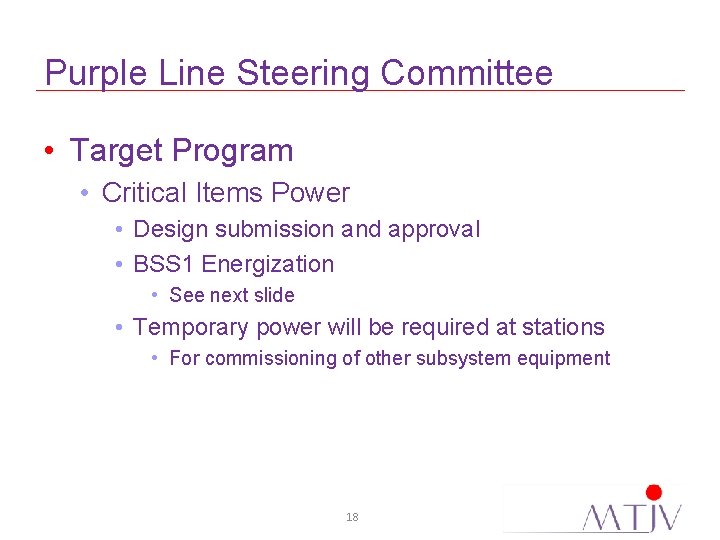

Purple Line Steering Committee • Target Program • Critical Items Power • Design submission and approval • BSS 1 Energization • See next slide • Temporary power will be required at stations • For commissioning of other subsystem equipment 18

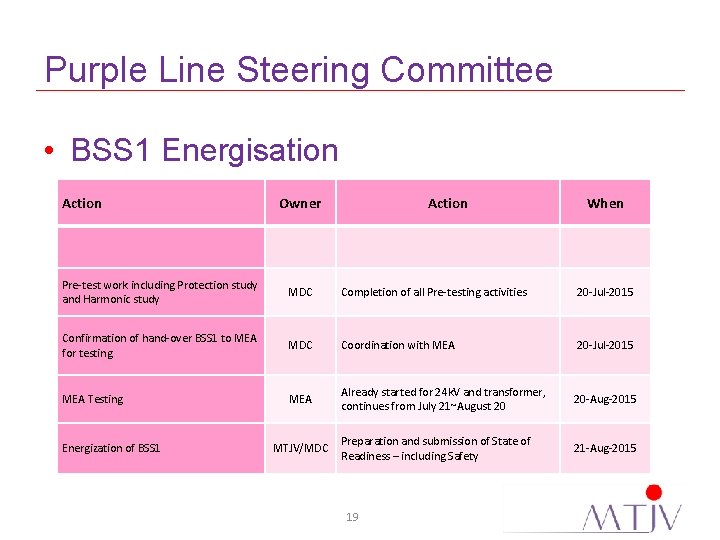

Purple Line Steering Committee • BSS 1 Energisation Action Owner Action When Pre-test work

Purple Line Steering Committee • BSS 1 Energisation Action Owner Action When Pre-test work including Protection study and Harmonic study MDC Completion of all Pre-testing activities 20 -Jul-2015 Confirmation of hand-over BSS 1 to MEA for testing MDC Coordination with MEA 20 -Jul-2015 MEA Testing MEA Already started for 24 k. V and transformer, continues from July 21~August 20 20 -Aug-2015 Preparation and submission of State of Readiness – including Safety 21 -Aug-2015 Energization of BSS 1 MTJV/MDC 19

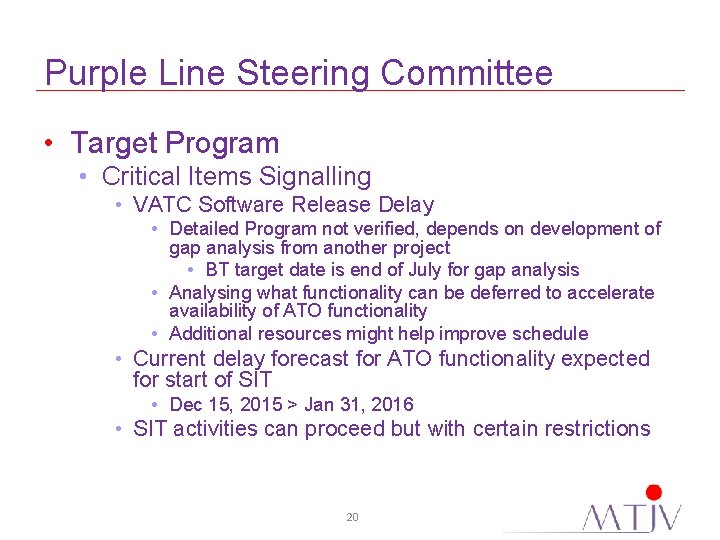

Purple Line Steering Committee • Target Program • Critical Items Signalling • VATC Software

Purple Line Steering Committee • Target Program • Critical Items Signalling • VATC Software Release Delay • Detailed Program not verified, depends on development of gap analysis from another project • BT target date is end of July for gap analysis • Analysing what functionality can be deferred to accelerate availability of ATO functionality • Additional resources might help improve schedule • Current delay forecast for ATO functionality expected for start of SIT • Dec 15, 2015 > Jan 31, 2016 • SIT activities can proceed but with certain restrictions 20

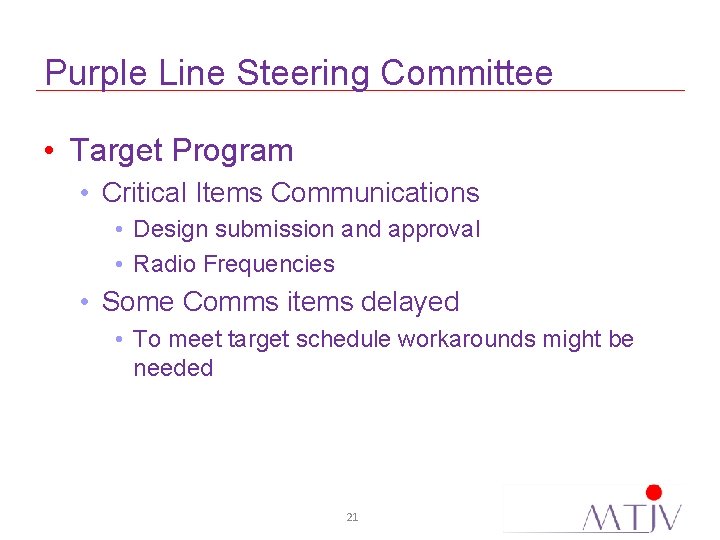

Purple Line Steering Committee • Target Program • Critical Items Communications • Design submission

Purple Line Steering Committee • Target Program • Critical Items Communications • Design submission and approval • Radio Frequencies • Some Comms items delayed • To meet target schedule workarounds might be needed 21

Purple Line Steering Committee • Target Program • Critical Items Platform Screen Doors •

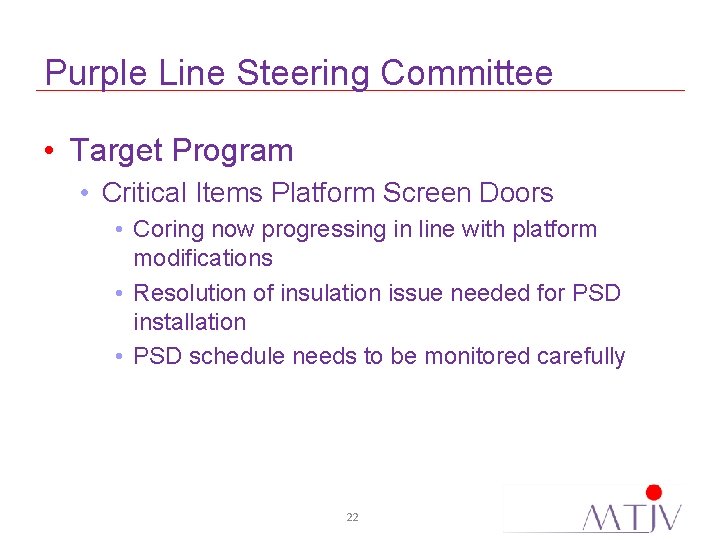

Purple Line Steering Committee • Target Program • Critical Items Platform Screen Doors • Coring now progressing in line with platform modifications • Resolution of insulation issue needed for PSD installation • PSD schedule needs to be monitored carefully 22

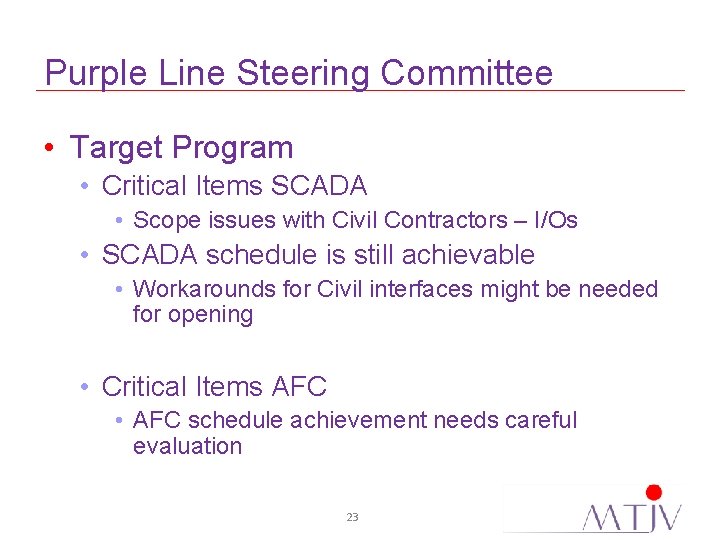

Purple Line Steering Committee • Target Program • Critical Items SCADA • Scope issues

Purple Line Steering Committee • Target Program • Critical Items SCADA • Scope issues with Civil Contractors – I/Os • SCADA schedule is still achievable • Workarounds for Civil interfaces might be needed for opening • Critical Items AFC • AFC schedule achievement needs careful evaluation 23

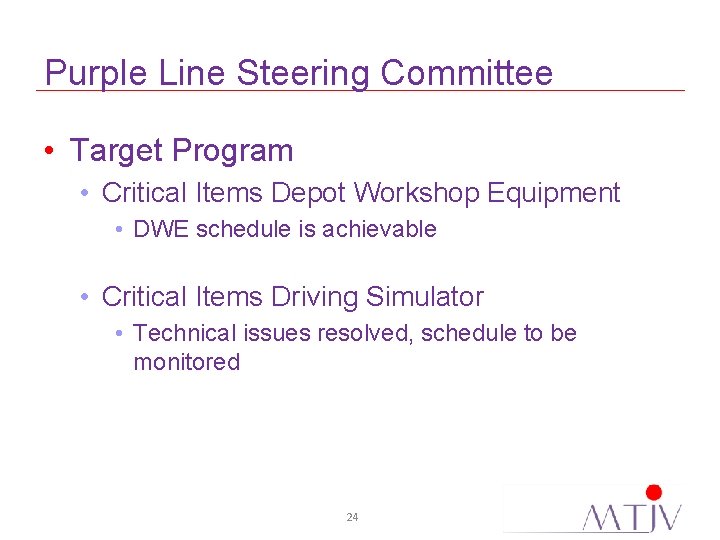

Purple Line Steering Committee • Target Program • Critical Items Depot Workshop Equipment •

Purple Line Steering Committee • Target Program • Critical Items Depot Workshop Equipment • DWE schedule is achievable • Critical Items Driving Simulator • Technical issues resolved, schedule to be monitored 24

Purple Line Steering Committee • Training and Operational Readiness • Operational Readiness Steering Committee

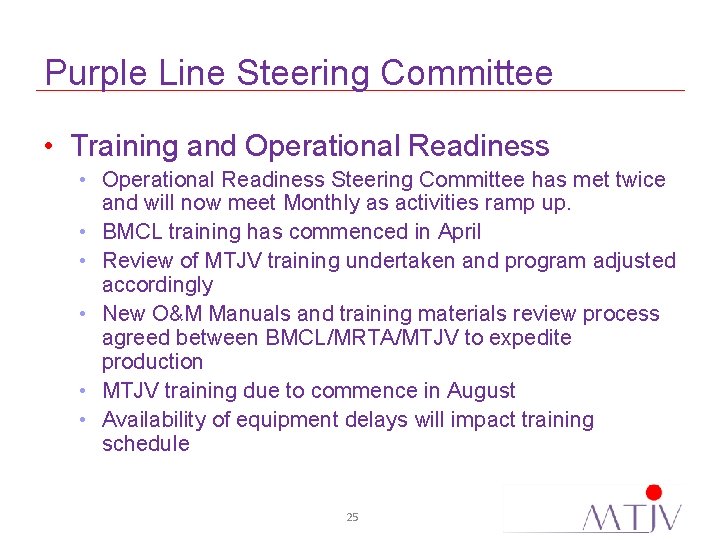

Purple Line Steering Committee • Training and Operational Readiness • Operational Readiness Steering Committee has met twice and will now meet Monthly as activities ramp up. • BMCL training has commenced in April • Review of MTJV training undertaken and program adjusted accordingly • New O&M Manuals and training materials review process agreed between BMCL/MRTA/MTJV to expedite production • MTJV training due to commence in August • Availability of equipment delays will impact training schedule 25

Purple Line Steering Committee • BT Support • System Integration and Interface • David

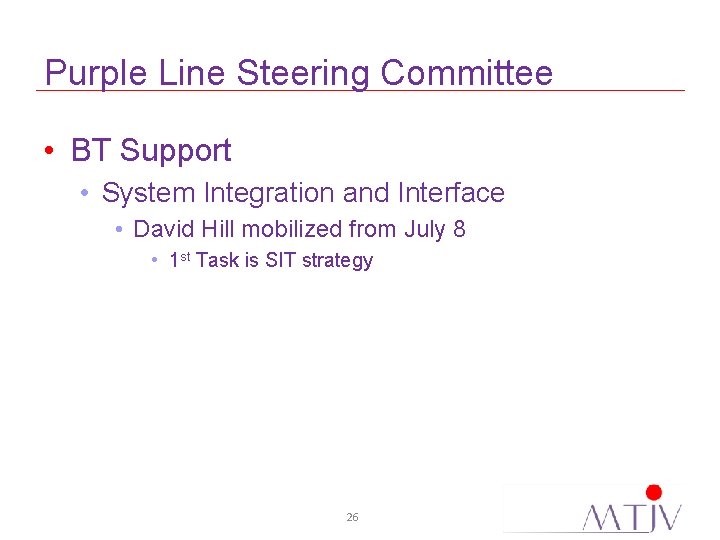

Purple Line Steering Committee • BT Support • System Integration and Interface • David Hill mobilized from July 8 • 1 st Task is SIT strategy 26

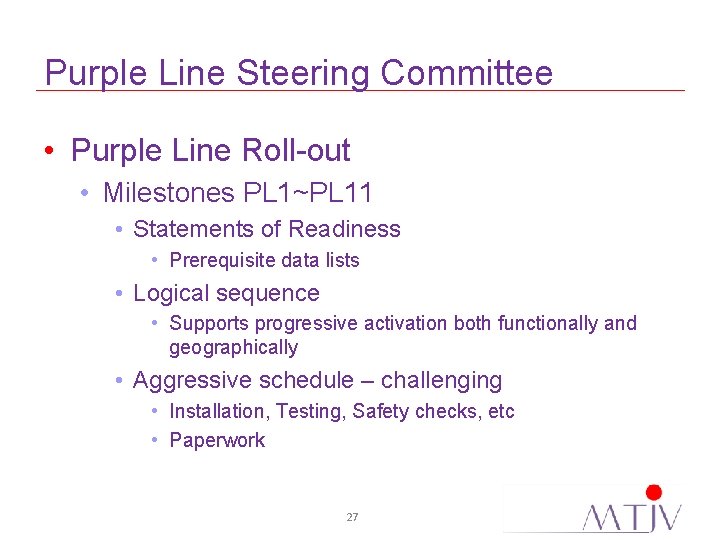

Purple Line Steering Committee • Purple Line Roll-out • Milestones PL 1~PL 11 •

Purple Line Steering Committee • Purple Line Roll-out • Milestones PL 1~PL 11 • Statements of Readiness • Prerequisite data lists • Logical sequence • Supports progressive activation both functionally and geographically • Aggressive schedule – challenging • Installation, Testing, Safety checks, etc • Paperwork 27

Purple Line Steering Committee 28

Purple Line Steering Committee 28

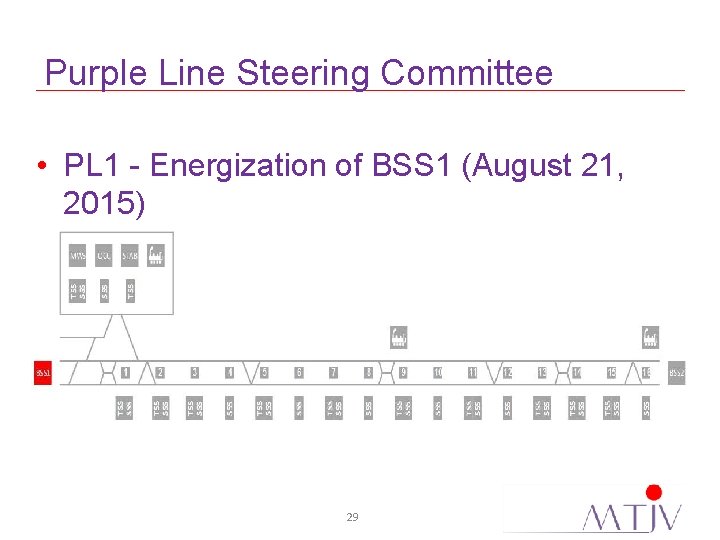

Purple Line Steering Committee • PL 1 - Energization of BSS 1 (August 21,

Purple Line Steering Committee • PL 1 - Energization of BSS 1 (August 21, 2015) 29

Purple Line Steering Committee • PL 2 - Energization of Main Workshop and OCC

Purple Line Steering Committee • PL 2 - Energization of Main Workshop and OCC SSS (Early September 2015) 30

Purple Line Steering Committee • PL 3 - Energization of Main Workshop and Depot

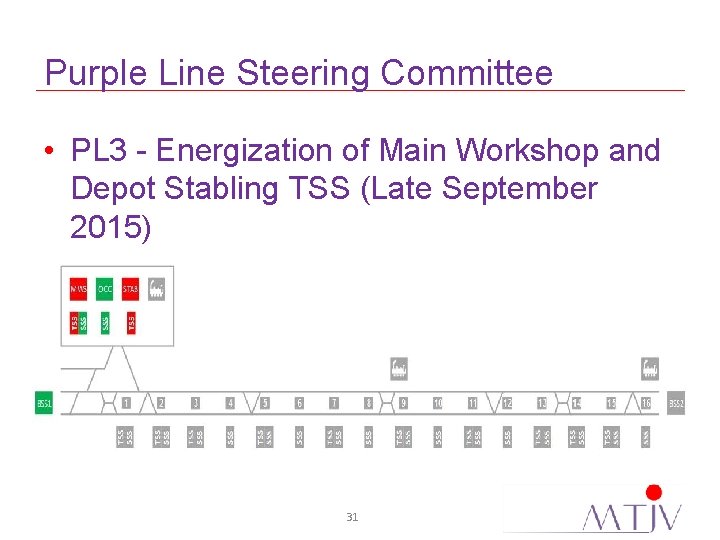

Purple Line Steering Committee • PL 3 - Energization of Main Workshop and Depot Stabling TSS (Late September 2015) 31

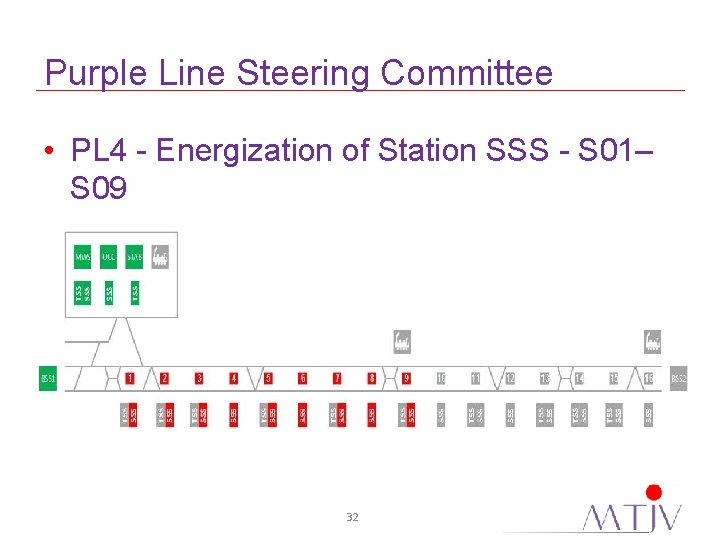

Purple Line Steering Committee • PL 4 - Energization of Station SSS - S

Purple Line Steering Committee • PL 4 - Energization of Station SSS - S 01– S 09 32

Purple Line Steering Committee • PL 5 - Energization of Station TSS – S

Purple Line Steering Committee • PL 5 - Energization of Station TSS – S 01– S 09 33

Purple Line Steering Committee • PL 6 - Energization of BSS 2 34

Purple Line Steering Committee • PL 6 - Energization of BSS 2 34

Purple Line Steering Committee • PL 7 - Energization of Station SSS – S

Purple Line Steering Committee • PL 7 - Energization of Station SSS – S 10– S 16 35

Purple Line Steering Committee • PL 8 - Energization of Station TSS – S

Purple Line Steering Committee • PL 8 - Energization of Station TSS – S 10– S 16 36

Purple Line Steering Committee • PL 9 - First Train Operation in Depot 37

Purple Line Steering Committee • PL 9 - First Train Operation in Depot 37

Purple Line Steering Committee • PL 10 - First Train Operation Main Line S

Purple Line Steering Committee • PL 10 - First Train Operation Main Line S 01 -S 09 38

Purple Line Steering Committee • PL 11 - First Train Operation Main Line S

Purple Line Steering Committee • PL 11 - First Train Operation Main Line S 10 -S 16 39

Purple Line Steering Committee THANK YOU 40

Purple Line Steering Committee THANK YOU 40

Purple Line Steering Committee 41

Purple Line Steering Committee 41

Purple Line Steering Committee 42

Purple Line Steering Committee 42

Purple Line Steering Committee 43

Purple Line Steering Committee 43

Purple Line Steering Committee 44

Purple Line Steering Committee 44

Purple Line Steering Committee 45

Purple Line Steering Committee 45

Purple Line Steering Committee 46

Purple Line Steering Committee 46

Purple Line Steering Committee 47

Purple Line Steering Committee 47
