PROJECT PLANNING SCHEDULING TECHNIQUES RESOURCES SCHEDULING 2 Prof

  • Slides: 20
Download presentation
PROJECT PLANNING & SCHEDULING TECHNIQUES RESOURCES SCHEDULING 2 Prof. Sanjay Bhoyar

PROJECT PLANNING & SCHEDULING TECHNIQUES RESOURCES SCHEDULING 2 Prof. Sanjay Bhoyar

 Success of a project � Orderly & even progress of work � Continuous

Success of a project � Orderly & even progress of work � Continuous work without interruptions This is possible, if � Adequate volume of required resources � Correct combination of resources � Suitable skilled workers � Technologically adequate equipment � Standard/ required quality of materials NICMAR, PUNE SANJAY BHOYAR

Resources for a project MATERIALS are worked upon and converted to PROJECT DELIVERABLES by

Resources for a project MATERIALS are worked upon and converted to PROJECT DELIVERABLES by the assigned MANPOWER using its skills & efforts with or without help of EQUIPMENT MONEY is required for procuring other resources NICMAR, PUNE SANJAY BHOYAR

Resources scheduling: Scheduling the work for effective utilization of resources Resources identification � Resources

Resources scheduling: Scheduling the work for effective utilization of resources Resources identification � Resources allocation � Daily resource requirement Resources smoothing � Assigning the resources for each activity Resources aggregation � Set of resources required Time constrained scheduling Resources leveling � Resource constrained scheduling NICMAR, PUNE SANJAY BHOYAR

Resources scheduling: Early Start Schedule � Time scaled network Rescheduling the activities: � To

Resources scheduling: Early Start Schedule � Time scaled network Rescheduling the activities: � To reduce the peak requirement Shifting the start times of activities Stretching activities Splitting activities NICMAR, PUNE SANJAY BHOYAR

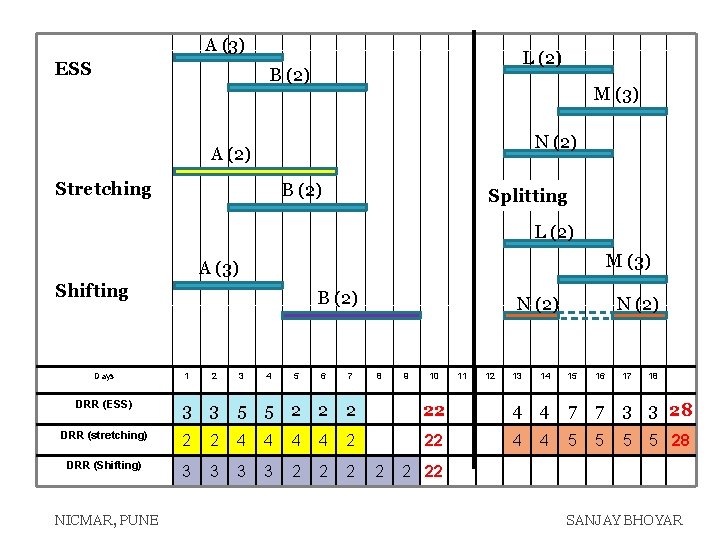

A (3) ESS L (2) B (2) M (3) N (2) A (2) Stretching

A (3) ESS L (2) B (2) M (3) N (2) A (2) Stretching B (2) Splitting L (2) M (3) A (3) Shifting Days DRR (ESS) B (2) 1 2 3 4 5 6 7 N (2) 8 9 10 11 12 13 14 N (2) 15 16 17 18 3 3 5 5 2 22 4 4 7 7 3 3 28 DRR (stretching) 2 2 4 4 2 22 4 5 5 DRR (Shifting) 3 3 2 2 2 NICMAR, PUNE 2 4 5 5 28 2 22 SANJAY BHOYAR

Purposes of Resources Scheduling: To know DRR To minimize idle time (and cost) of

Purposes of Resources Scheduling: To know DRR To minimize idle time (and cost) of resources To decide the optimal size of resources to be procured To avoid over-allocations for resources NICMAR, PUNE SANJAY BHOYAR

Time-constrained Resources Scheduling: Reducing the peak resource requirement as low as possible Shifting/ stretching/

Time-constrained Resources Scheduling: Reducing the peak resource requirement as low as possible Shifting/ stretching/ splitting activities � Within NICMAR, PUNE available floats SANJAY BHOYAR

Resource constrained scheduling: Reducing the peak resource requirement � To the resource limit Shifting/

Resource constrained scheduling: Reducing the peak resource requirement � To the resource limit Shifting/ stretching/ splitting activities � Firstly, within available floats � If required, beyond floats Project duration may extend NICMAR, PUNE SANJAY BHOYAR

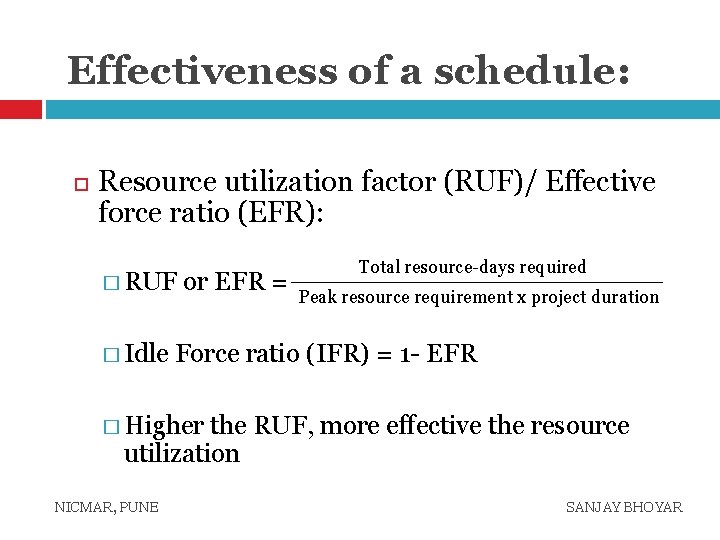

Effectiveness of a schedule: Resource utilization factor (RUF)/ Effective force ratio (EFR): � RUF

Effectiveness of a schedule: Resource utilization factor (RUF)/ Effective force ratio (EFR): � RUF � Idle or EFR = Total resource-days required Peak resource requirement x project duration Force ratio (IFR) = 1 - EFR � Higher the RUF, more effective the resource utilization NICMAR, PUNE SANJAY BHOYAR

Effectiveness of a schedule… Based on Peak resource requirement � Lower the peak, more

Effectiveness of a schedule… Based on Peak resource requirement � Lower the peak, more effective the resource utilization Burgess’ rule (Least square rule) � For comparable schedules, the one with least sum of the squares of the daily resource requirement is the most effective schedule. � Min, Σ(DRR)2 NICMAR, PUNE SANJAY BHOYAR

Activities, their durations & resource requirements are given below. Schedule the work for the

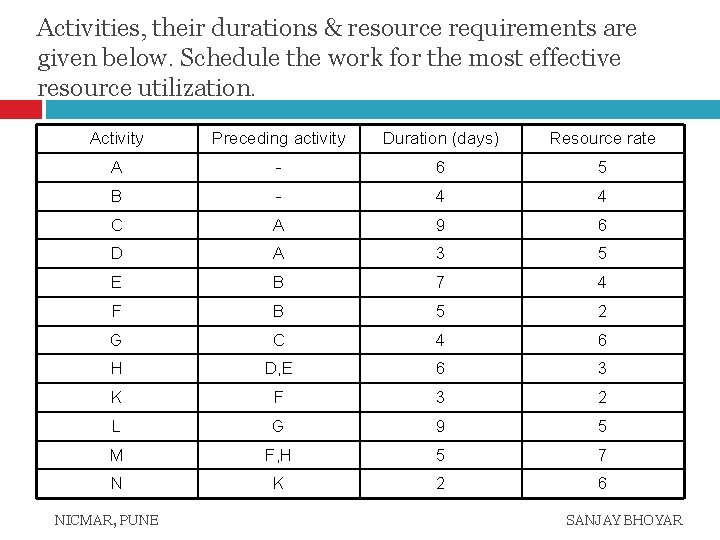

Activities, their durations & resource requirements are given below. Schedule the work for the most effective resource utilization. Activity Preceding activity Duration (days) Resource rate A - 6 5 B - 4 4 C A 9 6 D A 3 5 E B 7 4 F B 5 2 G C 4 6 H D, E 6 3 K F 3 2 L G 9 5 M F, H 5 7 N K 2 6 NICMAR, PUNE SANJAY BHOYAR

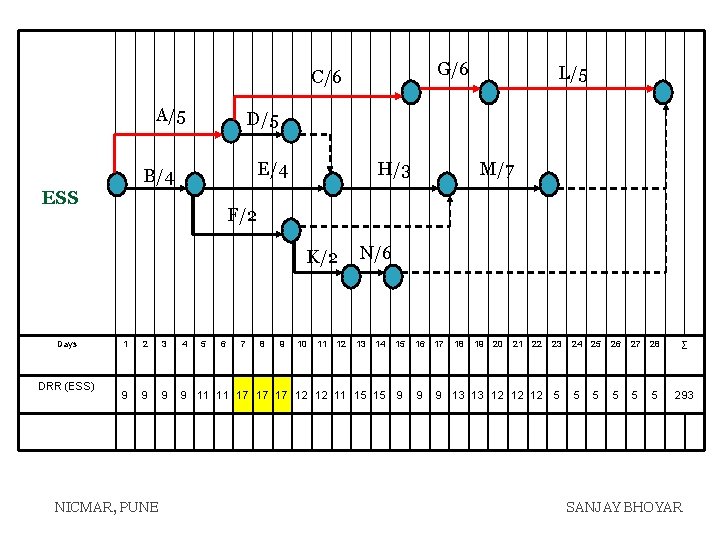

G/6 C/6 A/5 D/5 E/4 B/4 ESS H/3 DRR (ESS) M/7 F/2 K/2 Days

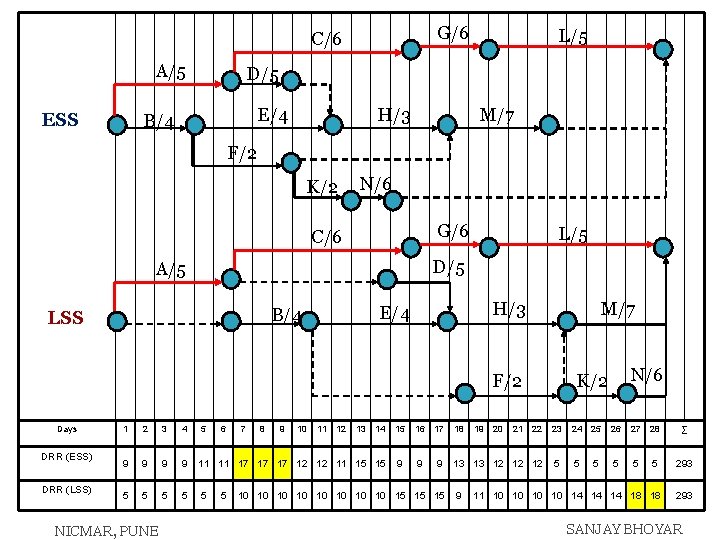

G/6 C/6 A/5 D/5 E/4 B/4 ESS H/3 DRR (ESS) M/7 F/2 K/2 Days L/5 1 2 3 4 15 16 17 23 24 25 26 27 28 ∑ 9 9 11 11 17 17 17 12 12 11 15 15 9 9 9 13 13 12 12 12 5 5 5 293 NICMAR, PUNE 5 6 7 8 9 10 11 12 N/6 13 14 18 19 20 21 22 SANJAY BHOYAR

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6

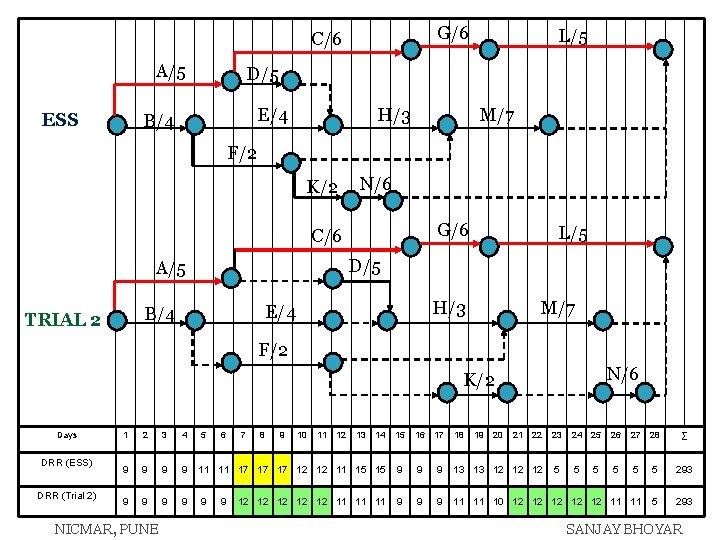

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6 C/6 L/5 D/5 A/5 H/3 E/4 B/4 LSS M/7 F/2 Days DRR (ESS) DRR (LSS) 1 2 3 4 9 9 9 5 5 5 NICMAR, PUNE 5 6 14 15 16 17 18 22 23 24 25 26 27 28 ∑ 9 11 11 17 17 17 12 12 11 15 15 9 9 9 13 13 12 12 12 5 5 5 293 5 5 11 10 10 14 14 14 18 18 293 5 7 8 9 10 11 12 13 10 10 15 15 15 9 19 20 21 N/6 K/2 SANJAY BHOYAR

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6 C/6 D/5 A/5 H/3 E/4 B/4 TRIAL 1 L/5 M/7 F/2 N/6 K/2 Days DRR (ESS) DRR (Trial 1) 1 2 3 4 9 9 9 NICMAR, PUNE 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 22 23 24 25 26 27 28 ∑ 9 11 11 17 17 17 12 12 11 15 15 9 9 9 13 13 12 12 12 5 5 5 293 9 11 11 12 12 12 13 17 17 9 9 12 12 12 5 5 5 293 9 20 8 21 SANJAY BHOYAR

G/6 C/6 D/5 A/5 H/3 E/4 B/4 TRIAL 1 L/5 M/7 F/2 N/6 K/2

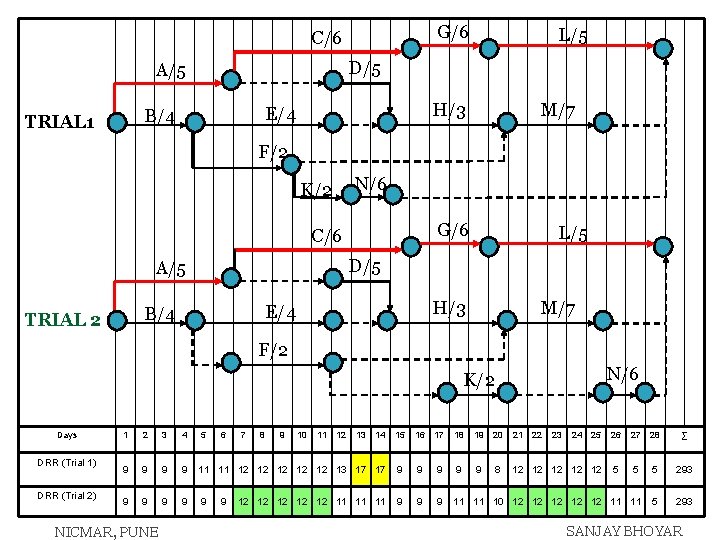

G/6 C/6 D/5 A/5 H/3 E/4 B/4 TRIAL 1 L/5 M/7 F/2 N/6 K/2 G/6 C/6 D/5 A/5 H/3 E/4 B/4 TRIAL 2 L/5 M/7 F/2 N/6 K/2 Days DRR (Trial 1) DRR (Trial 2) 1 2 3 4 9 9 9 NICMAR, PUNE 5 6 14 15 16 17 18 19 20 21 25 26 27 28 ∑ 9 11 11 12 12 12 13 17 17 9 9 9 8 12 12 12 5 5 5 293 9 9 9 11 11 10 12 12 12 11 11 5 293 9 7 8 9 10 11 12 13 12 12 12 11 11 11 22 23 24 SANJAY BHOYAR

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6

G/6 C/6 A/5 ESS L/5 D/5 E/4 B/4 H/3 M/7 F/2 K/2 N/6 G/6 C/6 D/5 A/5 H/3 E/4 B/4 TRIAL 2 L/5 M/7 F/2 N/6 K/2 Days DRR (ESS) DRR (Trial 2) 1 2 3 4 9 9 9 NICMAR, PUNE 5 6 14 15 16 17 18 22 23 24 25 26 27 28 ∑ 9 11 11 17 17 17 12 12 11 15 15 9 9 9 13 13 12 12 12 5 5 5 293 9 9 9 11 11 10 12 12 12 11 11 5 293 9 7 8 9 10 11 12 13 12 12 12 11 11 11 19 20 21 SANJAY BHOYAR

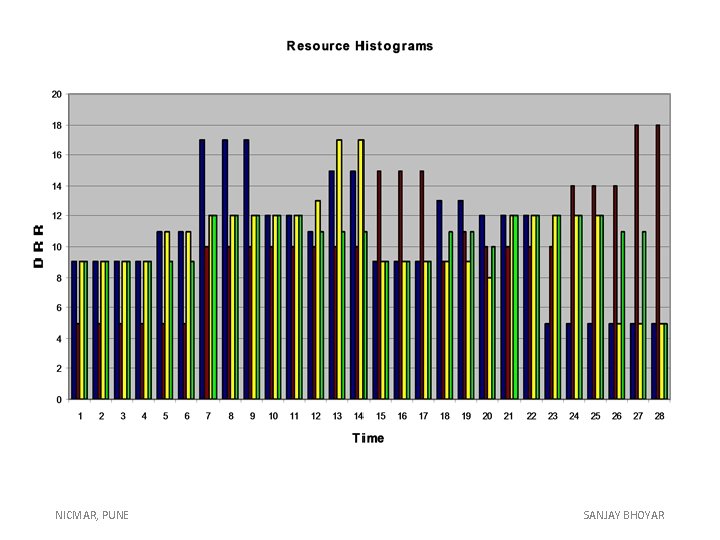

NICMAR, PUNE SANJAY BHOYAR

NICMAR, PUNE SANJAY BHOYAR

 Schedule the work if maximum size of resource is limited to 10. NICMAR,

Schedule the work if maximum size of resource is limited to 10. NICMAR, PUNE SANJAY BHOYAR

G/6 C/6 L/5 D/5 A/5 H/3 E/4 B/4 Smoothened resources M/7 F/2 TRIAL 2

G/6 C/6 L/5 D/5 A/5 H/3 E/4 B/4 Smoothened resources M/7 F/2 TRIAL 2 N/6 K/2 G/6 C/6 L/5 D/5 A/5 H/3 E/4 B/4 N/6 K/2 DRR (Trial 2) DRR (Trial 4) M/7 F/2 TRIAL 3 Days Leveled resources 1 2 3 4 5 6 7 9 9 9 12 12 12 11 11 11 9 9 9 11 11 10 12 12 12 11 11 5 9 9 9 10 10 10 8 7 7 7 5 NICMAR, PUNE 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32 33 34 35 36 37 38 8 8 9 9 9 8 5 5 ∑ 293 5 5 5 7 7 7 SANJAY BHOYAR 293
