Project Plan Development EM 4003 Class 5 Developing

  • Slides: 27
Download presentation
Project Plan Development EM 4003 Class #5

Project Plan Development EM 4003 Class #5

Developing a Plan What steps are Important?

Developing a Plan What steps are Important?

A Quote “I had six honest serving men who taught men all I know:

A Quote “I had six honest serving men who taught men all I know: their names were what and how and why, and when and where and who. ” Rudyard Kipling

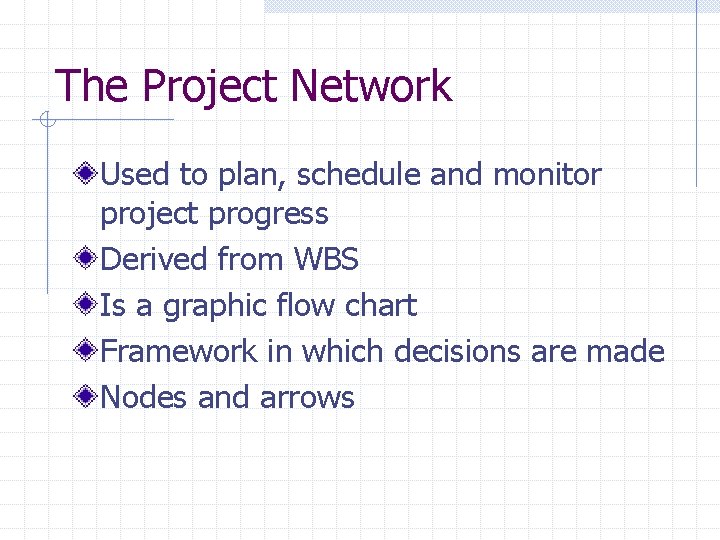

The Project Network Used to plan, schedule and monitor project progress Derived from WBS

The Project Network Used to plan, schedule and monitor project progress Derived from WBS Is a graphic flow chart Framework in which decisions are made Nodes and arrows

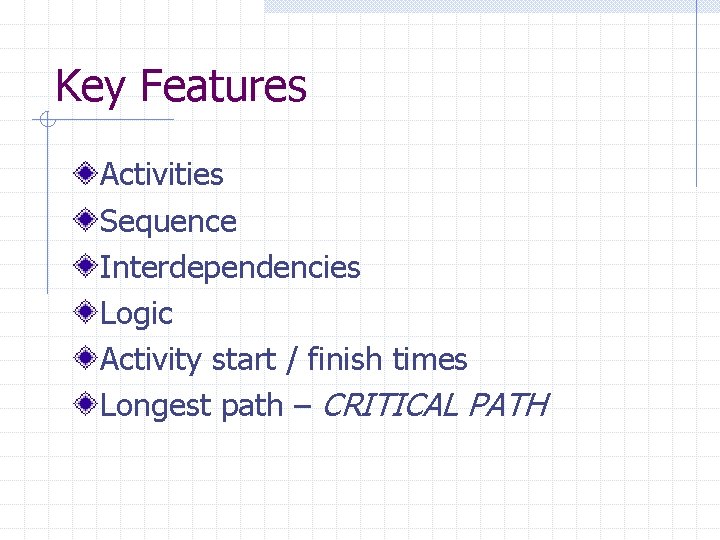

Key Features Activities Sequence Interdependencies Logic Activity start / finish times Longest path –

Key Features Activities Sequence Interdependencies Logic Activity start / finish times Longest path – CRITICAL PATH

Is it worth it? Costs time and money Needs accuracy Valuable communication tool Easily

Is it worth it? Costs time and money Needs accuracy Valuable communication tool Easily updated using current software e. g. MS Project A way to bring the team together Supports decisions Minimizes surprises

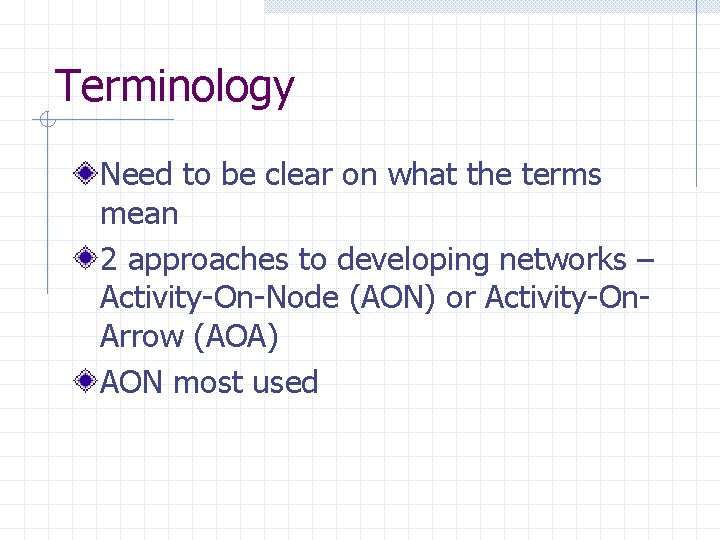

Terminology Need to be clear on what the terms mean 2 approaches to developing

Terminology Need to be clear on what the terms mean 2 approaches to developing networks – Activity-On-Node (AON) or Activity-On. Arrow (AOA) AON most used

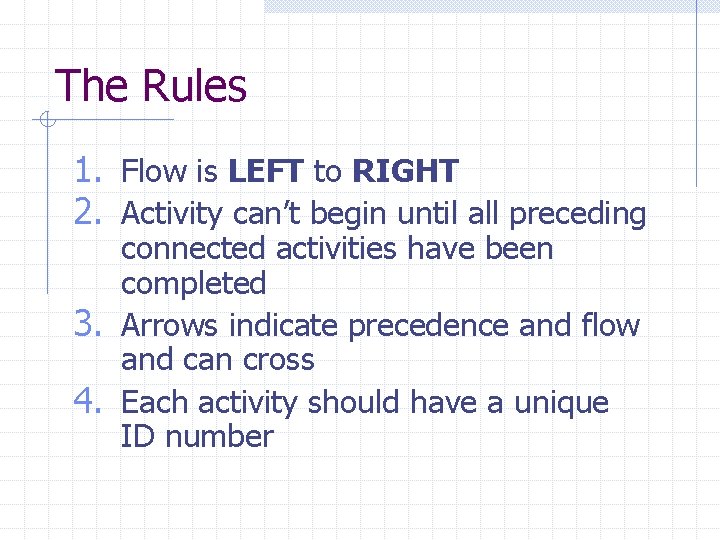

The Rules 1. Flow is LEFT to RIGHT 2. Activity can’t begin until all

The Rules 1. Flow is LEFT to RIGHT 2. Activity can’t begin until all preceding connected activities have been completed 3. Arrows indicate precedence and flow and can cross 4. Each activity should have a unique ID number

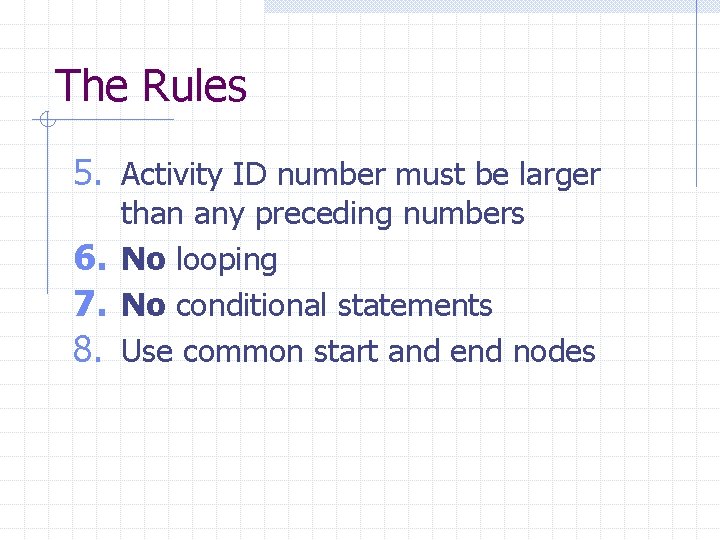

The Rules 5. Activity ID number must be larger than any preceding numbers 6.

The Rules 5. Activity ID number must be larger than any preceding numbers 6. No looping 7. No conditional statements 8. Use common start and end nodes

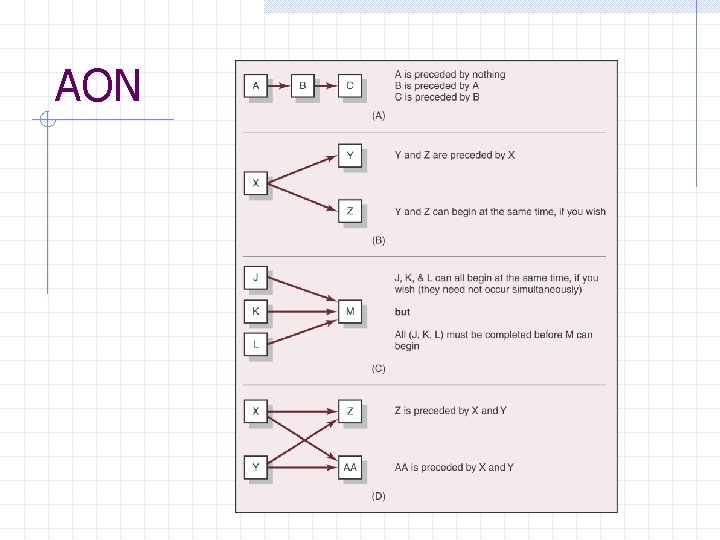

AON

AON

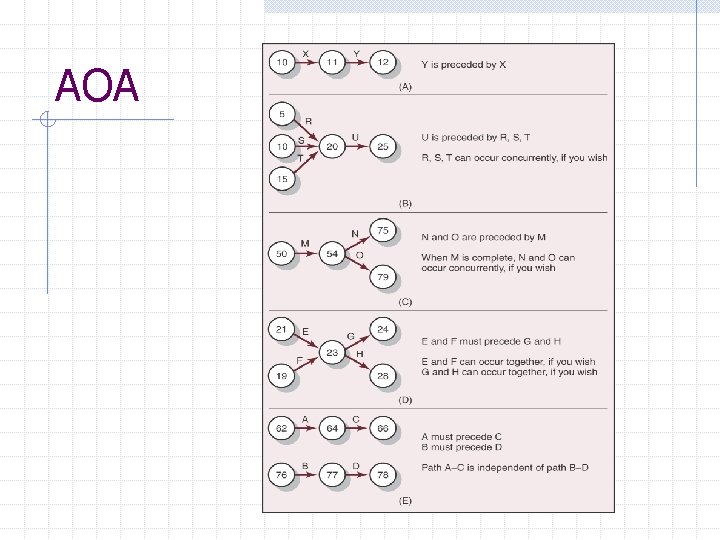

AOA

AOA

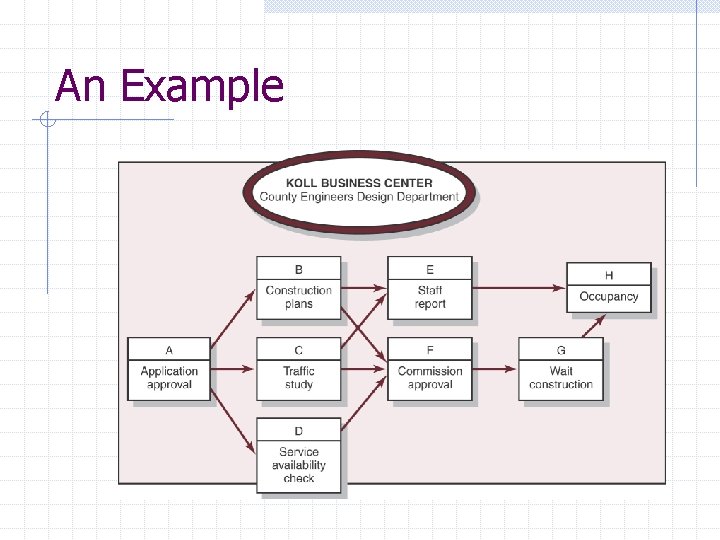

An Example

An Example

Network Computations TIME, TIME Complete Forward and Backward passes Forward – Earliest Times –

Network Computations TIME, TIME Complete Forward and Backward passes Forward – Earliest Times – ES, EF, TE Backward – Latest Times – LS, LF, SL

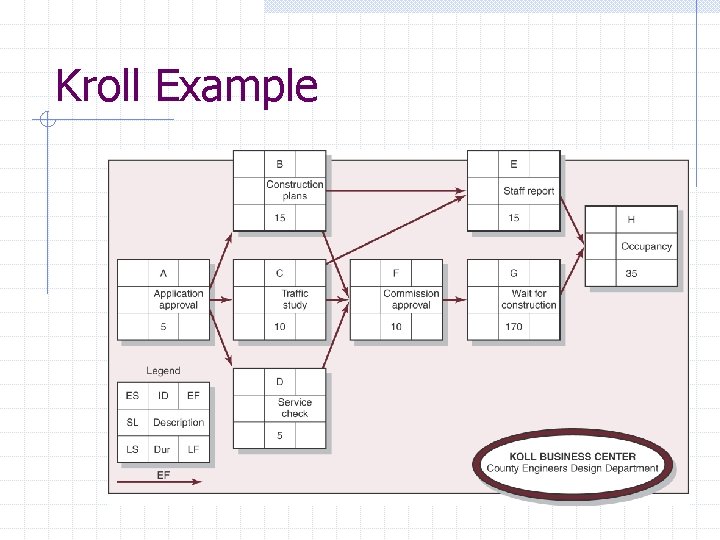

Kroll Example

Kroll Example

Kroll Example - Forward

Kroll Example - Forward

Kroll Example - Backward

Kroll Example - Backward

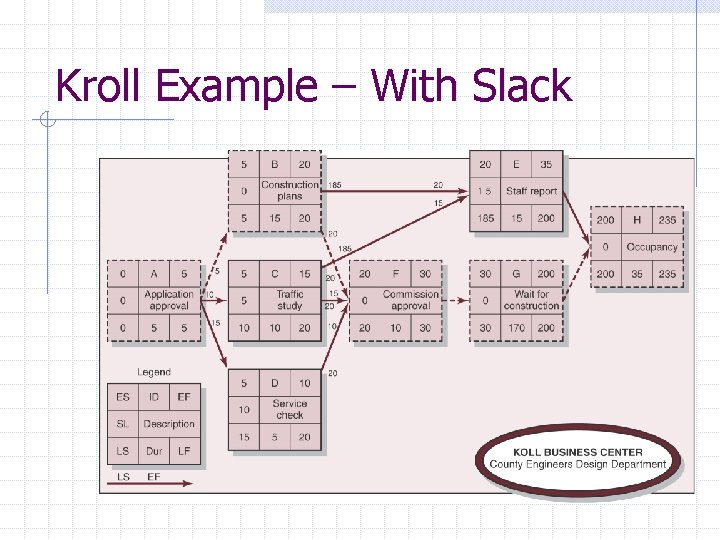

Kroll Example – With Slack

Kroll Example – With Slack

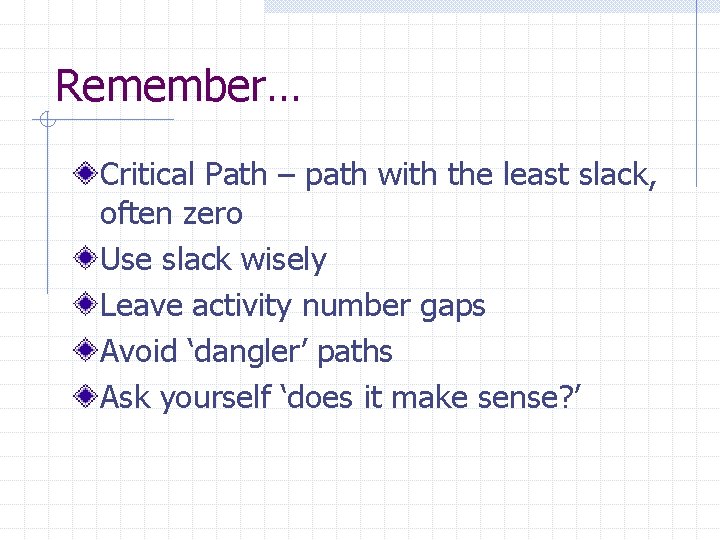

Remember… Critical Path – path with the least slack, often zero Use slack wisely

Remember… Critical Path – path with the least slack, often zero Use slack wisely Leave activity number gaps Avoid ‘dangler’ paths Ask yourself ‘does it make sense? ’

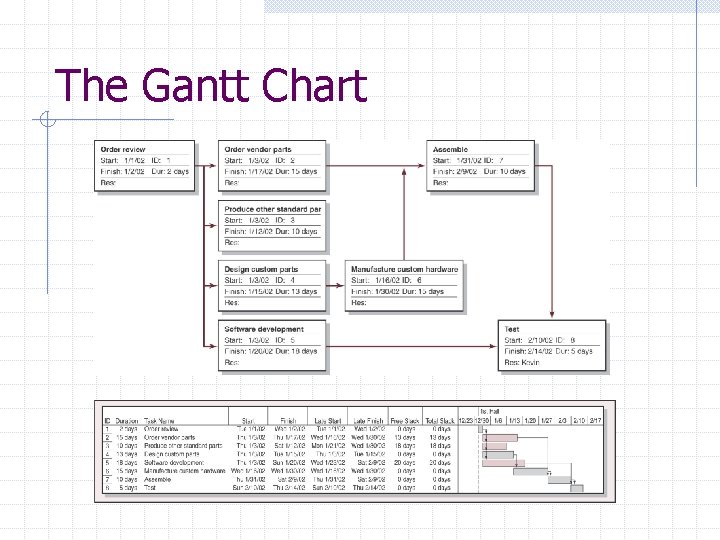

The Gantt Chart

The Gantt Chart

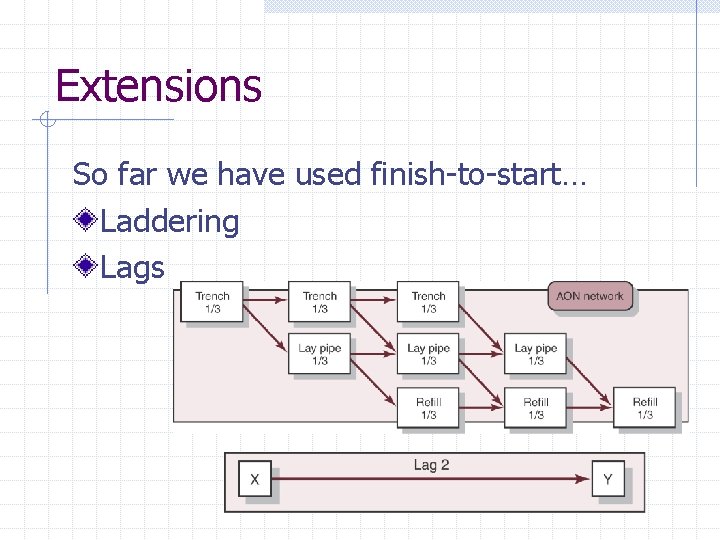

Extensions So far we have used finish-to-start… Laddering Lags

Extensions So far we have used finish-to-start… Laddering Lags

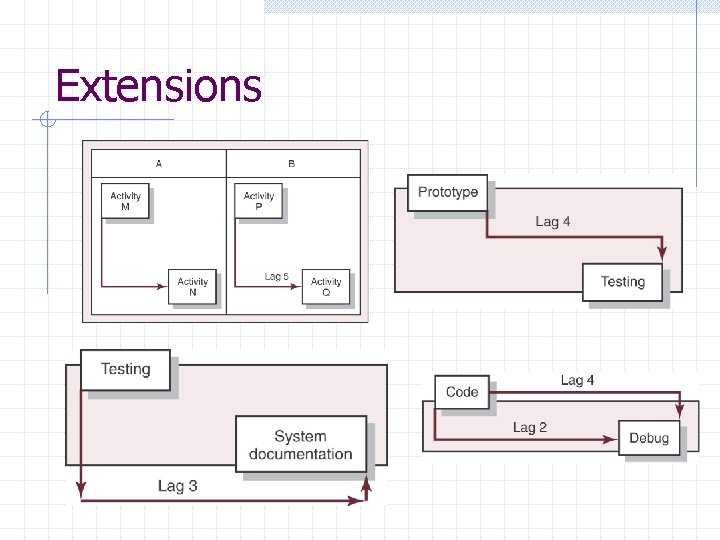

Extensions

Extensions

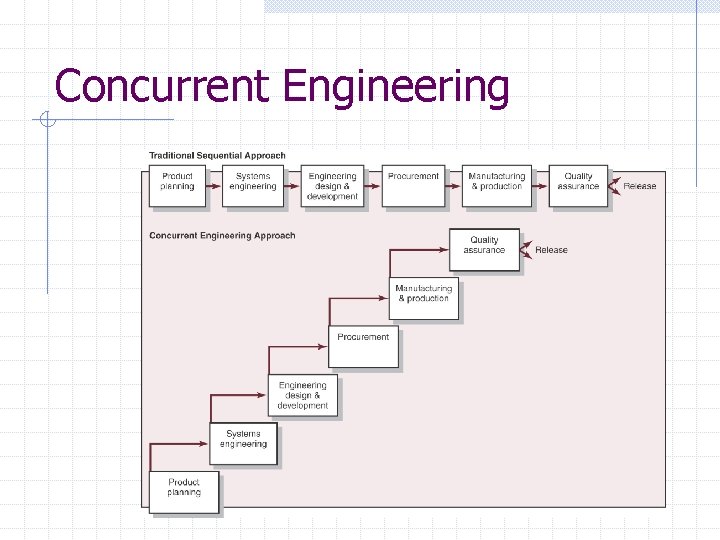

Concurrent Engineering

Concurrent Engineering

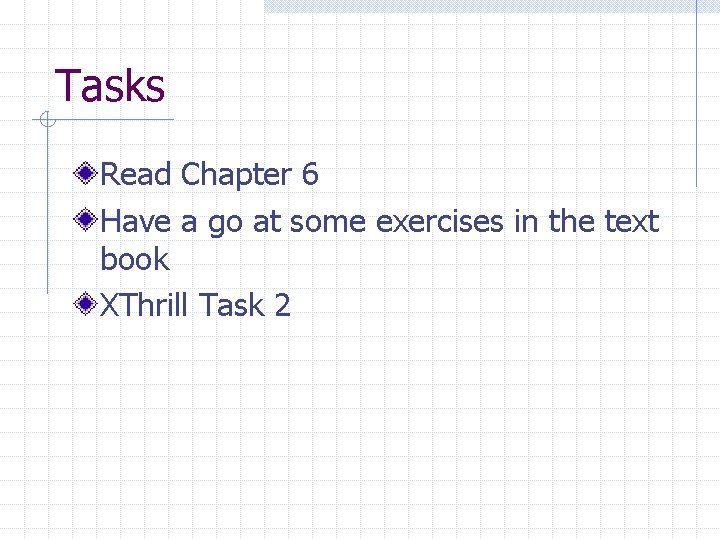

Tasks Read Chapter 6 Have a go at some exercises in the text book

Tasks Read Chapter 6 Have a go at some exercises in the text book XThrill Task 2

Capital Industries

Capital Industries

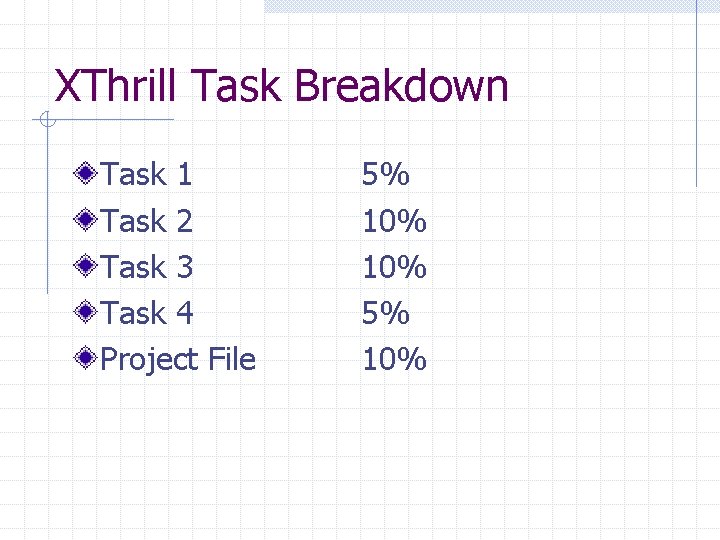

XThrill Task Breakdown Task 1 Task 2 Task 3 Task 4 Project File 5%
