Project Management by Gantt Chart PERT Diagram Start
Project Management by Gantt Chart & PERT Diagram Start Next Sanchai Yeewiyom School of Information & Communication Technology University of Phayao Structured System Analysis and Design Slide 1 from 38

Gantt Chart งาน Back A B C D Next E 16 Structured System Analysis and Design 14 12 10 8 6 4 2 เวลา Slide 12 from 38
PERT Diagram 60 E, 5 Back B, 3 10 20 D, 8 50 C, 2 30 A, 5 40 Next Structured System Analysis and Design Slide 14 from 38
PERT Diagram Back B, 3 10 C, 2 30 E, 5 40 A, 5 20 D, 8 Next Structured System Analysis and Design Slide 15 from 38

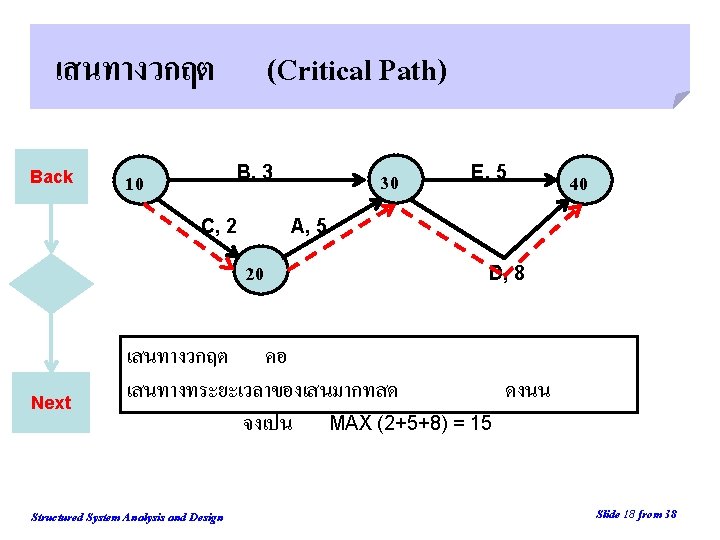

การคำนวณระยะเวลาในการดำเนนโครงการ Back B, 3 10 C, 2 30 40 A, 5 20 B-E 8 B-D 11 C-A-E Next E, 5 = 12 C-A-D D, 8 ผลรวมของระยะเวลา คอ คอ 3+5 = 3+8 = 2+5+5 2+5+8 = 15 : Critical Path Method CPM Structured System Analysis and Design Slide 16 from 38
ตวอยาง A Back B C D E F G H Next I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 20 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 21 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 22 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 23 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 24 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 25 from 38
ตวอยาง A B C D E F G H I J 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 Structured System Analysis and Design Slide 26 from 38
ขนตอนท 1 Back 10 A, 2 20 Next Structured System Analysis and Design Slide 28 from 38
ขนตอนท 2 Back B, 3 10 A, 2 20 F, 5 30 40 I, 7 50 Next Structured System Analysis and Design Slide 29 from 38
ขนตอนท 3 Back B, 3 10 A, 2 20 F, 5 30 C, 5 60 40 I, 7 50 Next Structured System Analysis and Design Slide 30 from 38
ขนตอนท 4 Back B, 3 10 A, 2 20 F, 5 30 C, 5 60 G, 4 70 40 I, 7 50 Next Structured System Analysis and Design Slide 31 from 38
ขนตอนท 5 Back B, 3 10 A, 2 20 F, 5 30 C, 5 60 G, 4 70 D, 1 80 40 I, 7 50 Next Structured System Analysis and Design Slide 32 from 38
ขนตอนท 6 90 E, 2 Back B, 3 10 A, 2 20 F, 5 30 C, 5 60 G, 4 70 D, 1 80 H, 5 100 J, 6 40 110 I, 7 Next Structured System Analysis and Design 50 Slide 33 from 38
ขนตอนท 7, 8 Back E, 2 10 A, 2 20 B, 3 30 C, 5 60 G, 4 70 D, 1 80 H, 5 100 F, 5 J, 6 Next Structured System Analysis and Design I, 7 Slide 34 from 38
ขนตอนท 9 Back E, 2 10 A, 2 20 B, 3 30 C, 5 40 G, 4 50 D, 1 60 H, 5 70 F, 5 J, 6 Next Structured System Analysis and Design I, 7 Slide 35 from 38
การหาเสนทางวกฤต Back Start Next A-B-C-G-D-E A-B-C-G-D-H A-B-C-G-D-J A-F-G-D-E A-F-G-D-H A-F-G-D-J A-I-D-E A-I-D-H A-I-D-J Structured System Analysis and Design = = = = = 2+3+5+4+1+2 2+3+5+4+1+5 2+3+5+4+1+6 2+5+4+1+2 2+5+4+1+5 2+5+4+1+6 2+7+1+2 2+7+1+5 2+7+1+6 = = = = = 17 20 21 14 17 16 12 15 16 Slide 36 from 38
แบบฝกหด Back งาน เวลาในการทำงาน 1 2 งานทตองทำกอน 21 2 2 2 3 4 5 6 End 3 3 7 6 13, 4 7 8 4, 5 6, 7 5 4 8 7 9 2จากตารางจงเขยน Gantt Chart และ PERT Diagram 8, 9 10 Path พรอมหา Critical Structured System Analysis and Design Slide 38 from 38
