Progress Review On Ongoing Construction Projects aimed at

  • Slides: 13
Download presentation
Progress Review On Ongoing Construction Projects aimed at Budget - 2016 Professor Ranjith Premalal

Progress Review On Ongoing Construction Projects aimed at Budget - 2016 Professor Ranjith Premalal De Silva Vice Chancellor Uva Wellassa University, Sri Lanka Dr. Gamani Chandrasena Vice Chancellor Uva Wellassa University, Sri Lanka

1. 2. Construction (Capital) Projects of Uva Wellassa Phase II Phase I i. iii.

1. 2. Construction (Capital) Projects of Uva Wellassa Phase II Phase I i. iii. iv. Administration Building Block Lecture Hall + Lab (Block A) Lecture Hall + Lab (Block B) Lecture Hall + Lab (Block C) Total Cost Estimated (Amended TCE) Actual Expenditure incurred to 30. 06. 2015 Future Commitment (Final Bill to be Settled) Physical Process : 100% Financial Progress => Rs. 350 Million => Rs. 348 Million => Rs 10 Million : 99% Administration Building Block • Awarding On : 03 rd Aug 2005 • Completed On : 16 th Oct 2006 25 August 2015

Lecture Hall + Lab (Block A) Awarding On : 03 rd Aug 2005 Completed

Lecture Hall + Lab (Block A) Awarding On : 03 rd Aug 2005 Completed On : 01 st Nov 2006 • • • Lecture Hall + Lab (Block B) Awarding On : 03 rd Aug 2005 Completed On : 11 th Oct 2006 Lecture Hall + Lab (Block C) Awarding On : 03 rd Aug 2005 Completed On : 11 th Oct 2006 25 August 2015

Phase II Hostel Block No. 1 Awarding On : 01 st Jul 2006 Completed

Phase II Hostel Block No. 1 Awarding On : 01 st Jul 2006 Completed On : 30 th Jul 2007 Physical Progress : 100% Financial Progress : 87% • • • Hostel Block No. 2 Awarding On : 01 st Sep 2006 Completed On : 26 Jun 2008 • • Physical Progress : 100% Financial Progress : 87% • • Hostel Block No. 3 Awarding On : 01 st Aug 2006 Completed On : 04 th Dec 2008 Physical Progress : 100% Financial Progress : 87% 25 August 2015

Hostel Block No. 4 TCE: 457 Million • • Awarding On : 01 st

Hostel Block No. 4 TCE: 457 Million • • Awarding On : 01 st Nov 2006 Completed On : 25 th Jul 2008 Physical Progress : 100% Financial Progress : 87% Dinning & Study Hall Kitchen for Dinning & Study Hall • • Awarding On Completed On : 15 th May 2006 : 30 th Jun 2006 • • Physical Progress Financial Progress : 100% : 87% • • Water Sump & Pump House Awarding On : 01 st Sep 2006 Completed On : 16 Jun 2008 Physical Progress : 100% Financial Progress : 73% 25 August 2015

Landscaping - Phase - 1 Area • • Awarding On : 01 st Jan

Landscaping - Phase - 1 Area • • Awarding On : 01 st Jan 2007 Completed On : 19 th Jan 2008 Physical Progress : 100% Financial Progress : 70% • • Name Board and Developments at entrance Awarding On : 01 st Jul 2007 Completed On : 19 th Jan 2008 • • Physical Progress : 100% Financial Progress : 35% Temporary Sports Court • • Awarding On : 15 th Jan 2007 Completed On : 27 th Feb 2006 Physical Progress : 100% Financial Progress : 70% 25 August 2015

 • • Fiber Network (IT back-born at Phase 1 buildings) Awarding On :

• • Fiber Network (IT back-born at Phase 1 buildings) Awarding On : 01 st Dec 2007 Completed On : 31 st Dec 2008 Physical Progress : 100% Financial Progress : 97% • • Vice Chancellor's Bungalow Awarding On : 08 th Sep 2008 Completed On : 09 th Mar 2010 Physical Progress : 100% Financial Progress : 98% • • Play Ground (For 200 m track) Awarding On : 01 st Apr 2007 Completed On : 13 th Sep 2009 Physical Progress : 100% Financial Progress: 63% 25 August 2015

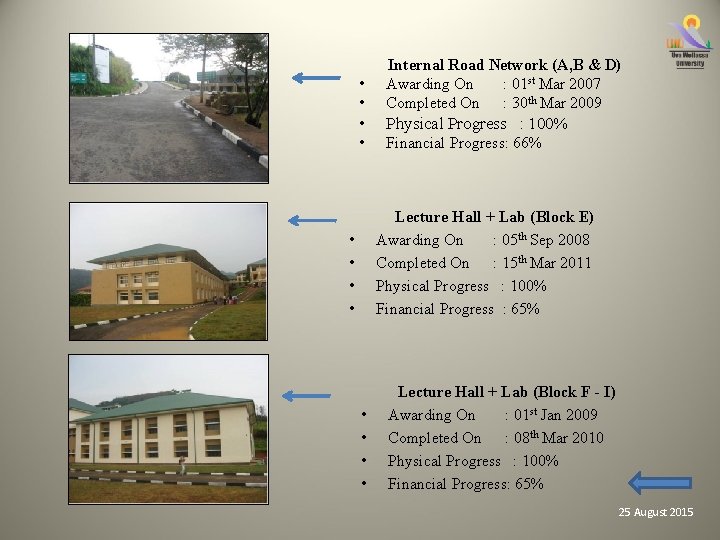

 • • Internal Road Network (A, B & D) Awarding On : 01

• • Internal Road Network (A, B & D) Awarding On : 01 st Mar 2007 Completed On : 30 th Mar 2009 • Physical Progress : 100% • Financial Progress: 66% Lecture Hall + Lab (Block E) Awarding On : 05 th Sep 2008 Completed On : 15 th Mar 2011 Physical Progress : 100% Financial Progress : 65% • • Lecture Hall + Lab (Block F - I) Awarding On : 01 st Jan 2009 Completed On : 08 th Mar 2010 Physical Progress : 100% Financial Progress: 65% 25 August 2015

 • • Lecture Hall + Lab (Block F - II) Awarding On :

• • Lecture Hall + Lab (Block F - II) Awarding On : 27 th Apr 2010 Completed On : 26 Jul 2011 • • Physical Progress: 100% Financial Progress: 65% • • Lecture Hall + Lab (Block D) Awarding On : 27 th Apr 2010 Completed On : 26 th Aug 2011 Physical Progress: 100% Financial Progress: 65% Storm Water Drainage System Awarding On : 30 th Dec 2009 Physical Progress: 65% Financial Progress: 17% Ongoing 25 August 2015

Quarters for Deans/ Registrar/ Bursar & Course Directors • Awarding On : 01 st

Quarters for Deans/ Registrar/ Bursar & Course Directors • Awarding On : 01 st Dec 2011 • Completed On : 15 th Feb 2013 • Physical Progress : 100% • Financial Progress : 77% • • Staff Quarters (Studio Apartments) Awarding On : 25 th Nov 2012 Completed On : 05 th Mar 2013 Physical Progress : 100% Financial Progress : 50% Roads and Landscaping at Phase II Area Awarding On : 17 th Dec 2009 Physical Progress : 50% Financial Progress : 41% Ongoing 25 August 2015

 • • • Sports Center & Gymnasium Awarding On : 30 th Dec

• • • Sports Center & Gymnasium Awarding On : 30 th Dec 2014 Physical Progress : 25% Financial Progress : 25% Ongoing Pavilion Awarding On : 06 th Aug 2015 Physical Progress : 5% Financial Progress : 5% Ongoing (Mobilization Advance) Cafeteria and Toilets Awarding On : 27 th Aug 2012 Completed On : 26 th Aug 2013 Physical Progress : 100% Financial Progress: 100% 25 August 2015

 • • Maintenance section Awarding On : 08 th Jan 2014 Completed On

• • Maintenance section Awarding On : 08 th Jan 2014 Completed On : 08 th Oct 2014 Physical Progress : 100% Financial Progress: 66% • • • Senate Building Awarding On : 20 th Mar 2013 Physical Progress : 95% Ongoing Financial Progress: 85% • • • Balance work Roads & Landscaping Awarding On : 22 nd Mar 2014 Physical Progress: 65% Financial Progress: 44% Ongoing 25 August 2015

 • • • Waste water drainage & treatment works (Job 01 & Job

• • • Waste water drainage & treatment works (Job 01 & Job 02) Awarding On : 14 th Oct 2010 / 17 th May 2013 Physical Progress : 85% Ongoing Financial Progress: 36% University Guest House • • Awarding On: 05 th Sep 2011 Completed On: 20 th Oct 2012 Physical Progress: 100% Financial Progress: 64% University Guest House • • Awarding On: 05 th Nov 2012 Completed On: 17 th Aug 2013 Physical Progress: 100% Financial Progress: 96% 25 August 2015
