Picture Lake Geneva Switzerland Surrounded by the Alps
Picture • Lake Geneva, Switzerland • Surrounded by the Alps • 20°C mean temperature in summer • Annual snow fall – 30 in Site Context
Site Analysis • 10, 000 sq. ft. footprint • Flat site • Excellent gravel • Clear view to the lake • Easily accessible by two roads Topsoil Lake Geneva Good gravel Water table
A Design Genesis
Architectural Layout A
Architectural Layout A
Architectural Layout A
EIFS Cladding Exterior Cladding A Reflective Glass Façade System
3 D Views
Program Analysis A
Structural System Picture Overview E Live loads Corridor 1 st floor (classrooms) Auditorium with fixed seating Classroom, seminar room, lab, office 5 k. N/m 2 4 k. N/m 2 3 k. N/m 2 Snow 0. 75 k. N/m 2 /s b l 8 Wind Earthquake 1 k 1 k N/ = 2 m 1 m f 4 20. 0. 9 k. N/m 2 =3 max. 0. 05% of gravity loads ft 8. 2
Picture E Structural System Foundation Waterproofing Retaining wall Foundation Groundwater Table
Structural System Picture Walls and Columns E D=14 mm D=10 mm
Picture E Structural System Auditorium
Picture E Structural System Auditorium
Picture E Structural System Auditorium
Picture E Max. deflection – 15. 7 mm Structural System Concrete Slabs
Picture E Structural System Lateral Load Resisting System
Picture E Shearwall: Structural System Lateral Load Resisting System
Picture C • Budget - $5. 5 M • Timeline – 1 year • Faster • Cheaper • Life cycle cost savings Construction Issues Objectives
Picture C Construction Issues Site Plan • Bonus double access roads • Can divert traffic if needed and use the other side of the road • Mobile crane
Construction Issues Picture Equipment C Pump Truck Based on capacity and availability Capacity 1. 54 cubic meter. Boom – 54 m Hauling Truck Reach curve
Construction Issues C Sequencing
Construction Issues Picture Schedule Milestones C Start Substructure complete Mar 1, 2015 May 4, 2015 Framing complete Sep 27, 2015 Dec 13, 2015 End
Picture Construction Issues C Schedule Analysis • Project Duration – 9 months • Resource allocation considered • Snow season- December 15 th to February 15 th • Steel procurement lead time
Picture Construction Issues C Total Project Cost = $5. 29 M (3. 38 M in 2001) Cost Estimate
Picture Construction Issues Cost Analysis C EIFS vs Concrete Panels: EIFS • $ 22. 5 per sf • Fast to erect • Good thermal insulation and immune to cracking Concrete $25 per sf Impacts schedule Sturdy but is labor intensive
Picture C Construction Issues MEP Issues Concerns • Head Room – Floor to floor heights? • Location of MEP room • Choice of a centralized vs distributed system
Picture C Construction Issues MEP Design • Cores used for risers with diameter of 24” • Distribution at center brings used air down • Fresh air distributed through the lateral cores. • Duct sizes • typical rooms 14” • auditorium 18”

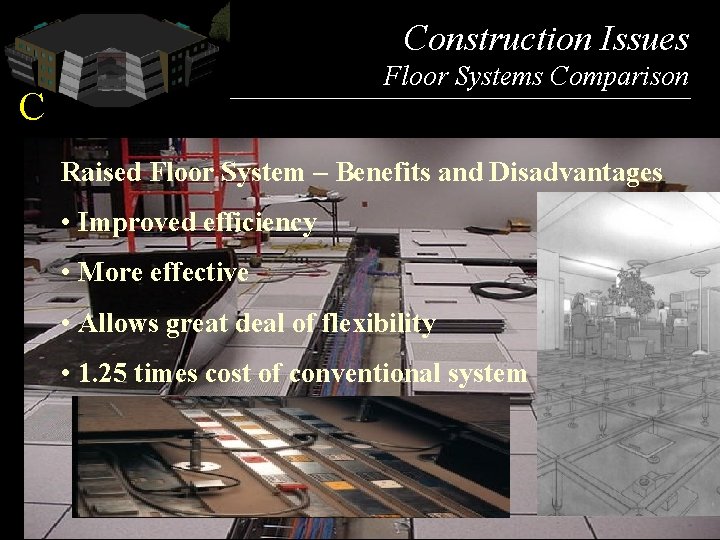

Picture C Construction Issues Floor Systems Comparison Raised Floor System – Benefits and Disadvantages • Improved efficiency • More effective • Allows great deal of flexibility • 1. 25 times cost of conventional system
Team Dynamics AEC Case 1: Floor heights iteration C E A
Team Dynamics AEC Case 1: Floor heights iteration C E A
Team Dynamics AEC Case 1: Floor heights iteration C E A
Team Dynamics AEC Case 1: Floor heights iteration C E A
Team Dynamics AEC Case 2: Mechanical Room Location

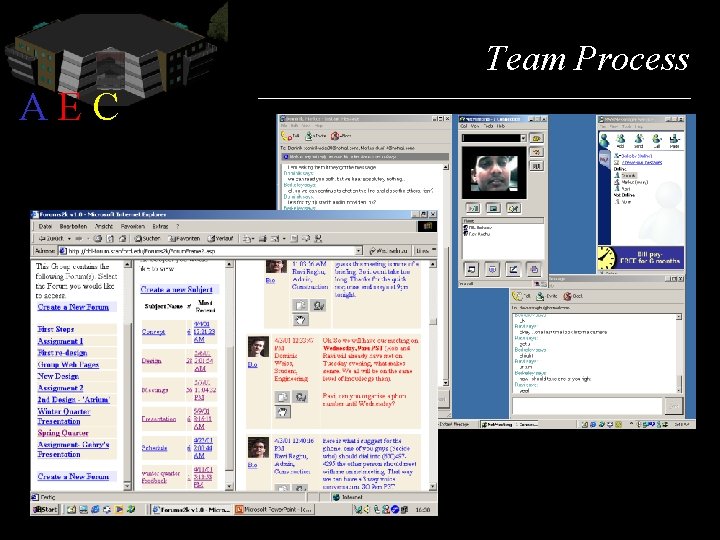

Team Process AEC
Conclusion AEC Working together, we were able to design a building that: • Closely meets the program requirements • Functions well as a learning facility • Responds to the site • Has a fairly low-life cycle cost • Is adaptable to meet changing needs
Lessons Learned AEC • • • Early design commitments Early consideration of MEP and structural systems Cross-disciplinary design contribution Synchronous communication Common Auto. CAD drawing
Acknowledgements AEC Renate Fruchter, Stanford University Mike Martin, U. C. Berkeley Humberto Cavalli, U. C. Berkeley David Bendet, MBT Architects Hansjörg Baumann, Bau. Ing AG, Switzerland Bob Tatum, Stanford University James Bartone, Nielsen Dillingham Eric Horn, Webcor Builders
