New Trunk and Distribution Water Main and Infrastructure
New Trunk and Distribution Water Main and Infrastructure Upgrades Along 33 rd Avenue and Surrounding Areas, Bayside and Flushing Queens Project ID: QED 991 Summer 2017 -Summer 2021 Broadway-Flushing Homeowners Association Date: 10/25/18 Church on the Hill 167 -03 35 th Avenue Flushing, NY 11358

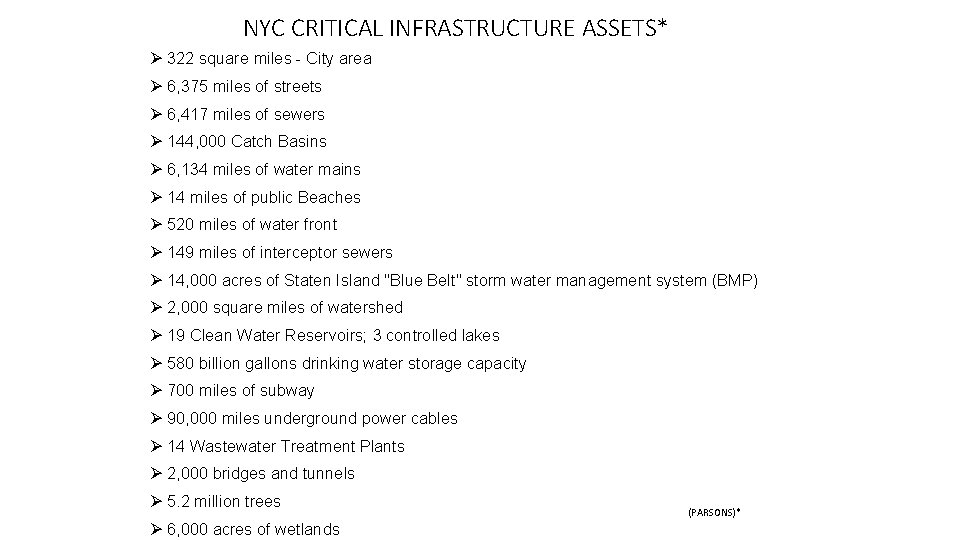

NYC CRITICAL INFRASTRUCTURE ASSETS* Ø 322 square miles - City area Ø 6, 375 miles of streets Ø 6, 417 miles of sewers Ø 144, 000 Catch Basins Ø 6, 134 miles of water mains Ø 14 miles of public Beaches Ø 520 miles of water front Ø 149 miles of interceptor sewers Ø 14, 000 acres of Staten Island "Blue Belt" storm water management system (BMP) Ø 2, 000 square miles of watershed Ø 19 Clean Water Reservoirs; 3 controlled lakes Ø 580 billion gallons drinking water storage capacity Ø 700 miles of subway Ø 90, 000 miles underground power cables Ø 14 Wastewater Treatment Plants Ø 2, 000 bridges and tunnels Ø 5. 2 million trees Ø 6, 000 acres of wetlands (PARSONS)*
WHY IS THIS PROJECT NECESSARY?

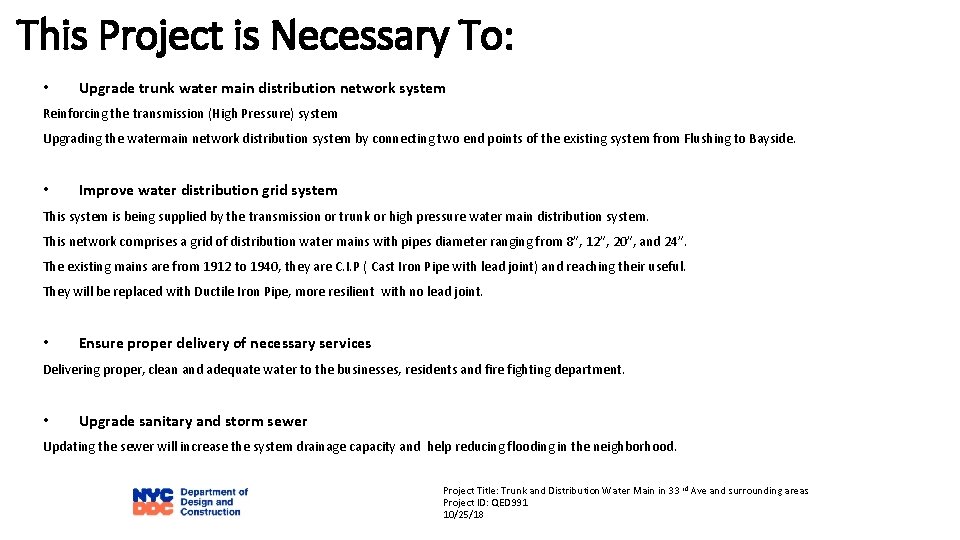

This Project is Necessary To: • Upgrade trunk water main distribution network system Reinforcing the transmission (High Pressure) system Upgrading the watermain network distribution system by connecting two end points of the existing system from Flushing to Bayside. • Improve water distribution grid system This system is being supplied by the transmission or trunk or high pressure water main distribution system. This network comprises a grid of distribution water mains with pipes diameter ranging from 8”, 12”, 20”, and 24”. The existing mains are from 1912 to 1940, they are C. I. P ( Cast Iron Pipe with lead joint) and reaching their useful. They will be replaced with Ductile Iron Pipe, more resilient with no lead joint. • Ensure proper delivery of necessary services Delivering proper, clean and adequate water to the businesses, residents and fire fighting department. • Upgrade sanitary and storm sewer Updating the sewer will increase the system drainage capacity and help reducing flooding in the neighborhood. Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

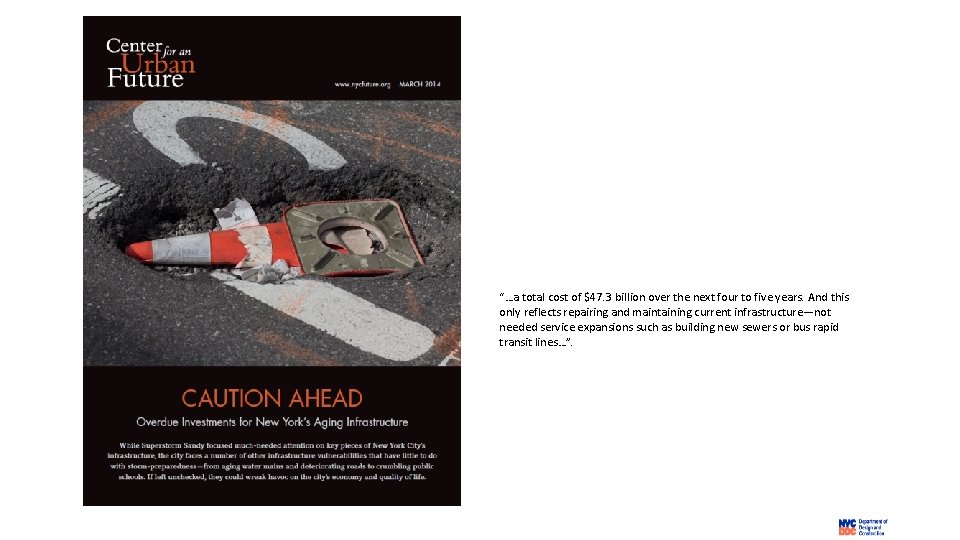

“…a total cost of $47. 3 billion over the next four to five years. And this only reflects repairing and maintaining current infrastructure—not needed service expansions such as building new sewers or bus rapid transit lines…”.

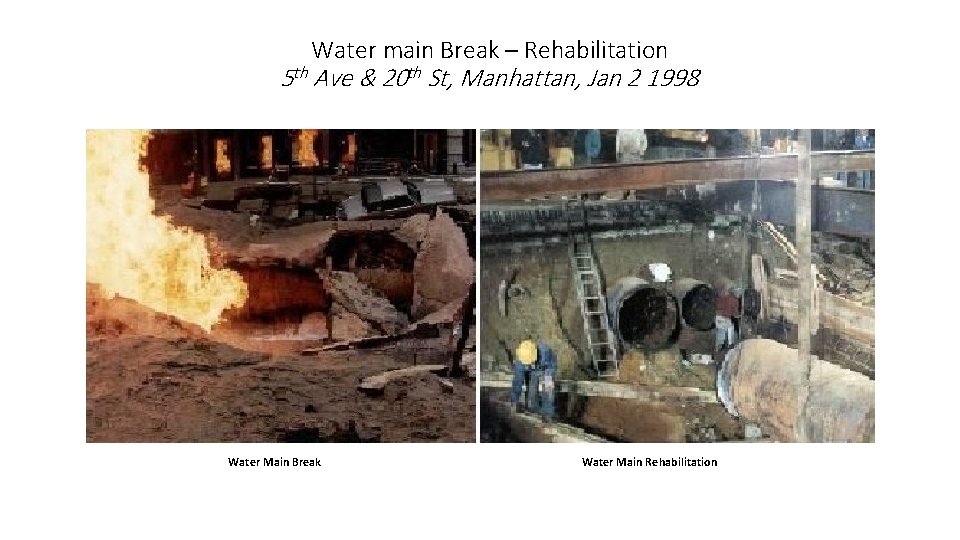

Water main Break – Rehabilitation 5 th Ave & 20 th St, Manhattan, Jan 2 1998 Water Main Break Water Main Rehabilitation

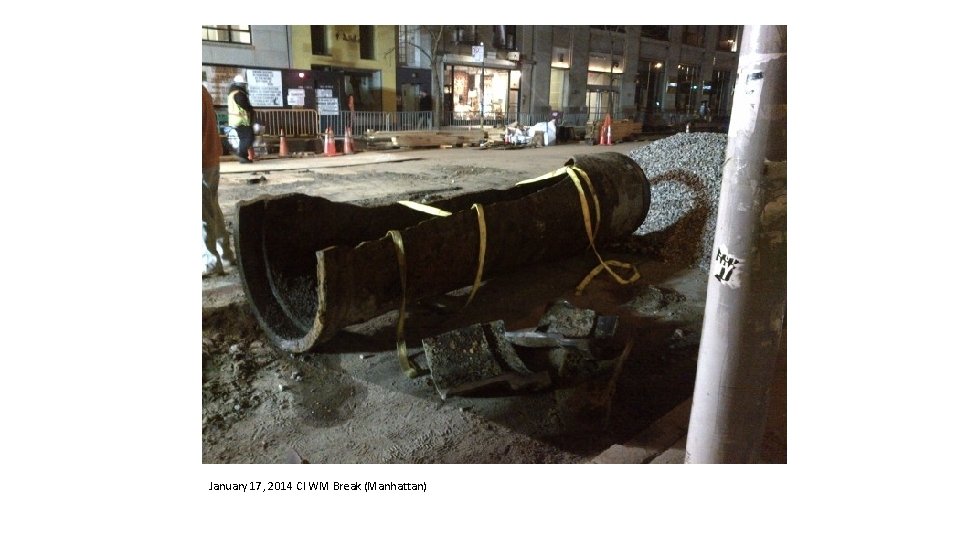

January 17, 2014 CI WM Break (Manhattan)

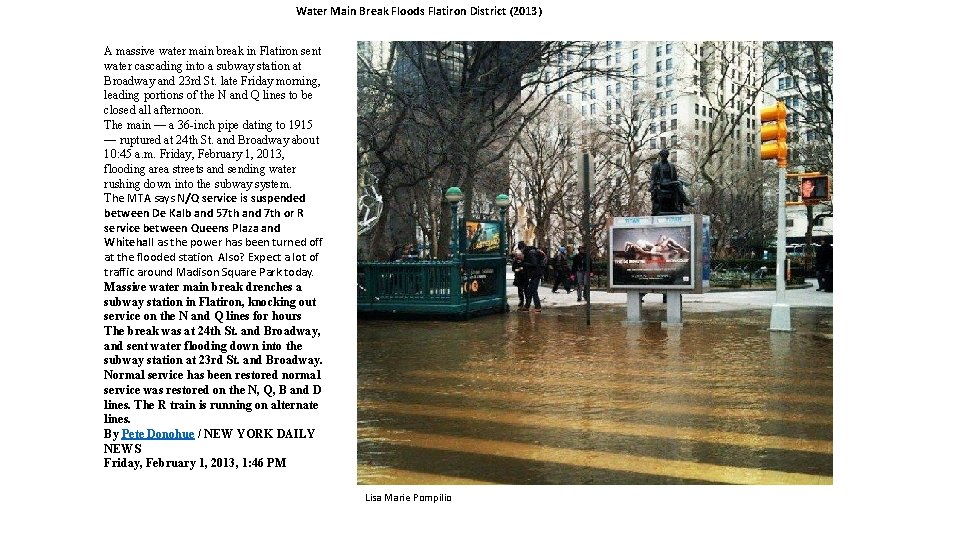

Water Main Break Floods Flatiron District (2013) A massive water main break in Flatiron sent water cascading into a subway station at Broadway and 23 rd St. late Friday morning, leading portions of the N and Q lines to be closed all afternoon. The main — a 36 -inch pipe dating to 1915 — ruptured at 24 th St. and Broadway about 10: 45 a. m. Friday, February 1, 2013, flooding area streets and sending water rushing down into the subway system. The MTA says N/Q service is suspended between De Kalb and 57 th and 7 th or R service between Queens Plaza and Whitehall as the power has been turned off at the flooded station. Also? Expect a lot of traffic around Madison Square Park today. Massive water main break drenches a subway station in Flatiron, knocking out service on the N and Q lines for hours The break was at 24 th St. and Broadway, and sent water flooding down into the subway station at 23 rd St. and Broadway. Normal service has been restored normal service was restored on the N, Q, B and D lines. The R train is running on alternate lines. By Pete Donohue / NEW YORK DAILY NEWS Friday, February 1, 2013, 1: 46 PM Lisa Marie Pompilio

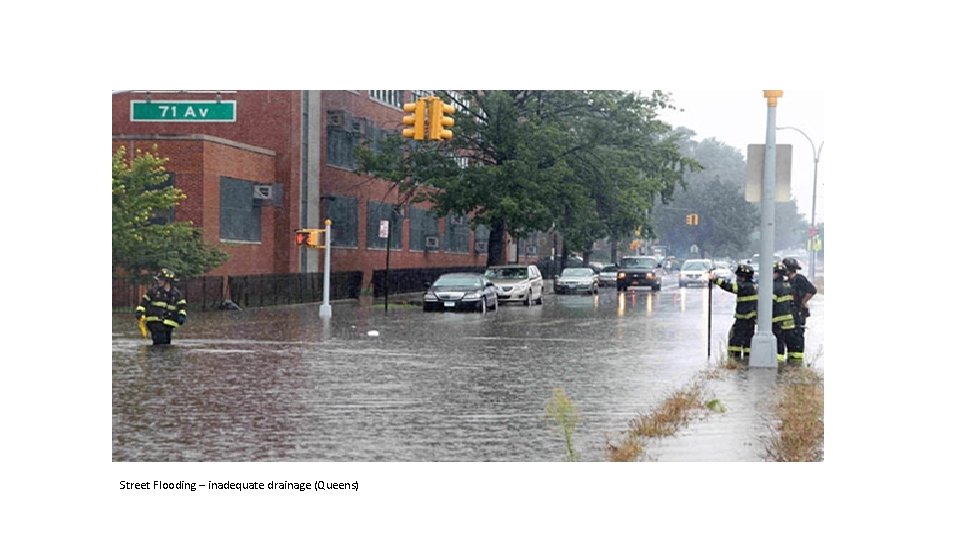

Street Flooding – inadequate drainage (Queens)

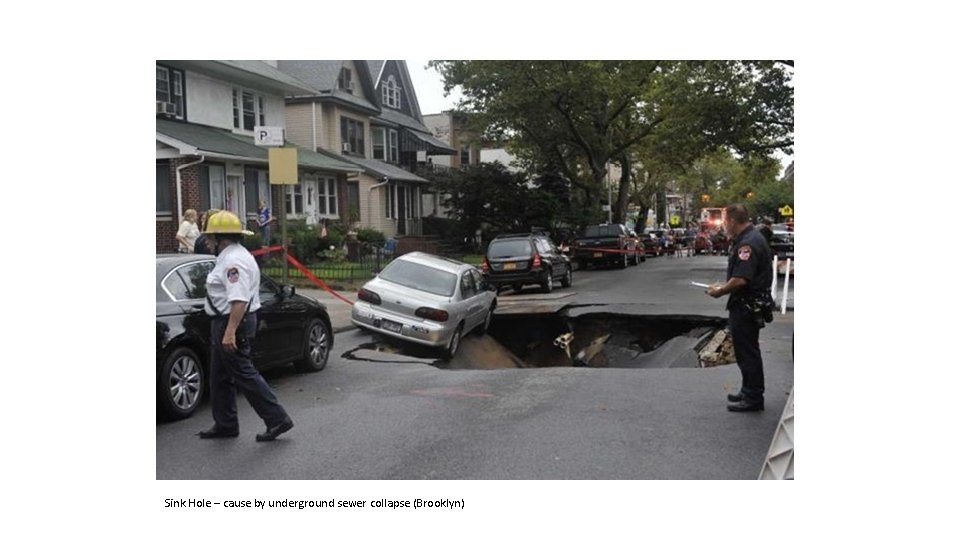

Sink Hole – cause by underground sewer collapse (Brooklyn)

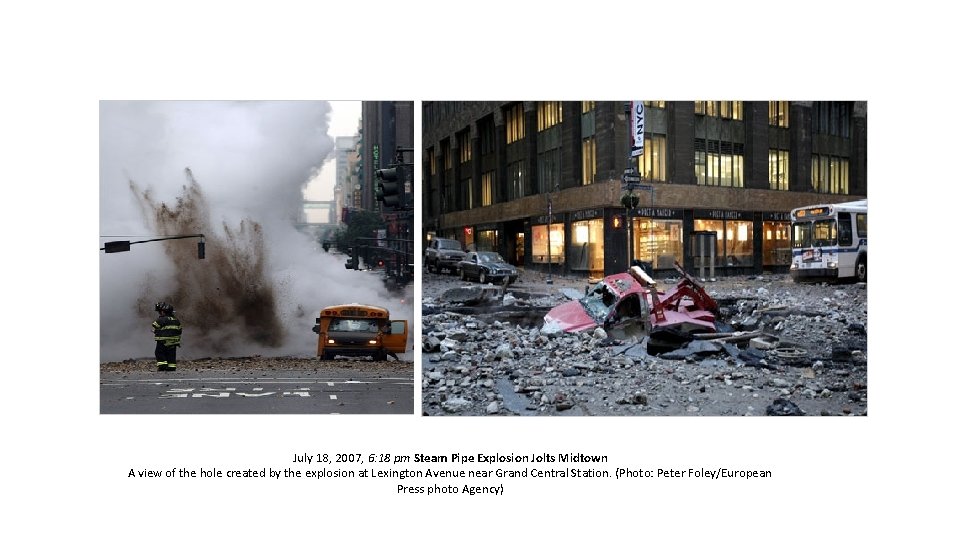

July 18, 2007, 6: 18 pm Steam Pipe Explosion Jolts Midtown A view of the hole created by the explosion at Lexington Avenue near Grand Central Station. (Photo: Peter Foley/European Press photo Agency)

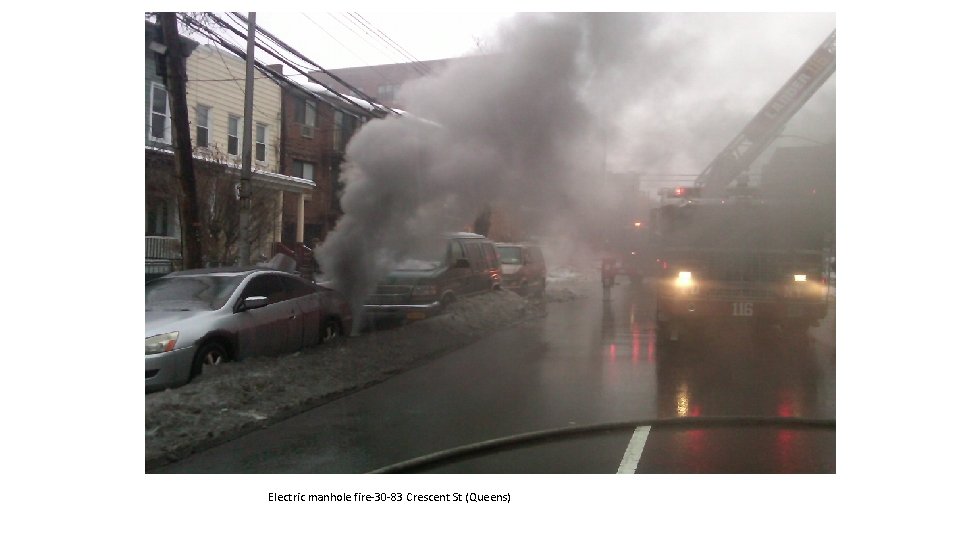

Electric manhole fire-30 -83 Crescent St (Queens)
SCOPE OF WORK TO BE PERFORMED

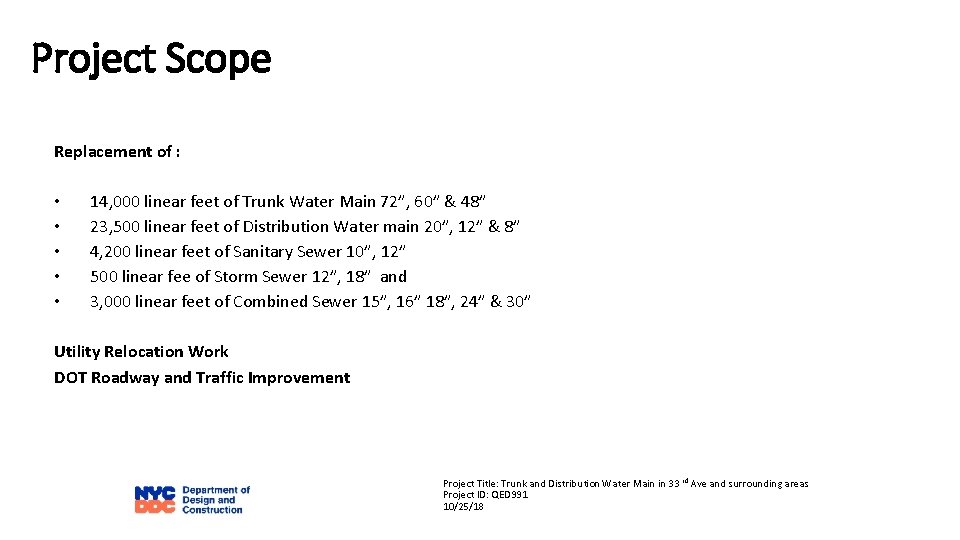

Project Scope Replacement of : • 14, 000 linear feet of Trunk Water Main 72”, 60” & 48” • 23, 500 linear feet of Distribution Water main 20”, 12” & 8” • 4, 200 linear feet of Sanitary Sewer 10”, 12” • 500 linear fee of Storm Sewer 12”, 18” and • 3, 000 linear feet of Combined Sewer 15”, 16” 18”, 24” & 30” Utility Relocation Work DOT Roadway and Traffic Improvement Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
WHERE WILL THE WORK BE PERFORMED?

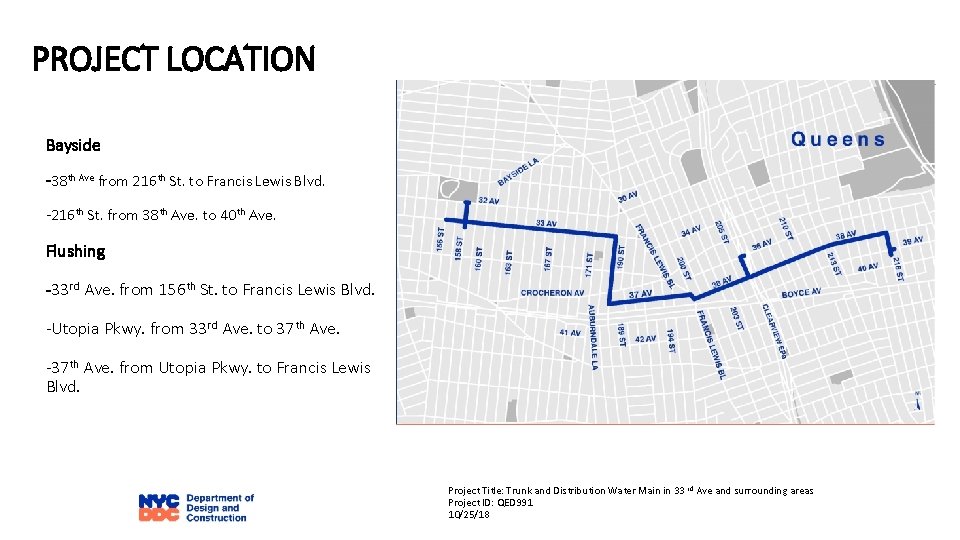

PROJECT LOCATION Bayside -38 th Ave from 216 th St. to Francis Lewis Blvd. -216 th St. from 38 th Ave. to 40 th Ave. Flushing -33 rd Ave. from 156 th St. to Francis Lewis Blvd. -Utopia Pkwy. from 33 rd Ave. to 37 th Ave. -37 th Ave. from Utopia Pkwy. to Francis Lewis Blvd. Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

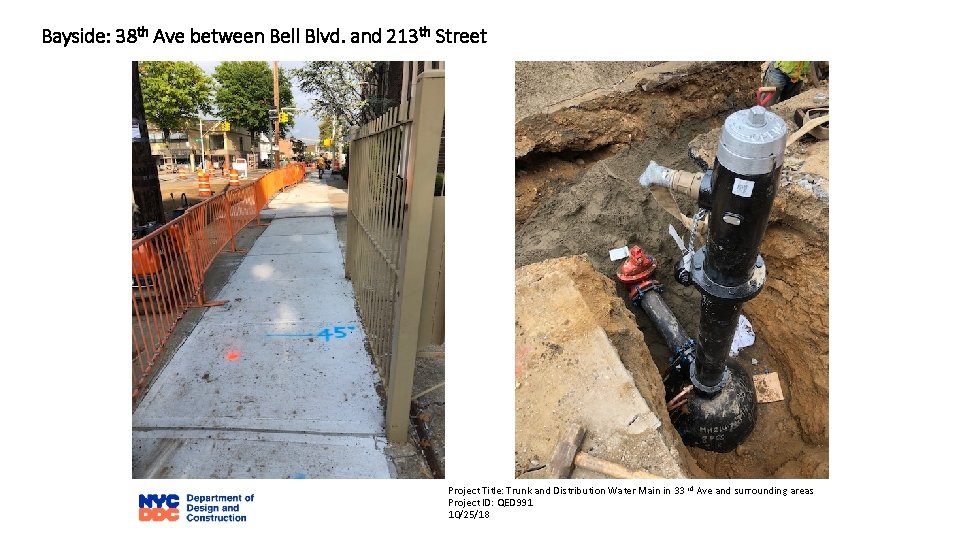

Bayside: 38 th Ave between Bell Blvd. and 213 th Street Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

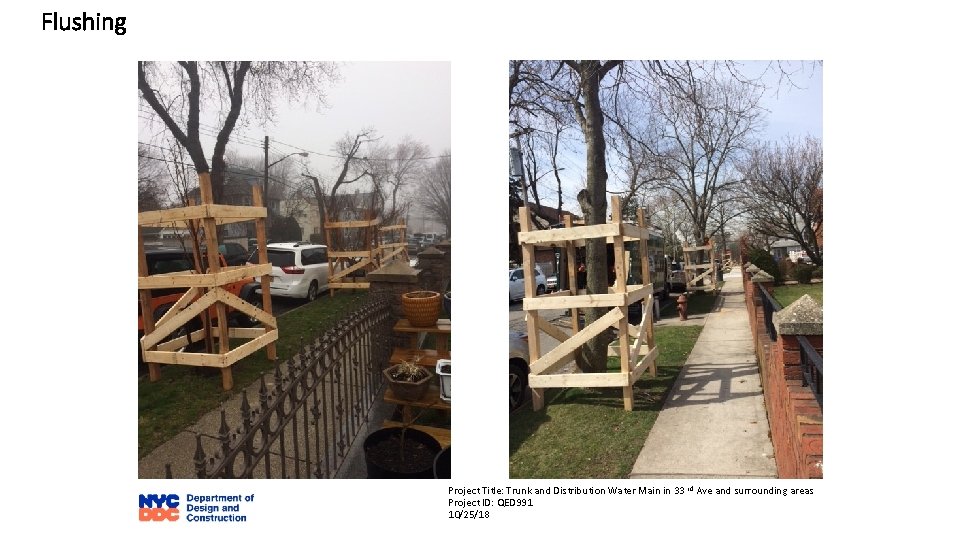

Flushing Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

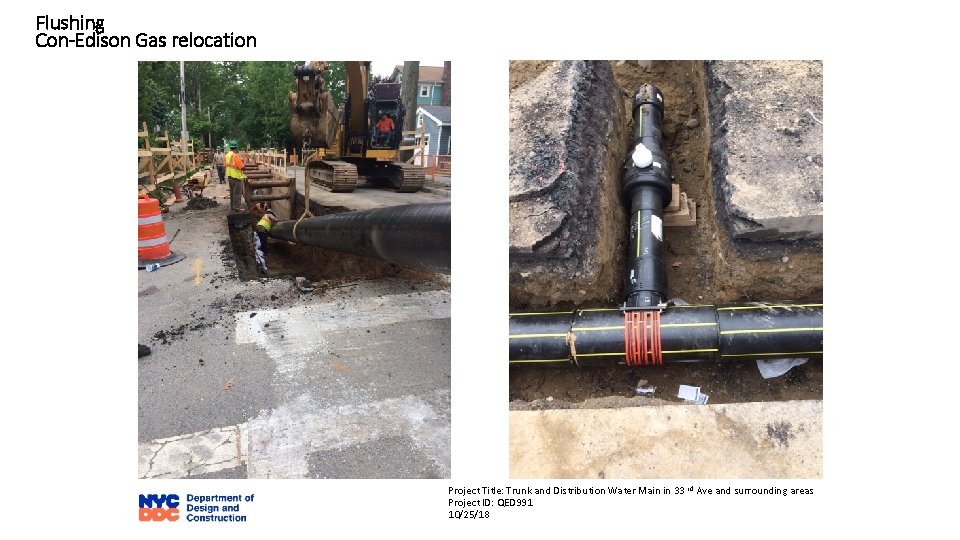

Flushing Con-Edison Gas relocation Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

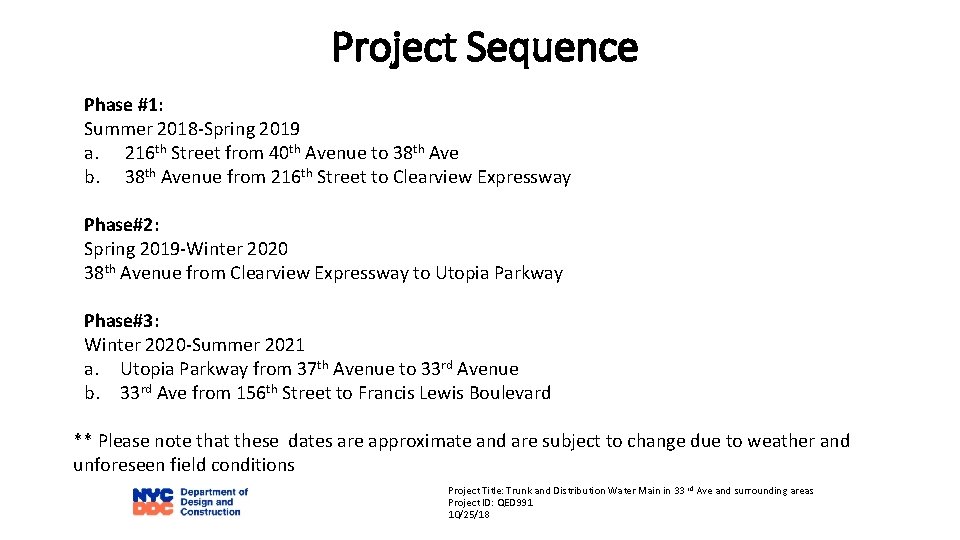

Project Sequence Phase #1: Summer 2018 -Spring 2019 a. 216 th Street from 40 th Avenue to 38 th Ave b. 38 th Avenue from 216 th Street to Clearview Expressway Phase#2: Spring 2019 -Winter 2020 38 th Avenue from Clearview Expressway to Utopia Parkway Phase#3: Winter 2020 -Summer 2021 a. Utopia Parkway from 37 th Avenue to 33 rd Avenue b. 33 rd Ave from 156 th Street to Francis Lewis Boulevard ** Please note that these dates are approximate and are subject to change due to weather and unforeseen field conditions Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
WORKING HOURS AND TRAFFIC STIPULATIONS

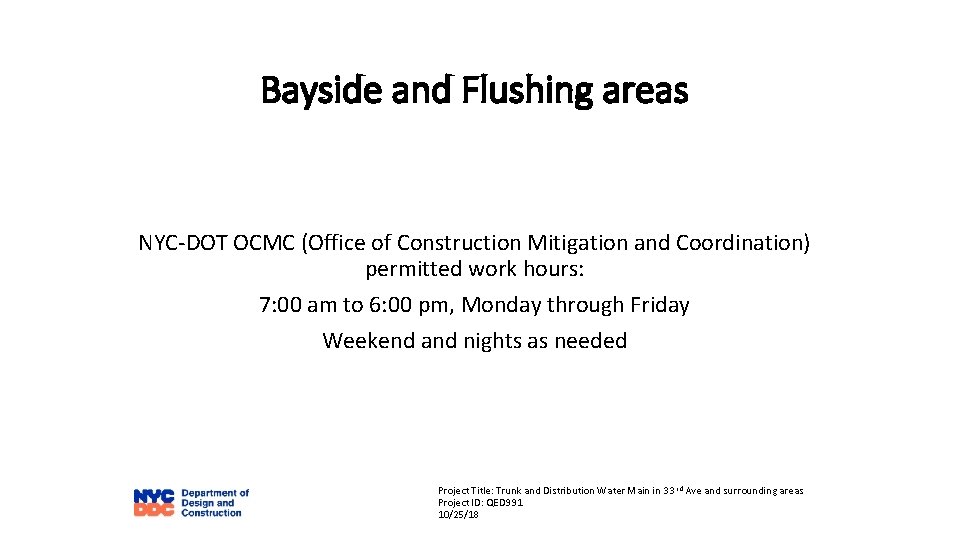

Bayside and Flushing areas NYC-DOT OCMC (Office of Construction Mitigation and Coordination) permitted work hours: 7: 00 am to 6: 00 pm, Monday through Friday Weekend and nights as needed Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
Traffic Stipulations • Contractor shall maintain (1) 12 foot lane for local and emergency traffic during working hours. • Contractor shall maintain (1) 11 foot lane on one way streets and (2) 11 foot lanes on two way streets, where possible. • Contractor must maintain a 5 foot clear sidewalk for pedestrians at all times Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS
COMMUNITY IMPACTS Water Service Interruptions • Scheduled water service interruptions. • 72 hours and 24 hours prior advance notice with instructions will be provided. • If your water service is not restored by the time indicated on the Shutoff Notice, please contact the Community Construction Liaison (CCL) or 311 if after hours. Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS 72 Hour Water Community Advisory E L P M A S Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS 24 Hour Water Community Notice E L P M A S Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS Pedestrian and Traffic Interruptions The DDC is committed to maintaining a work site that is safe and clean Pedestrian/Traffic • Pedestrian access to buildings will be maintained at all times • Street Closures may be required -Warning signs will be posted • Driveway access and curbside parking may be temporarily restricted during construction • Parking may be temporarily restricted -Signs will be posted where necessary and advance notification provided Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS No-Parking/Tow Away Notice S M A E L P Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY OUTREACH Weekly Construction Bulletin E L P M A S Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY OUTREACH S M A E L P On Site Community Construction Liaison Project Information card Newsletters Email alerts On going communication with Community Board 7 and other Stakeholders. Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
COMMUNITY IMPACTS Rodent Control • Rodent Survey will be performed by a licensed exterminator prior to construction • The contractor will be baiting within the construction zone as required by the contract • Rodent Control Stations will be installed and monitored by a professional rodent control specialist Special Needs • Individual with special needs should contact the Community Construction (CCL) • The DDC field staff will work specifically with those individuals to minimize the inconvenience Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18

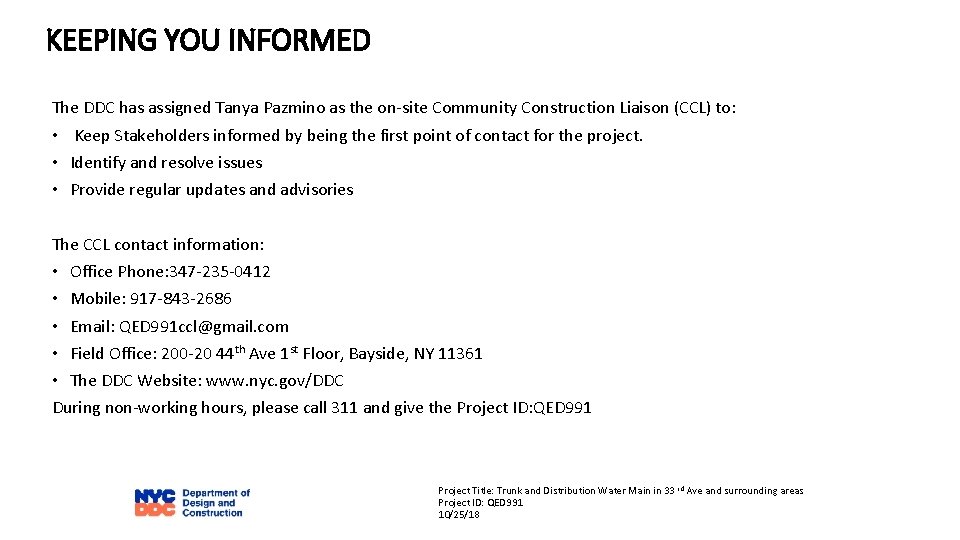

KEEPING YOU INFORMED The DDC has assigned Tanya Pazmino as the on-site Community Construction Liaison (CCL) to: • Keep Stakeholders informed by being the first point of contact for the project. • Identify and resolve issues • Provide regular updates and advisories The CCL contact information: • Office Phone: 347 -235 -0412 • Mobile: 917 -843 -2686 • Email: QED 991 ccl@gmail. com • Field Office: 200 -20 44 th Ave 1 st Floor, Bayside, NY 11361 • The DDC Website: www. nyc. gov/DDC During non-working hours, please call 311 and give the Project ID: QED 991 Project Title: Trunk and Distribution Water Main in 33 rd Ave and surrounding areas Project ID: QED 991 10/25/18
QUESTION & ANSWERS
