New test structures: Status report and technical documentation review Case structures : Extra: 11

New test structures: Status report and technical documentation review Case structures : Extra: 11 WNSDVG 1. KS N 2 (T 18) PETS 11. 4 GHz with damping material BAAN, ERP-package for inventory management Margarita Saifoulina & Maria Filippova BE/RF Input from: Andrey Olyunin Germana Riddone Serge Lebet

CATIA/Smarteam & EDMS/MTF

CATIA/Smarteam & EDMS/MTF

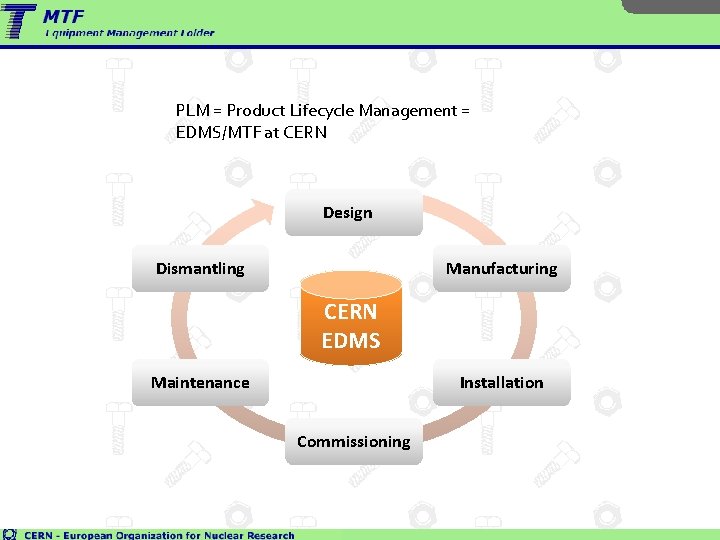

PLM = Product Lifecycle Management = EDMS/MTF at CERN Design Manufacturing Dismantling CERN EDMS

PLM = Product Lifecycle Management = EDMS/MTF at CERN Design Manufacturing Dismantling CERN EDMS Installation Maintenance Commissioning

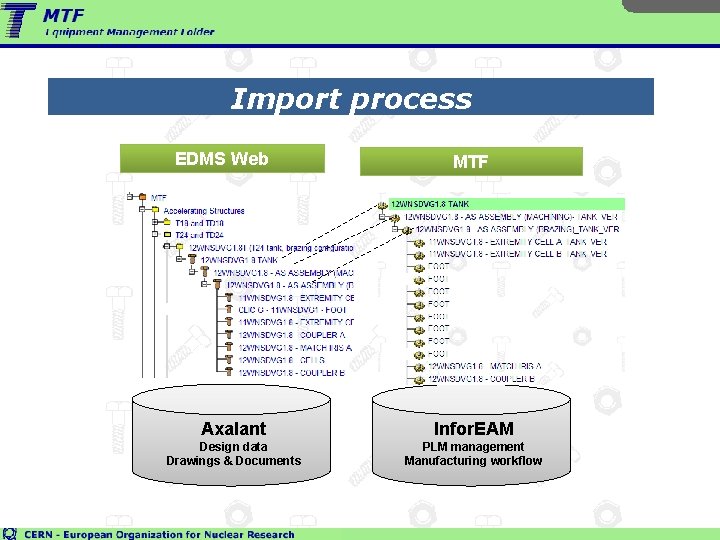

Import process EDMS Web MTF Axalant Infor. EAM Design data Drawings & Documents PLM

Import process EDMS Web MTF Axalant Infor. EAM Design data Drawings & Documents PLM management Manufacturing workflow

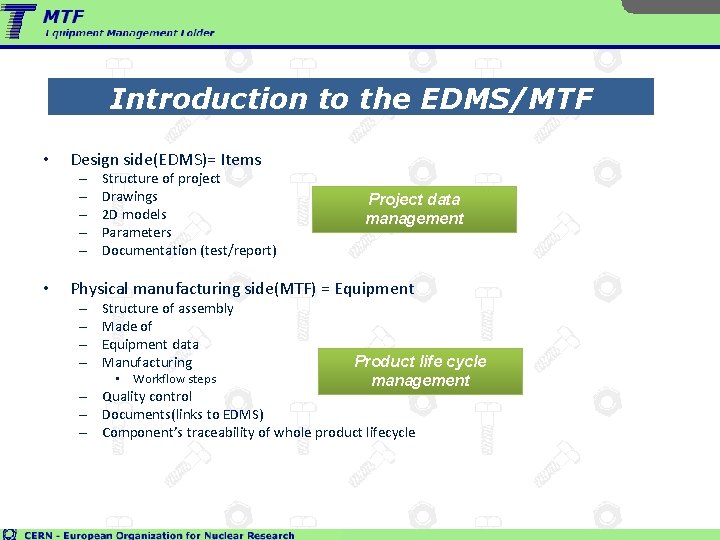

Introduction to the EDMS/MTF • Design side(EDMS)= Items – – – • Structure of

Introduction to the EDMS/MTF • Design side(EDMS)= Items – – – • Structure of project Drawings 2 D models Parameters Documentation (test/report) Project data management Physical manufacturing side(MTF) = Equipment – – Structure of assembly Made of Equipment data Manufacturing • Workflow steps Product life cycle management – Quality control – Documents(links to EDMS) – Component’s traceability of whole product lifecycle

Manufacturing Workflow in MTF • Describes the manufacturing process Easy to identify data when

Manufacturing Workflow in MTF • Describes the manufacturing process Easy to identify data when it appears along with the equipment being manufactured

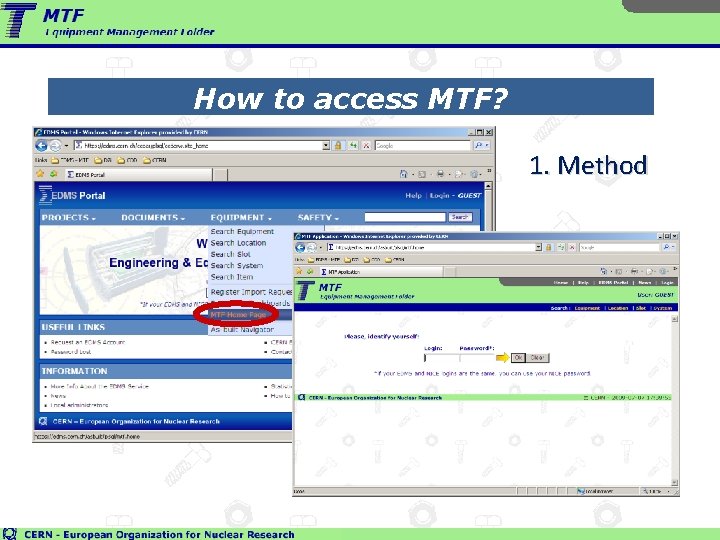

How to access MTF? 1. Method

How to access MTF? 1. Method

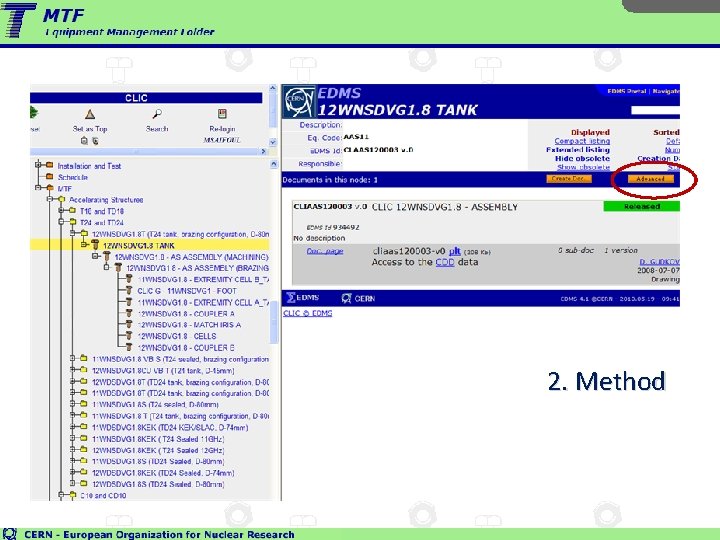

2. Method

2. Method

11 WNSDVG 1. KS N 2 (T 18) Now it’s ready for shipment

11 WNSDVG 1. KS N 2 (T 18) Now it’s ready for shipment

PETS 11. 4 GHz with damping material Now it’s ready for final bake-out

PETS 11. 4 GHz with damping material Now it’s ready for final bake-out

Notification letter for MTF Proposal of letter content: Please find new attached report document

Notification letter for MTF Proposal of letter content: Please find new attached report document in MTF, under the structure '11 WNSDVG 1. 8 VB S- CLAAS 110277 -CR 000002'. https: //edms. cern. ch/asbuilt/plsql/mtf_equip. eqp_work_top? cooki =9270257&p_rec_id=CLAAS 110277 -CR 000002&p_rec_type EDMS id. of document 1065640 (ver. 1) RF design and parameters of 11. 424 GHz T 24_vg 1. 8_disk. ( or 11 WNSDvg 1. 8; or CLIC_G undamped) created by Alexej GRUDIEV https: //edms. cern. ch/document/1065640/1

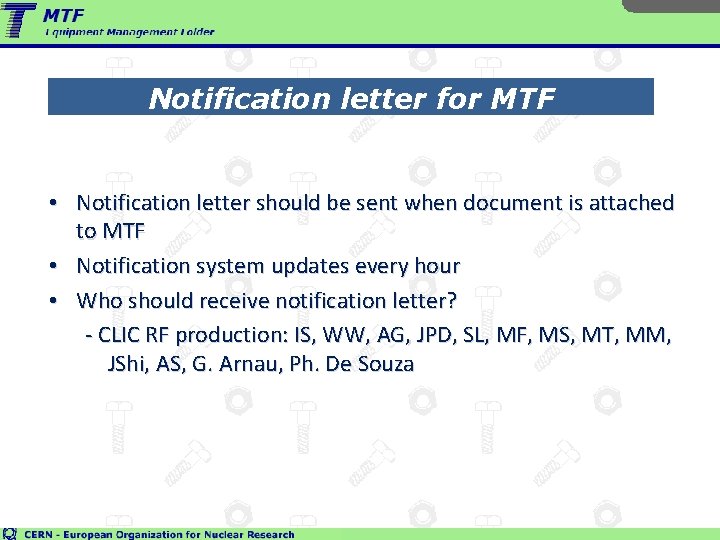

Notification letter for MTF • Notification letter should be sent when document is attached

Notification letter for MTF • Notification letter should be sent when document is attached to MTF • Notification system updates every hour • Who should receive notification letter? - CLIC RF production: IS, WW, AG, JPD, SL, MF, MS, MT, MM, JShi, AS, G. Arnau, Ph. De Souza

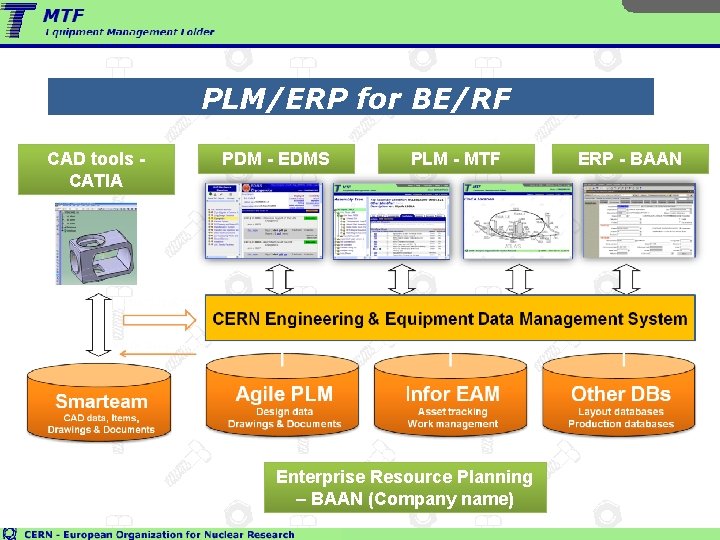

PLM/ERP for BE/RF CAD tools CATIA PDM - EDMS PLM - MTF Enterprise Resource

PLM/ERP for BE/RF CAD tools CATIA PDM - EDMS PLM - MTF Enterprise Resource Planning – BAAN (Company name) ERP - BAAN

BAAN – Inventory Management • ERP- package used by CERN since 1995 • It’s

BAAN – Inventory Management • ERP- package used by CERN since 1995 • It’s integrated to other applications such as EDH and Qualiac, which is another ERP package for purchasing and logistics export/import documentation • Component’s traceability of whole product lifecycle in different levels of intra- and inter- organizational integration in one place

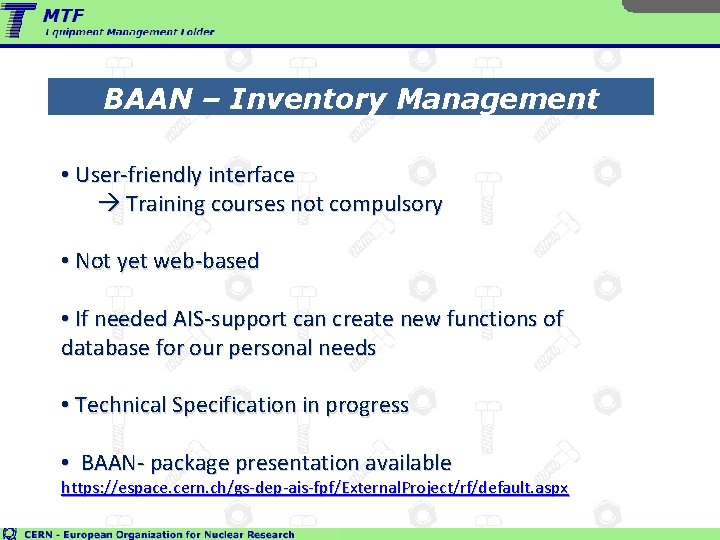

BAAN – Inventory Management • User-friendly interface Training courses not compulsory • Not yet

BAAN – Inventory Management • User-friendly interface Training courses not compulsory • Not yet web-based • If needed AIS-support can create new functions of database for our personal needs • Technical Specification in progress • BAAN- package presentation available https: //espace. cern. ch/gs-dep-ais-fpf/External. Project/rf/default. aspx

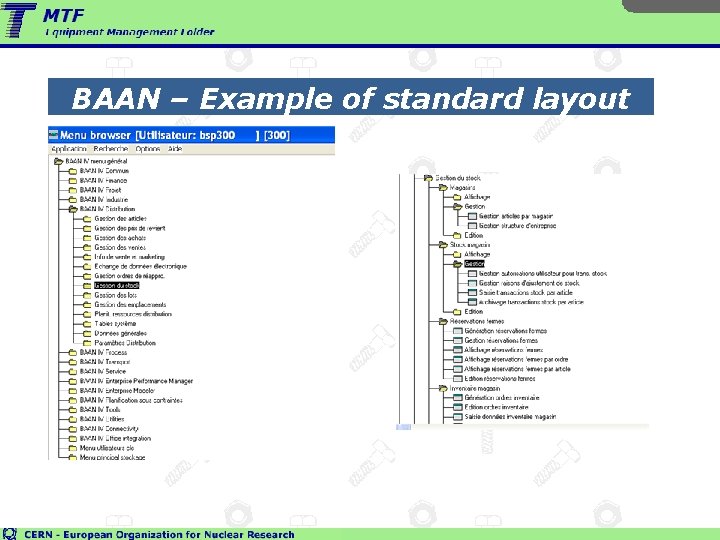

BAAN – Example of standard layout

BAAN – Example of standard layout

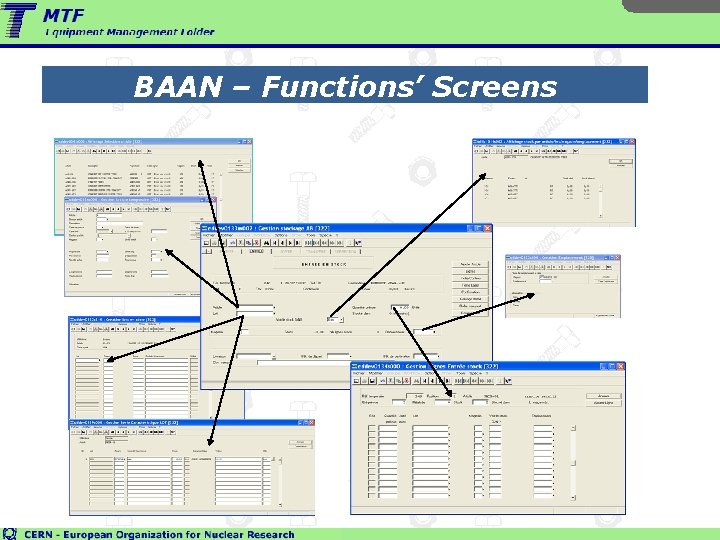

BAAN – Functions’ Screens

BAAN – Functions’ Screens

BAAN – Stock Management

BAAN – Stock Management

Conclusion • PLM/ERP eliminates: The lack of information Waste of time Inefficiency of component’s

Conclusion • PLM/ERP eliminates: The lack of information Waste of time Inefficiency of component’s whole lifecycle, not only in manufacturing • If used properly PLM/ERP increase productivity • Future actions: Inventory management is needed Standard information in reports for data management: what was done, who did, when, where
