Net. Plan – A Practitioner’s Experience HASTUS International User Group September 2012 Phillip Boyle

Net. Plan – A Practitioner’s Experience HASTUS International User Group September 2012 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project 4. Net. Plan Solutions to Implementable Outcomes September 2012 2 Phillip Boyle & Associates

Phillip Boyle & Associates has worldwide experience in use of Hastus and Net. Plan

Phillip Boyle & Associates has worldwide experience in use of Hastus and Net. Plan to produce successful operating outcomes September 2012 3 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project 4. Net. Plan Solutions to Implementable Outcomes September 2012 4 Phillip Boyle & Associates

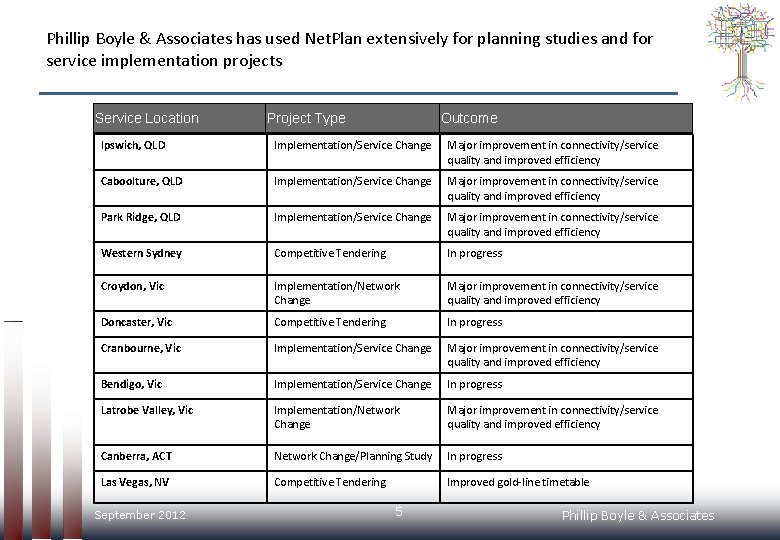

Phillip Boyle & Associates has used Net. Plan extensively for planning studies and for

Phillip Boyle & Associates has used Net. Plan extensively for planning studies and for service implementation projects Service Location Project Type Outcome Ipswich, QLD Implementation/Service Change Major improvement in connectivity/service quality and improved efficiency Caboolture, QLD Implementation/Service Change Major improvement in connectivity/service quality and improved efficiency Park Ridge, QLD Implementation/Service Change Major improvement in connectivity/service quality and improved efficiency Western Sydney Competitive Tendering In progress Croydon, Vic Implementation/Network Change Major improvement in connectivity/service quality and improved efficiency Doncaster, Vic Competitive Tendering In progress Cranbourne, Vic Implementation/Service Change Major improvement in connectivity/service quality and improved efficiency Bendigo, Vic Implementation/Service Change In progress Latrobe Valley, Vic Implementation/Network Change Major improvement in connectivity/service quality and improved efficiency Canberra, ACT Network Change/Planning Study In progress Las Vegas, NV Competitive Tendering Improved gold-line timetable September 2012 5 Phillip Boyle & Associates

Westside Bus, Ipswich (Queensland) Service Area • 18 bus routes, 70 peak vehicles (incl.

Westside Bus, Ipswich (Queensland) Service Area • 18 bus routes, 70 peak vehicles (incl. schools) • Heavy rail service to downtown Brisbane requiring strong intermodal connectivity at five stations • Several routes serving common corridors Project Approach • Complete re-write of all timetables, on a revised network • Provide an implementable solution, complete with driver paddles and period rosters • Work with the bus company on behalf of the state (Translink) Outcomes • Major improvement in connectivity & timetable quality • Improved operating efficiencies • Increased patronage September 2012 6 Phillip Boyle & Associates

Westside Bus, Ipswich (Queensland) – Net. Plan Schematic September 2012 7 Phillip Boyle &

Westside Bus, Ipswich (Queensland) – Net. Plan Schematic September 2012 7 Phillip Boyle & Associates

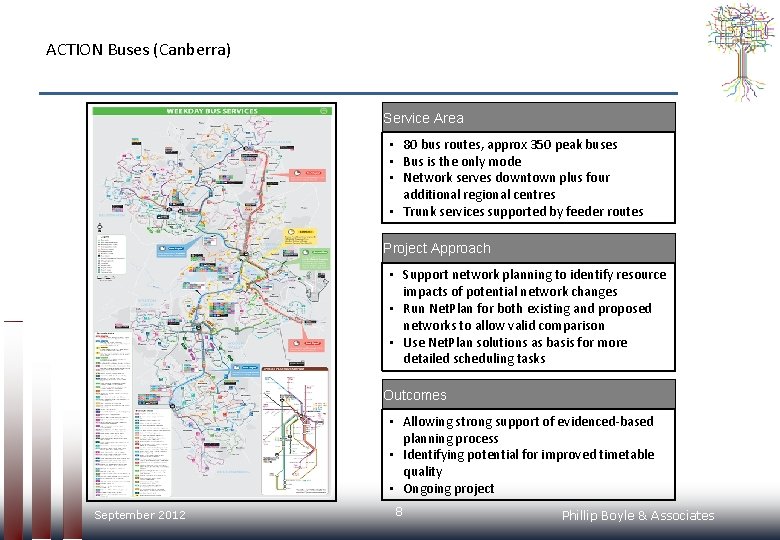

ACTION Buses (Canberra) Service Area • 80 bus routes, approx 350 peak buses •

ACTION Buses (Canberra) Service Area • 80 bus routes, approx 350 peak buses • Bus is the only mode • Network serves downtown plus four additional regional centres • Trunk services supported by feeder routes Project Approach • Support network planning to identify resource impacts of potential network changes • Run Net. Plan for both existing and proposed networks to allow valid comparison • Use Net. Plan solutions as basis for more detailed scheduling tasks Outcomes • Allowing strong support of evidenced-based planning process • Identifying potential for improved timetable quality • Ongoing project September 2012 8 Phillip Boyle & Associates

Caboolture (Queensland) Service Area • 6 bus routes, 8 peak buses • Heavy rail

Caboolture (Queensland) Service Area • 6 bus routes, 8 peak buses • Heavy rail service to downtown Brisbane requiring strong intermodal connectivity at five stations Project Approach • Complete re-write of all timetables, for an existing network • Provide an implementable solution, complete with driver paddles and period rosters • Work with the bus company on behalf of the state (Translink) Outcomes • Major improvement in connectivity & timetable quality • Improved operating efficiencies (8% more service for 2% more cost) • Strong patronage increases September 2012 9 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project 4. Net. Plan Solutions to Implementable Outcomes September 2012 10 Phillip Boyle & Associates

The Invicta bus network covers a substantial part of eastern Melbourne, operating 21 routes

The Invicta bus network covers a substantial part of eastern Melbourne, operating 21 routes with an additional 80 dedicated school services Existing Route Network - Invicta September 2012 11 Phillip Boyle & Associates

The network has a range of complexities that require sophisticated scheduling approaches A few

The network has a range of complexities that require sophisticated scheduling approaches A few challenges: ² Strong connectivity required with the heavy rail system ² A range of different route types, and sometimes vehicle types ² Some routes offer demand-responsive or flex-route configurations ² A number of dedicated school runs are operated and integrated (scheduling-wise) with the regular route services September 2012 12 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project process 4. Net. Plan Solutions to Implementable Outcomes September 2012 13 Phillip Boyle & Associates

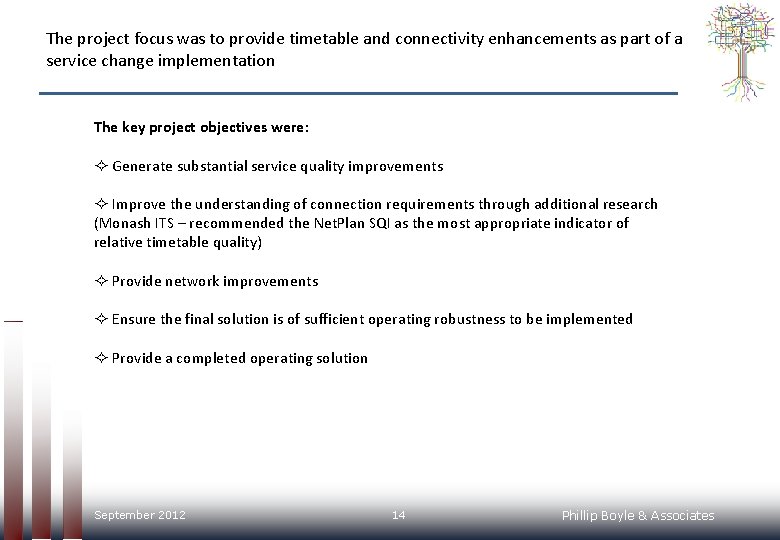

The project focus was to provide timetable and connectivity enhancements as part of a

The project focus was to provide timetable and connectivity enhancements as part of a service change implementation The key project objectives were: ² Generate substantial service quality improvements ² Improve the understanding of connection requirements through additional research (Monash ITS – recommended the Net. Plan SQI as the most appropriate indicator of relative timetable quality) ² Provide network improvements ² Ensure the final solution is of sufficient operating robustness to be implemented ² Provide a completed operating solution September 2012 14 Phillip Boyle & Associates

The network was defined in Net. Plan, with the heavy rail system fixed (for

The network was defined in Net. Plan, with the heavy rail system fixed (for connectivity) September 2012 15 Phillip Boyle & Associates

Many instances of common route corridors were also considered September 2012 16 Phillip Boyle

Many instances of common route corridors were also considered September 2012 16 Phillip Boyle & Associates

Over 70 meet builders were defined, both intermodal and bus-to-bus September 2012 17 Phillip

Over 70 meet builders were defined, both intermodal and bus-to-bus September 2012 17 Phillip Boyle & Associates

Of particular note was the need to, in some instances, build the whole-of-day timetable

Of particular note was the need to, in some instances, build the whole-of-day timetable based on travelling past the school at morning/afternoon bell times, but keeping an allday clockface Bell times modeled by defining a ‘route’ September 2012 18 Phillip Boyle & Associates

To understand how to weight/prioritize the meet builders, we undertook a system-wide on-board survey,

To understand how to weight/prioritize the meet builders, we undertook a system-wide on-board survey, using an advanced i. Pad data collection system, tracking the number of passengers transferring at key locations September 2012 19 Phillip Boyle & Associates

Our approach modeled alternatives to find the ‘sweet spot’ in the tradeoff between efficiency

Our approach modeled alternatives to find the ‘sweet spot’ in the tradeoff between efficiency and timetable quality/intermodal connectivity Off-Peak SQI Comparison Existing Off-Peak September 2012 20 Phillip Boyle & Associates

In the end a complete set of all day timetables, blocks and runs were

In the end a complete set of all day timetables, blocks and runs were developed from the Net. Plan solutions September 2012 21 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project Coordination Improvements Summary 4. Net. Plan Solutions to Implementable Outcomes September 2012 22 Phillip Boyle & Associates

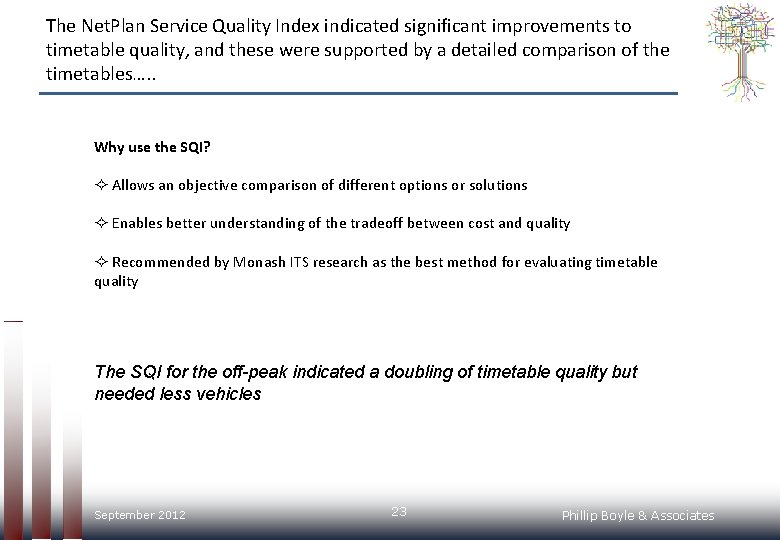

The Net. Plan Service Quality Index indicated significant improvements to timetable quality, and these

The Net. Plan Service Quality Index indicated significant improvements to timetable quality, and these were supported by a detailed comparison of the timetables…. . Why use the SQI? ² Allows an objective comparison of different options or solutions ² Enables better understanding of the tradeoff between cost and quality ² Recommended by Monash ITS research as the best method for evaluating timetable quality The SQI for the off-peak indicated a doubling of timetable quality but needed less vehicles September 2012 23 Phillip Boyle & Associates

On weekdays, there are 19% more scheduled connections within 12 minutes. September 2012 24

On weekdays, there are 19% more scheduled connections within 12 minutes. September 2012 24 Phillip Boyle & Associates

In particular, there has been a significant increase in scheduled connections of 3 to

In particular, there has been a significant increase in scheduled connections of 3 to 8 minutes September 2012 25 Phillip Boyle & Associates

On weekends, there are 42% more scheduled connections < 12 minutes. September 2012 26

On weekends, there are 42% more scheduled connections < 12 minutes. September 2012 26 Phillip Boyle & Associates

As a result, there are 50% fewer scheduled connections of greater than 20 minutes

As a result, there are 50% fewer scheduled connections of greater than 20 minutes on weekends. September 2012 27 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project Patronage impacts after 12 months 4. Net. Plan Solutions to Implementable Outcomes September 2012 28 Phillip Boyle & Associates

Overall patronage from May 2011 to May 2012 has increased by over 15 percent

Overall patronage from May 2011 to May 2012 has increased by over 15 percent on the eight routes surveyed Route May 2011 May 2012 Change 664 1, 498 1, 586 6% 671 192 165 -14% 672 167 236 41% 675 92 131 42% 676 98 100 2% 677 171 154 -10% 691 1, 192 1, 280 7% 693 1, 263 1, 715 36% Overall 4, 673 5, 367 15% Source – PBA surveys conducted in May 2011 & May 2012 September 2012 29 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project Changes in connectivity patterns 4. Net. Plan Solutions to Implementable Outcomes September 2012 30 Phillip Boyle & Associates

The survey results show a signifcant increase in passengers transferring between buses and trains,

The survey results show a signifcant increase in passengers transferring between buses and trains, well above general patronage level increases Invicta Phase 1 Summary of Weekday Patronage Changes Existing Proposed Change 4, 673 5, 367 694 (+15%) Total Connecting Passengers 849 1, 278 429 (+51%) Total Connecting Passengers as % of bus Patronage 18% 24% Total Bus Patronage Source – PBA surveys conducted in May 2011 & May 2012 September 2012 31 Phillip Boyle & Associates

Both on a per-route basis, with almost every route showing increases in the percentage

Both on a per-route basis, with almost every route showing increases in the percentage of connecting passengers…. . Source – PBA surveys conducted in May 2011 & May 2012 September 2012 32 Phillip Boyle & Associates

…. and by time of day, where only evening services show any reduction Source

…. and by time of day, where only evening services show any reduction Source – PBA surveys conducted in May 2011 & May 2012 September 2012 33 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project On-time running improvements 4. Net. Plan Solutions to Implementable Outcomes September 2012 34 Phillip Boyle & Associates

Finally, service reliability has also improved, with on-time running increasing overall from 73% to

Finally, service reliability has also improved, with on-time running increasing overall from 73% to 81% across all routes, and some routes showing substantial levels of improvement Source – PBA surveys conducted in May 2011 & May 2012 September 2012 35 Phillip Boyle & Associates

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling

1. Introduction 2. Our Net. Plan Experience 3. Project Focus – Invicta intermodal Scheduling Project 4. Net. Plan Solutions to Implementable Outcomes September 2012 36 Phillip Boyle & Associates
