National Aeronautics and Space Administration Implementing Earned Value Management (EVM) on NASA Contracts Agency EVM Capability Training Series Revised December 12, 2017 www. nasa. gov
Agenda • • • Background and Purpose Desired Learning Objectives NASA EVM Contract Policy Implementing EVM on Contracts Available Resources / Tools Summary 2

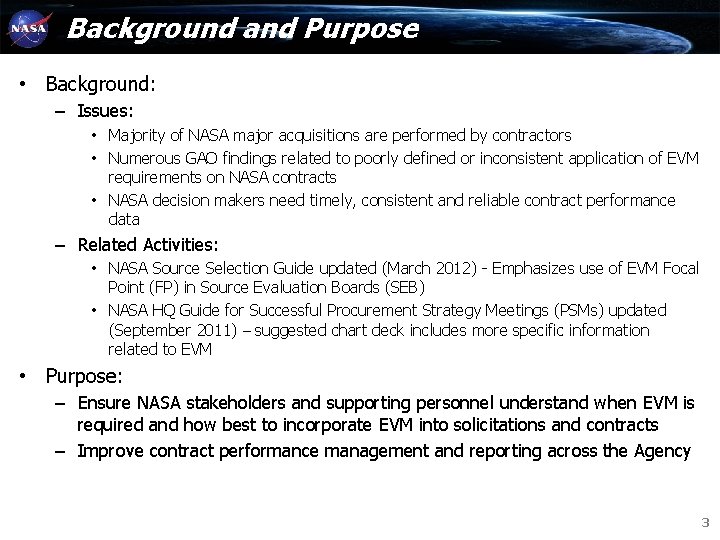

Background and Purpose • Background: – Issues: • Majority of NASA major acquisitions are performed by contractors • Numerous GAO findings related to poorly defined or inconsistent application of EVM requirements on NASA contracts • NASA decision makers need timely, consistent and reliable contract performance data – Related Activities: • NASA Source Selection Guide updated (March 2012) - Emphasizes use of EVM Focal Point (FP) in Source Evaluation Boards (SEB) • NASA HQ Guide for Successful Procurement Strategy Meetings (PSMs) updated (September 2011) – suggested chart deck includes more specific information related to EVM • Purpose: – Ensure NASA stakeholders and supporting personnel understand when EVM is required and how best to incorporate EVM into solicitations and contracts – Improve contract performance management and reporting across the Agency 3

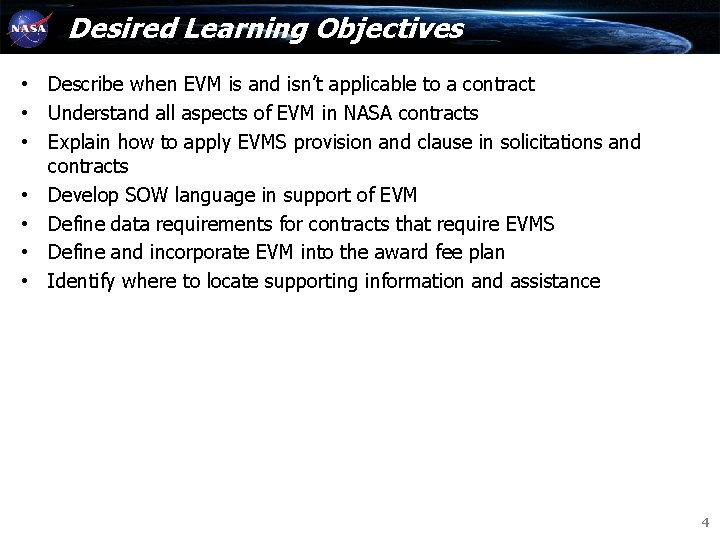

Desired Learning Objectives • Describe when EVM is and isn’t applicable to a contract • Understand all aspects of EVM in NASA contracts • Explain how to apply EVMS provision and clause in solicitations and contracts • Develop SOW language in support of EVM • Define data requirements for contracts that require EVMS • Define and incorporate EVM into the award fee plan • Identify where to locate supporting information and assistance 4
National Aeronautics and Space Administration NASA EVM Contract Policy www. nasa. gov 5

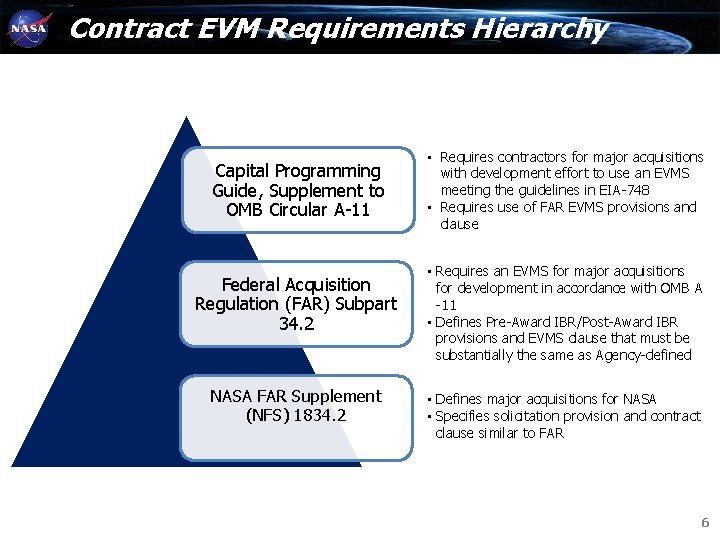

Contract EVM Requirements Hierarchy Capital Programming Guide, Supplement to OMB Circular A-11 Federal Acquisition Regulation (FAR) Subpart 34. 2 NASA FAR Supplement (NFS) 1834. 2 • Requires contractors for major acquisitions with development effort to use an EVMS meeting the guidelines in EIA-748 • Requires use of FAR EVMS provisions and clause • Requires an EVMS for major acquisitions for development in accordance with OMB A -11 • Defines Pre-Award IBR/Post-Award IBR provisions and EVMS clause that must be substantially the same as Agency-defined • Defines major acquisitions for NASA • Specifies solicitation provision and contract clause similar to FAR 6

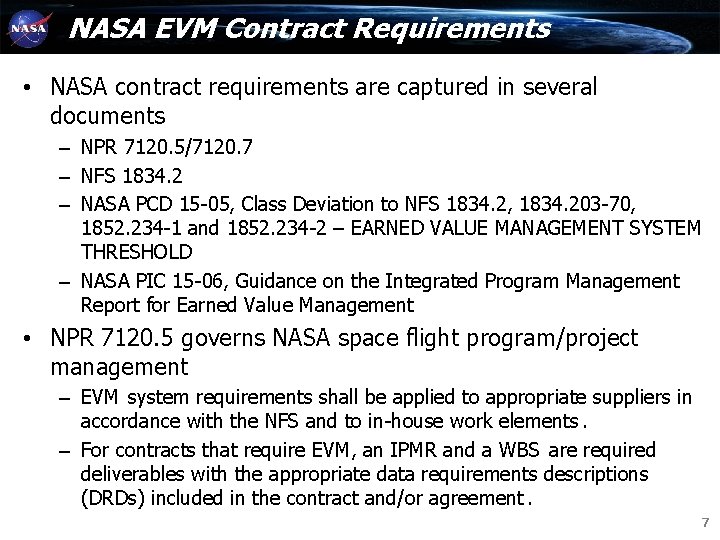

NASA EVM Contract Requirements • NASA contract requirements are captured in several documents – NPR 7120. 5/7120. 7 – NFS 1834. 2 – NASA PCD 15 -05, Class Deviation to NFS 1834. 2, 1834. 203 -70, 1852. 234 -1 and 1852. 234 -2 – EARNED VALUE MANAGEMENT SYSTEM THRESHOLD – NASA PIC 15 -06, Guidance on the Integrated Program Management Report for Earned Value Management • NPR 7120. 5 governs NASA space flight program/project management – EVM system requirements shall be applied to appropriate suppliers in accordance with the NFS and to in-house work elements. – For contracts that require EVM, an IPMR and a WBS are required deliverables with the appropriate data requirements descriptions (DRDs) included in the contract and/or agreement. 7

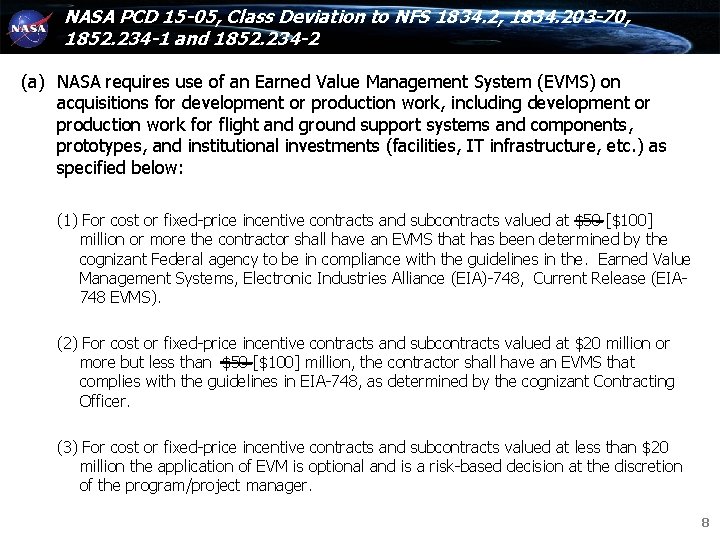

NASA PCD 15 -05, Class Deviation to NFS 1834. 2, 1834. 203 -70, 1852. 234 -1 and 1852. 234 -2 (a) NASA requires use of an Earned Value Management System (EVMS) on acquisitions for development or production work, including development or production work for flight and ground support systems and components, prototypes, and institutional investments (facilities, IT infrastructure, etc. ) as specified below: (1) For cost or fixed-price incentive contracts and subcontracts valued at $50 [$100] million or more the contractor shall have an EVMS that has been determined by the cognizant Federal agency to be in compliance with the guidelines in the. Earned Value Management Systems, Electronic Industries Alliance (EIA)-748, Current Release (EIA 748 EVMS). (2) For cost or fixed-price incentive contracts and subcontracts valued at $20 million or more but less than $50 [$100] million, the contractor shall have an EVMS that complies with the guidelines in EIA-748, as determined by the cognizant Contracting Officer. (3) For cost or fixed-price incentive contracts and subcontracts valued at less than $20 million the application of EVM is optional and is a risk-based decision at the discretion of the program/project manager. 8

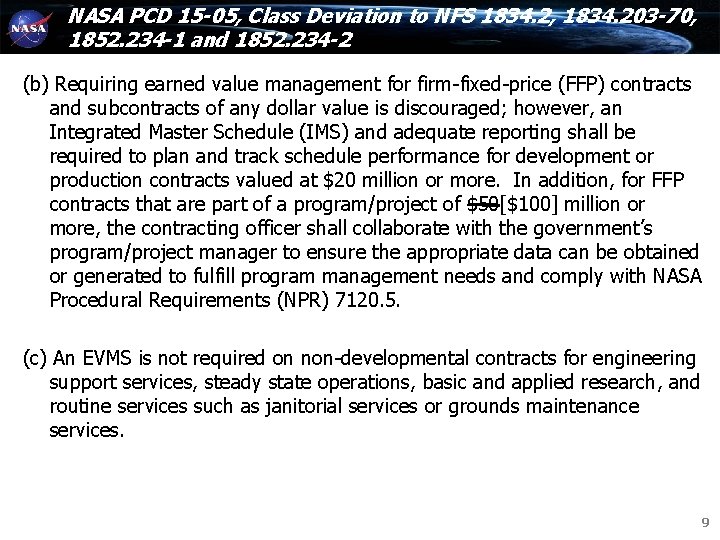

NASA PCD 15 -05, Class Deviation to NFS 1834. 2, 1834. 203 -70, 1852. 234 -1 and 1852. 234 -2 (b) Requiring earned value management for firm-fixed-price (FFP) contracts and subcontracts of any dollar value is discouraged; however, an Integrated Master Schedule (IMS) and adequate reporting shall be required to plan and track schedule performance for development or production contracts valued at $20 million or more. In addition, for FFP contracts that are part of a program/project of $50[$100] million or more, the contracting officer shall collaborate with the government’s program/project manager to ensure the appropriate data can be obtained or generated to fulfill program management needs and comply with NASA Procedural Requirements (NPR) 7120. 5. (c) An EVMS is not required on non-developmental contracts for engineering support services, steady state operations, basic and applied research, and routine services such as janitorial services or grounds maintenance services. 9

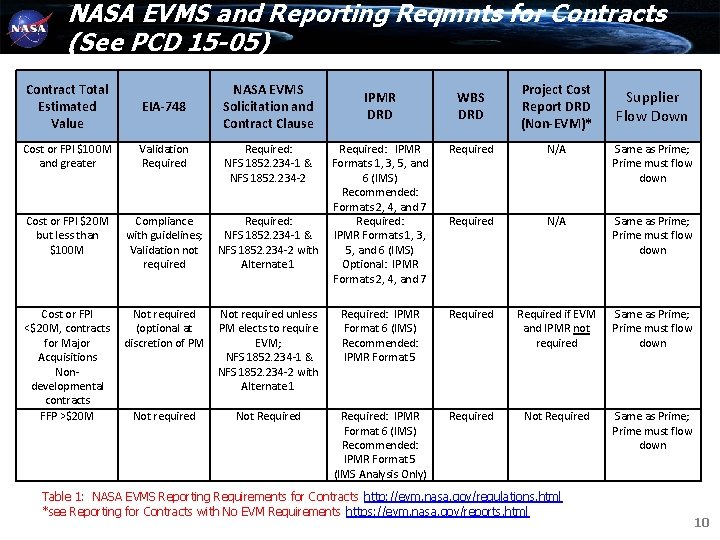

NASA EVMS and Reporting Reqmnts for Contracts (See PCD 15 -05) Contract Total Estimated Value NASA EVMS Solicitation and Contract Clause IPMR DRD WBS DRD Project Cost Report DRD (Non-EVM)* EIA-748 Supplier Flow Down Cost or FPI $100 M and greater Validation Required: NFS 1852. 234 -1 & NFS 1852. 234 -2 Required: IPMR Formats 1, 3, 5, and 6 (IMS) Recommended: Formats 2, 4, and 7 Required: IPMR Formats 1, 3, 5, and 6 (IMS) Optional: IPMR Formats 2, 4, and 7 Required N/A Same as Prime; Prime must flow down Cost or FPI $20 M but less than $100 M Compliance with guidelines; Validation not required Required: NFS 1852. 234 -1 & NFS 1852. 234 -2 with Alternate 1 Required N/A Same as Prime; Prime must flow down Cost or FPI <$20 M, contracts for Major Acquisitions Nondevelopmental contracts FFP >$20 M Not required (optional at discretion of PM Not required unless PM elects to require EVM; NFS 1852. 234 -1 & NFS 1852. 234 -2 with Alternate 1 Required: IPMR Format 6 (IMS) Recommended: IPMR Format 5 Required if EVM and IPMR not required Same as Prime; Prime must flow down Not required Not Required: IPMR Format 6 (IMS) Recommended: IPMR Format 5 (IMS Analysis Only) Required Not Required Same as Prime; Prime must flow down Table 1: NASA EVMS Reporting Requirements for Contracts http: //evm. nasa. gov/regulations. html *see Reporting for Contracts with No EVM Requirements https: //evm. nasa. gov/reports. html 10
National Aeronautics and Space Administration Implementing EVM on NASA Contracts www. nasa. gov 11

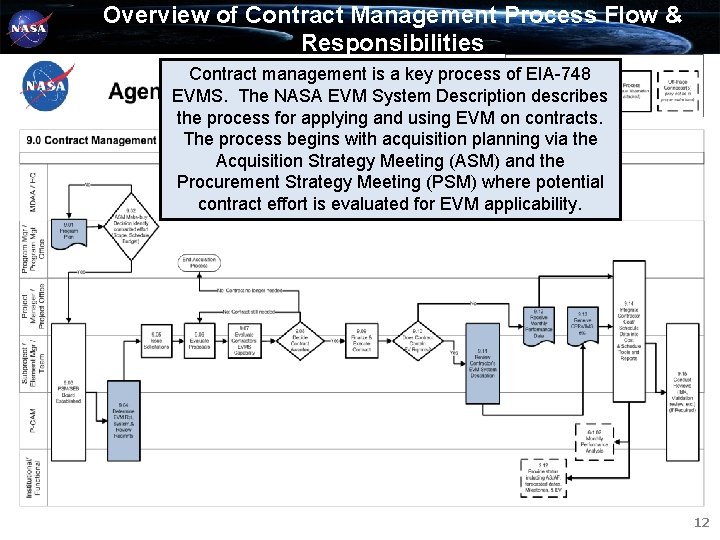

Overview of Contract Management Process Flow & Responsibilities Contract management is a key process of EIA-748 EVMS. The NASA EVM System Description describes the process for applying and using EVM on contracts. The process begins with acquisition planning via the Acquisition Strategy Meeting (ASM) and the Procurement Strategy Meeting (PSM) where potential contract effort is evaluated for EVM applicability. 12

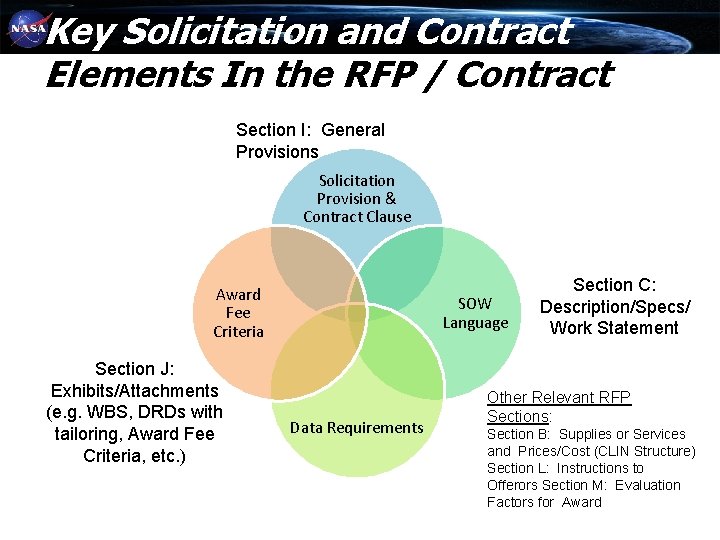

Key Solicitation and Contract Elements In the RFP / Contract Section I: General Provisions Solicitation Provision & Contract Clause Award Fee Criteria Section J: Exhibits/Attachments (e. g. WBS, DRDs with tailoring, Award Fee Criteria, etc. ) SOW Language Data Requirements Section C: Description/Specs/ Work Statement Other Relevant RFP Sections: Section B: Supplies or Services and Prices/Cost (CLIN Structure) Section L: Instructions to Offerors Section M: Evaluation Factors for Award
National Aeronautics and Space Administration Solicitation Provision and Contract Clause www. nasa. gov 14

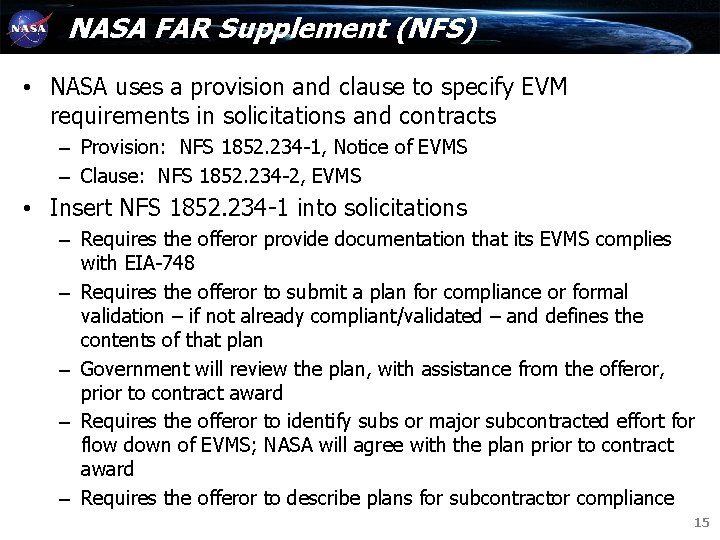

NASA FAR Supplement (NFS) • NASA uses a provision and clause to specify EVM requirements in solicitations and contracts – Provision: NFS 1852. 234 -1, Notice of EVMS – Clause: NFS 1852. 234 -2, EVMS • Insert NFS 1852. 234 -1 into solicitations – Requires the offeror provide documentation that its EVMS complies with EIA-748 – Requires the offeror to submit a plan for compliance or formal validation – if not already compliant/validated – and defines the contents of that plan – Government will review the plan, with assistance from the offeror, prior to contract award – Requires the offeror to identify subs or major subcontracted effort for flow down of EVMS; NASA will agree with the plan prior to contract award – Requires the offeror to describe plans for subcontractor compliance 15

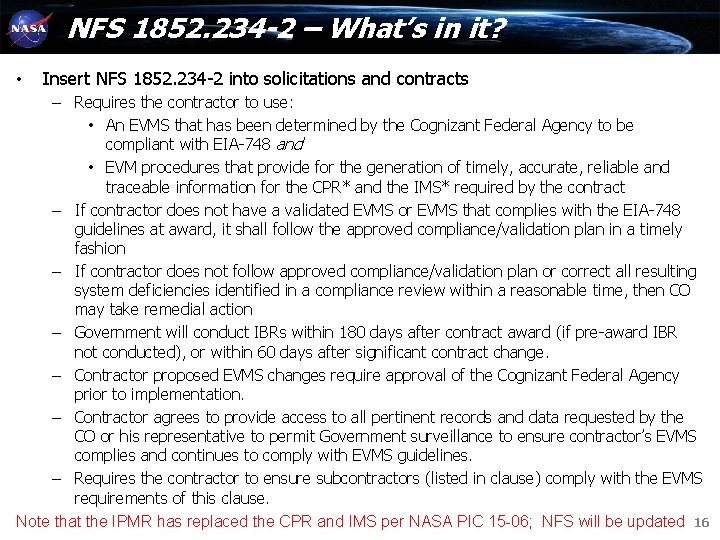

NFS 1852. 234 -2 – What’s in it? • Insert NFS 1852. 234 -2 into solicitations and contracts – Requires the contractor to use: • An EVMS that has been determined by the Cognizant Federal Agency to be compliant with EIA-748 and • EVM procedures that provide for the generation of timely, accurate, reliable and traceable information for the CPR* and the IMS* required by the contract – If contractor does not have a validated EVMS or EVMS that complies with the EIA-748 guidelines at award, it shall follow the approved compliance/validation plan in a timely fashion – If contractor does not follow approved compliance/validation plan or correct all resulting system deficiencies identified in a compliance review within a reasonable time, then CO may take remedial action – Government will conduct IBRs within 180 days after contract award (if pre-award IBR not conducted), or within 60 days after significant contract change. – Contractor proposed EVMS changes require approval of the Cognizant Federal Agency prior to implementation. – Contractor agrees to provide access to all pertinent records and data requested by the CO or his representative to permit Government surveillance to ensure contractor’s EVMS complies and continues to comply with EVMS guidelines. – Requires the contractor to ensure subcontractors (listed in clause) comply with the EVMS requirements of this clause. Note that the IPMR has replaced the CPR and IMS per NASA PIC 15 -06; NFS will be updated 16
Input to Clause • NFS 1852. 234 -1 can be inserted into the solicitation without modification • NFS 1852. 234 -2 will require inputs prior to incorporation – For the solicitation • Use Alternate I when the contract is valued at less than $100 M • Substitute Alternate I for paragraph b of the standard clause – For the contract • Identify subcontractor flow down 17

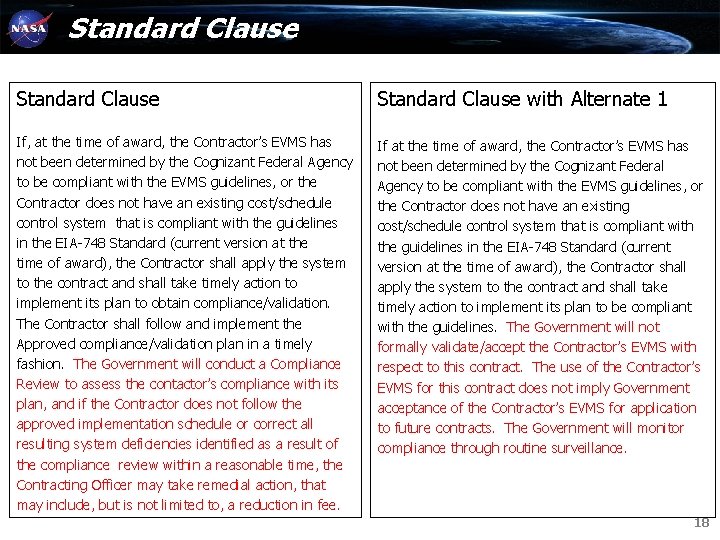

Standard Clause with Alternate 1 If, at the time of award, the Contractor’s EVMS has not been determined by the Cognizant Federal Agency to be compliant with the EVMS guidelines, or the Contractor does not have an existing cost/schedule control system that is compliant with the guidelines in the EIA-748 Standard (current version at the time of award), the Contractor shall apply the system to the contract and shall take timely action to implement its plan to obtain compliance/validation. The Contractor shall follow and implement the Approved compliance/validation plan in a timely fashion. The Government will conduct a Compliance Review to assess the contactor’s compliance with its plan, and if the Contractor does not follow the approved implementation schedule or correct all resulting system deficiencies identified as a result of the compliance review within a reasonable time, the Contracting Officer may take remedial action, that may include, but is not limited to, a reduction in fee. If at the time of award, the Contractor’s EVMS has not been determined by the Cognizant Federal Agency to be compliant with the EVMS guidelines, or the Contractor does not have an existing cost/schedule control system that is compliant with the guidelines in the EIA-748 Standard (current version at the time of award), the Contractor shall apply the system to the contract and shall take timely action to implement its plan to be compliant with the guidelines. The Government will not formally validate/accept the Contractor’s EVMS with respect to this contract. The use of the Contractor’s EVMS for this contract does not imply Government acceptance of the Contractor’s EVMS for application to future contracts. The Government will monitor compliance through routine surveillance. 18

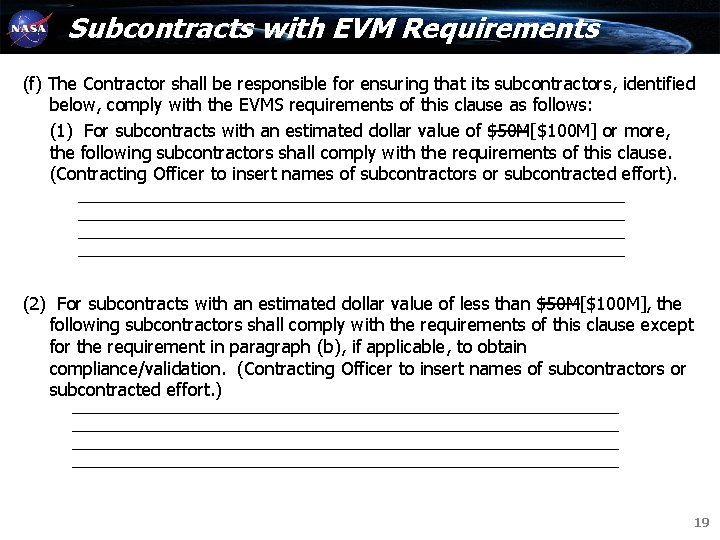

Subcontracts with EVM Requirements (f) The Contractor shall be responsible for ensuring that its subcontractors, identified below, comply with the EVMS requirements of this clause as follows: (1) For subcontracts with an estimated dollar value of $50 M[$100 M] or more, the following subcontractors shall comply with the requirements of this clause. (Contracting Officer to insert names of subcontractors or subcontracted effort). (2) For subcontracts with an estimated dollar value of less than $50 M[$100 M], the following subcontractors shall comply with the requirements of this clause except for the requirement in paragraph (b), if applicable, to obtain compliance/validation. (Contracting Officer to insert names of subcontractors or subcontracted effort. ) 19
National Aeronautics and Space Administration Statement of Work (SOW) www. nasa. gov 20
Statement of Work (SOW) • The SOW can be used to provide additional instructions and guidance to contractors when EVM is required. • The SOW shall not contain guidance or direction that conflicts with, removes, or adds work scope to the offeror’s validated EVMS. • Refer to Appendix C of the NASA EVM Implementation Handbook (NASA EVM Website http: //evm. nasa. gov/ ) for sample SOW language. 21

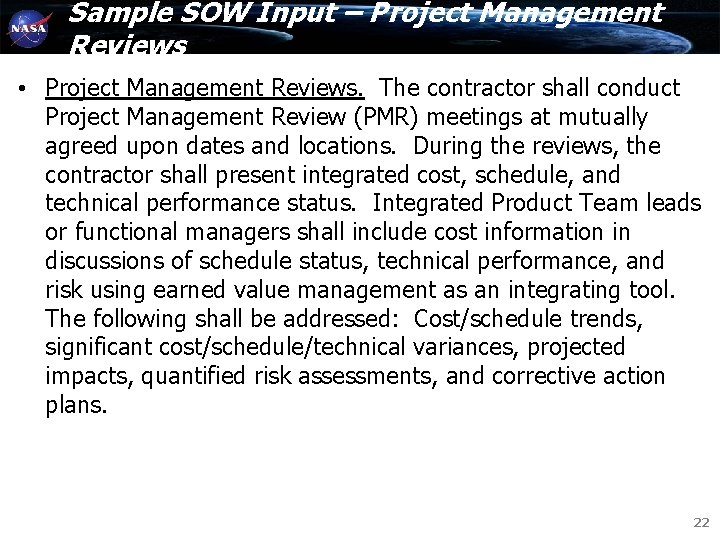

Sample SOW Input – Project Management Reviews • Project Management Reviews. The contractor shall conduct Project Management Review (PMR) meetings at mutually agreed upon dates and locations. During the reviews, the contractor shall present integrated cost, schedule, and technical performance status. Integrated Product Team leads or functional managers shall include cost information in discussions of schedule status, technical performance, and risk using earned value management as an integrating tool. The following shall be addressed: Cost/schedule trends, significant cost/schedule/technical variances, projected impacts, quantified risk assessments, and corrective action plans. 22

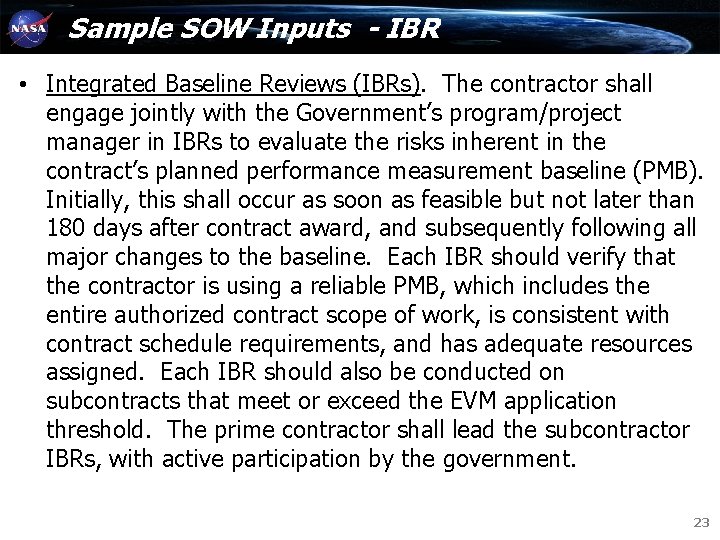

Sample SOW Inputs - IBR • Integrated Baseline Reviews (IBRs). The contractor shall engage jointly with the Government’s program/project manager in IBRs to evaluate the risks inherent in the contract’s planned performance measurement baseline (PMB). Initially, this shall occur as soon as feasible but not later than 180 days after contract award, and subsequently following all major changes to the baseline. Each IBR should verify that the contractor is using a reliable PMB, which includes the entire authorized contract scope of work, is consistent with contract schedule requirements, and has adequate resources assigned. Each IBR should also be conducted on subcontracts that meet or exceed the EVM application threshold. The prime contractor shall lead the subcontractor IBRs, with active participation by the government. 23
National Aeronautics and Space Administration Data Requirements www. nasa. gov 24

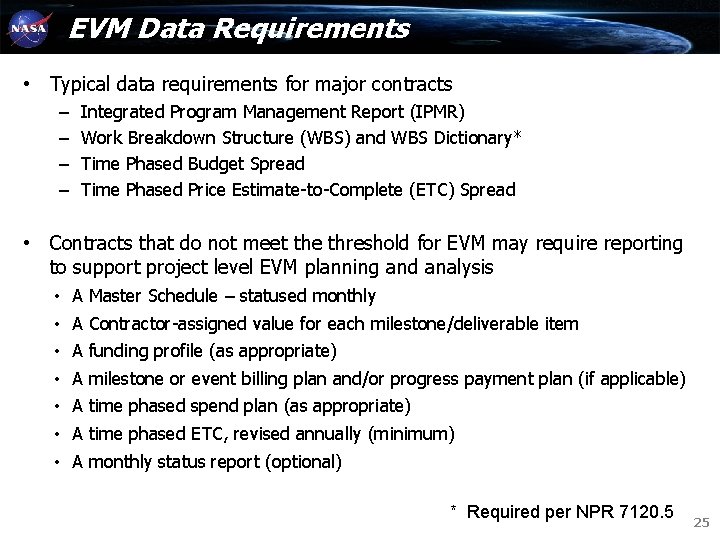

EVM Data Requirements • Typical data requirements for major contracts – – Integrated Program Management Report (IPMR) Work Breakdown Structure (WBS) and WBS Dictionary* Time Phased Budget Spread Time Phased Price Estimate-to-Complete (ETC) Spread • Contracts that do not meet the threshold for EVM may require reporting to support project level EVM planning and analysis • • A Master Schedule – statused monthly A Contractor-assigned value for each milestone/deliverable item A funding profile (as appropriate) A milestone or event billing plan and/or progress payment plan (if applicable) A time phased spend plan (as appropriate) A time phased ETC, revised annually (minimum) A monthly status report (optional) * Required per NPR 7120. 5 25

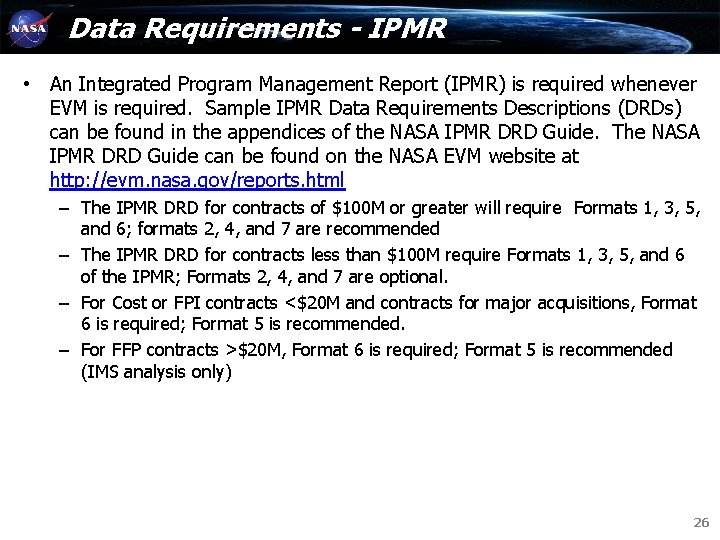

Data Requirements - IPMR • An Integrated Program Management Report (IPMR) is required whenever EVM is required. Sample IPMR Data Requirements Descriptions (DRDs) can be found in the appendices of the NASA IPMR DRD Guide. The NASA IPMR DRD Guide can be found on the NASA EVM website at http: //evm. nasa. gov/reports. html – The IPMR DRD for contracts of $100 M or greater will require Formats 1, 3, 5, and 6; formats 2, 4, and 7 are recommended – The IPMR DRD for contracts less than $100 M require Formats 1, 3, 5, and 6 of the IPMR; Formats 2, 4, and 7 are optional. – For Cost or FPI contracts <$20 M and contracts for major acquisitions, Format 6 is required; Format 5 is recommended. – For FFP contracts >$20 M, Format 6 is required; Format 5 is recommended (IMS analysis only) 26

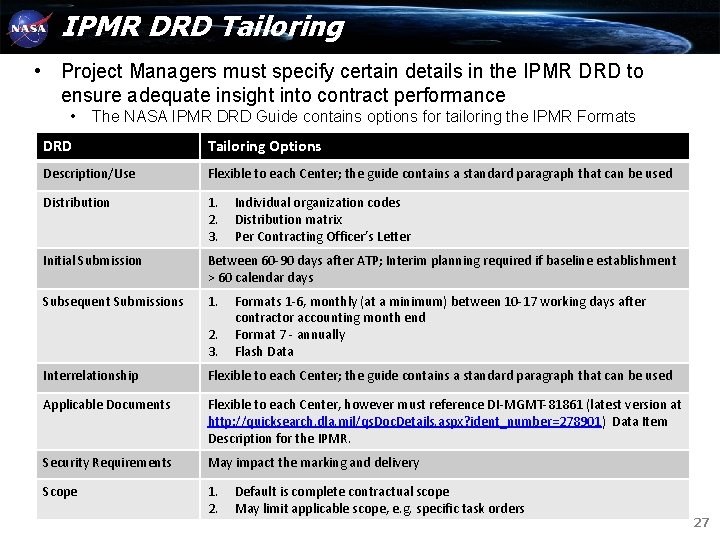

IPMR DRD Tailoring • Project Managers must specify certain details in the IPMR DRD to ensure adequate insight into contract performance • The NASA IPMR DRD Guide contains options for tailoring the IPMR Formats DRD Tailoring Options Description/Use Flexible to each Center; the guide contains a standard paragraph that can be used Distribution 1. 2. 3. Initial Submission Between 60 -90 days after ATP; Interim planning required if baseline establishment > 60 calendar days Subsequent Submissions 1. 2. 3. Individual organization codes Distribution matrix Per Contracting Officer’s Letter Formats 1 -6, monthly (at a minimum) between 10 -17 working days after contractor accounting month end Format 7 - annually Flash Data Interrelationship Flexible to each Center; the guide contains a standard paragraph that can be used Applicable Documents Flexible to each Center, however must reference DI-MGMT-81861 (latest version at http: //quicksearch. dla. mil/qs. Doc. Details. aspx? ident_number=278901) Data Item Description for the IPMR. Security Requirements May impact the marking and delivery Scope 1. 2. Default is complete contractual scope May limit applicable scope, e. g. specific task orders 27

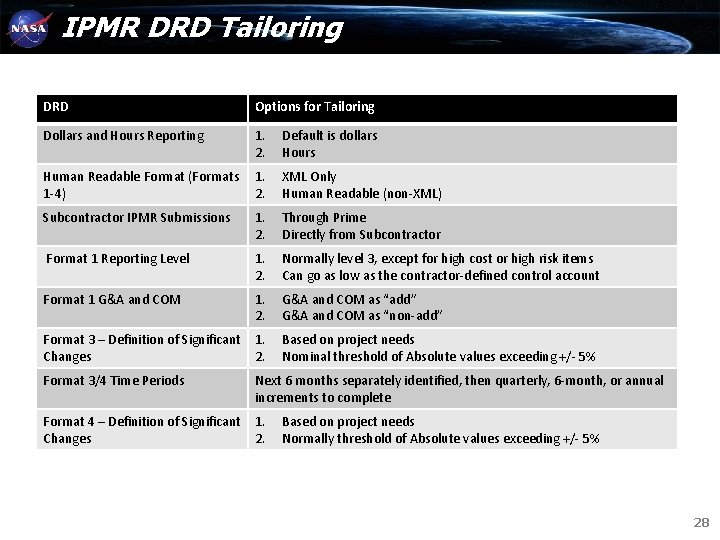

IPMR DRD Tailoring DRD Options for Tailoring Dollars and Hours Reporting 1. 2. Default is dollars Hours Human Readable Format (Formats 1 -4) 1. 2. XML Only Human Readable (non-XML) Subcontractor IPMR Submissions 1. 2. Through Prime Directly from Subcontractor Format 1 Reporting Level 1. 2. Normally level 3, except for high cost or high risk items Can go as low as the contractor-defined control account Format 1 G&A and COM 1. 2. G&A and COM as “add” G&A and COM as “non-add” Format 3 – Definition of Significant 1. Changes 2. Format 3/4 Time Periods Based on project needs Nominal threshold of Absolute values exceeding +/- 5% Next 6 months separately identified, then quarterly, 6 -month, or annual increments to complete Format 4 – Definition of Significant 1. Changes 2. Based on project needs Normally threshold of Absolute values exceeding +/- 5% 28

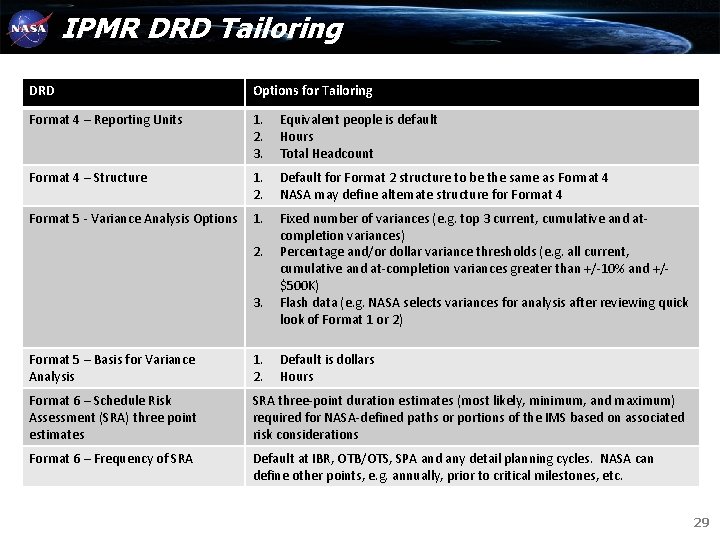

IPMR DRD Tailoring DRD Options for Tailoring Format 4 – Reporting Units 1. 2. 3. Equivalent people is default Hours Total Headcount Format 4 – Structure 1. 2. Default for Format 2 structure to be the same as Format 4 NASA may define alternate structure for Format 4 Format 5 - Variance Analysis Options 1. Fixed number of variances (e. g. top 3 current, cumulative and atcompletion variances) Percentage and/or dollar variance thresholds (e. g. all current, cumulative and at-completion variances greater than +/-10% and +/$500 K) Flash data (e. g. NASA selects variances for analysis after reviewing quick look of Format 1 or 2) 2. 3. Format 5 – Basis for Variance Analysis 1. 2. Format 6 – Schedule Risk Assessment (SRA) three point estimates SRA three-point duration estimates (most likely, minimum, and maximum) required for NASA-defined paths or portions of the IMS based on associated risk considerations Format 6 – Frequency of SRA Default at IBR, OTB/OTS, SPA and any detail planning cycles. NASA can define other points, e. g. annually, prior to critical milestones, etc. Default is dollars Hours 29

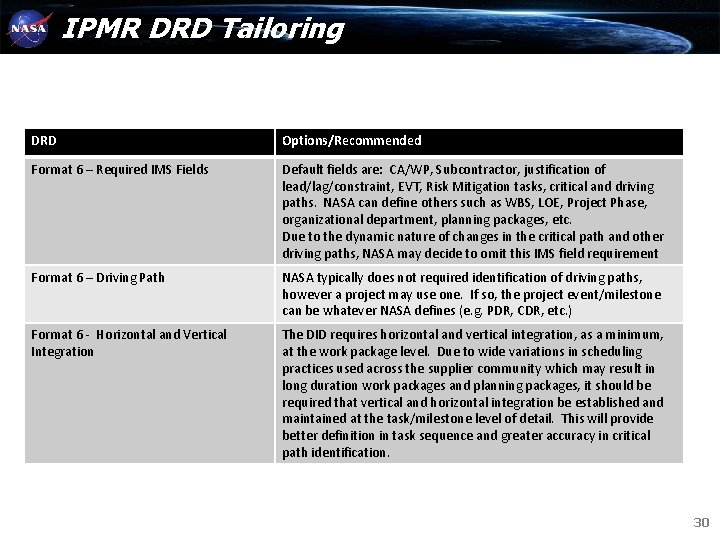

IPMR DRD Tailoring DRD Options/Recommended Format 6 – Required IMS Fields Default fields are: CA/WP, Subcontractor, justification of lead/lag/constraint, EVT, Risk Mitigation tasks, critical and driving paths. NASA can define others such as WBS, LOE, Project Phase, organizational department, planning packages, etc. Due to the dynamic nature of changes in the critical path and other driving paths, NASA may decide to omit this IMS field requirement Format 6 – Driving Path NASA typically does not required identification of driving paths, however a project may use one. If so, the project event/milestone can be whatever NASA defines (e. g. PDR, CDR, etc. ) Format 6 - Horizontal and Vertical Integration The DID requires horizontal and vertical integration, as a minimum, at the work package level. Due to wide variations in scheduling practices used across the supplier community which may result in long duration work packages and planning packages, it should be required that vertical and horizontal integration be established and maintained at the task/milestone level of detail. This will provide better definition in task sequence and greater accuracy in critical path identification. 30
IPMR DRD Tailoring DRD NASA Intent Format 6 - Predecessor and Successor. The DID requires that all non-constrained discrete tasks/activities/milestones, except the start and end of the contract or interim delivery, shall have at least one predecessor and successor. NASA recognizes that the use of task constraints does not always preclude the need for predecessor & successor identification. Since this is the case, it is recommended that all discrete tasks/milestones, except for the start and end of the contract or for interim receipt and delivery events to/from external entities, shall have at least one predecessor and successor. Format 6 – Schedule Margin Placement The DID requires that schedule margin be placed as the last task/activity before key contractual events (e. g. , PDR, CDR, System I&T Complete, etc. ), end item deliverables, or contract completion. Format 6 – Health Analysis NASA may want to specify content of health analysis. For example, 1) the total number of tasks, milestones, and non-detail (e. g. summary, hammock, rollup, etc. ) activities contained in the schedule, 2) the number of completed tasks and milestones, 3) the number of tasks and milestones to be completed, 4) the number of tasks and milestones that have no predecessor and/or no successor relationships, 5) the total number of tasks and milestones that have a total float (slack) value greater than 25% of the remaining duration of the total program/project schedule, 6) the total number of non-detail (e. g. , summary, hammock, rollup, etc. ) activities that have assigned predecessor or successor logical relationships, and 7) the total number of tasks and milestones that have assigned constraint (forced or fixed) dates. 31

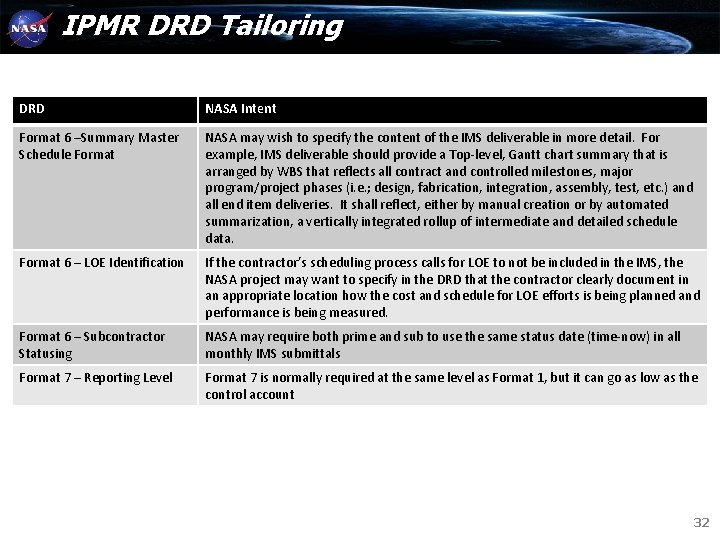

IPMR DRD Tailoring DRD NASA Intent Format 6 –Summary Master Schedule Format NASA may wish to specify the content of the IMS deliverable in more detail. For example, IMS deliverable should provide a Top-level, Gantt chart summary that is arranged by WBS that reflects all contract and controlled milestones, major program/project phases (i. e. ; design, fabrication, integration, assembly, test, etc. ) and all end item deliveries. It shall reflect, either by manual creation or by automated summarization, a vertically integrated rollup of intermediate and detailed schedule data. Format 6 – LOE Identification If the contractor’s scheduling process calls for LOE to not be included in the IMS, the NASA project may want to specify in the DRD that the contractor clearly document in an appropriate location how the cost and schedule for LOE efforts is being planned and performance is being measured. Format 6 – Subcontractor Statusing NASA may require both prime and sub to use the same status date (time-now) in all monthly IMS submittals Format 7 – Reporting Level Format 7 is normally required at the same level as Format 1, but it can go as low as the control account 32

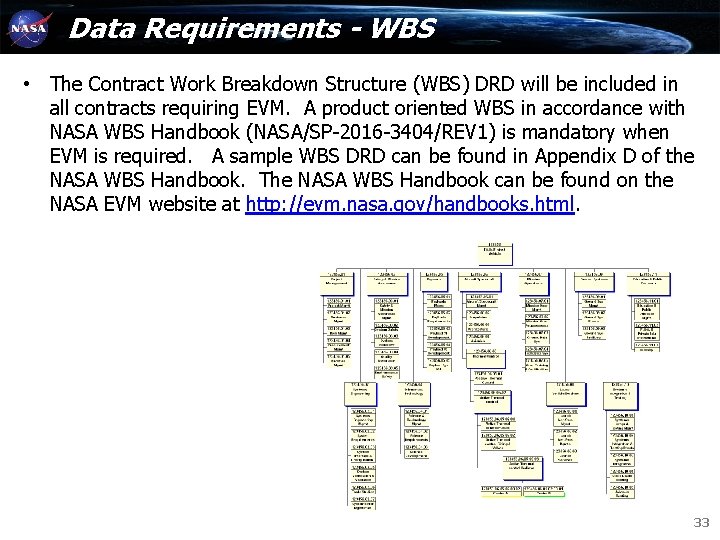

Data Requirements - WBS • The Contract Work Breakdown Structure (WBS) DRD will be included in all contracts requiring EVM. A product oriented WBS in accordance with NASA WBS Handbook (NASA/SP-2016 -3404/REV 1) is mandatory when EVM is required. A sample WBS DRD can be found in Appendix D of the NASA WBS Handbook. The NASA WBS Handbook can be found on the NASA EVM website at http: //evm. nasa. gov/handbooks. html. 33

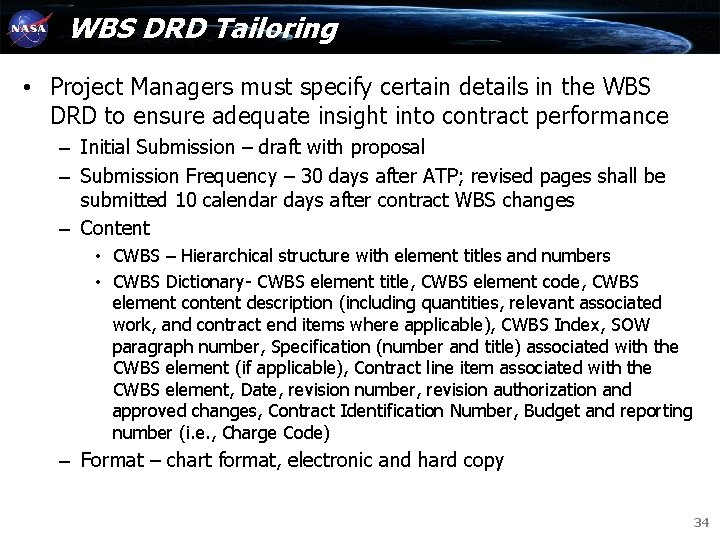

WBS DRD Tailoring • Project Managers must specify certain details in the WBS DRD to ensure adequate insight into contract performance – Initial Submission – draft with proposal – Submission Frequency – 30 days after ATP; revised pages shall be submitted 10 calendar days after contract WBS changes – Content • CWBS – Hierarchical structure with element titles and numbers • CWBS Dictionary- CWBS element title, CWBS element code, CWBS element content description (including quantities, relevant associated work, and contract end items where applicable), CWBS Index, SOW paragraph number, Specification (number and title) associated with the CWBS element (if applicable), Contract line item associated with the CWBS element, Date, revision number, revision authorization and approved changes, Contract Identification Number, Budget and reporting number (i. e. , Charge Code) – Format – chart format, electronic and hard copy 34
Data Requirements - NF 533 • Contractor Financial Management Reports, Monthly and Quarterly, NASA Forms (NF) 533 M and 533 Q respectively, are required on contracts (see NPD 9501. 1 I and NPR 9501. 2) and, when EVMS is required, will reflect information consistent with the IPMR and generated from the same management information systems. 35

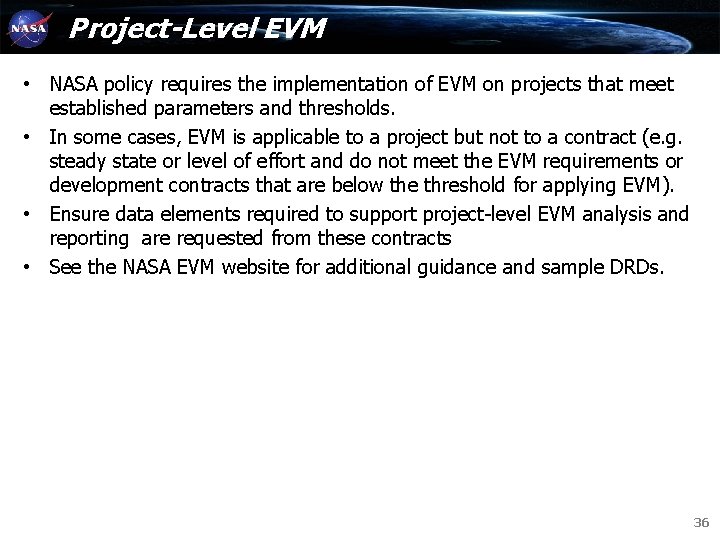

Project-Level EVM • NASA policy requires the implementation of EVM on projects that meet established parameters and thresholds. • In some cases, EVM is applicable to a project but not to a contract (e. g. steady state or level of effort and do not meet the EVM requirements or development contracts that are below the threshold for applying EVM). • Ensure data elements required to support project-level EVM analysis and reporting are requested from these contracts • See the NASA EVM website for additional guidance and sample DRDs. 36

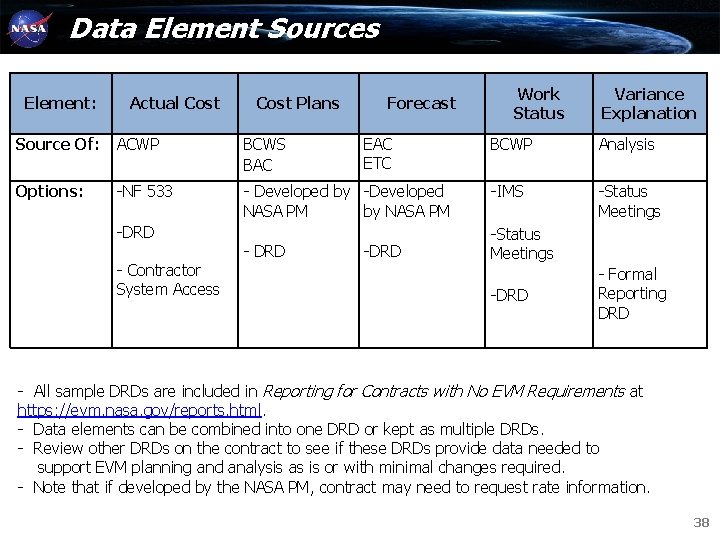

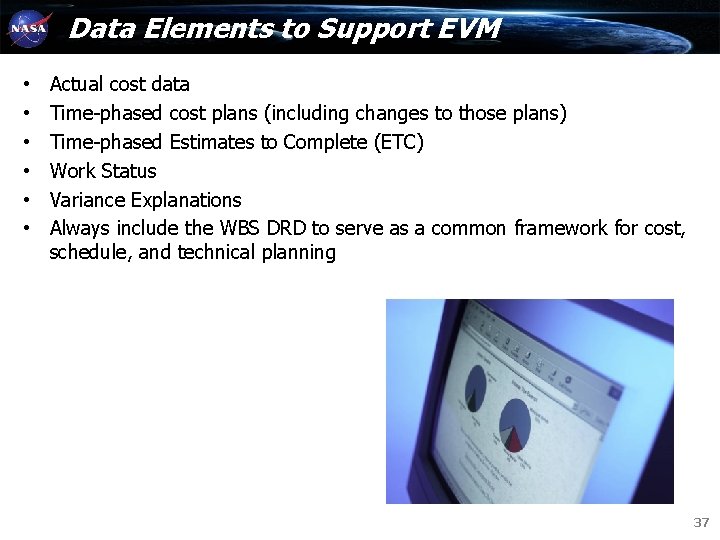

Data Elements to Support EVM • • • Actual cost data Time-phased cost plans (including changes to those plans) Time-phased Estimates to Complete (ETC) Work Status Variance Explanations Always include the WBS DRD to serve as a common framework for cost, schedule, and technical planning 37
Data Element Sources Element: Actual Cost Plans Forecast Source Of: ACWP BCWS BAC Options: -NF 533 - Developed by -Developed -IMS NASA PM by NASA PM -Status - DRD -DRD Meetings -DRD - Contractor System Access EAC ETC Work Status BCWP -DRD Variance Explanation Analysis -Status Meetings - Formal Reporting DRD - All sample DRDs are included in Reporting for Contracts with No EVM Requirements at https: //evm. nasa. gov/reports. html. - Data elements can be combined into one DRD or kept as multiple DRDs. - Review other DRDs on the contract to see if these DRDs provide data needed to support EVM planning and analysis as is or with minimal changes required. - Note that if developed by the NASA PM, contract may need to request rate information. 38

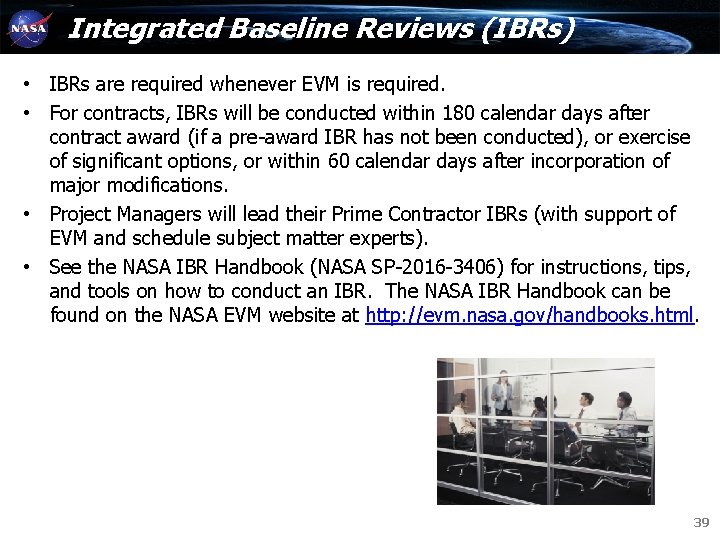

Integrated Baseline Reviews (IBRs) • IBRs are required whenever EVM is required. • For contracts, IBRs will be conducted within 180 calendar days after contract award (if a pre-award IBR has not been conducted), or exercise of significant options, or within 60 calendar days after incorporation of major modifications. • Project Managers will lead their Prime Contractor IBRs (with support of EVM and schedule subject matter experts). • See the NASA IBR Handbook (NASA SP-2016 -3406) for instructions, tips, and tools on how to conduct an IBR. The NASA IBR Handbook can be found on the NASA EVM website at http: //evm. nasa. gov/handbooks. html. 39
National Aeronautics and Space Administration Award Fee Criteria www. nasa. gov 40
Award Fee Criteria • The application of EVM and IBRs in the award fee criteria is a valuable tool to promote good project management. However, the use of a single EVM indicator, such as the Cost Performance Index (CPI), or the IBR event, is not recommended. • See section 3. 2. 1 of the NASA EVM Implementation Handbook for examples of effectively incorporating EVM and IBRs into the award fee evaluation 41

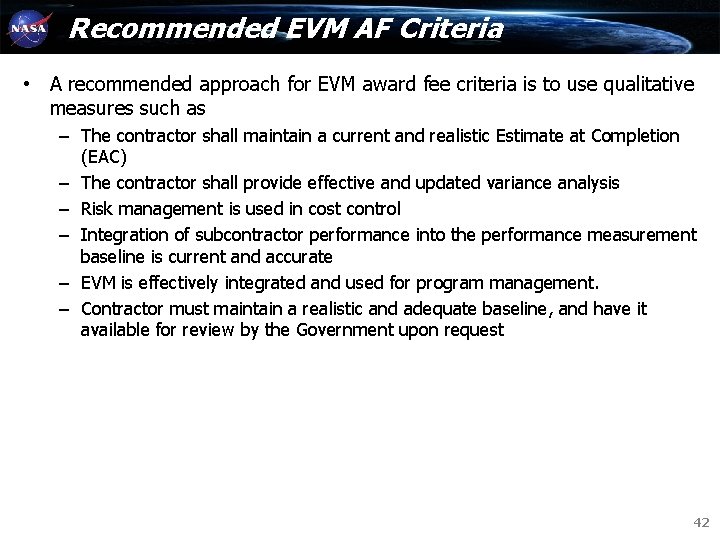

Recommended EVM AF Criteria • A recommended approach for EVM award fee criteria is to use qualitative measures such as – The contractor shall maintain a current and realistic Estimate at Completion (EAC) – The contractor shall provide effective and updated variance analysis – Risk management is used in cost control – Integration of subcontractor performance into the performance measurement baseline is current and accurate – EVM is effectively integrated and used for program management. – Contractor must maintain a realistic and adequate baseline, and have it available for review by the Government upon request 42

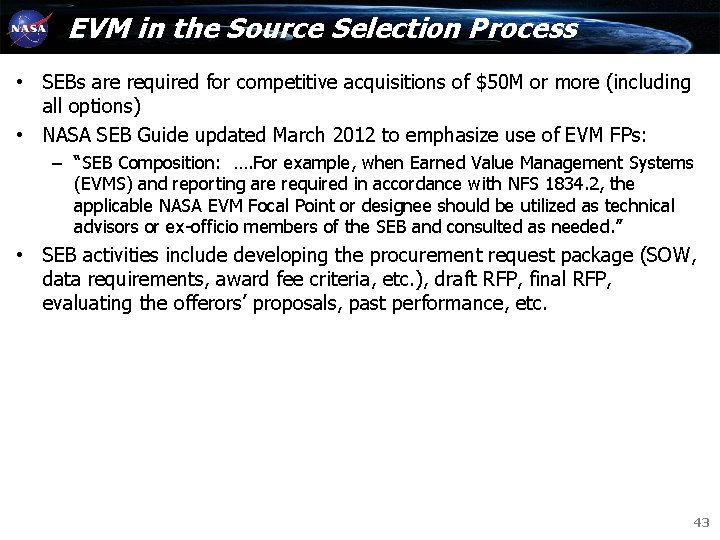

EVM in the Source Selection Process • SEBs are required for competitive acquisitions of $50 M or more (including all options) • NASA SEB Guide updated March 2012 to emphasize use of EVM FPs: – “SEB Composition: …. For example, when Earned Value Management Systems (EVMS) and reporting are required in accordance with NFS 1834. 2, the applicable NASA EVM Focal Point or designee should be utilized as technical advisors or ex-officio members of the SEB and consulted as needed. ” • SEB activities include developing the procurement request package (SOW, data requirements, award fee criteria, etc. ), draft RFP, final RFP, evaluating the offerors’ proposals, past performance, etc. 43
National Aeronautics and Space Administration Available Resources/Tools www. nasa. gov 44

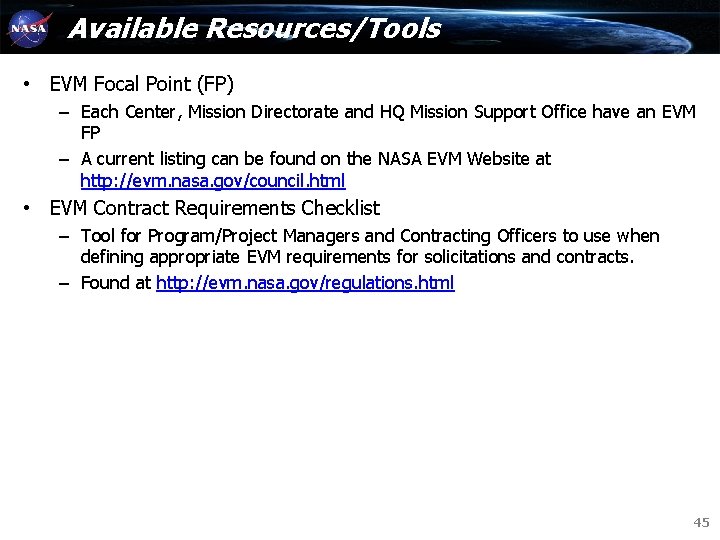

Available Resources/Tools • EVM Focal Point (FP) – Each Center, Mission Directorate and HQ Mission Support Office have an EVM FP – A current listing can be found on the NASA EVM Website at http: //evm. nasa. gov/council. html • EVM Contract Requirements Checklist – Tool for Program/Project Managers and Contracting Officers to use when defining appropriate EVM requirements for solicitations and contracts. – Found at http: //evm. nasa. gov/regulations. html 45

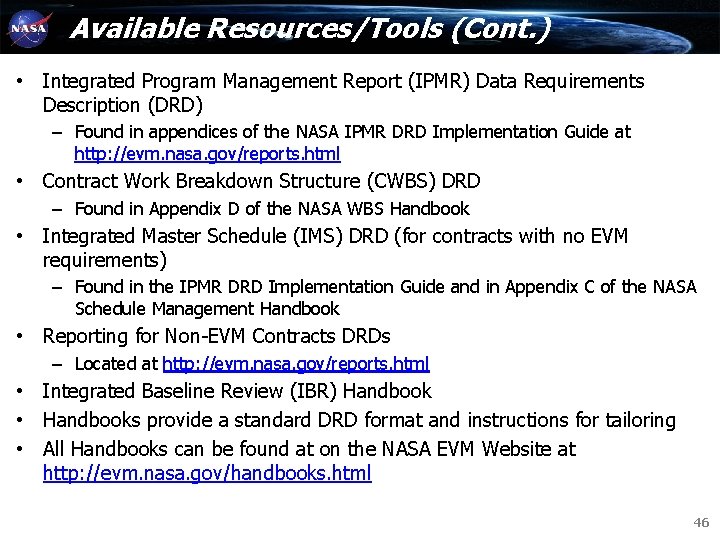

Available Resources/Tools (Cont. ) • Integrated Program Management Report (IPMR) Data Requirements Description (DRD) – Found in appendices of the NASA IPMR DRD Implementation Guide at http: //evm. nasa. gov/reports. html • Contract Work Breakdown Structure (CWBS) DRD – Found in Appendix D of the NASA WBS Handbook • Integrated Master Schedule (IMS) DRD (for contracts with no EVM requirements) – Found in the IPMR DRD Implementation Guide and in Appendix C of the NASA Schedule Management Handbook • Reporting for Non-EVM Contracts DRDs – Located at http: //evm. nasa. gov/reports. html • Integrated Baseline Review (IBR) Handbook • Handbooks provide a standard DRD format and instructions for tailoring • All Handbooks can be found at on the NASA EVM Website at http: //evm. nasa. gov/handbooks. html 46

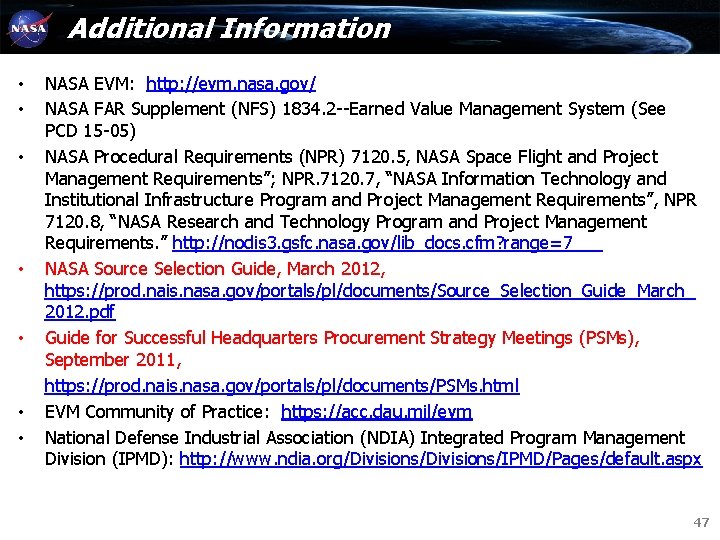

Additional Information • • NASA EVM: http: //evm. nasa. gov/ NASA FAR Supplement (NFS) 1834. 2 --Earned Value Management System (See PCD 15 -05) NASA Procedural Requirements (NPR) 7120. 5, NASA Space Flight and Project Management Requirements”; NPR. 7120. 7, “NASA Information Technology and Institutional Infrastructure Program and Project Management Requirements”, NPR 7120. 8, “NASA Research and Technology Program and Project Management Requirements. ” http: //nodis 3. gsfc. nasa. gov/lib_docs. cfm? range=7___ NASA Source Selection Guide, March 2012, https: //prod. nais. nasa. gov/portals/pl/documents/Source_Selection_Guide_March_ 2012. pdf Guide for Successful Headquarters Procurement Strategy Meetings (PSMs), September 2011, https: //prod. nais. nasa. gov/portals/pl/documents/PSMs. html EVM Community of Practice: https: //acc. dau. mil/evm National Defense Industrial Association (NDIA) Integrated Program Management Division (IPMD): http: //www. ndia. org/Divisions/IPMD/Pages/default. aspx 47
y r a m m u S
Summary • EVM planning activities must begin early – i. e. , in the acquisition planning phase (ASP, ASM, PSM) • Properly defined EVM requirements in the RFP are the first steps to EVM success in the contract • EVM data requirements in the contract should reflect the stakeholders’ need for EVM data throughout the performance period • Waivers to the NFS must require approval of NASA HQ Office of Procurement 49
For more information visit: evm. nasa. gov 50
Back Up p u k Bac 51

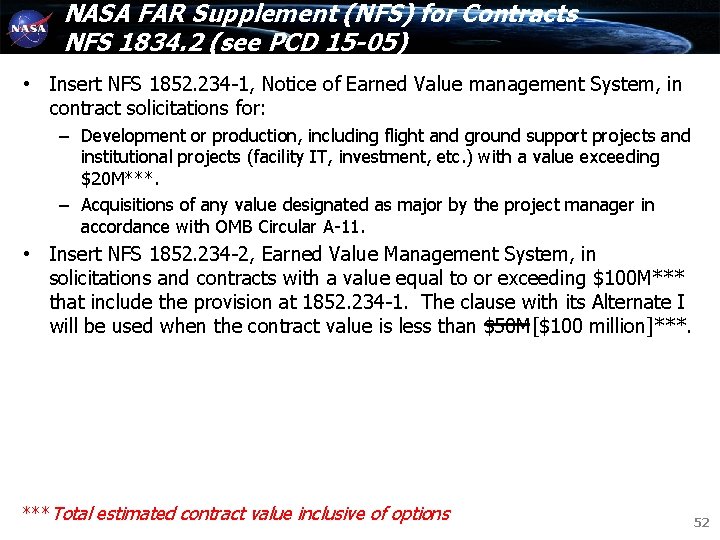

NASA FAR Supplement (NFS) for Contracts NFS 1834. 2 (see PCD 15 -05) • Insert NFS 1852. 234 -1, Notice of Earned Value management System, in contract solicitations for: – Development or production, including flight and ground support projects and institutional projects (facility IT, investment, etc. ) with a value exceeding $20 M***. – Acquisitions of any value designated as major by the project manager in accordance with OMB Circular A-11. • Insert NFS 1852. 234 -2, Earned Value Management System, in solicitations and contracts with a value equal to or exceeding $100 M*** that include the provision at 1852. 234 -1. The clause with its Alternate I will be used when the contract value is less than $50 M[$100 million]***. ***Total estimated contract value inclusive of options 52

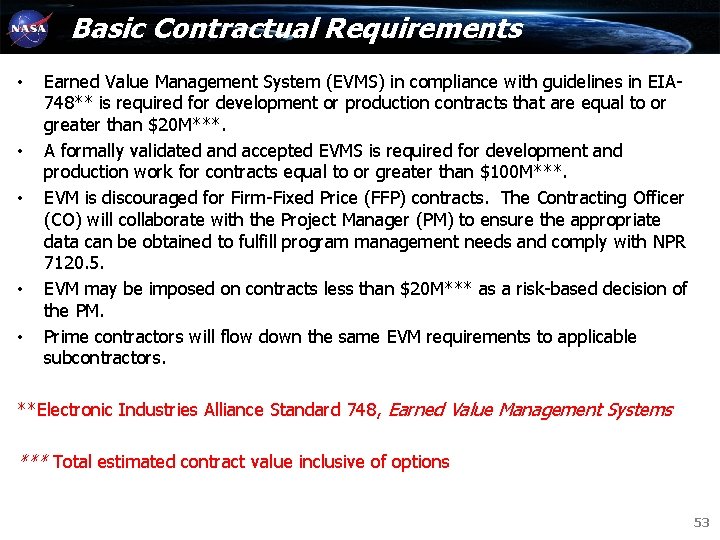

Basic Contractual Requirements • • • Earned Value Management System (EVMS) in compliance with guidelines in EIA 748** is required for development or production contracts that are equal to or greater than $20 M***. A formally validated and accepted EVMS is required for development and production work for contracts equal to or greater than $100 M***. EVM is discouraged for Firm-Fixed Price (FFP) contracts. The Contracting Officer (CO) will collaborate with the Project Manager (PM) to ensure the appropriate data can be obtained to fulfill program management needs and comply with NPR 7120. 5. EVM may be imposed on contracts less than $20 M*** as a risk-based decision of the PM. Prime contractors will flow down the same EVM requirements to applicable subcontractors. **Electronic Industries Alliance Standard 748, Earned Value Management Systems *** Total estimated contract value inclusive of options 53

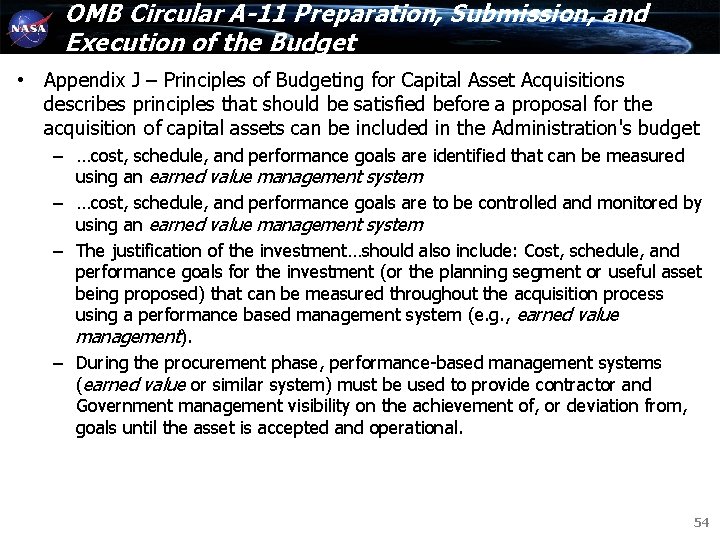

OMB Circular A-11 Preparation, Submission, and Execution of the Budget • Appendix J – Principles of Budgeting for Capital Asset Acquisitions describes principles that should be satisfied before a proposal for the acquisition of capital assets can be included in the Administration's budget – …cost, schedule, and performance goals are identified that can be measured using an earned value management system – …cost, schedule, and performance goals are to be controlled and monitored by using an earned value management system – The justification of the investment…should also include: Cost, schedule, and performance goals for the investment (or the planning segment or useful asset being proposed) that can be measured throughout the acquisition process using a performance based management system (e. g. , earned value management). – During the procurement phase, performance-based management systems (earned value or similar system) must be used to provide contractor and Government management visibility on the achievement of, or deviation from, goals until the asset is accepted and operational. 54

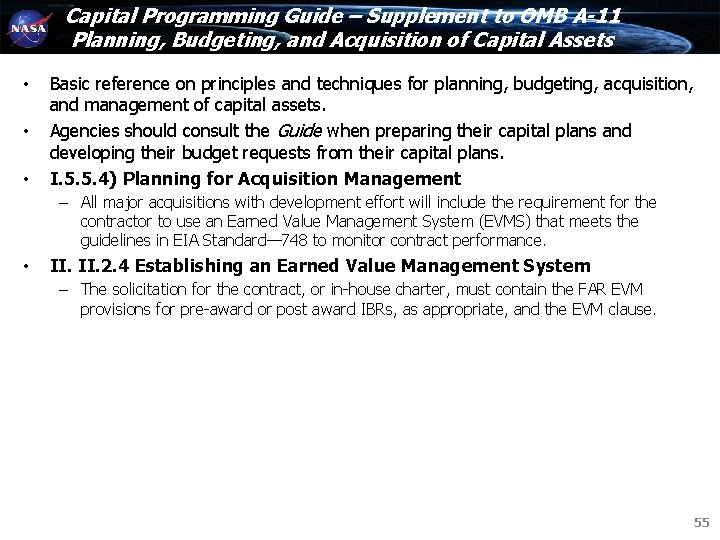

Capital Programming Guide – Supplement to OMB A-11 Planning, Budgeting, and Acquisition of Capital Assets • • • Basic reference on principles and techniques for planning, budgeting, acquisition, and management of capital assets. Agencies should consult the Guide when preparing their capital plans and developing their budget requests from their capital plans. I. 5. 5. 4) Planning for Acquisition Management – All major acquisitions with development effort will include the requirement for the contractor to use an Earned Value Management System (EVMS) that meets the guidelines in EIA Standard— 748 to monitor contract performance. • II. 2. 4 Establishing an Earned Value Management System – The solicitation for the contract, or in-house charter, must contain the FAR EVM provisions for pre-award or post award IBRs, as appropriate, and the EVM clause. 55

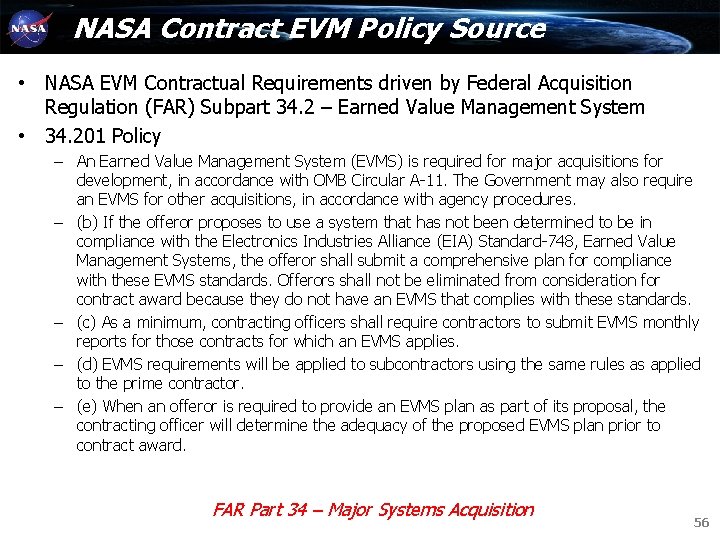

NASA Contract EVM Policy Source • NASA EVM Contractual Requirements driven by Federal Acquisition Regulation (FAR) Subpart 34. 2 – Earned Value Management System • 34. 201 Policy – An Earned Value Management System (EVMS) is required for major acquisitions for development, in accordance with OMB Circular A-11. The Government may also require an EVMS for other acquisitions, in accordance with agency procedures. – (b) If the offeror proposes to use a system that has not been determined to be in compliance with the Electronics Industries Alliance (EIA) Standard-748, Earned Value Management Systems, the offeror shall submit a comprehensive plan for compliance with these EVMS standards. Offerors shall not be eliminated from consideration for contract award because they do not have an EVMS that complies with these standards. – (c) As a minimum, contracting officers shall require contractors to submit EVMS monthly reports for those contracts for which an EVMS applies. – (d) EVMS requirements will be applied to subcontractors using the same rules as applied to the prime contractor. – (e) When an offeror is required to provide an EVMS plan as part of its proposal, the contracting officer will determine the adequacy of the proposed EVMS plan prior to contract award. FAR Part 34 – Major Systems Acquisition 56

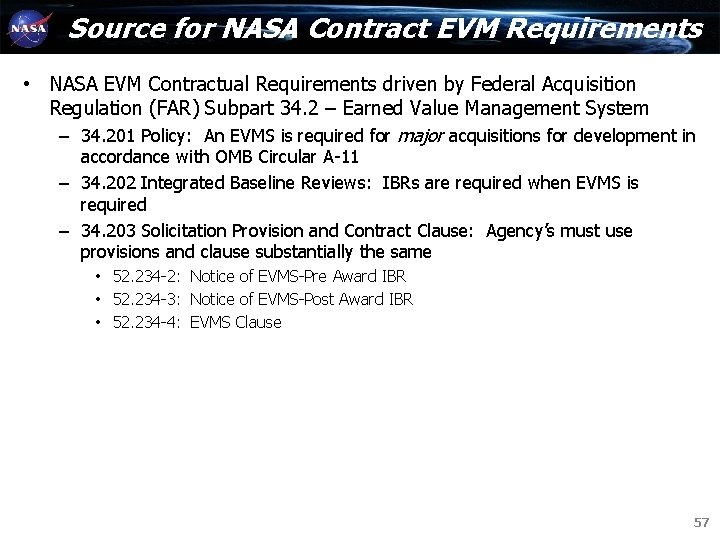

Source for NASA Contract EVM Requirements • NASA EVM Contractual Requirements driven by Federal Acquisition Regulation (FAR) Subpart 34. 2 – Earned Value Management System – 34. 201 Policy: An EVMS is required for major acquisitions for development in accordance with OMB Circular A-11 – 34. 202 Integrated Baseline Reviews: IBRs are required when EVMS is required – 34. 203 Solicitation Provision and Contract Clause: Agency’s must use provisions and clause substantially the same • 52. 234 -2: Notice of EVMS-Pre Award IBR • 52. 234 -3: Notice of EVMS-Post Award IBR • 52. 234 -4: EVMS Clause 57

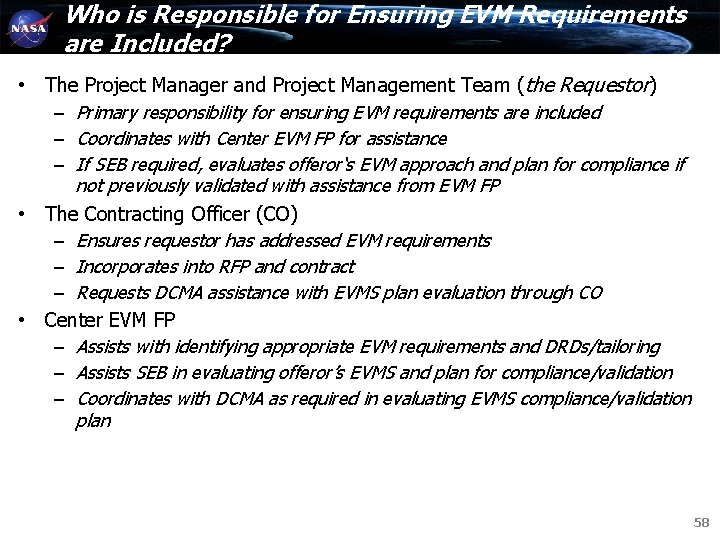

Who is Responsible for Ensuring EVM Requirements are Included? • The Project Manager and Project Management Team (the Requestor) – Primary responsibility for ensuring EVM requirements are included – Coordinates with Center EVM FP for assistance – If SEB required, evaluates offeror‘s EVM approach and plan for compliance if not previously validated with assistance from EVM FP • The Contracting Officer (CO) – Ensures requestor has addressed EVM requirements – Incorporates into RFP and contract – Requests DCMA assistance with EVMS plan evaluation through CO • Center EVM FP – Assists with identifying appropriate EVM requirements and DRDs/tailoring – Assists SEB in evaluating offeror’s EVMS and plan for compliance/validation – Coordinates with DCMA as required in evaluating EVMS compliance/validation plan 58
