Mechanical Modernization Project Creating the Best Choice in
Mechanical Modernization Project “Creating the Best Choice in Urban Education” St. Louis Public Schools Department of Operations June 26, 2008 Roger L. Cay. Ce Executive Director of Operations Building Commissioner
The 9 Schools Dewey I S. School, Ann Russek, Principal Washington Montessori School, De. Adrienne Torrey, Principal Beaumont High School, Travis Brown, Principal Carr Lane VPA Middle School, Melba Davis, Principal Mc. Kinley CJA Middle School, Brenda Smith, Principal Nottingham CAJT School, Roland Werner, Principal Roosevelt High School, Terry Houston, Principal Soldan I. S. High School, Dr. Thomas Cason, Principal Sumner High School, Sherman Curtis, Principal 2

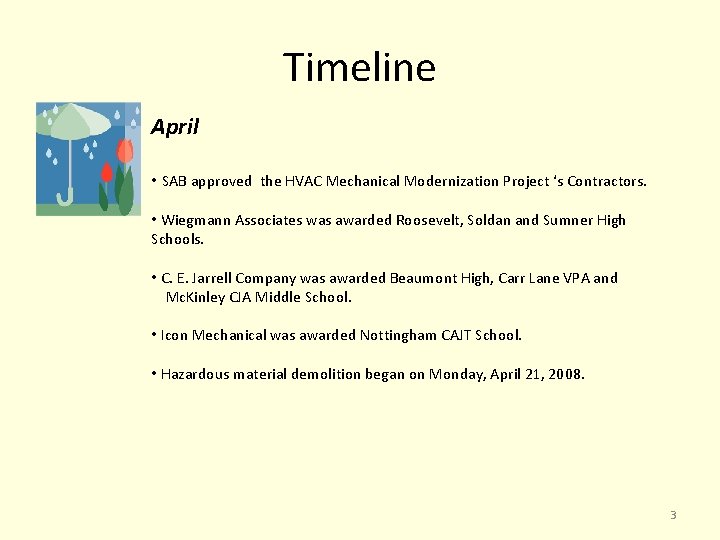

Timeline April • SAB approved the HVAC Mechanical Modernization Project ‘s Contractors. • Wiegmann Associates was awarded Roosevelt, Soldan and Sumner High Schools. • C. E. Jarrell Company was awarded Beaumont High, Carr Lane VPA and Mc. Kinley CJA Middle School. • Icon Mechanical was awarded Nottingham CAJT School. • Hazardous material demolition began on Monday, April 21, 2008. 3
May Timeline • The District’s Construction Team met with the Construction Management Consultants and the contractors to finalize the Design Build Projects. • Preliminary reviews with the City of St. Louis Department of Public Safety – Division of Building and Inspections. • The Construction Team met with each principal individually to discuss installation and packing of the school for the HVAC Project. • Boxes and tape delivered to schools during the week of May 5 th. • Demolition of the boiler rooms, fan rooms and tank rooms are in progress. 4

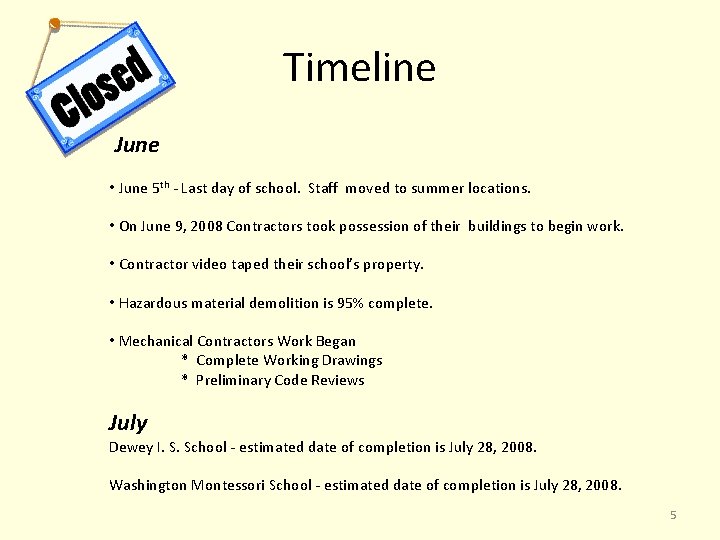

Timeline June • June 5 th - Last day of school. Staff moved to summer locations. • On June 9, 2008 Contractors took possession of their buildings to begin work. • Contractor video taped their school’s property. • Hazardous material demolition is 95% complete. • Mechanical Contractors Work Began * Complete Working Drawings * Preliminary Code Reviews July Dewey I. S. School - estimated date of completion is July 28, 2008. Washington Montessori School - estimated date of completion is July 28, 2008. 5
Extra, Read All About It! The District’s Construction Team produces a biweekly newsletter to keep Principals, Education Officers, staff and the community informed on the progress of the mechanical modernization project. 6

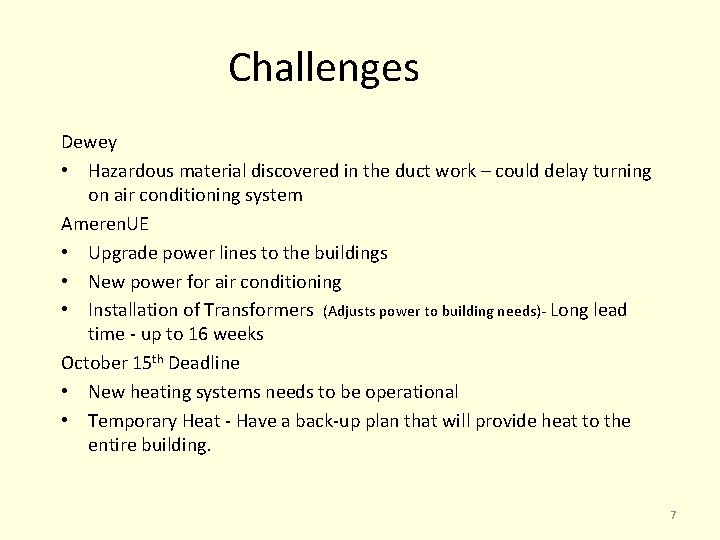

Challenges Dewey • Hazardous material discovered in the duct work – could delay turning on air conditioning system Ameren. UE • Upgrade power lines to the buildings • New power for air conditioning • Installation of Transformers (Adjusts power to building needs)- Long lead time - up to 16 weeks October 15 th Deadline • New heating systems needs to be operational • Temporary Heat - Have a back-up plan that will provide heat to the entire building. 7

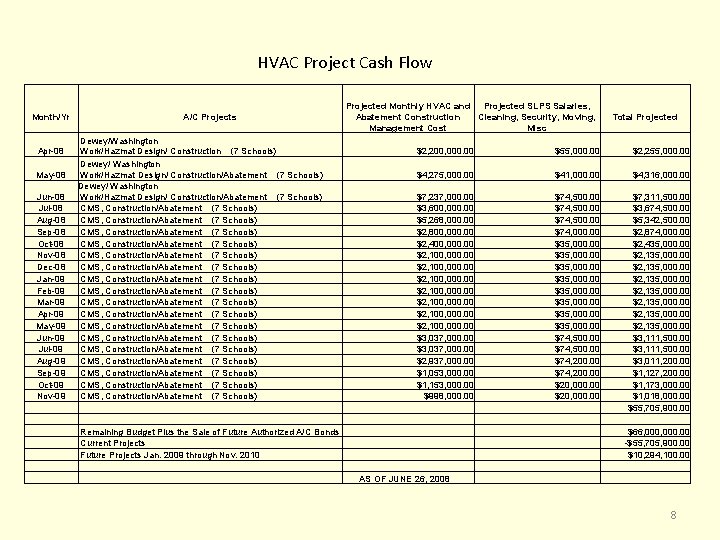

HVAC Project Cash Flow Month/Yr Apr-08 May-08 Jun-08 Jul-08 Aug-08 Sep-08 Oct-08 Nov-08 Dec-08 Jan-09 Feb-09 Mar-09 Apr-09 May-09 Jun-09 Jul-09 Aug-09 Sep-09 Oct-09 Nov-09 A/C Projects Dewey/Washington Work/Hazmat Design/ Construction (7 Schools) Dewey/ Washington Work/Hazmat Design/ Construction/Abatement (7 Schools) CMS, Construction/Abatement (7 Schools) CMS, Construction/Abatement (7 Schools) CMS, Construction/Abatement (7 Schools) CMS, Construction/Abatement (7 Schools) CMS, Construction/Abatement (7 Schools) Projected Monthly HVAC and Projected SLPS Salaries, Abatement Construction Cleaning, Security, Moving, Management Cost Misc Total Projected $2, 200, 000. 00 $55, 000. 00 $2, 255, 000. 00 $4, 275, 000. 00 $41, 000. 00 $4, 316, 000. 00 $7, 237, 000. 00 $3, 600, 000. 00 $5, 268, 000. 00 $2, 800, 000. 00 $2, 400, 000. 00 $2, 100, 000. 00 $3, 037, 000. 00 $2, 937, 000. 00 $1, 053, 000. 00 $1, 153, 000. 00 $998, 000. 00 $74, 500. 00 $74, 000. 00 $35, 000. 00 $74, 500. 00 $74, 200. 00 $20, 000. 00 $7, 311, 500. 00 $3, 674, 500. 00 $5, 342, 500. 00 $2, 874, 000. 00 $2, 435, 000. 00 $2, 135, 000. 00 $3, 111, 500. 00 $3, 011, 200. 00 $1, 127, 200. 00 $1, 173, 000. 00 $1, 018, 000. 00 $55, 705, 900. 00 Remaining Budget Plus the Sale of Future Authorized A/C Bonds Current Projects Future Projects Jan. 2009 through Nov. 2010 $66, 000. 00 -$55, 705, 900. 00 $10, 294, 100. 00 AS OF JUNE 26, 2008 8
