MAXIMO UPGRADE WITH FINGERTIP NIE Networks NIE Networks

  • Slides: 11
Download presentation
MAXIMO UPGRADE WITH FINGERTIP NIE Networks

MAXIMO UPGRADE WITH FINGERTIP NIE Networks

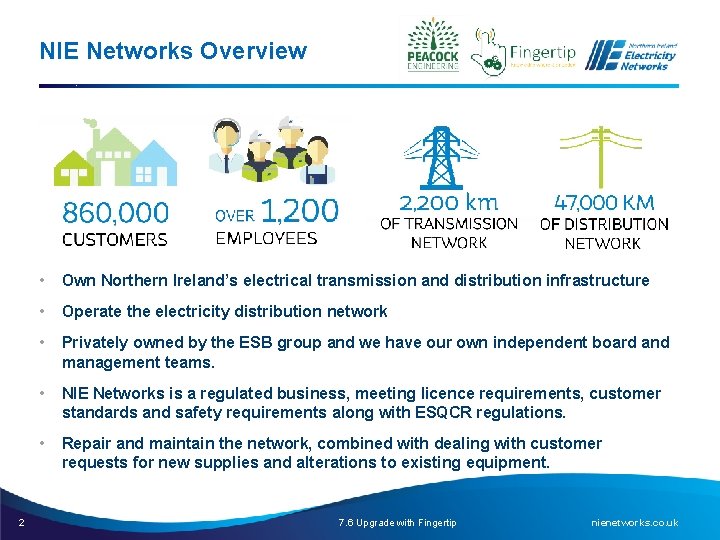

NIE Networks Overview 2 • Own Northern Ireland’s electrical transmission and distribution infrastructure •

NIE Networks Overview 2 • Own Northern Ireland’s electrical transmission and distribution infrastructure • Operate the electricity distribution network • Privately owned by the ESB group and we have our own independent board and management teams. • NIE Networks is a regulated business, meeting licence requirements, customer standards and safety requirements along with ESQCR regulations. • Repair and maintain the network, combined with dealing with customer requests for new supplies and alterations to existing equipment. 7. 6 Upgrade with Fingertip nienetworks. co. uk

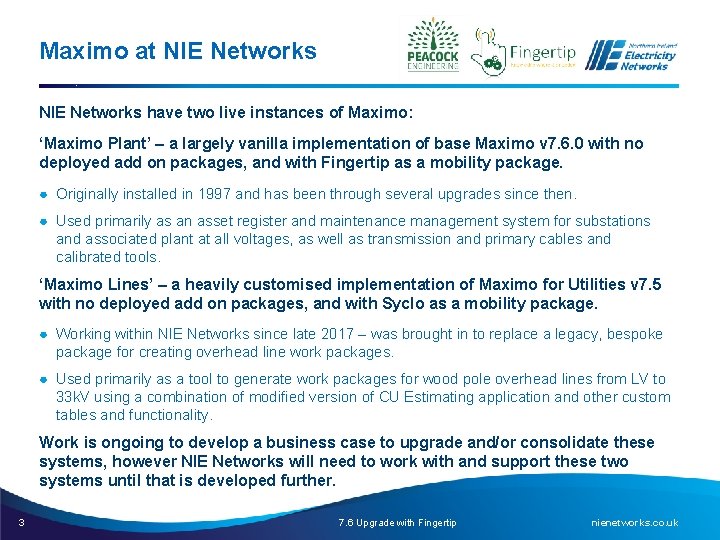

Maximo at NIE Networks have two live instances of Maximo: ‘Maximo Plant’ – a

Maximo at NIE Networks have two live instances of Maximo: ‘Maximo Plant’ – a largely vanilla implementation of base Maximo v 7. 6. 0 with no deployed add on packages, and with Fingertip as a mobility package. ● Originally installed in 1997 and has been through several upgrades since then. ● Used primarily as an asset register and maintenance management system for substations and associated plant at all voltages, as well as transmission and primary cables and calibrated tools. ‘Maximo Lines’ – a heavily customised implementation of Maximo for Utilities v 7. 5 with no deployed add on packages, and with Syclo as a mobility package. ● Working within NIE Networks since late 2017 – was brought in to replace a legacy, bespoke package for creating overhead line work packages. ● Used primarily as a tool to generate work packages for wood pole overhead lines from LV to 33 k. V using a combination of modified version of CU Estimating application and other custom tables and functionality. Work is ongoing to develop a business case to upgrade and/or consolidate these systems, however NIE Networks will need to work with and support these two systems until that is developed further. 3 7. 6 Upgrade with Fingertip nienetworks. co. uk

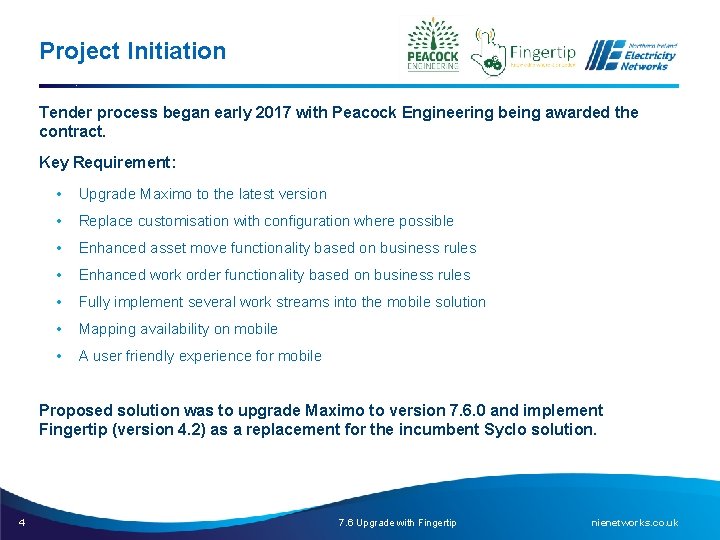

Project Initiation Tender process began early 2017 with Peacock Engineering being awarded the contract.

Project Initiation Tender process began early 2017 with Peacock Engineering being awarded the contract. Key Requirement: • Upgrade Maximo to the latest version • Replace customisation with configuration where possible • Enhanced asset move functionality based on business rules • Enhanced work order functionality based on business rules • Fully implement several work streams into the mobile solution • Mapping availability on mobile • A user friendly experience for mobile Proposed solution was to upgrade Maximo to version 7. 6. 0 and implement Fingertip (version 4. 2) as a replacement for the incumbent Syclo solution. 4 7. 6 Upgrade with Fingertip nienetworks. co. uk

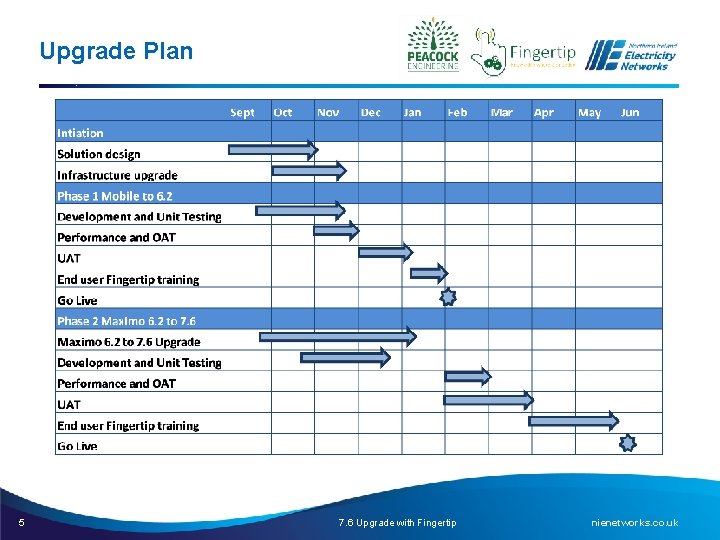

Upgrade Plan 5 7. 6 Upgrade with Fingertip nienetworks. co. uk

Upgrade Plan 5 7. 6 Upgrade with Fingertip nienetworks. co. uk

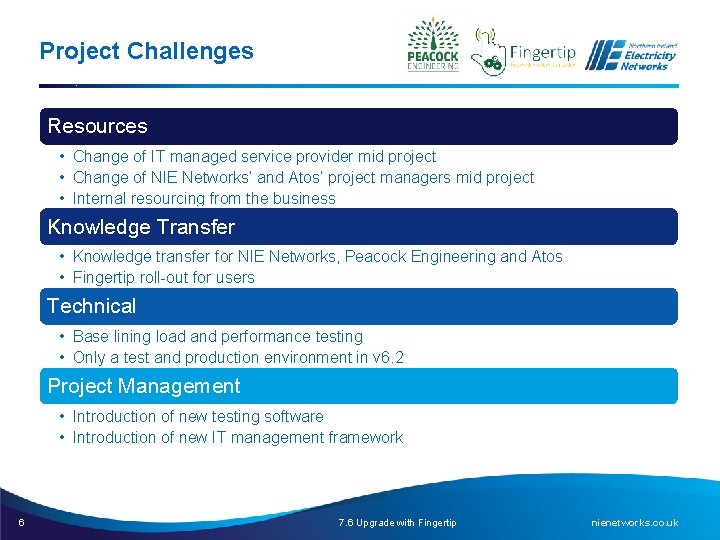

Project Challenges Resources • Change of IT managed service provider mid project • Change

Project Challenges Resources • Change of IT managed service provider mid project • Change of NIE Networks’ and Atos’ project managers mid project • Internal resourcing from the business Knowledge Transfer • Knowledge transfer for NIE Networks, Peacock Engineering and Atos • Fingertip roll-out for users Technical • Base lining load and performance testing • Only a test and production environment in v 6. 2 Project Management • Introduction of new testing software • Introduction of new IT management framework 6 7. 6 Upgrade with Fingertip nienetworks. co. uk

What went well Engagement Mobile Rollout 7 Project Governance Resource Availability On Budget Minimal

What went well Engagement Mobile Rollout 7 Project Governance Resource Availability On Budget Minimal Disruption 7. 6 Upgrade with Fingertip nienetworks. co. uk

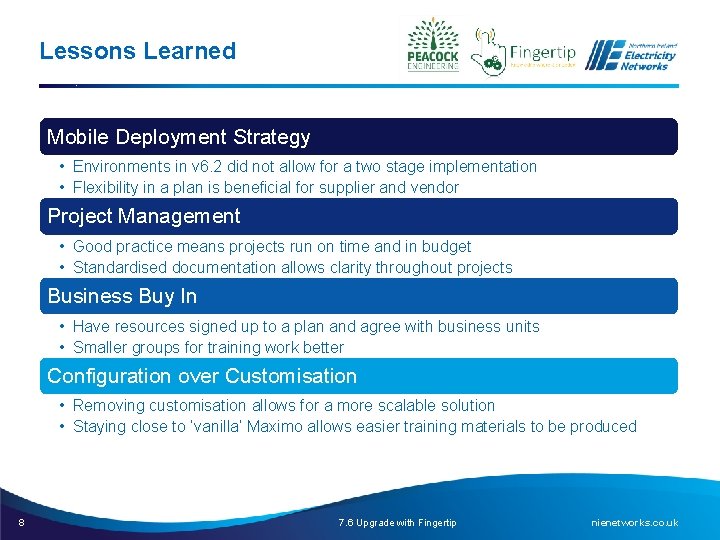

Lessons Learned Mobile Deployment Strategy • Environments in v 6. 2 did not allow

Lessons Learned Mobile Deployment Strategy • Environments in v 6. 2 did not allow for a two stage implementation • Flexibility in a plan is beneficial for supplier and vendor Project Management • Good practice means projects run on time and in budget • Standardised documentation allows clarity throughout projects Business Buy In • Have resources signed up to a plan and agree with business units • Smaller groups for training work better Configuration over Customisation • Removing customisation allows for a more scalable solution • Staying close to ‘vanilla’ Maximo allows easier training materials to be produced 8 7. 6 Upgrade with Fingertip nienetworks. co. uk

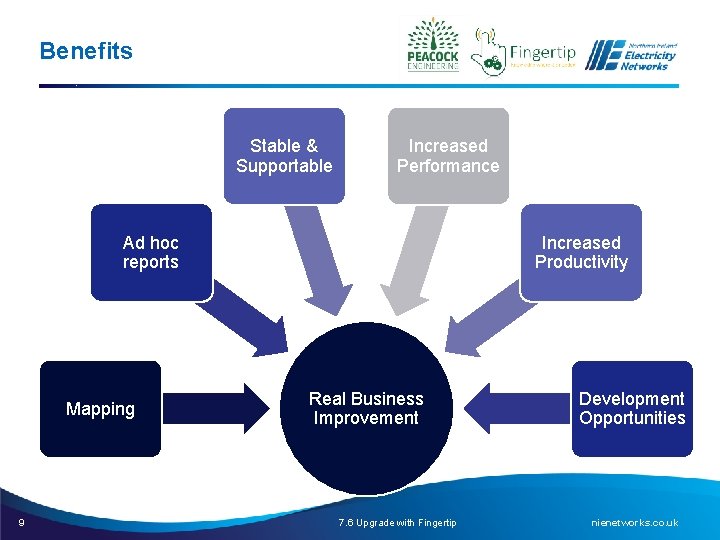

Benefits Stable & Supportable Increased Performance Ad hoc reports Mapping 9 Increased Productivity Real

Benefits Stable & Supportable Increased Performance Ad hoc reports Mapping 9 Increased Productivity Real Business Improvement 7. 6 Upgrade with Fingertip Development Opportunities nienetworks. co. uk

Future Plans Improve Data Quality 10 Small Upgrades GIS Integration Additional Modules 7. 6

Future Plans Improve Data Quality 10 Small Upgrades GIS Integration Additional Modules 7. 6 Upgrade with Fingertip One Maximo Instance nienetworks. co. uk
