Mars Atmosphere and Volatile Evolutio N MAVEN Mission

  • Slides: 30
Download presentation
Mars Atmosphere and Volatile Evolutio. N (MAVEN) Mission Particles and Fields Package Instrument Critical

Mars Atmosphere and Volatile Evolutio. N (MAVEN) Mission Particles and Fields Package Instrument Critical Design Review May 23 -25, 2011 Management Dave Curtis PFP Package Manager MAVEN PFP ICDR May 23 -25, 2011 1 -1

PFP Instrument CDR Context • Last year we covered the instrument design in detail

PFP Instrument CDR Context • Last year we covered the instrument design in detail in the pre-PDR peer reviews and the Instrument PDR • Over the past few months we have covered the detailed changes in design since PDR and the test results from the engineering models in the pre-CDR peer reviews • This Instrument CDR will include a top level discussion of instrument design and programmatics, focusing on changes since PDR. MAVEN PFP ICDR May 23 -25, 2011 1 -2

The PF Package SWEA LPW (2) EUV SWIA Solar Wind Electron Analyzer (SWEA) –

The PF Package SWEA LPW (2) EUV SWIA Solar Wind Electron Analyzer (SWEA) – IRAP(CESR) / SSL Langmuir Probe and Waves (LPW) – LASP / SSL PFDPU LPW/Extreme Ultra-Violet (LPW-EUV) – LASP MAG (2) Solar Energetic Particle Detector (SEP) – SSL Magnetometer (MAG) – GSFC SEP (2) STATIC MAVEN PFP ICDR May 23 -25, 2011 Solar Wind Ion Analyzer (SWIA) – SSL Supra-Thermal and Thermal Ion Composition (STATIC) SSL 1 -3

PFP Block Diagram 10 cm MAVEN PFP ICDR May 23 -25, 2011 1 -4

PFP Block Diagram 10 cm MAVEN PFP ICDR May 23 -25, 2011 1 -4

MAVEN PFP Org Chart MAVEN Project PI: Bruce Jakosky (LASP) No changes since PDR

MAVEN PFP Org Chart MAVEN Project PI: Bruce Jakosky (LASP) No changes since PDR PM: David Mitchell (GSFC) MAVEN Deputy PI, PFP PI Robert Lin PFP Science Team: Jim Mc. Fadden Dave Mitchell Davin Larson Jasper Halekas Greg Delory Janet Luhmann Jack Connerney (GSFC) Robert Ergun (LASP) etc PFDPU EE: Gordon ME: Donakowski FSW: Harvey STATIC Sci: Mc. Fadden EE: Sterling ME: Dalton PF Package Manager Systems: EE: Curtis ME: Turin SWIA Sci: Halekas EE: Taylor ME: Dalton SWEA Sci: Mitchell EE: Taylor ME: Turin SWEA (IRAP) Sci: Mazelle MAVEN PFP ICDR May 23 -25, 2011 SPO , EH&S, Purchasing, Financial David Curtis Management Team: Financial: Harps Schedule: Meilhan UCB Support: Mission Assurance & Safety Jorg Fischer SEP Sci: Larson EE: Hatch ME: Glaser LPW (LASP) Sci: Ergun MAG (GSFC) Sci: Connerney LPW (SSL) Sci: Delory ME: Mc. Cauley EE: Sterling 1 -5

PFP Responsibilities MAVEN PFP ICDR May 23 -25, 2011 1 -6

PFP Responsibilities MAVEN PFP ICDR May 23 -25, 2011 1 -6

Contracting • Phase C/D Contracts in place – SSL and LASP/LPW independently contracted to

Contracting • Phase C/D Contracts in place – SSL and LASP/LPW independently contracted to GSFC for MAVEN PFP – Internal Funds Transfers from MAVEN Project to GSFC/MAG – IRAP/SWEA funded by CNES, contributed hardware to SSL • IRAP formerly CESR – Inter-agency agreement with Lawrence Berkeley Nartional Labs for SEP detector development • SSL Manages PFP development in collaboration with MAVEN Project Office – SSL Coordinates PFP Team • Schedules, Planning, Interfaces, Technical Resources, Risk Management, etc. – A common Instrument Manager at GSFC facilitates coordination of contracts, deliverables, funding, etc. • No changes in this configuration since PDR MAVEN PFP ICDR May 23 -25, 2011 1 -7

Team Experience • SSL has a long history of successful development of instrument suites:

Team Experience • SSL has a long history of successful development of instrument suites: – Wind 3 DP (5), FAST (5), MO/MGS/LP MAG/ER (2), STEREO IMPACT (7*2), THEMIS (5*5) • Team is experienced working together: – SSL w/ GSFC, Acuna/Connerney, MAG: MO, MGS, LP, STEREO – SSL w/ LASP, Ergun, LPW: FAST, THEMIS – SSL w/IRAP/CESR, Reme/Sauvaud/Mazelle, ESAs: Giotto RPA, Wind 3 DP, Cluster CIS, MO/MGS MAG/ER, STEREO IMPACT SWEA – SSL w/ Lockheed Spacecraft: MGS, LP • Centuries of experience building spaceflight instrumentation in the PFP team • No changes in the team key players since PDR – some additions at lower levels MAVEN PFP ICDR May 23 -25, 2011 1 -8

Staffing • PFP Team fully staffed – Consistent below planned FTE levels due to:

Staffing • PFP Team fully staffed – Consistent below planned FTE levels due to: • RBSP issues which have pulled MAVEN team members away • Shared staffing with other projects, resulting in unplanned efficiencies – Some team members have been distracted by continuing responsibilities with RBSP EFW instruments • SWIA/STATIC mechanical engineers • Power converter design team • Thermal engineer – Work-arounds have had some success • but SWIA/STATIC behind schedule in completing EM fabrication and test • SWIA and STATIC still have plenty of schedule margin to delivery MAVEN PFP ICDR May 23 -25, 2011 1 -9

Workforce Status, by CAM Area 87% 8 8 8 7 8 7 86 77

Workforce Status, by CAM Area 87% 8 8 8 7 8 7 86 77 7 6 6 6 75 6 6 5 5 4 65 5 5 44 53 4 43 2 33 83% of plan over-all MAVEN PFP ICDR May 23 -25, 2011 107% 96% DPU -- PLAN DPU -- ACTUAL SEP -- PLAN SEP -- ACTUAL LPW -- PLAN LPW -- ACTUAL STATIC SWIA SLF ----PLAN SLF SWIA STATIC -- ACTUAL SWEA -- PLAN SWEA -- ACTUAL 69% 62% 323 3 2 1 2 21 22 0 1 1 окт-10 11 10 окт-10 000 окт-10 0 0 окт-10 ноя-10 дек-10 янв-11 ноя-10 ноя-10 дек-10 дек-10 янв-11 янв-11 62% фев-11 мар-11 фев-11 фев-11 мар-11 мар-11 44% 1 -10

Communications - Meetings • In constant communication with the Project and the Team via

Communications - Meetings • In constant communication with the Project and the Team via any means necessary in order to identify and resolve issues in a timely manner • Participate in Project and LM Meetings: – – – Weekly Management Tag-Up telecon Weekly System Design Team telecon Weekly Electromagnetics Working Group telecon Weekly Payload telecon Weekly Parts Control Board ~Weekly Project CCB and LM ECB meetings ~Weekly Planetary Protection telecon Monthly PFP Management Reviews Monthly PFP Flight Software Status telecon Quarterly Status Reviews & Science Working Group Other meetings as needed: Operations, SMA, etc • Internal Meetings – Weekly team meetings – Weekly instrument-level meetings MAVEN PFP ICDR May 23 -25, 2011 1 -11

Communications - Documents • Periodic Reporting: – PFP Monthly & Quarterly Status Reports –

Communications - Documents • Periodic Reporting: – PFP Monthly & Quarterly Status Reports – PFP Monthly & Quarterly 533 financials – PFP Monthly Schedule updates • PFP Plans and other deliverables • Document Databases: – Project MIS Database & Configuration Control System • Submit deliverables, CCRs, etc • Interact with CCR process • Access Project Documents – PFP open-access ftp site for Documents & Configuration Control • ftp: //apollo. ssl. berkeley. edu/pub/MAVEN/ • Released documents, drawings, technical notes • Separate, access controlled site for the few ITAR-controlled and proprietary documents we get MAVEN PFP ICDR May 23 -25, 2011 1 -12

PFP Plans • • • • • MAVEN_PF_MGT_001 – SSL WBS & Dictionary MAVEN_PF_MGT_003

PFP Plans • • • • • MAVEN_PF_MGT_001 – SSL WBS & Dictionary MAVEN_PF_MGT_003 – Descopes List MAVEN_PF_QA_002 – Mission Assurance Implementation Plan MAVEN_PF_QA_001 – Mission Assurance Compliance Matrix 001_PA Plan - CESR SWEA Performance Assurance Plan MAVEN-RSS-PLAN-0038 – LASP RSS&LPW MAIP MAVEN_PF_QA_005 – Safety Plan MAVEN_PF_QA_012 – Contamination Control Plan MAVEN_PF_QA_015 – Planetary Protection Implementation Plan MAVEN_PF_SYS_006 – Gold Rule Compliance Matrix MAVEN_PF_SYS_008 – Software Development Plan MAVEN_PF_FSW_006 - Flight Software Test Plan MAVEN_PF_SYS_009 – System Engineering Management Plan MAVEN_PF_SYS_011 – Configuration Management Plan MAVEN_PF_SYS_012 – Risk Management Plan MAVEN_PF_SYS_018 – IT Security Plan MAVEN_PF_SYS_020 – Fault Management Description Document MAVEN_PF_SYS_023 – Verification & Validation Plan MAVEN_PF_SYS_024 – Integration and Test Plan MAVEN_PF_SYS_TBD – Logistics Plan – Pending, before MCDR Highlighted in Blue; New or revised since PDR. All under configuration control either by Project (Deliverables, on MIS) or by PFP MAVEN PFP ICDR May 23 -25, 2011 1 -13

PFP Requirements, Specifications, ICDs • • MAVEN-PFIS-RQMT-0016 – PFP Functional (Level 3 ) Requirements

PFP Requirements, Specifications, ICDs • • MAVEN-PFIS-RQMT-0016 – PFP Functional (Level 3 ) Requirements MAVEN-SC-ICD-0007 – PFP to Spacecraft ICD [CDR version pending signature] • • • • • MAVEN_PF_SYS_010 – Flight Software Requirements (L 4) MAVEN_PF_FSW_002 – Software Requirements Specification (L 5) MAVEN_PF_SYS_004 – PFDPU to Instruments ICD MAVEN_PF_SYS_003 – Power Converter Requirements MAVEN_PF_PFDPU_001 – Data Controller Board Specification MAVEN_PF_LPW_001 – LPW Specification (L 4) MAVEN_PF_SEP_001 – SEP Specification (L 4) MAVEN_PF_STATIC_001 – STATIC Specification (L 4) MAVEN_PF_SWEA_001 – SWEA CESR to SSL ICD MAVEN_PF_SWEA_002 – SWEA Specification (L 4) MAVEN_PF_SWIA_001 – SWIA Specification (L 4) MAVEN-MAG-RQMT-0061 - MAVEN Magnetometer Specification (L 4) MAVEN_PF_SYS_013 – Harnessing Drawing MAVEN_PF_SYS_016 – Connector Pinouts MAVEN_PF_SYS_018 – IT Security Plan MAVEN_PF_PFDPU_002 – PFDPU Interconnect Pinouts MAVEN_PFDPU-002 – PFDPU Board Outlines MAVEN_PF_SYS_024 – Drawing Tree Various – FPGA Specifications Various – Mechanical ICD Drawings – Mechanical ICDs, Circuit Datasheets, Thermal Memos MAVEN PFP ICDR May 23 -25, 2011 1 -14

PFP Analyses • • • MAVEN_PF_QA_004 – Fault Tree Analysis MAVEN_PF_QA_007 – FMEA /

PFP Analyses • • • MAVEN_PF_QA_004 – Fault Tree Analysis MAVEN_PF_QA_007 – FMEA / CIL / CICP MAVEN_PF_QA_008 – Limited Life Items List MAVEN_PF_QA_009 – Preliminary Hazard Analysis MAVEN_PF_QA_011 – Safety Assessment Report MAVEN_PF_QA_017 – Operational Hazard Analysis Several – MAVEN PFP Component Thermal Models MAVEN_PF_QA_003 –EEE Parts List MAVEN_PF_QA_010 – SSL Materials & Process List – 008, 009 – CESR Materials & Process List • MAVEN PFP Parts Stress Analyses – By board; 10 completed, 18 still in progress, complete before MCDR • Worst Case Analyses / Test – Pending for STATIC, complete before MCDR MAVEN PFP ICDR May 23 -25, 2011 1 -15

PFP Instrument PDR RFAs • All PFP pre-PDR Peer Review and PDR RFAs closed

PFP Instrument PDR RFAs • All PFP pre-PDR Peer Review and PDR RFAs closed MAVEN PFP ICDR May 23 -25, 2011 1 -16

Pre-CDR PFP Engineering Peer Reviews • A full set of PFP peer reviews was

Pre-CDR PFP Engineering Peer Reviews • A full set of PFP peer reviews was held including: – – SWEA at IRAP/CESR, 2011 -03 -28 LPW & EUV at LASP, 2011 -04 -25 MAG at GSFC, 2011 -05 -05 SEP, SWIA, STATIC, LPW Boom, PFDPU, FSW at SSL 05 -09 – 2011 -05 -11 2011 - • Very helpful informal technical interchanges with independent review teams • Concentrated on changes since PDR, Test & Analysis Results, Plans • Materials, Attendance, RFAs, Reports, RFA Responses posted to MIS • Still pending: Detailed FPGA peer reviews – Supported by Project / GSFC MAVEN PFP ICDR May 23 -25, 2011 1 -17

Pre-CDR Peer Review RFAs • Peer reviews too recent to have made much progress

Pre-CDR Peer Review RFAs • Peer reviews too recent to have made much progress in RFA closures – Plan to have all responses at least submitted by Mission CDR • Specific RFAs and responses to be discussed in subsystem presentations MAVEN PFP ICDR May 23 -25, 2011 1 -18

Management Metrics • Schedule – Schedule updated monthly at a minimum • Provided monthly

Management Metrics • Schedule – Schedule updated monthly at a minimum • Provided monthly to Project – – • Schedule slack (per instrument and critical path) Task slippage Historical problem spots Walk Around Financial – Spending tracked monthly by WBS element (instrument) • Cost vs Budget (spending rate and total) • 533 provided monthly to Project – Project starting EVM • SSL contract is below the EVM threshold, but SSL will benefit from Project EVM analysis results based on SSL inputs • Technical – Resource margins updated monthly (mass, power, processor) • Provided to Project as part of Monthly Status Report • Project CCR process for changes to NTE • Gold Rule Contingency levels maintained per development phase – Risk Levels from Risk Management System, updated monthly • Provided to Project as part of Monthly Status Report – Technical Issues • Gleaned from weekly team & instrument meetings • Provided to Project as part of Monthly Status Report MAVEN PFP ICDR May 23 -25, 2011 1 -19

Configuration Management • Project Configuration Management Plan defines Level 1 change control process –

Configuration Management • Project Configuration Management Plan defines Level 1 change control process – Level 1 changes affect Project configured documents, resources, cost, schedule milestones, contractual items, risk – PFP PM part of CCB process for changes impacting PFP – PFP also participates in LM ECB process for changes impacting PFP • Approved PFP Configuration Management Plan defines Level 2 change control process – PFP PM chairs PFP CCB • Determines what changes need to be elevated to Level 1 – Discusses any marginal changes with Project to determine classification • Approves changes that are Level 2 • Maintains configured database of documents on ftp site – PFP PM delegates lower level change authority to leads • Changes that don’t impact resources, configured items, level 4 requirements, interfaces, cost, or schedule MAVEN PFP ICDR May 23 -25, 2011 1 -20

Risk Management • Project Risk Management Plan describes Project-Level system • Approved PFP Risk

Risk Management • Project Risk Management Plan describes Project-Level system • Approved PFP Risk Management Plan describes how PFP Risk Management Processes work – Supports Project Risk Management Process – Collects risk inputs from all members of the PFP team on a monthly basis – Identifies Risk Areas for PFP mitigation or elevation to the Project level – Tracks risks to closure • LASP tracks and reports LASP/LPW risks separately per their plan • FSW tracks software risks separately and reports to PM for possible inclusion with other risks MAVEN PFP ICDR May 23 -25, 2011 1 -21

Top Risks MAVEN PFP ICDR May 23 -25, 2011 1 -22

Top Risks MAVEN PFP ICDR May 23 -25, 2011 1 -22

Risks List MAVEN PFP ICDR May 23 -25, 2011 1 -23

Risks List MAVEN PFP ICDR May 23 -25, 2011 1 -23

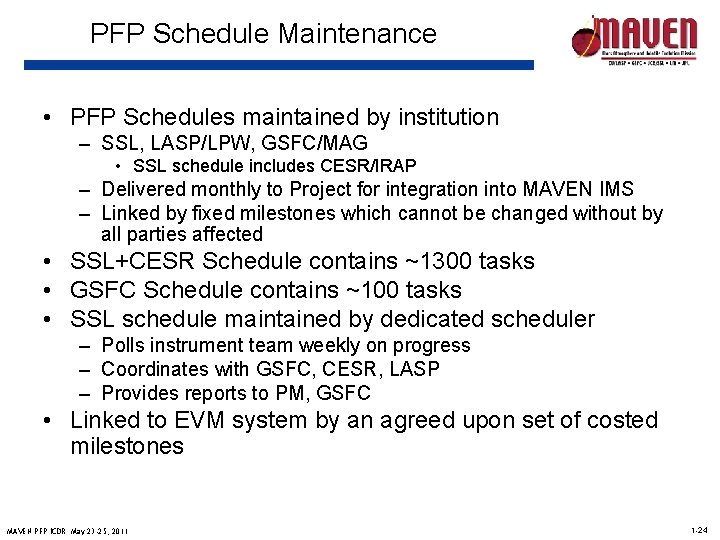

PFP Schedule Maintenance • PFP Schedules maintained by institution – SSL, LASP/LPW, GSFC/MAG •

PFP Schedule Maintenance • PFP Schedules maintained by institution – SSL, LASP/LPW, GSFC/MAG • SSL schedule includes CESR/IRAP – Delivered monthly to Project for integration into MAVEN IMS – Linked by fixed milestones which cannot be changed without by all parties affected • SSL+CESR Schedule contains ~1300 tasks • GSFC Schedule contains ~100 tasks • SSL schedule maintained by dedicated scheduler – Polls instrument team weekly on progress – Coordinates with GSFC, CESR, LASP – Provides reports to PM, GSFC • Linked to EVM system by an agreed upon set of costed milestones MAVEN PFP ICDR May 23 -25, 2011 1 -24

MAVEN PFP Schedule • • Instrument CDR May 23 -25 2011 Mission CDR July

MAVEN PFP Schedule • • Instrument CDR May 23 -25 2011 Mission CDR July 11 -15 2011 PFP PER May 2012 PFP PSR, Delivery November 2012 Launch November 2013 Arrive at Mars September 2014 End on nominal mission October 2015 MAVEN PFP ICDR May 23 -25, 2011 1 -25

Schedule Summary, CDR to Delivery MAVEN PFP ICDR May 23 -25, 2011 1 -26

Schedule Summary, CDR to Delivery MAVEN PFP ICDR May 23 -25, 2011 1 -26

Schedule Summary, CDR to Delivery MAVEN PFP ICDR May 23 -25, 2011 1 -27

Schedule Summary, CDR to Delivery MAVEN PFP ICDR May 23 -25, 2011 1 -27

Schedule Margins • FM Instrument deliveries to PFP Integration margin – MAG – 7.

Schedule Margins • FM Instrument deliveries to PFP Integration margin – MAG – 7. 4 weeks (was 12. 4 weeks at PDR) – LPW – 8. 2 weeks (was 11. 4 weeks at PDR) • Includes 2. 2 weeks to delivery from LASP plus 6 weeks to Package I&T – – – SEP – 10. 4 weeks (same as PDR) SWEA – 9. 4 weeks (was 11. 4 weeks at PDR) SWIA – 9. 8 weeks (was 10. 4 weeks at PDR) STATIC – 7. 4 weeks (was 10. 4 weeks at PDR) PFDPU – 9 weeks (was 11. 4 weeks at PDR) • PFP Integration to Ship margin – 10. 6 weeks – increased from 4 weeks at PDR due to later delivery requirement • So 18 weeks total margin CDR-Delivery on the critical path – Was 14. 4 weeks at PDR (plus 4. 4 weeks pre-CDR margin) – Out of 16 months – Critical Path currently through STATIC due to delays in completing EM fab & test • All schedule margin/slack is funded MAVEN PFP ICDR May 23 -25, 2011 1 -28

Schedule Status • Some instrument EM assembly/test still to be completed • • 18

Schedule Status • Some instrument EM assembly/test still to be completed • • 18 of 28 parts stress analyses still to be completed Detailed Board-level thermal analysis remain to be completed for all boards dissipating significant power (>0. 5 W) including: – Especially SWIA, STATIC – Includes SWIA/STATIC Attenuator life test, instrument calibrations – Includes STATIC ‘Worst Case Test’ voltage-temperature margin test – REG, IIB, DCB, DAP; SWIA Preamp, Power converters; STATIC Digital, TDC, Power Converters • • Feedback from EM testing to power converter requirements not complete Full-up PFP integrated package test • • PFDPU board mechanical PWB stress analysis to be finalized All of this will be completed and results delivered by Mission CDR with the following exceptions: • – Have completed all individual instrument to PFDPU integration, just not all at once – SWIA, STATIC Calibrations – SWIA, STATIC Attenuator Life test – These will be completed by mid August FM schedule assumes flight build not started until these tasks are completed on an instrument-by-instrument basis – i. e. SEP can start flight fab even though STATIC is not done with calibration MAVEN PFP ICDR May 23 -25, 2011 1 -29

Drawing Status • EM Drawings nearly 100% complete – Missing: • MAG Thermal blanket,

Drawing Status • EM Drawings nearly 100% complete – Missing: • MAG Thermal blanket, assembly drawing • PFDPU mechanical (pending MDM connector change) • PFDPU Flight-format FPGA daughter board layout (in review) • The majority of EM drawings will be converted to FM drawings with some minor exceptions as a result of EM assembly and test – FM Drawing release pending completion of EM testing in most cases MAVEN PFP ICDR May 23 -25, 2011 1 -30
