Long Range Planning Production Planning PP Resource Requirements

  • Slides: 20
Download presentation
長程的生產計劃 Long Range Planning Production Planning (PP) 生產規劃 Resource Requirements Planning (RRP) 資源需求規劃

長程的生產計劃 Long Range Planning Production Planning (PP) 生產規劃 Resource Requirements Planning (RRP) 資源需求規劃

生產規劃/計劃 Production Planning Input Process Output Forecasting 銷售預測 Production Planning 產能規劃/管理策略 Production Plan 公司各時期

生產規劃/計劃 Production Planning Input Process Output Forecasting 銷售預測 Production Planning 產能規劃/管理策略 Production Plan 公司各時期 (月,季)的 生產率及存貨 水準

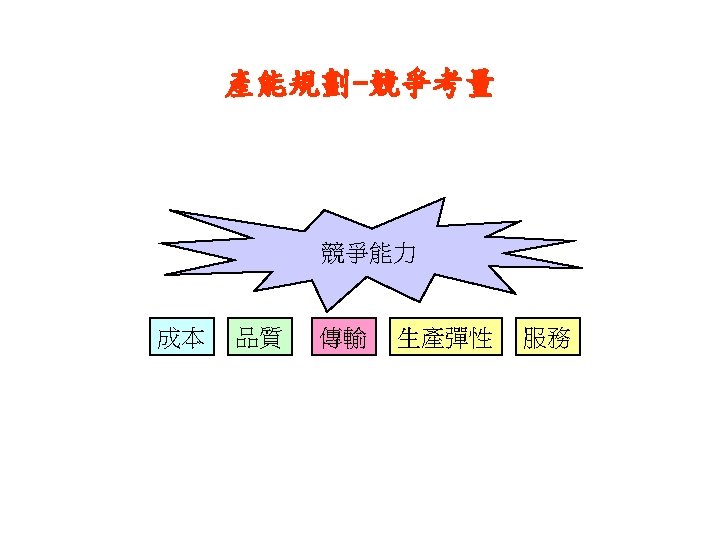

產能規劃策略 How big do we make the facilities? Where do we locate them? When

產能規劃策略 How big do we make the facilities? Where do we locate them? When do we build them? What type of process(es) do we install to make the products?

需求與產能的均衡 改變需求 Pricing Promotion Back Order (欠撥定單) New Demand

需求與產能的均衡 改變需求 Pricing Promotion Back Order (欠撥定單) New Demand

需求與產能的均衡 改變產能 (供給) Hire and Fire Worker Overtime/Slack Time Part Time Worker Inventories Subcontracting

需求與產能的均衡 改變產能 (供給) Hire and Fire Worker Overtime/Slack Time Part Time Worker Inventories Subcontracting

迎合不均勻需求的產能管理策略 Level Capacity Strategy 平準化產能策略 Maintaining a steady rate of regular-time output while meeting

迎合不均勻需求的產能管理策略 Level Capacity Strategy 平準化產能策略 Maintaining a steady rate of regular-time output while meeting variations in demand by a combination of option.

迎合不均勻需求的產能管理策略 Chase Demand Strategy 追逐需求策略 Matching capacity to demand; the planned output for a

迎合不均勻需求的產能管理策略 Chase Demand Strategy 追逐需求策略 Matching capacity to demand; the planned output for a period is set at the expected demand for that period.

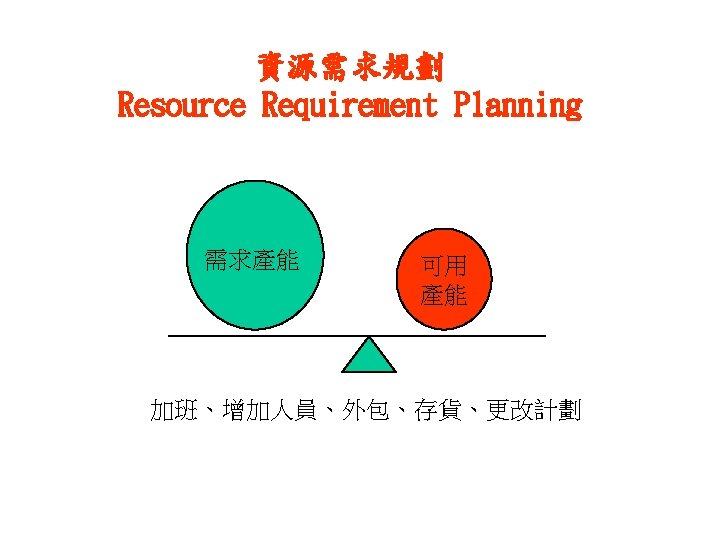

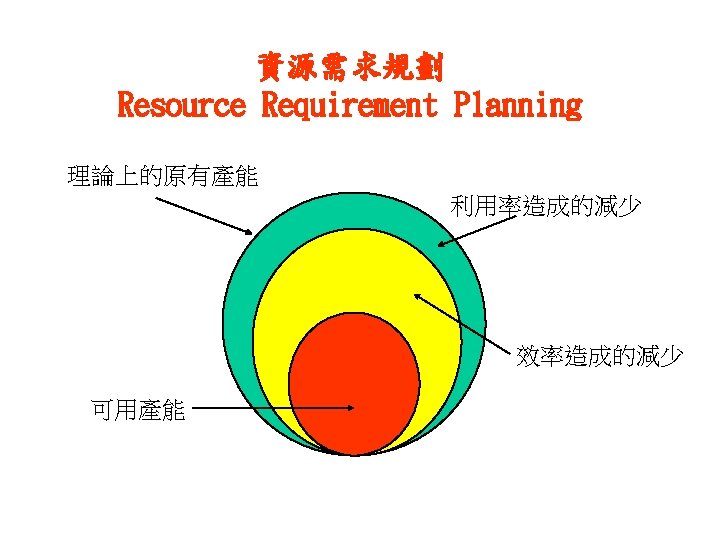

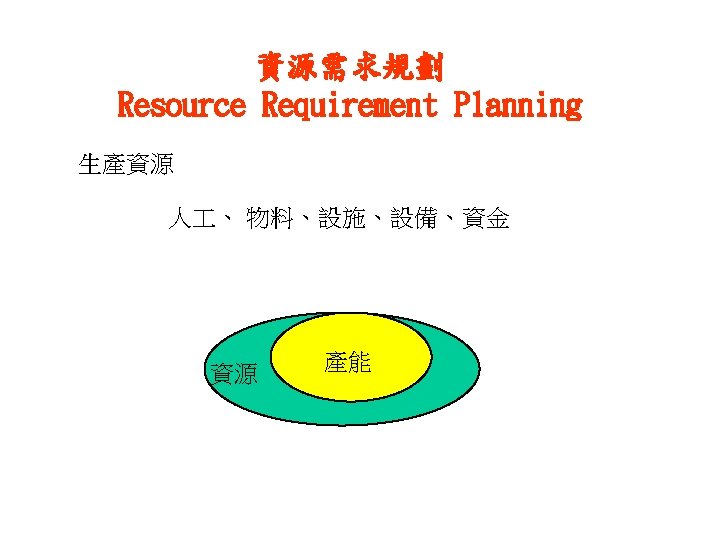

資源需求規劃 Resource Requirement Planning 產品群生 產資訊 + Resource Profile + 資源及物料需求 Material Profile

資源需求規劃 Resource Requirement Planning 產品群生 產資訊 + Resource Profile + 資源及物料需求 Material Profile

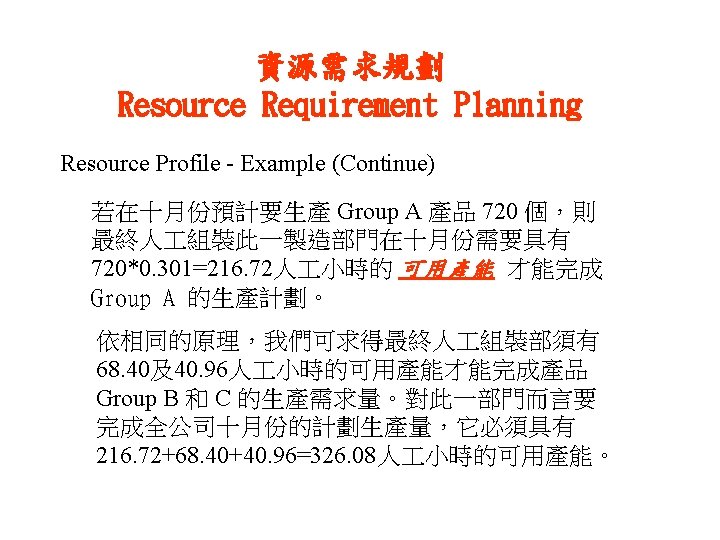

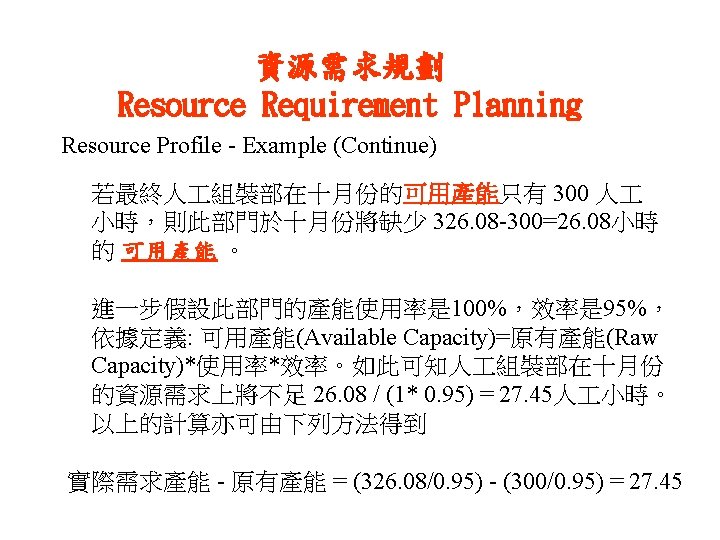

資源需求規劃 Resource Requirement Planning Resource Profile - Example (參考課本 p. 50) Group A -

資源需求規劃 Resource Requirement Planning Resource Profile - Example (參考課本 p. 50) Group A - 最終人 組裝部門 Item # 需求% 1 50% 0. 342 2 30% 0. 294 3 20% 0. 210 標準 時 平均組裝 時=0. 342 * 0. 5+0. 294*0. 3+0. 21*0. 2=0. 301
