LIUPLI report LIU PT meeting PLAN LIU Project

  • Slides: 9
Download presentation
LIU–PLI report LIU PT meeting

LIU–PLI report LIU PT meeting

PLAN LIU Project Some numbers: • 10 activities cancelled by TE-MSC as apparently already

PLAN LIU Project Some numbers: • 10 activities cancelled by TE-MSC as apparently already declared under other activities • 2 activities kept in created status because of missing information follow-up ongoing with the responsible and the LS 2 C • 14 activities in the prioritization phase follow-up ongoing with the LS 2 C • 25 activities already in the ressource allocation status • 113 activities already approved Follow-up of the resources confirmation till 12 th December LIU-IONS 19 October 2017 LIU-PSB LN 4 LIU-PSB LIU PT meeting - J. Coupard LIU-PS LIU-SPS 2

Readiness for installation during LS 2 Document in EDMS: • • Readiness for LS

Readiness for installation during LS 2 Document in EDMS: • • Readiness for LS 2 – LIU-IONS Readiness for LS 2 – LIU-PSB Readiness for LS 2 – LIU-PS Readiness for LS 2 – LIU-SPS LIU-PM-SC-0004 LIU-PM-SC-0005 LIU-PM-SC-0006 In Work Under Approval Not Started List of equipment not ready for installation at the start of LS 2 (i. e. January 2019) • LIU-PSB: [BE-BI] Fast wire scanners period 4 and 11 July 2019 (Draft 3, installation 2018. . ) • LIU-PSB: [EN-STI] Absorber period 8 February 2020 (not clearly defined in APT, but end of installation declared in December 2019) • LIU-PS: [EN-CV] Ventilation system for the building 269 May 2019 (APT: not found) • LIU-PS: [EN-STI] PS internal dumps March 2020 (not clear information in APT, DE defined per year) • LIU-PS: [EN-STI] PS ralentisseur November 2019 (APT: not found) • LIU-PS: [EN-STI] Upgraded beam stoppers November 2019 (APT: Installation from January 2019) • LIU-PS: [TE-ABT] Injection septum PI. SMH 42/BSW 42 July 2019 (coherent with APT) • LIU-PS: [TE-ABT] Injection kicker KFA-45 January 2020 (coherent with APT) • LIU-PS: [TE-EPC] Power converters for the new bumpers January 2020 (not coherent in APT, still January 2019) • LIU-PS: [TE-MSC] Injection bumpers March 2019 (coherent with APT) • LIU-PS: [TE-MSC] Injection quardupole (normal and skew) March 2019 (coherent with APT) • LIU-PS: [TE-MSC] Injection vertical correctors DVT March 2019 (coherent with APT) • LIU-PS: [TE-MSC] Corrector magnet for the vertical BGI February 2020 (APT: not found) • LIU-PS: [TE-MSC] TT 2 magnets March 2019 (APT: not found) 19 October 2017 LIU PT meeting - J. Coupard 3

Progress on LS 2 detailed schedule Linac 4 connection 3 ECRs describe the entire

Progress on LS 2 detailed schedule Linac 4 connection 3 ECRs describe the entire work for the connection of the Linac 4 from Linac 4 Project: • Partial Disassembly of Linac 2, EDMS 1688400, Under Approval • Connection of Linac 4 to LT. BHZ 20, EDMS 1688387, Under Approval • LBE line and infrastructure, EDMS 1805620, Under Approval Presentation of the schedule during the Linac 4 -PSB 160 Me. V connection readiness review held on 30 th August 2016, Indico 548092 Aurelio Berjillos completed/adjusted the detailed schedule according to the completion of the integration studies and ECR approval process. The detailed schedule will be stored in EDMS LIU Planning and Installation (EDMS rights to Aurelio) Next steps: Split the schedule and • Include all the work inside the PS switch yard (transfer lines, LBE, LBS) in the PS&TT 2 detailed schedule Fernando • Complete the Linacs (2, 3, 4) schedule with work on Linac 4 side and consolidations Aurelio 19 October 2017 LIU PT meeting - J. Coupard 4

De-cabling/cabling campaigns Cooling and Ventilation works Progress on LS 2 detailed schedule PSB To

De-cabling/cabling campaigns Cooling and Ventilation works Progress on LS 2 detailed schedule PSB To start earlier (complex installation) To coordinate with cabling campaigns • Lots of activities to schedule according to readiness and co-activities • Coordination meeting in progress • Dedicated meetings about the sequence of the work for the transfer lines and injection region will start soon 19 October 2017 IN WORK LIU PT meeting - J. Coupard No lots of margin 5

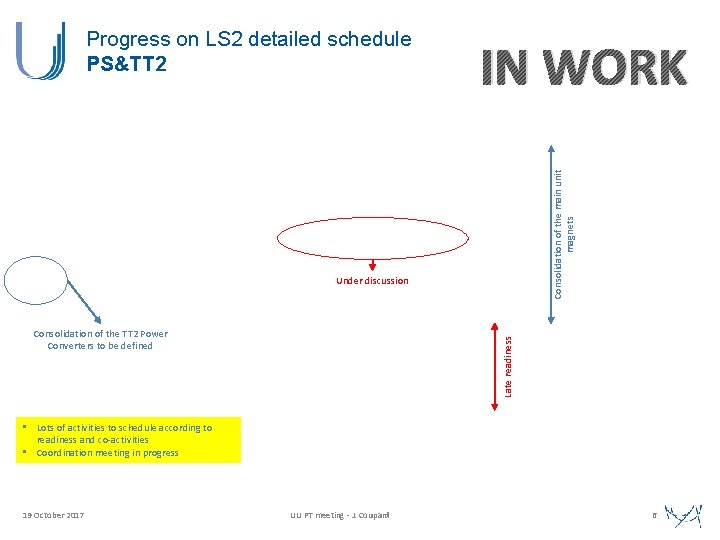

IN WORK Consolidation of the main unit magnets Progress on LS 2 detailed schedule

IN WORK Consolidation of the main unit magnets Progress on LS 2 detailed schedule PS&TT 2 Under discussion Late readiness Consolidation of the TT 2 Power Converters to be defined • Lots of activities to schedule according to readiness and co-activities • Coordination meeting in progress 19 October 2017 LIU PT meeting - J. Coupard 6

Progress on LS 2 detailed schedule PS&TT 2 We still need important information to

Progress on LS 2 detailed schedule PS&TT 2 We still need important information to prepare a realistic detailed schedule: • Consolidation of 42 main units in the PS ring + 38 quadrupole magnets in TT 2 Sequence to be defined with TE-MSC (depending on the workshop logistics) • Modification of the PS and TT 2 Demineralised Water Cooling Circuits (EDMS 1835995) Integration in stand-by (need to access the PS) • De-cabling/Cabling campaigns Need information from EN-EL • EN-EL renovation/consolidation Need information from EN-EL • Schedule compatibility for the LBE beam test during 2019 under discussion (EDMS 1853898) Next meeting on 31 st October • Compatibility of the detailed schedule for LBE and LBS lines • Consolidation of the TT 2 power converters (b. 269) 19 October 2017 LIU PT meeting - J. Coupard 7

Progress on LS 2 detailed schedule SPS IN WORK • Lots of co-activities to

Progress on LS 2 detailed schedule SPS IN WORK • Lots of co-activities to detail and coordinate • Coordination meeting in progress To be fully detailed 19 October 2017 LIU PT meeting - J. Coupard 8

Progress on LS 2 detailed schedule SPS We still need important information to prepare

Progress on LS 2 detailed schedule SPS We still need important information to prepare a realistic detailed schedule: • De-cabling/Cabling campaigns Need information from EN-EL • Replacement of the irradiated cables in BA 2 Need LS 2 C decisions • Detailed schedule for the SPS New Beam Dump (BA 1 and BA 5) Aurelio • Detailed schedule of the SPS RF 200 MHz Upgrade (BA 3) David • Detailed schedule of the SPS Fire Safety Project David • Detailed schedule of the Renovation of the SPS Access System Project David 19 October 2017 LIU PT meeting - J. Coupard 9
