LEDOutlined Traffic Signs on the ISU Campus May

  • Slides: 45
Download presentation
LED-Outlined Traffic Signs on the ISU Campus May 07 -01 Jacob Bonner Dustin Nekvinda

LED-Outlined Traffic Signs on the ISU Campus May 07 -01 Jacob Bonner Dustin Nekvinda Hieu Pham Brian Schnurr David Wallace

System Operation Master 2

System Operation Master 2

System Operation Master 3

System Operation Master 3

Presentation Outline n n n Problem description Definitions Acknowledgement Operating Environment Intended Users/Uses Assumptions

Presentation Outline n n n Problem description Definitions Acknowledgement Operating Environment Intended Users/Uses Assumptions and Limitations n n n Expected End Product Present Accomplishments Project Definition of Activities Resources and Schedule Closing Material 4

Definitions n n n Programmable Integrated Chip (PIC) - A small chip that can

Definitions n n n Programmable Integrated Chip (PIC) - A small chip that can be programmed to control data flow and overall system functionality. Manual On Uniform Traffic Control Devices (MUTCD) - The MUTCD defines the standards used by road managers nationwide to install and maintain traffic control devices on all streets and highways. DOT - Department of Transportation DPS - Department of Public Safety FP&M - Facilities Planning and Management CCEE - Department of Civil, Construction, and Environmental Engineering 5

Introductory Material n Problem Statement n Operating Environment n Intended Users & Uses n

Introductory Material n Problem Statement n Operating Environment n Intended Users & Uses n Assumptions & Limitations n End Product & Deliverables 6

Problem Statement n n Rob Stupka Pedestrian traffic is extremely high on campus. Need

Problem Statement n n Rob Stupka Pedestrian traffic is extremely high on campus. Need to alert drivers of pedestrian. The signs have lights that will flash to get the driver’s attention. 7

Operating Environment n n n Iowa State University campus. The signs will be able

Operating Environment n n n Iowa State University campus. The signs will be able to stand up to Iowa weather conditions. Solar powered 8

Intended Users/Uses n n Iowa State University Department of Public Safety. Motorists Students, faculty

Intended Users/Uses n n Iowa State University Department of Public Safety. Motorists Students, faculty and visitorsn to campus. Alert drivers of situations that may involve pedestrians. To allow pedestrians to cross the street more safely. 9

Assumptions n n LED cluster in each corner Automatic flashing during regular 10 minute

Assumptions n n LED cluster in each corner Automatic flashing during regular 10 minute class breaks Solar powered Wireless communication Limitations n n n Sunlight availability Unprecedented extreme weather conditions LEDs must be seen at required distances and not blind motorists at night 10

End Product & Deliverables n Prototype n n n Two working signs with components.

End Product & Deliverables n Prototype n n n Two working signs with components. One working master control circuit. Design Report n n Documentation and schematics Parts list and assembly instructions. 11

Project Activity Approaches Considered/Used n Accomplishments n Project Activities n Project Definition n Research

Project Activity Approaches Considered/Used n Accomplishments n Project Activities n Project Definition n Research n Design n Implementation n Testing/Results n Other n 12

Approaches Considered/Used n LEDs – 106, 200 milli-Candela n Advantages n High level of

Approaches Considered/Used n LEDs – 106, 200 milli-Candela n Advantages n High level of illumination (925 ft) n Low energy consumption n Disadvantage n High current (90 m. A) n Flasher-dimmer module n Advantage n Energy saving n DOT regulation – 50 to 60 flash per minute 13

Approaches Considered/Used (cont. ) n Evaluated power system options Hard wired AC n Solar

Approaches Considered/Used (cont. ) n Evaluated power system options Hard wired AC n Solar power n n Acquired software from May 06 -06 to calculate solar power needs n n Determined necessary battery and panel size PIC requirements 14

Approaches Considered/Used (cont. ) n Programmable integrated chip – PIC 16 F 877 A

Approaches Considered/Used (cont. ) n Programmable integrated chip – PIC 16 F 877 A n Advantages n Low cost ($9) n Powerful (RAM, data size, speed) 15

Approaches Considered/Used (cont. ) Communication Infrared (IR) Wi. Fi Bluetooth (RF Tranceiver) Cost Low

Approaches Considered/Used (cont. ) Communication Infrared (IR) Wi. Fi Bluetooth (RF Tranceiver) Cost Low Highest Low Vulnerable to object interference Yes No No Vulnerable to freq. interference No Yes No Multi-connection (greater than 2) No Yes Outdoor Range 300 ft. Many miles 500 ft. Power consumption Lowest Highest Low 16

Accomplishments n Sign display Capture motorist attention n Inform pedestrian n n Reliable power

Accomplishments n Sign display Capture motorist attention n Inform pedestrian n n Reliable power source Battery - primary n Solar - secondary n 17

Accomplishments (cont. ) n Communication network Coordination -transmit/receive n Signal identification n n Programmable

Accomplishments (cont. ) n Communication network Coordination -transmit/receive n Signal identification n n Programmable integrated chip (PIC) Real time n On demand - pushbutton n Automatic on/off n 18

Project Activities (1/6) Project Definition n Composed project plan n Designed physical sign system

Project Activities (1/6) Project Definition n Composed project plan n Designed physical sign system n Wrote controller software 19

Solar Power Need Calculator 20

Solar Power Need Calculator 20

Project Activities (2/6) Research n Battery – Seal absorbed glass mat n Advantage n

Project Activities (2/6) Research n Battery – Seal absorbed glass mat n Advantage n n Seal completely Operating temperature (-25° C to 80° C) Less maintenance Disadvantage n n More expensive Big and heavy n Charge controller – Sun. Guard n Advantage n n Improve performance (30% per day) Over current protection Over voltage protection Low cost ($27) 21

Project Activities (2/6) Research (cont. ) Power source Cost Power line Solar power $2,

Project Activities (2/6) Research (cont. ) Power source Cost Power line Solar power $2, 250 $796 Green power No Yes Portable No Yes Reliable Yes Some time n Battery n Store power 22

Project Activities (3/6) Design 23

Project Activities (3/6) Design 23

Project Activities (4/6) Implementation n n Master system -Using PIC microcontroller’s internal clock for

Project Activities (4/6) Implementation n n Master system -Using PIC microcontroller’s internal clock for time keeping Slave system – Using a signaling LED cluster vs. countdown timer. n n n High cost -$650 to $1, 300 Bulky on the sign False sense of security 24

Project Activities (5/6) Testing n Three main test areas Subsystems component testing n Integrated

Project Activities (5/6) Testing n Three main test areas Subsystems component testing n Integrated systems testing n Outdoor site testing n 25

Project Activities (5/6) Testing - Subsystems 26

Project Activities (5/6) Testing - Subsystems 26

Project Activities (5/6) Testing – Subsystem Integration 27

Project Activities (5/6) Testing – Subsystem Integration 27

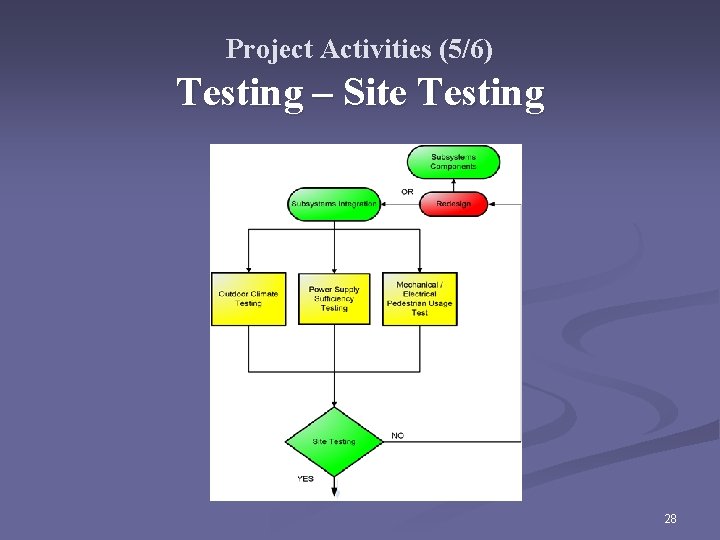

Project Activities (5/6) Testing – Site Testing 28

Project Activities (5/6) Testing – Site Testing 28

Project Activities (6/6) Other Using round tube instead of Telespar n Evaluated software language

Project Activities (6/6) Other Using round tube instead of Telespar n Evaluated software language (C, ASM, JAL) n 29

Resources & Schedule n Personal Effort n Financial Requirements n Schedule 30

Resources & Schedule n Personal Effort n Financial Requirements n Schedule 30

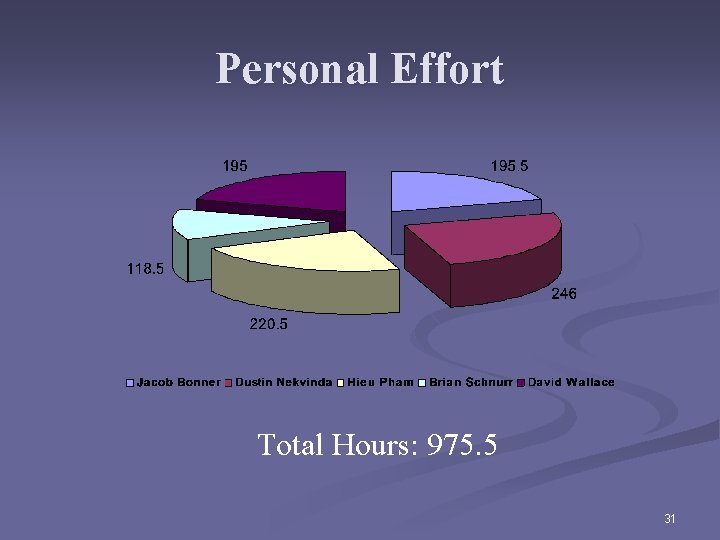

Personal Effort Total Hours: 975. 5 31

Personal Effort Total Hours: 975. 5 31

Financial Requirements Item Cost Signs Donated LED’s $120. 00 Battery $304. 00 Solar Panel

Financial Requirements Item Cost Signs Donated LED’s $120. 00 Battery $304. 00 Solar Panel $338. 00 Solar Panel Mounts $100. 00 Hardware Donated Communications $100. 00 PIC $20. 00 Enclosure $200. 00 Controller $168. 00 Total $1, 350. 00 Total Cost: $13, 056 32

Schedule 33

Schedule 33

Closing Material Project Evaluation n Commercialization n Additional Work n Lessons Learned n Risk

Closing Material Project Evaluation n Commercialization n Additional Work n Lessons Learned n Risk & Risk Management n Closing Summary n Questions n 34

Project Evaluation May 07 -01 Design Evaluation Relative Importance (%) Functionality Evaluation Score (%)

Project Evaluation May 07 -01 Design Evaluation Relative Importance (%) Functionality Evaluation Score (%) Resultant Score Signs will flash when requested from the pushbutton 30% 100% 30% Automatically flashes signs during high traffic times (class transitions) 20% 100% 20% Signs successfully send and receive information with the master controller 20% 100% 20% System will be able to operate only on solar power 15% 100% 15% System will comply with all known traffic laws and standards 10% 10% Systems will be able to operate under all weather conditions 5% 100% Total 35

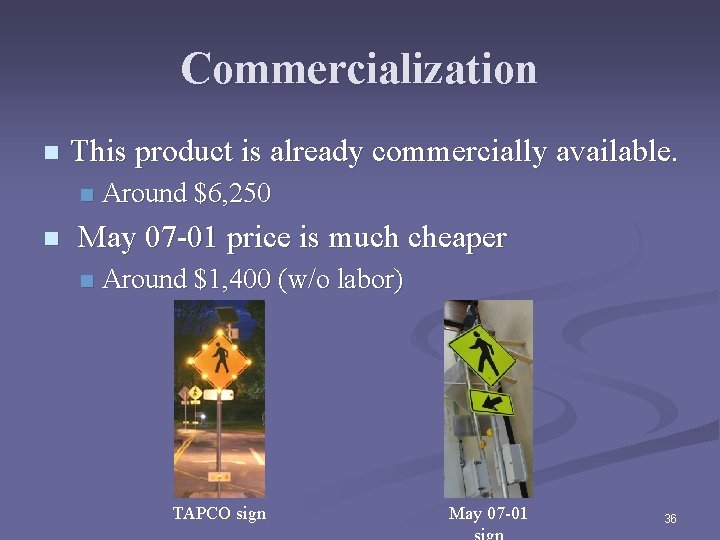

Commercialization n This product is already commercially available. n n Around $6, 250 May

Commercialization n This product is already commercially available. n n Around $6, 250 May 07 -01 price is much cheaper n Around $1, 400 (w/o labor) TAPCO sign May 07 -01 36

Additional Work Audio system for the blind n Logging system for tracking use of

Additional Work Audio system for the blind n Logging system for tracking use of system n Proximity sensor to automatically turn the system on n WWVB and Real Time Clock n 37

Lessons Learned (1/5) What Went Well Client-team interaction n Team communication n On schedule

Lessons Learned (1/5) What Went Well Client-team interaction n Team communication n On schedule throughout most of project n Constantly working even when parts were missing n 38

Lessons Learned (2/5) What Did Not Go Well n Delayed arrival of components Could

Lessons Learned (2/5) What Did Not Go Well n Delayed arrival of components Could not get the system installed in time n Testing was delayed n n Inadequate research prior to initial ordering Area researched ≠ area implemented n Communication with supporting departments n 39

Lessons Learned (3/5) Technical Knowledge Gained PIC programming and functionality n Communication technologies n

Lessons Learned (3/5) Technical Knowledge Gained PIC programming and functionality n Communication technologies n Mechanical engineering skills n MUTCD regulations n 40

Lessons Learned (4/5) Non-Technical Knowledge Gained Project management n Schedule management using Gantt charts

Lessons Learned (4/5) Non-Technical Knowledge Gained Project management n Schedule management using Gantt charts n Communication management between multiple departments n DPS n FP&M n CCEE n DOT n 41

Lessons Learned (5/5) Things Done Different Next Time Divide into sub-sections earlier n Make

Lessons Learned (5/5) Things Done Different Next Time Divide into sub-sections earlier n Make sure components are finalized with client so ordering can take place sooner n Start testing earlier n 42

Risk & Risk Management Anticipated potential risks n Loss of team member n n

Risk & Risk Management Anticipated potential risks n Loss of team member n n Every member knows what the other is doing Not encountered Unanticipated encountered risks n Flasher/Dimmer module was incorrectly labeled and destroyed. n n Team pulled same module from another project Lack of interest by certain contacts involved with the project. n Client was addressed and assured the team of the project’s importance 43

Closing Summary System is intended to save lives n Provide a means of warning

Closing Summary System is intended to save lives n Provide a means of warning n No guarantees n Give a chance to avoid tragedy n 44

Any Questions? 45

Any Questions? 45
