LEBT MEBT Insertable devices HW status LEBT FC
LEBT MEBT Insertable devices HW status LEBT FC MEBT FC WS EMU AS EMU SG SC BSM 1
LEBT MEBT Insertable devices HW status LEBT FC Beam line: MEBT FC Beam line HW installation: fully installed Cabling machine side: completed WS MPS modifications: completed Water flow & temperature: not connected EMU AS Collision protection: not implemented Control racks: EMU SG ECAT crate installed HVPS installed SC m. TCA ready for installation Internal cabling partially. BSM completed Testing: Motion testing without beam: partially completed Verification plan released 2
LEBT MEBT Insertable devices HW status MEBT FC Beam line: MEBT FC Beam line HW installation: fully installed Cabling machine side: completed WS MPS modifications: completed Water flow & temperature: not connected EMU AS Control racks: ECAT crate: tests ongoing sensors) EMU(NAMUR SG HVPS: installed m. TCA: ready for installation SC Internal cabling: partially completed Testing: BSM Motion testing without beam: not started Verification plan released 3

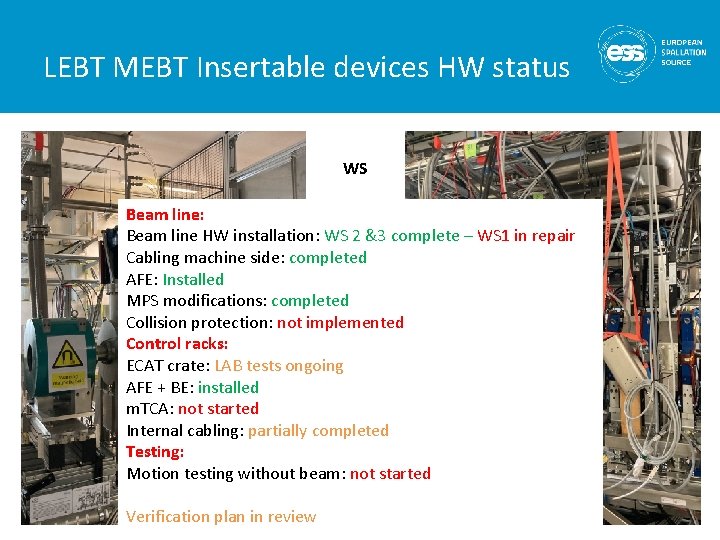

LEBT MEBT Insertable devices HW status WS MEBT FC Beam line: Beam line HW installation: WS 2 &3 complete – WS 1 in repair WS Cabling machine side: completed AFE: Installed EMU AS MPS modifications: completed Collision protection: not implemented EMU SG Control racks: ECAT crate: LAB tests ongoing SC AFE + BE: installed m. TCA: not started BSM Internal cabling: partially completed Testing: Motion testing without beam: not started Verification plan in review 4

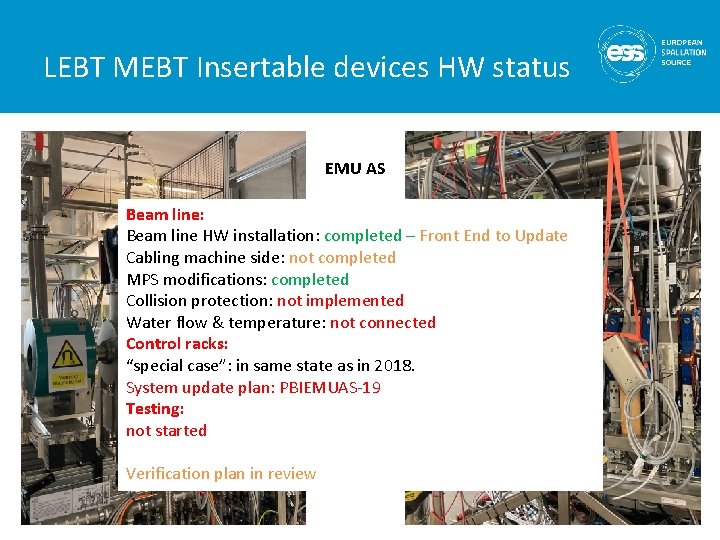

LEBT MEBT Insertable devices HW status EMU AS MEBT FC Beam line: Beam line HW installation: completed – Front End to Update WS Cabling machine side: not completed MPS modifications: completed EMU AS Collision protection: not implemented Water flow & temperature: not connected EMU SG Control racks: “special case”: in same state as in 2018. SC System update plan: PBIEMUAS-19 Testing: BSM not started Verification plan in review 5
LEBT MEBT Insertable devices HW status EMU SG MEBT FC Beam line: Beam line HW installation: Actuators complete – FE to install Cabling machine side: partially. WS completed MPS modifications: completed EMU AS Collision protection: not implemented Water flow & temperature: not connected EMU SG Control racks: not started SC Testing: Motion testing without beam: not started BSM Verification plan released 6
LEBT MEBT Insertable devices HW status SC MEBT FC Beam line: Beam line HW installation: completed Cabling machine side: partially. WS completed MPS modifications: completed EMU AS Collision protection: not implemented Water flow & temperature: not connected EMU SG Control racks: not started SC Testing: Motion testing without beam: not started BSM Verification plan to update 7
LEBT MEBT Insertable devices HW status BSM Beam line: MEBT FC Beam line HW installation: installed Cabling machine side: partially completed WS MPS modifications: ongoing Water flow & temperature: not connected EMU AS Collision protection: not implemented Control racks: EMU SG “special case”: fully tested installed in test rack. Deployment in FEB rack SC by IK team. Testing: Motion testing without. BSM beam: partially completed Verification plan to write from Sergei’s notes 8
