Iter Canada Plan for Hosting Iter Canadian Nuclear

  • Slides: 28
Download presentation
Iter Canada Plan for Hosting Iter Canadian Nuclear Society Professional Engineers Ontario March 29,

Iter Canada Plan for Hosting Iter Canadian Nuclear Society Professional Engineers Ontario March 29, 2001 1

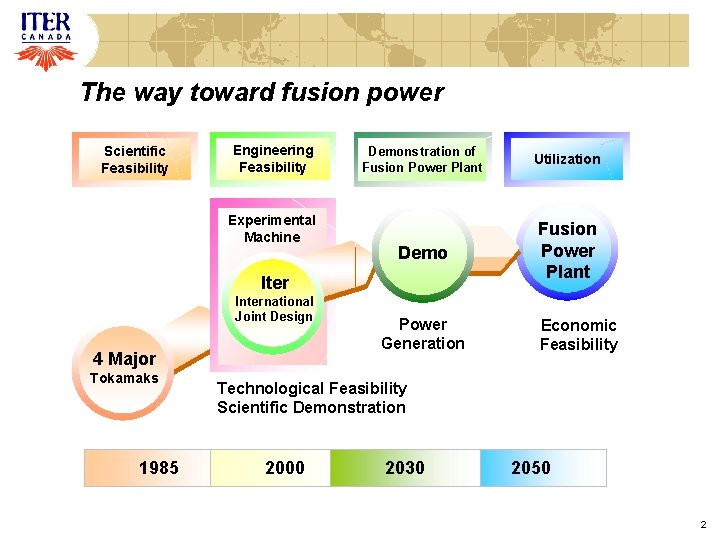

The way toward fusion power Scientific Feasibility Engineering Feasibility Experimental Machine Demonstration of Fusion

The way toward fusion power Scientific Feasibility Engineering Feasibility Experimental Machine Demonstration of Fusion Power Plant . Utilization Demo Fusion Power Plant Iter International Joint Design 4 4 Major Tokamaks 1985 Power Generation Economic Feasibility Technological Feasibility Scientific Demonstration 2000 2030 2050 2

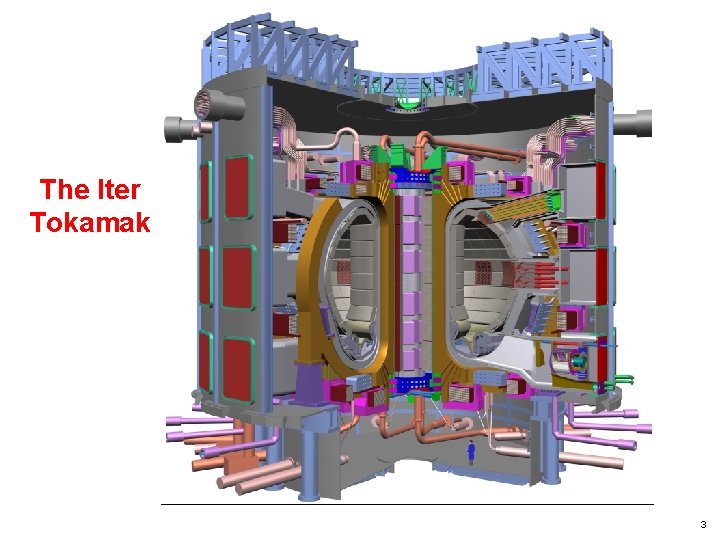

The Iter Tokamak 3

The Iter Tokamak 3

The Iter Tokamak Plasma +100, 000 o. C 4

The Iter Tokamak Plasma +100, 000 o. C 4

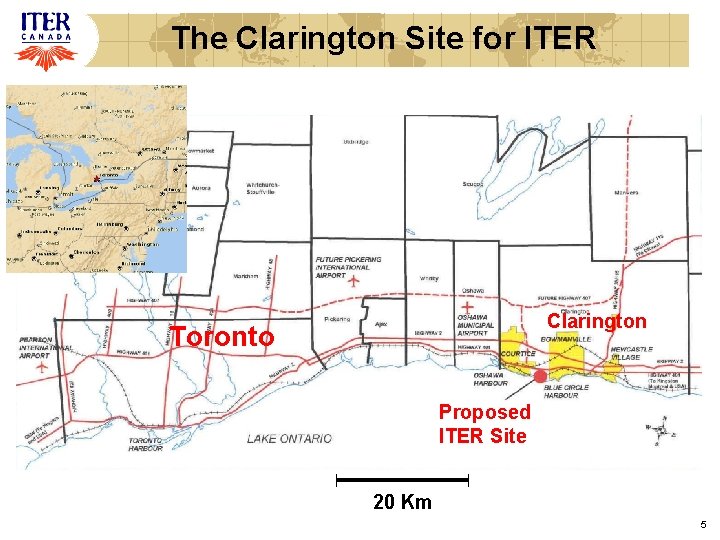

The Clarington Site for ITER Clarington Toronto Proposed ITER Site 20 Km 5

The Clarington Site for ITER Clarington Toronto Proposed ITER Site 20 Km 5

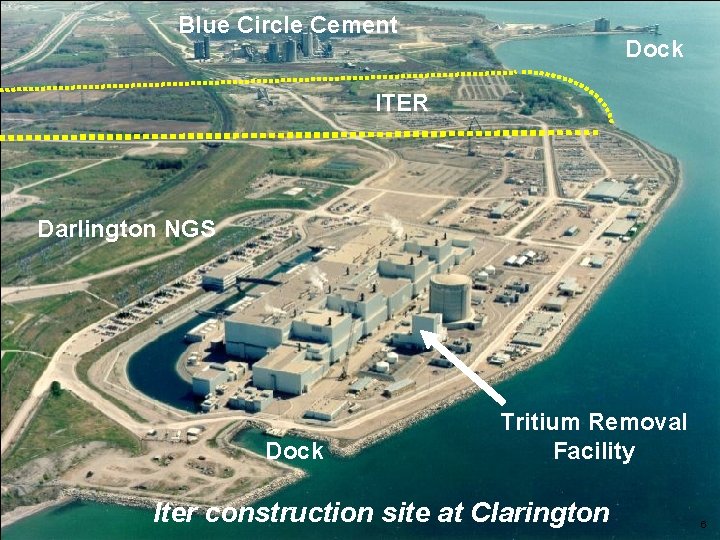

Blue Circle Cement Location for ITER at the Clarington Site Dock ITER Darlington NGS

Blue Circle Cement Location for ITER at the Clarington Site Dock ITER Darlington NGS Dock Tritium Removal Facility Iter construction site at Clarington 6

7

7

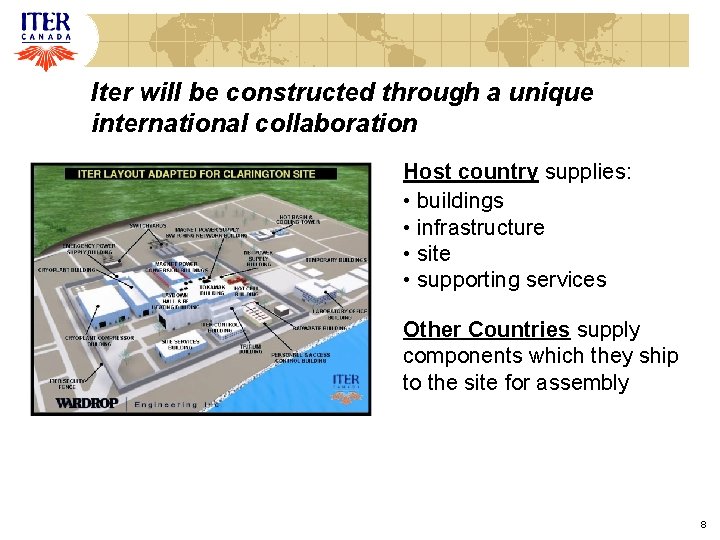

Iter will be constructed through a unique international collaboration Host country supplies: • buildings

Iter will be constructed through a unique international collaboration Host country supplies: • buildings • infrastructure • site • supporting services Other Countries supply components which they ship to the site for assembly ITER LAYOUT ADAPTED FOR CLARINGTON SITE 8

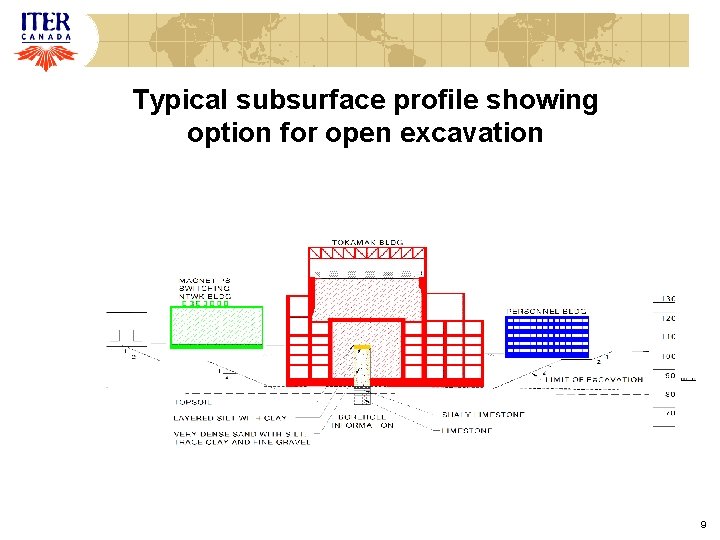

Typical subsurface profile showing option for open excavation 9

Typical subsurface profile showing option for open excavation 9

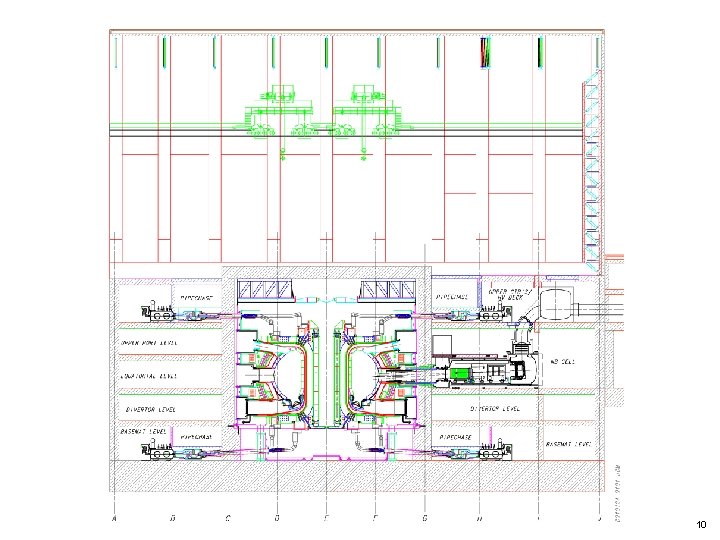

10

10

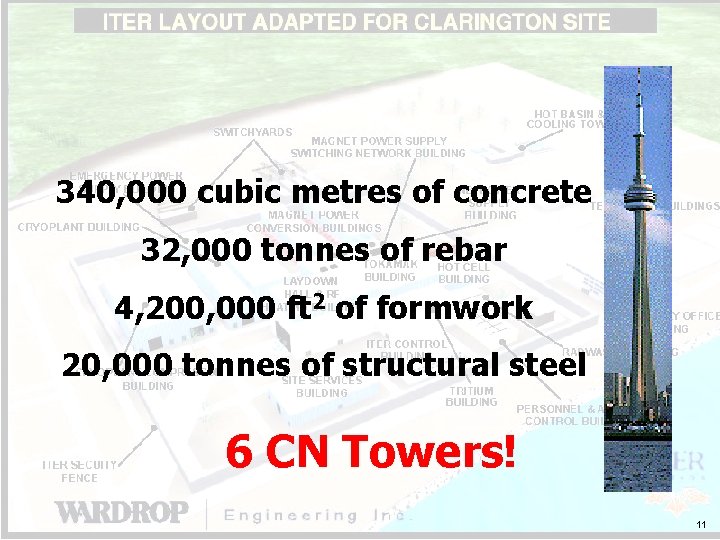

340, 000 cubic metres of concrete 32, 000 tonnes of rebar 4, 200, 000

340, 000 cubic metres of concrete 32, 000 tonnes of rebar 4, 200, 000 ft 2 of formwork 20, 000 tonnes of structural steel 6 CN Towers! 11

Our strength is in our stakeholders from both public and private sectors Private Sector

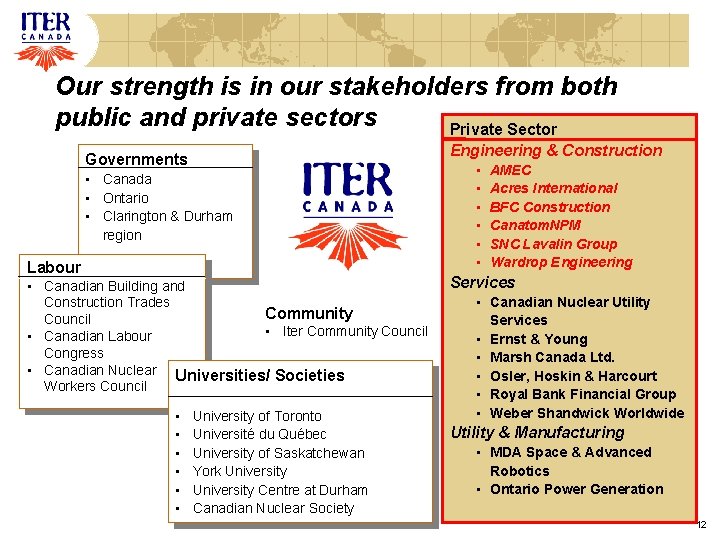

Our strength is in our stakeholders from both public and private sectors Private Sector Engineering & Construction Governments • Canada • Ontario • Clarington & Durham region Labour • Canadian Building and Construction Trades Community Council • Iter Community Council • Canadian Labour Congress • Canadian Nuclear Universities/ Societies Workers Council • • • University of Toronto Université du Québec University of Saskatchewan York University Centre at Durham Canadian Nuclear Society • • • AMEC Acres International BFC Construction Canatom. NPM SNC Lavalin Group Wardrop Engineering Services • Canadian Nuclear Utility Services • Ernst & Young • Marsh Canada Ltd. • Osler, Hoskin & Harcourt • Royal Bank Financial Group • Weber Shandwick Worldwide Utility & Manufacturing • MDA Space & Advanced Robotics • Ontario Power Generation 12

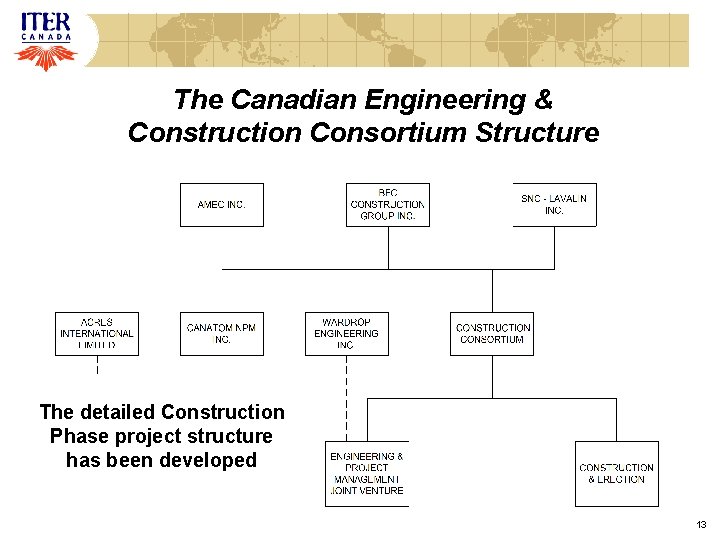

The Canadian Engineering & Construction Consortium Structure The detailed Construction Phase project structure has

The Canadian Engineering & Construction Consortium Structure The detailed Construction Phase project structure has been developed 13

Iter Canada Board of Directors 14

Iter Canada Board of Directors 14

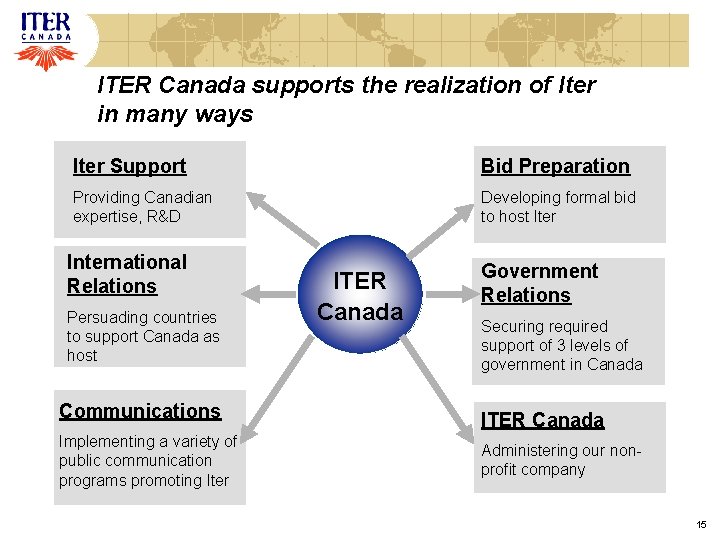

ITER Canada supports the realization of Iter in many ways Iter Support Bid Preparation

ITER Canada supports the realization of Iter in many ways Iter Support Bid Preparation Providing Canadian expertise, R&D Developing formal bid to host Iter International Relations Persuading countries to support Canada as host Communications Implementing a variety of public communication programs promoting Iter ITER Canada Government Relations Securing required support of 3 levels of government in Canada ITER Canada Administering our nonprofit company 15

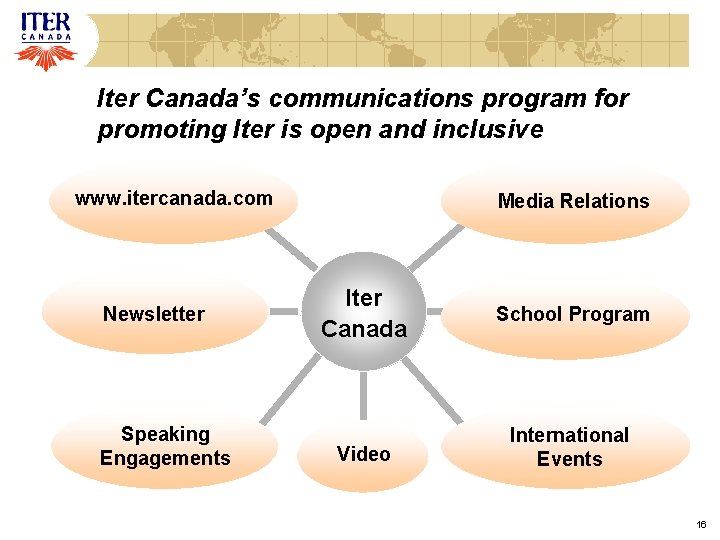

Iter Canada’s communications program for promoting Iter is open and inclusive www. itercanada. com

Iter Canada’s communications program for promoting Iter is open and inclusive www. itercanada. com Newsletter Speaking Engagements Media Relations Iter Canada School Program Video International Events 16

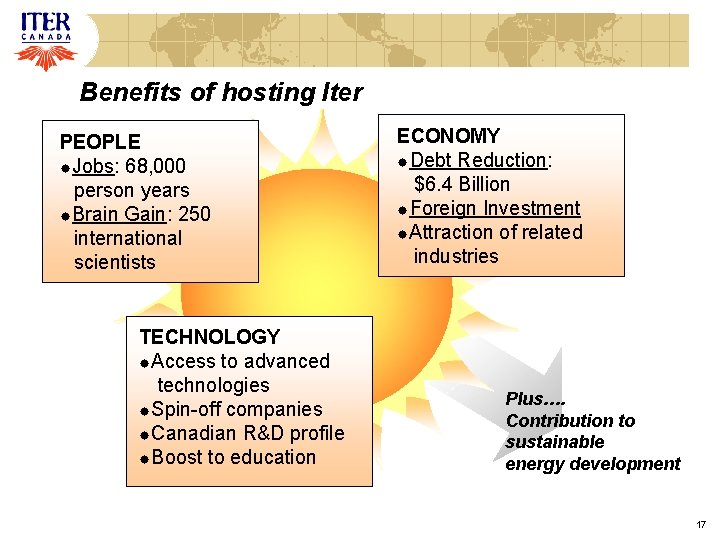

Benefits of hosting Iter PEOPLE ® Jobs: 68, 000 person years ® Brain Gain:

Benefits of hosting Iter PEOPLE ® Jobs: 68, 000 person years ® Brain Gain: 250 international scientists TECHNOLOGY ® Access to advanced technologies ® Spin-off companies ® Canadian R&D profile ® Boost to education ECONOMY ® Debt Reduction: $6. 4 Billion ® Foreign Investment ® Attraction of related industries Plus…. Contribution to sustainable energy development 17

Joelle Mailloux Fusion Physicist - JET 18

Joelle Mailloux Fusion Physicist - JET 18

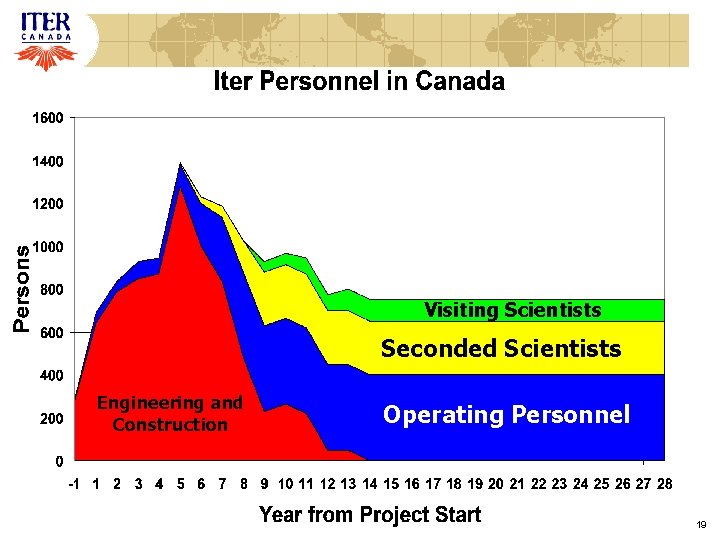

Visiting Scientists Seconded Scientists Engineering and Construction Operating Personnel 19

Visiting Scientists Seconded Scientists Engineering and Construction Operating Personnel 19

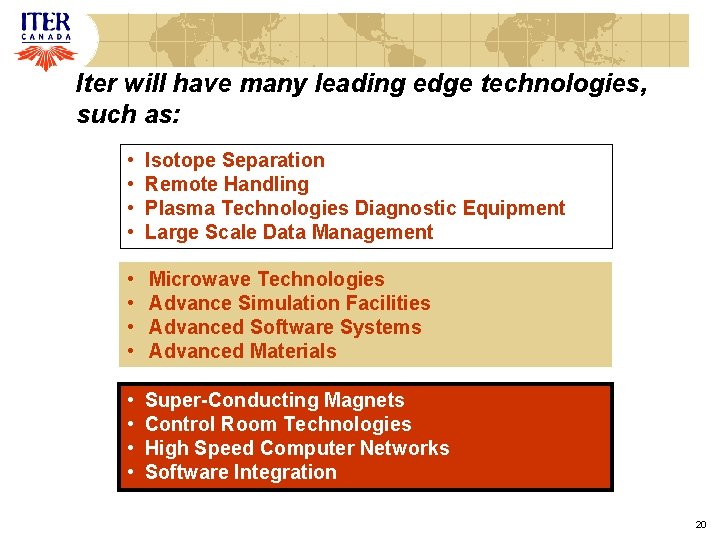

Iter will have many leading edge technologies, such as: • • Isotope Separation Remote

Iter will have many leading edge technologies, such as: • • Isotope Separation Remote Handling Plasma Technologies Diagnostic Equipment Large Scale Data Management • • Microwave Technologies Advance Simulation Facilities Advanced Software Systems Advanced Materials • • Super-Conducting Magnets Control Room Technologies High Speed Computer Networks Software Integration 20

Three Competitors for Hosting Iter: • Japan • France • Canada 21

Three Competitors for Hosting Iter: • Japan • France • Canada 21

Dr. Robert Aymar Director, Iter 22

Dr. Robert Aymar Director, Iter 22

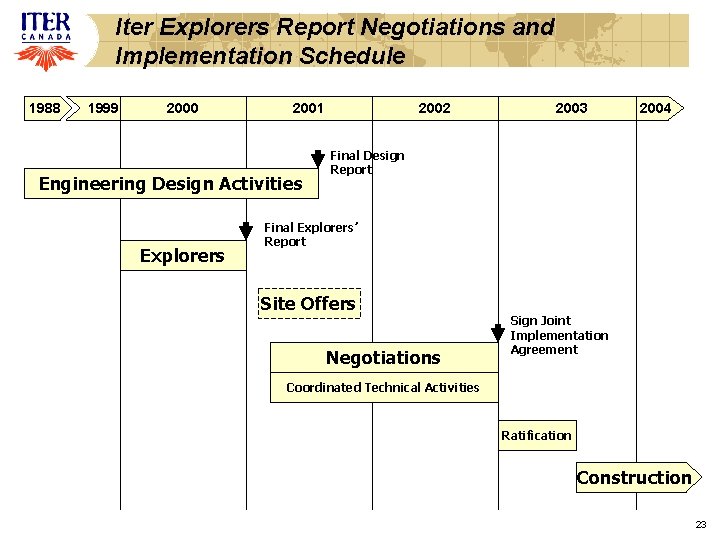

Iter Explorers Report Negotiations and Implementation Schedule 1988 1999 2000 2001 Engineering Design Activities

Iter Explorers Report Negotiations and Implementation Schedule 1988 1999 2000 2001 Engineering Design Activities Explorers 2002 2003 2004 Final Design Report Final Explorers’ Report Site Offers Negotiations Sign Joint Implementation Agreement Coordinated Technical Activities Ratification Construction 23

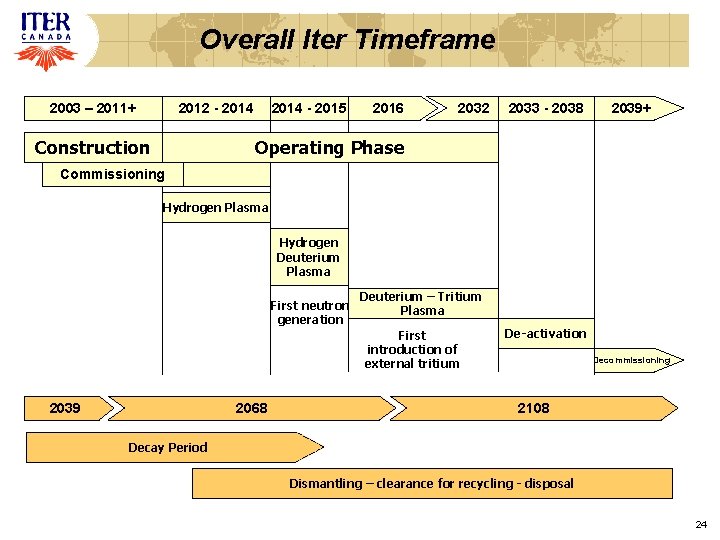

Overall Iter Timeframe 2003 – 2011+ 2012 - 2014 Construction 2014 - 2015 2016

Overall Iter Timeframe 2003 – 2011+ 2012 - 2014 Construction 2014 - 2015 2016 2032 2033 - 2038 2039+ Operating Phase Commissioning Hydrogen Plasma Hydrogen Deuterium Plasma First neutron generation Deuterium – Tritium Plasma First introduction of external tritium 2039 2068 De-activation Decommissioning 2108 Decay Period Dismantling – clearance for recycling - disposal 24

Iter Canada Video 25

Iter Canada Video 25

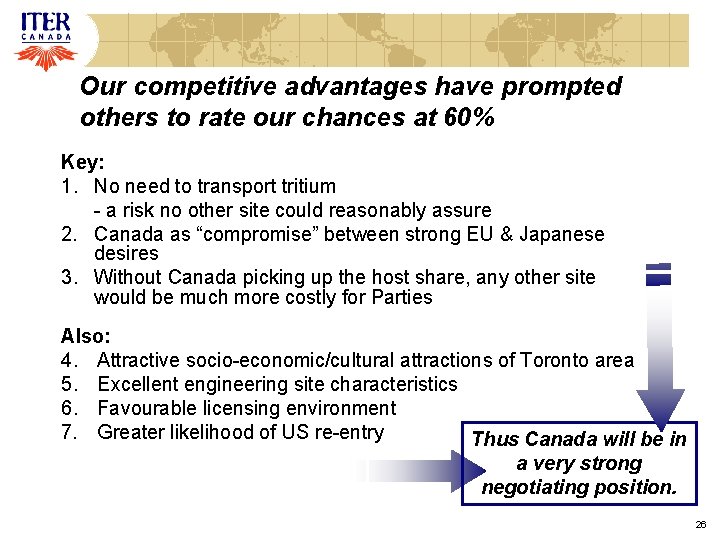

Our competitive advantages have prompted others to rate our chances at 60% Key: 1.

Our competitive advantages have prompted others to rate our chances at 60% Key: 1. No need to transport tritium - a risk no other site could reasonably assure 2. Canada as “compromise” between strong EU & Japanese desires 3. Without Canada picking up the host share, any other site would be much more costly for Parties Also: 4. Attractive socio-economic/cultural attractions of Toronto area 5. Excellent engineering site characteristics 6. Favourable licensing environment 7. Greater likelihood of US re-entry Thus Canada will be in a very strong negotiating position. 26

A World Class Site for ITER www. itercanada. com 27

A World Class Site for ITER www. itercanada. com 27

28

28
