Introduction The People Owner Tomo Cerovsek Slovenia rchitectural

  • Slides: 52
Download presentation
Introduction: The People • Owner: Tomo Cerovsek: Slovenia rchitectural • Contract: A Design: Mario

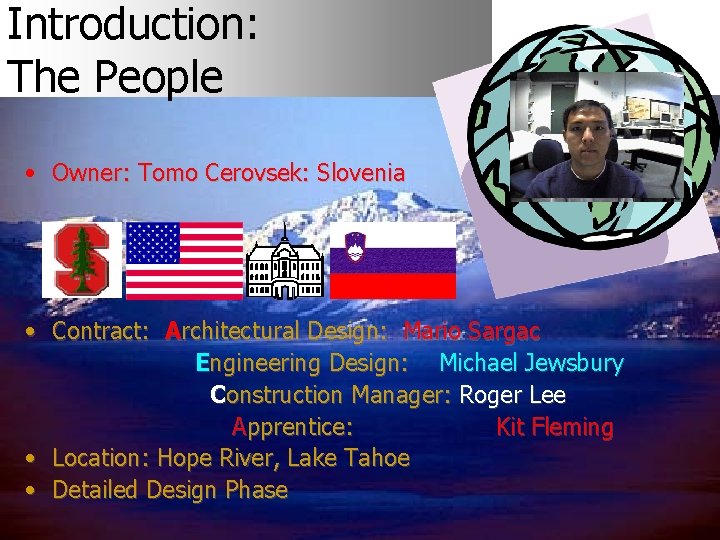

Introduction: The People • Owner: Tomo Cerovsek: Slovenia rchitectural • Contract: A Design: Mario Sargac Engineering Design: Michael Jewsbury Construction Manager: Roger Lee Apprentice: Kit Fleming • Location: Hope River, Lake Tahoe • Detailed Design Phase

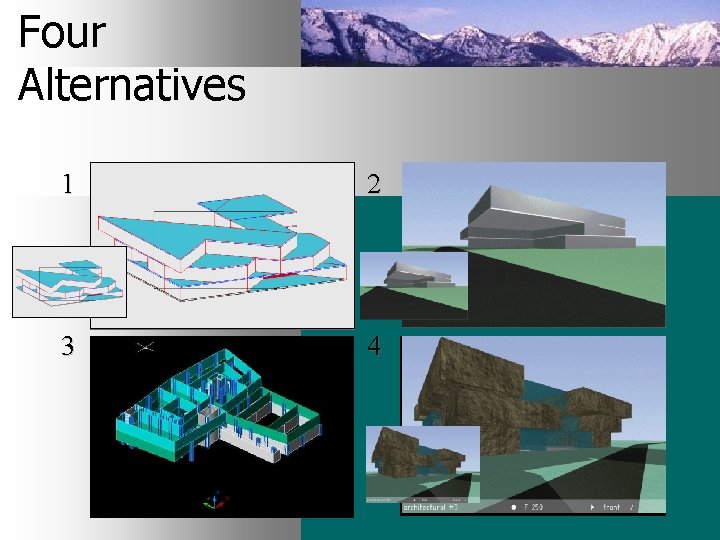

Four Alternatives 1 2 3 4

Four Alternatives 1 2 3 4

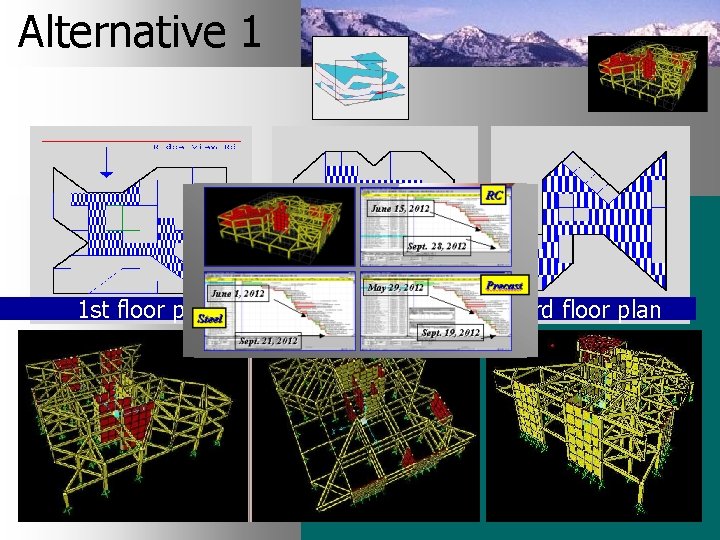

Alternative 1 1 st floor plan 2 nd floor plan 3 rd floor plan

Alternative 1 1 st floor plan 2 nd floor plan 3 rd floor plan

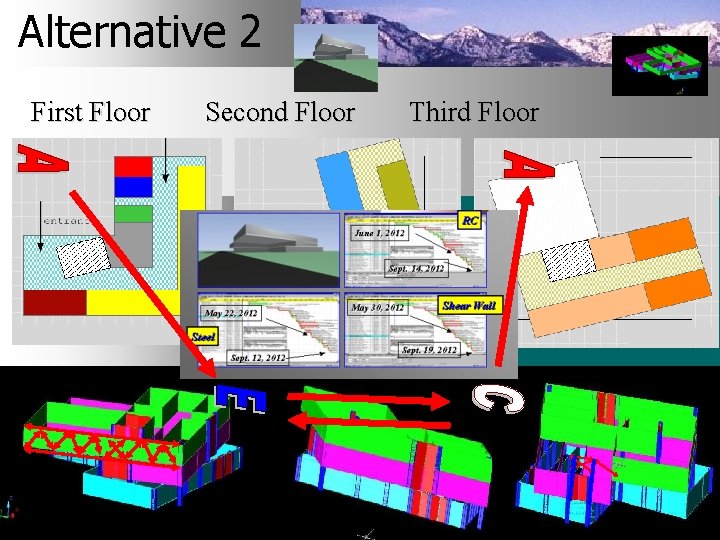

Alternative 2 First Floor Second Floor Third Floor

Alternative 2 First Floor Second Floor Third Floor

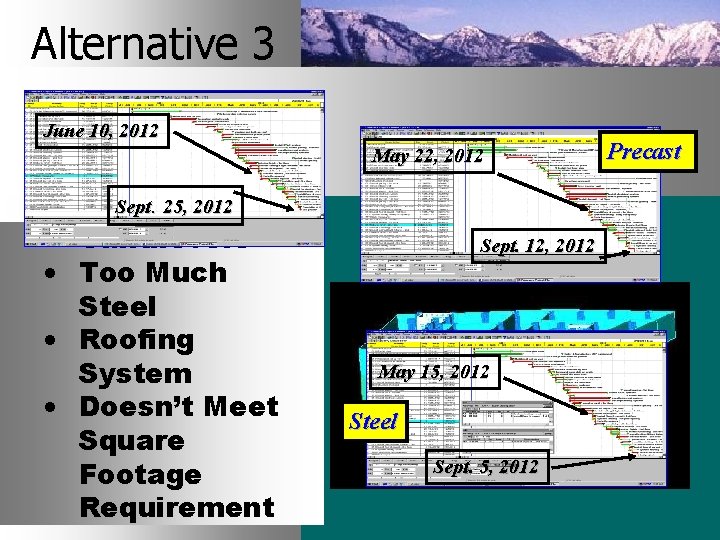

Alternative 3 RC June 10, 2012 May 22, 2012 Sept. 25, 2012 • Cantilevers

Alternative 3 RC June 10, 2012 May 22, 2012 Sept. 25, 2012 • Cantilevers • Too Much Steel • Roofing System • Doesn’t Meet Square Footage Requirement Sept. 12, 2012 May 15, 2012 Steel Sept. 5, 2012 Precast

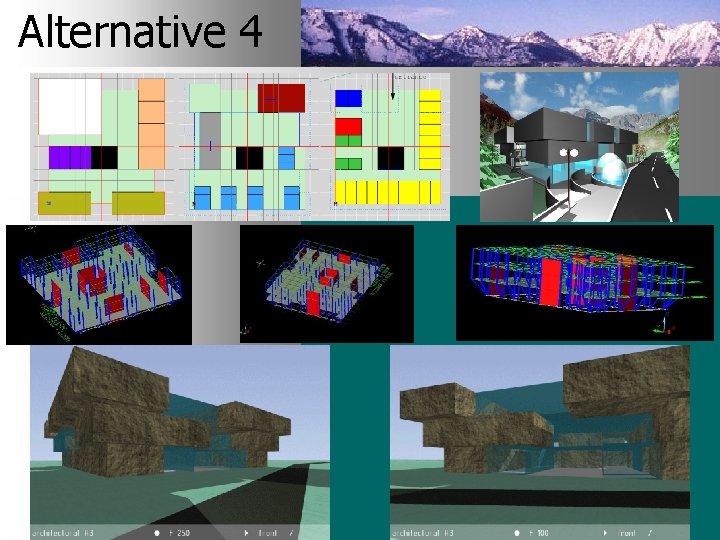

Alternative 4

Alternative 4

Pros/cons • • Cost Constructability Challenge Satisfaction of Owner Requirements • • • Life-Cycle

Pros/cons • • Cost Constructability Challenge Satisfaction of Owner Requirements • • • Life-Cycle Costs Owner’s second choice Need for New Technology

Architect Fakulteta za Gradbenistvo in Geodezijo

Architect Fakulteta za Gradbenistvo in Geodezijo

Final solution

Final solution

Final solution

Final solution

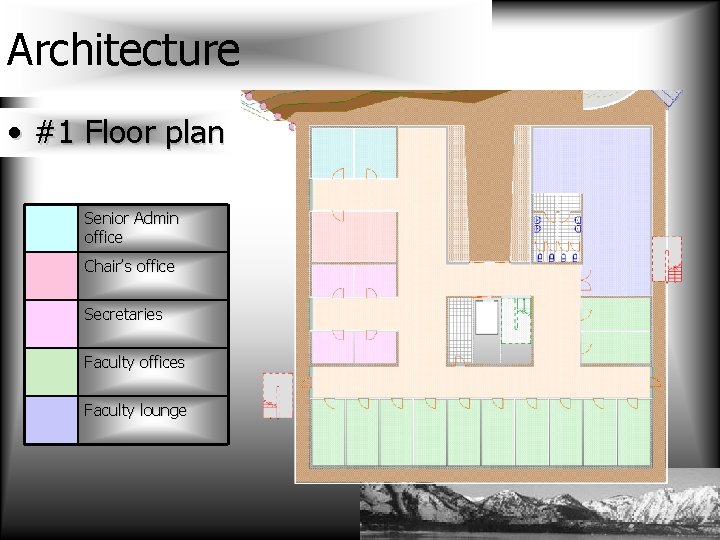

Architecture • #1 Floor plan Senior Admin office Chair’s office Secretaries Faculty offices Faculty

Architecture • #1 Floor plan Senior Admin office Chair’s office Secretaries Faculty offices Faculty lounge

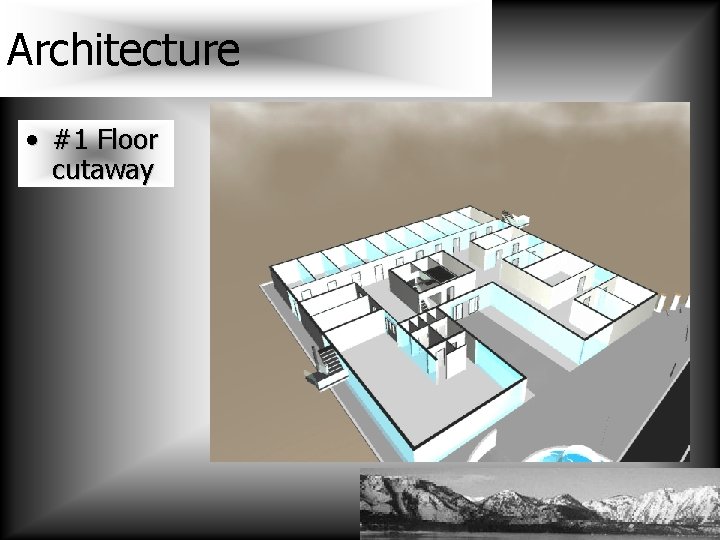

Architecture • #1 Floor cutaway

Architecture • #1 Floor cutaway

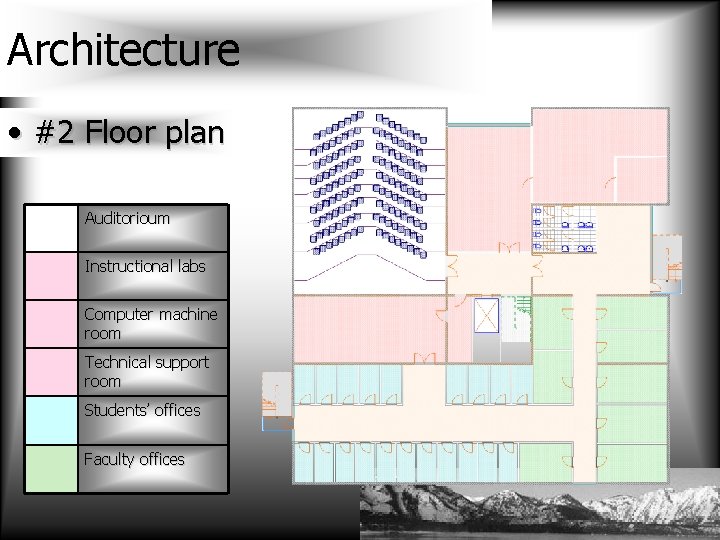

Architecture • #2 Floor plan Auditorioum Instructional labs Computer machine room Technical support room

Architecture • #2 Floor plan Auditorioum Instructional labs Computer machine room Technical support room Students’ offices Faculty offices

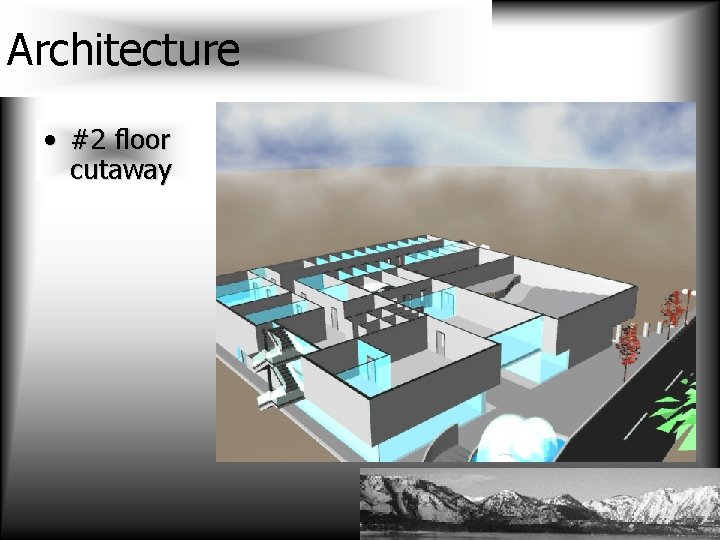

Architecture • #2 floor cutaway

Architecture • #2 floor cutaway

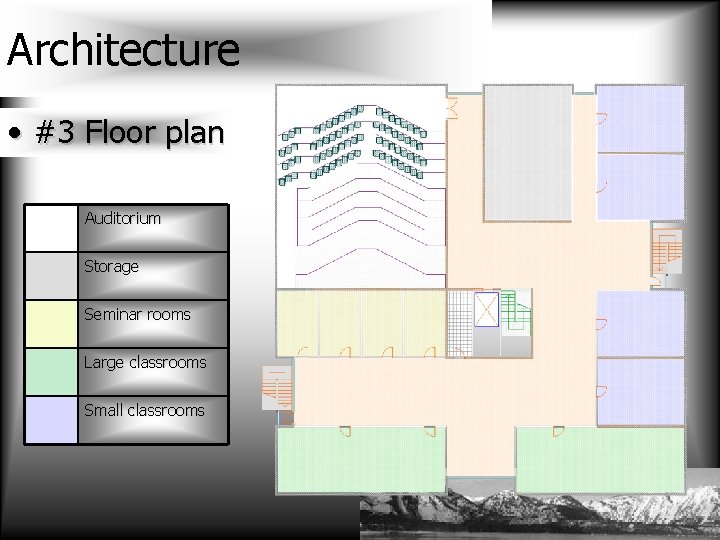

Architecture • #3 Floor plan Auditorium Storage Seminar rooms Large classrooms Small classrooms

Architecture • #3 Floor plan Auditorium Storage Seminar rooms Large classrooms Small classrooms

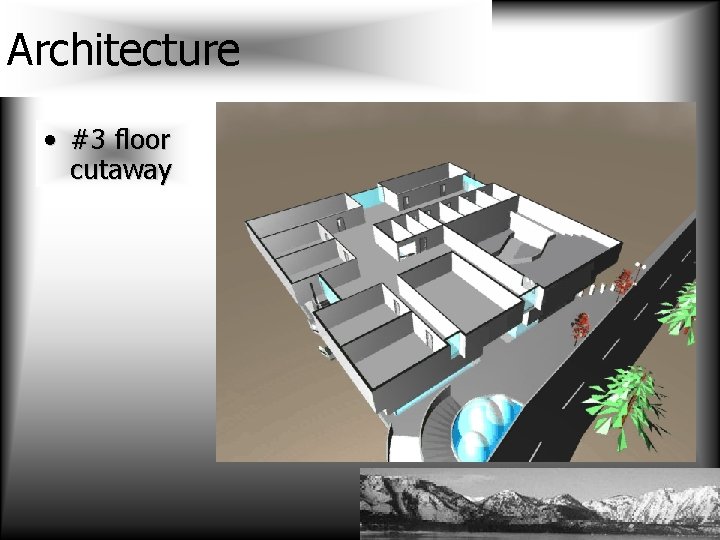

Architecture • #3 floor cutaway

Architecture • #3 floor cutaway

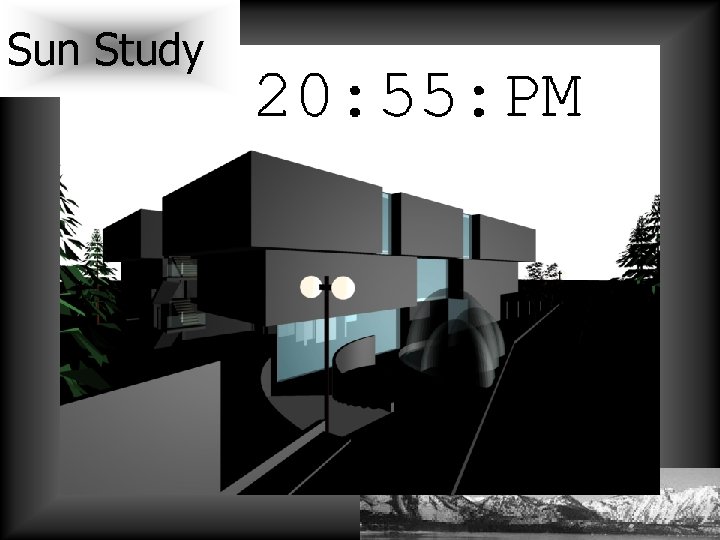

Sun Study

Sun Study

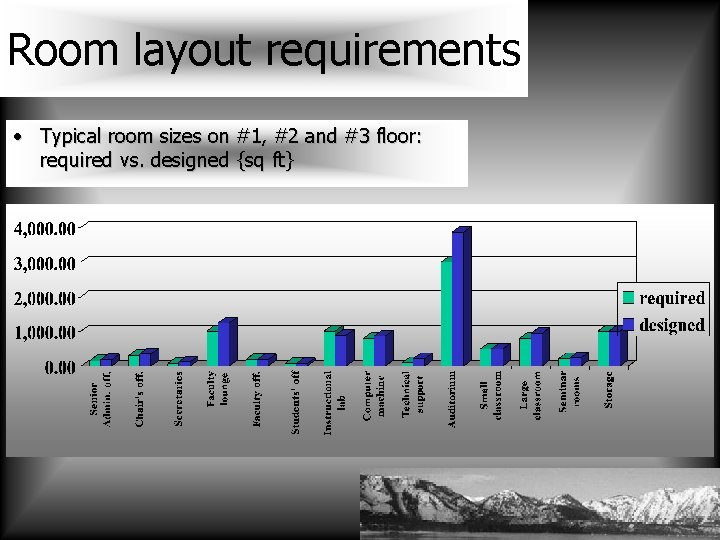

Room layout requirements • Typical room sizes on #1, #2 and #3 floor: required

Room layout requirements • Typical room sizes on #1, #2 and #3 floor: required vs. designed {sq ft}

Engineer

Engineer

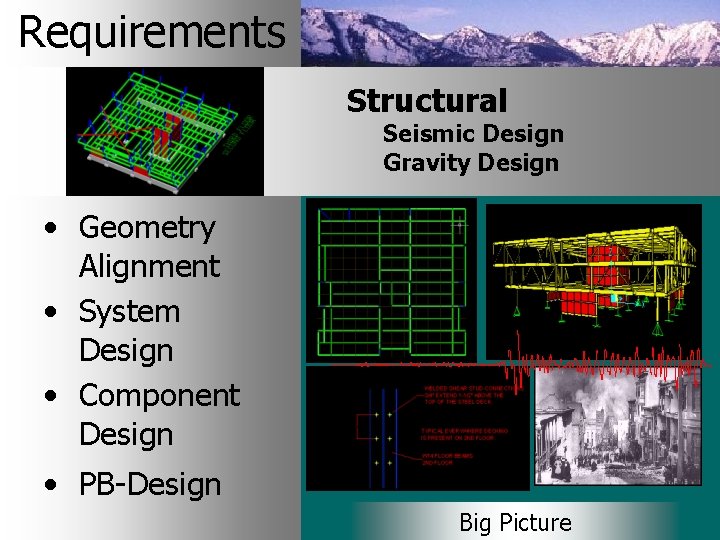

Requirements Structural Seismic Design Gravity Design • Geometry Alignment • System Design • Component

Requirements Structural Seismic Design Gravity Design • Geometry Alignment • System Design • Component Design • PB-Design Big Picture

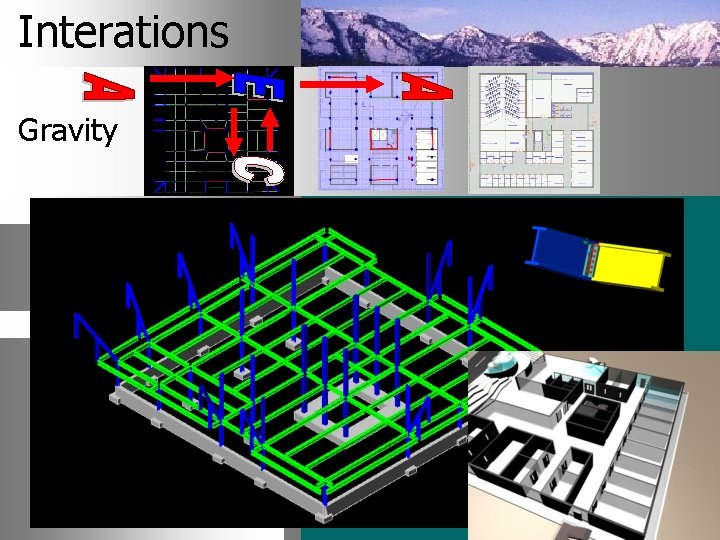

Interations Gravity • • Structure vs. Architecture Integration • • Gravity Design FL =

Interations Gravity • • Structure vs. Architecture Integration • • Gravity Design FL = 0. 244 ksf • • W 18 X 35 C=1” (40) W 18 x 46 C=1” (45) W 14 X 30 C=1/8” (22) C 9 X 15

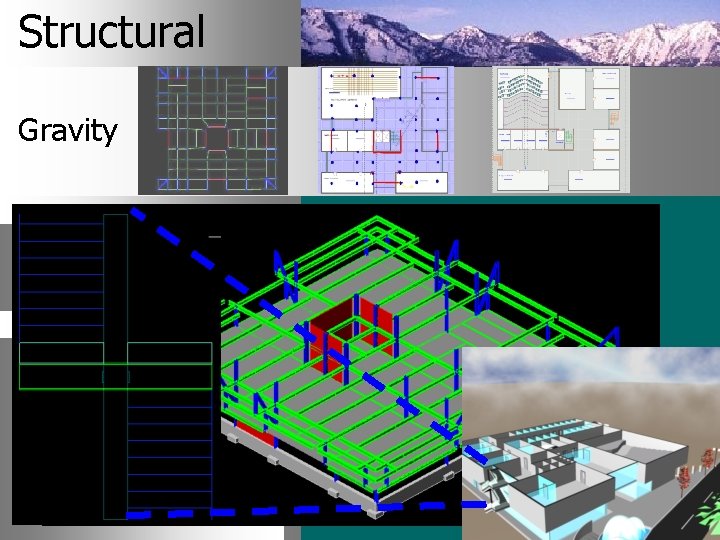

Structural Gravity • • Structure vs. Architecture Integration • • Gravity Design FL =

Structural Gravity • • Structure vs. Architecture Integration • • Gravity Design FL = 0. 244 ksf • • W 18 X 35 C=1” (40) W 18 x 46 C=1” (45) W 14 X 30 C=1/8” (22) C 9 X 15

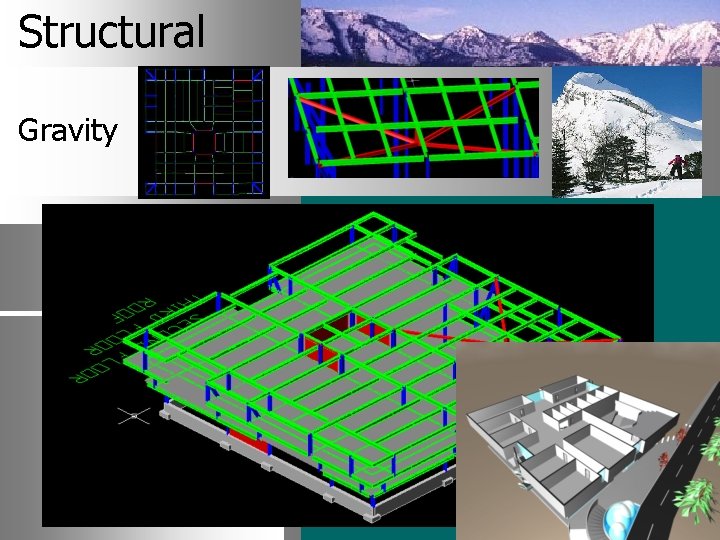

Structural Gravity • • Structure vs. Architecture Integration • • Gravity Design RL =

Structural Gravity • • Structure vs. Architecture Integration • • Gravity Design RL = 0. 588 ksf • • W 21 X 147 C=3/8”(36) W 21 x 101 C=1” (52) W 18 X 40 C=1/8” (45) W 21 X 160 C = 1” (40)

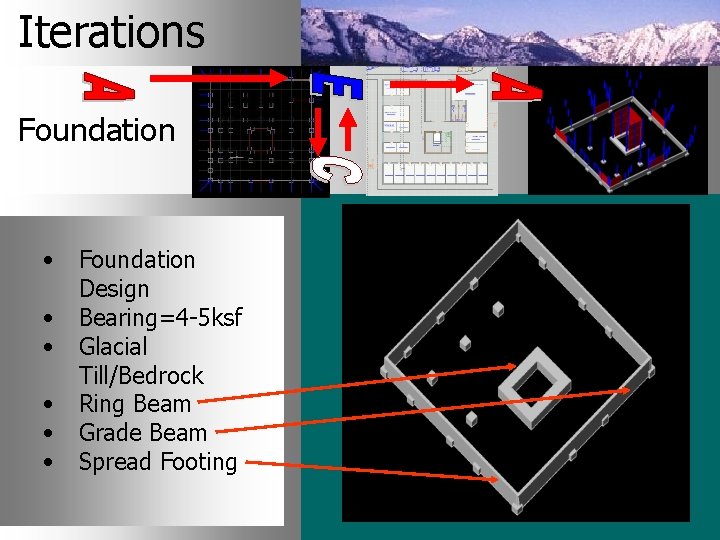

Iterations Foundation • • • Foundation Design Bearing=4 -5 ksf Glacial Till/Bedrock Ring Beam

Iterations Foundation • • • Foundation Design Bearing=4 -5 ksf Glacial Till/Bedrock Ring Beam Grade Beam Spread Footing

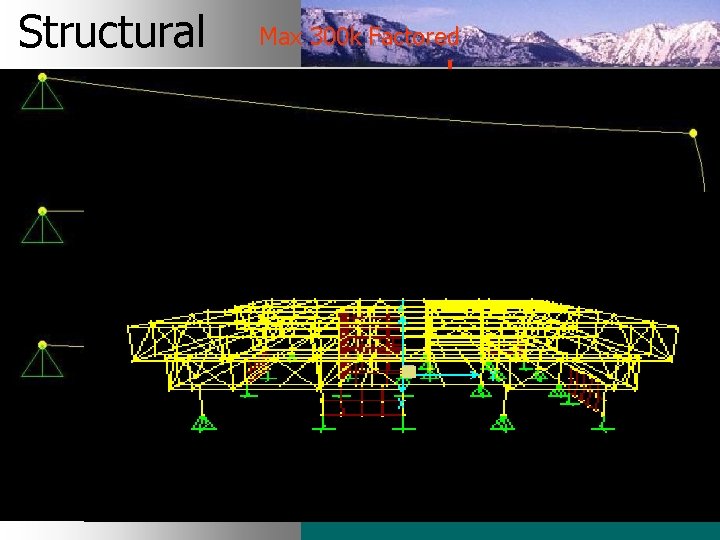

Structural Gravity System Max 300 k Factored

Structural Gravity System Max 300 k Factored

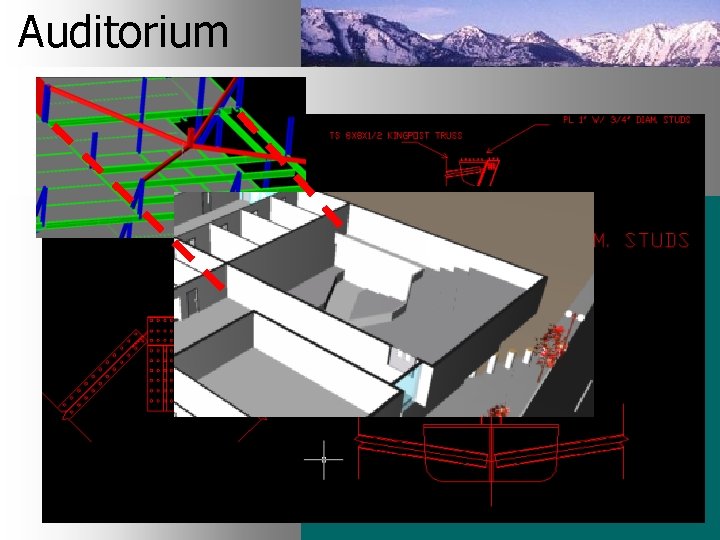

Auditorium

Auditorium

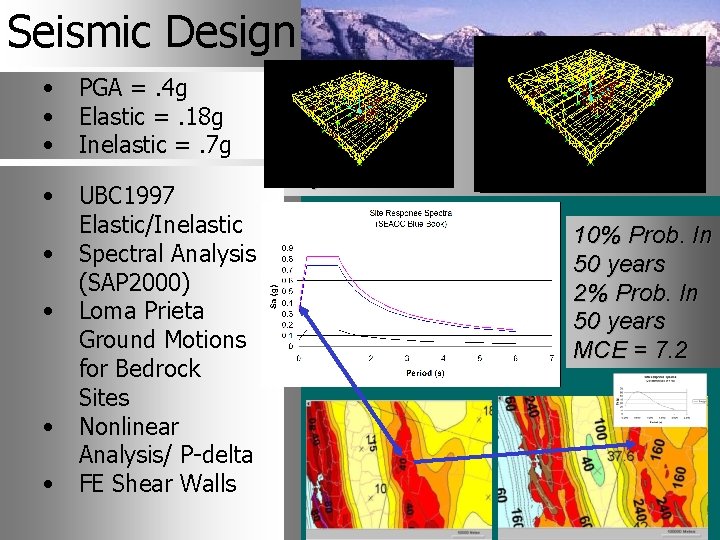

Seismic Design • • • PGA =. 4 g Elastic =. 18 g Inelastic

Seismic Design • • • PGA =. 4 g Elastic =. 18 g Inelastic =. 7 g • UBC 1997 Elastic/Inelastic Spectral Analysis (SAP 2000) Loma Prieta Ground Motions for Bedrock Sites Nonlinear Analysis/ P-delta FE Shear Walls • • T 1 =. 31 sec T 2 =. 29 sec Vx = 925 k Vy = 1001 k 10% Prob. In 50 years 2% Prob. In 50 years MCE = 7. 2

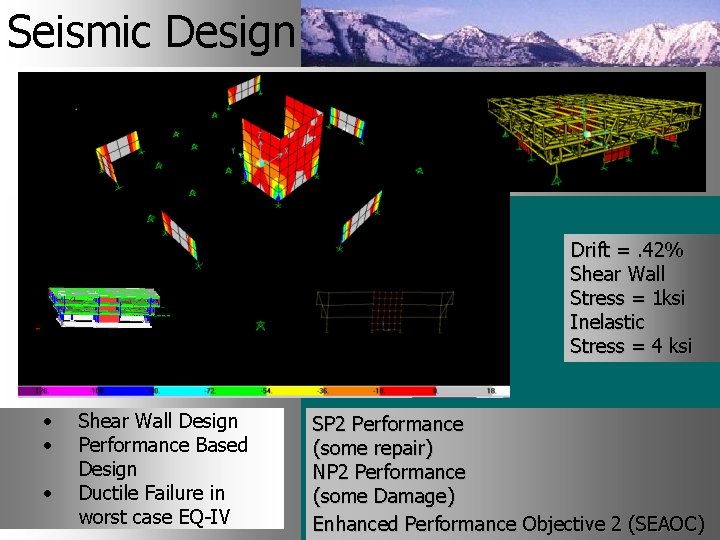

Seismic Design Drift =. 42% Shear Wall Stress = 1 ksi Inelastic Stress =

Seismic Design Drift =. 42% Shear Wall Stress = 1 ksi Inelastic Stress = 4 ksi • • • Shear Wall Design Performance Based Design Ductile Failure in worst case EQ-IV SP 2 Performance (some repair) NP 2 Performance (some Damage) Enhanced Performance Objective 2 (SEAOC)

Shear Wall And Misc. Shear Stud Steel Deck Diaphragm Reinforcement Concrete MEP ROOF

Shear Wall And Misc. Shear Stud Steel Deck Diaphragm Reinforcement Concrete MEP ROOF

Foundation Site Profile Bedrock Settlement Foundation Slab on grade Spread Footing

Foundation Site Profile Bedrock Settlement Foundation Slab on grade Spread Footing

Construction Manager

Construction Manager

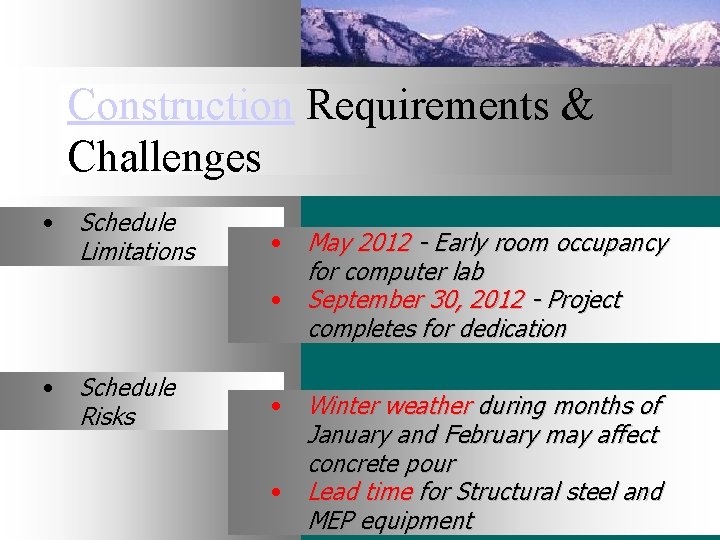

Construction Requirements & Challenges • Schedule Limitations • Schedule Risks • May 2012 -

Construction Requirements & Challenges • Schedule Limitations • Schedule Risks • May 2012 - Early room occupancy for computer lab • September 30, 2012 - Project completes for dedication • Winter weather during months of January and February may affect concrete pour • Lead time for Structural steel and MEP equipment

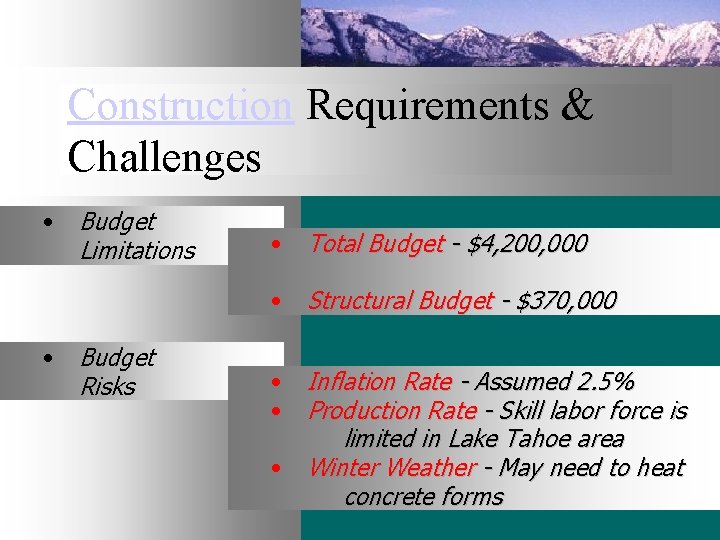

Construction Requirements & Challenges • Budget Limitations • Total Budget - $4, 200, 000

Construction Requirements & Challenges • Budget Limitations • Total Budget - $4, 200, 000 • Structural Budget - $370, 000 • Budget Risks • Inflation Rate - Assumed 2. 5% • Production Rate - Skill labor force is limited in Lake Tahoe area • Winter Weather - May need to heat concrete forms

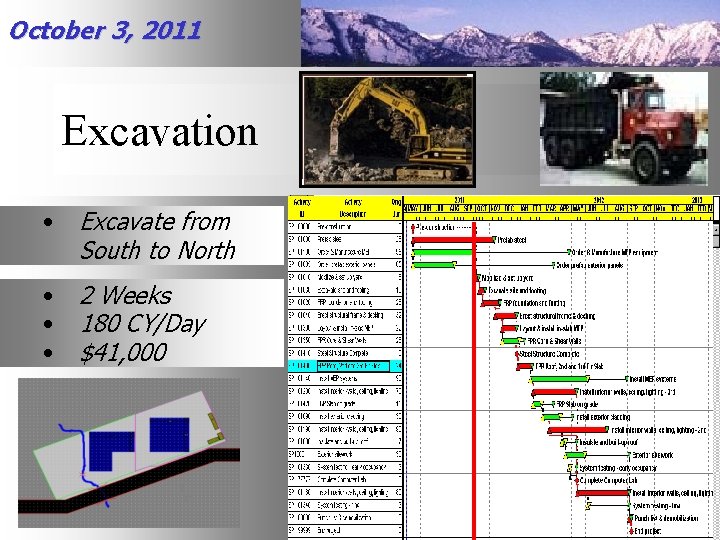

October 3, 2011 Excavation • Excavate from South to North • • • 2

October 3, 2011 Excavation • Excavate from South to North • • • 2 Weeks 180 CY/Day $41, 000

October 10, 2011 Footing and Foundation • Starting from South Side • • 5

October 10, 2011 Footing and Foundation • Starting from South Side • • 5 weeks $24, 600

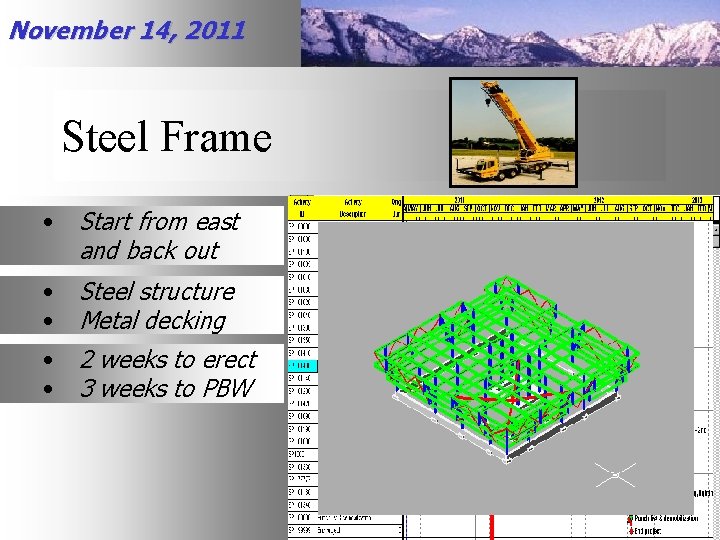

November 14, 2011 Steel Frame • Start from east and back out • •

November 14, 2011 Steel Frame • Start from east and back out • • Steel structure Metal decking • • 2 weeks to erect 3 weeks to PBW

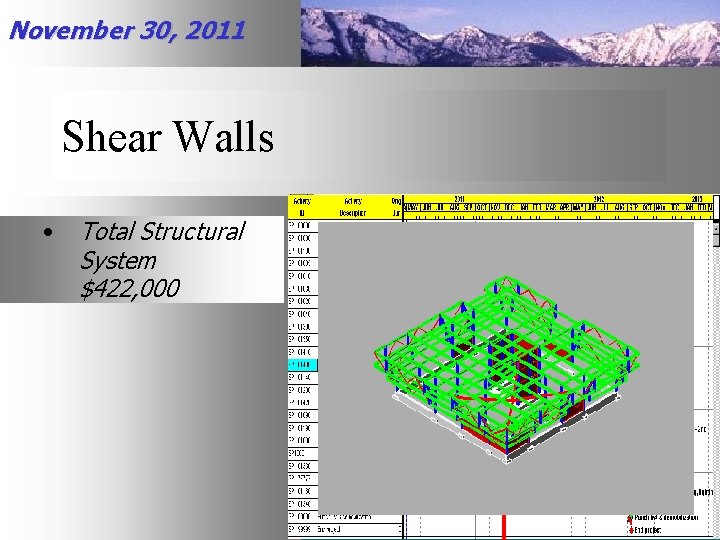

November 30, 2011 Shear Walls • Total Structural System $422, 000

November 30, 2011 Shear Walls • Total Structural System $422, 000

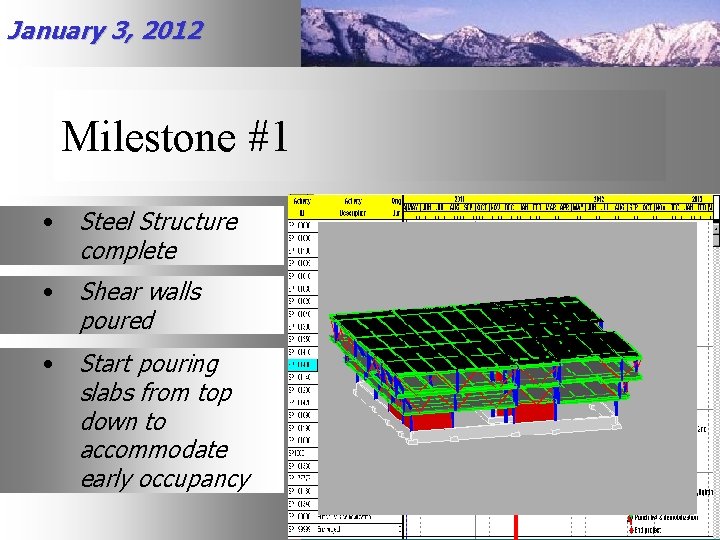

January 3, 2012 Milestone #1 • Steel Structure complete • Shear walls poured •

January 3, 2012 Milestone #1 • Steel Structure complete • Shear walls poured • Start pouring slabs from top down to accommodate early occupancy

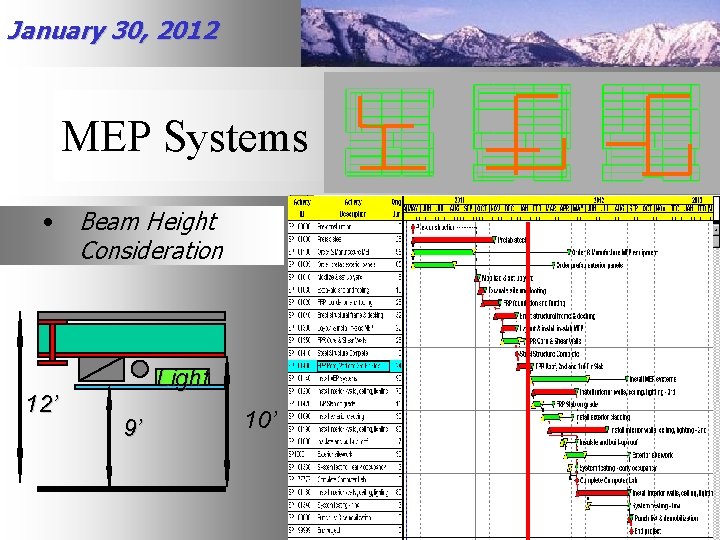

January 30, 2012 MEP Systems • 12’ Beam Height Consideration Light 9’ 10’

January 30, 2012 MEP Systems • 12’ Beam Height Consideration Light 9’ 10’

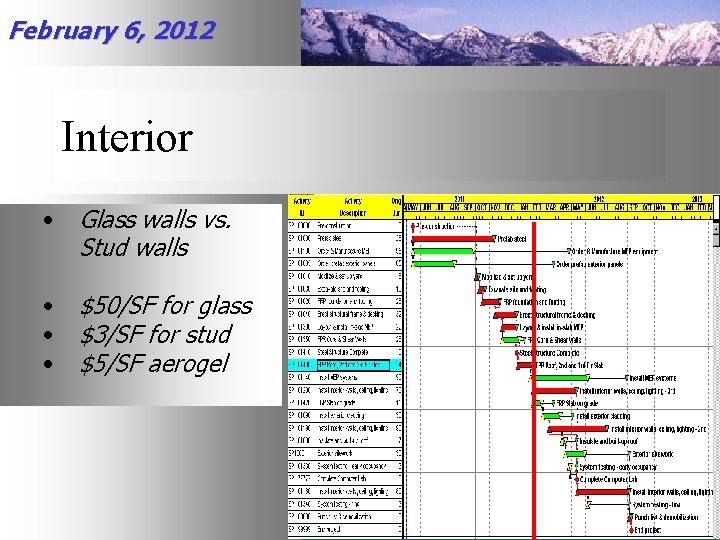

February 6, 2012 Interior • Glass walls vs. Stud walls • • • $50/SF

February 6, 2012 Interior • Glass walls vs. Stud walls • • • $50/SF for glass $3/SF for stud $5/SF aerogel

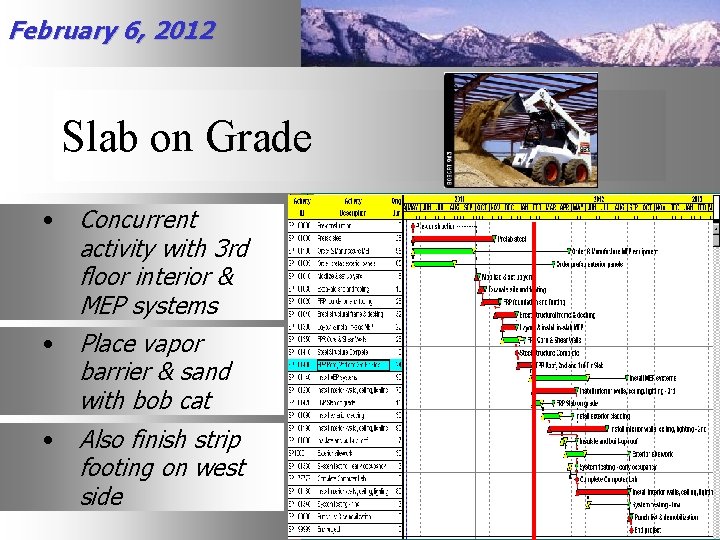

February 6, 2012 Slab on Grade Concurrent activity with 3 rd floor interior &

February 6, 2012 Slab on Grade Concurrent activity with 3 rd floor interior & MEP systems • Place vapor barrier & sand with bob cat • • Also finish strip footing on west side

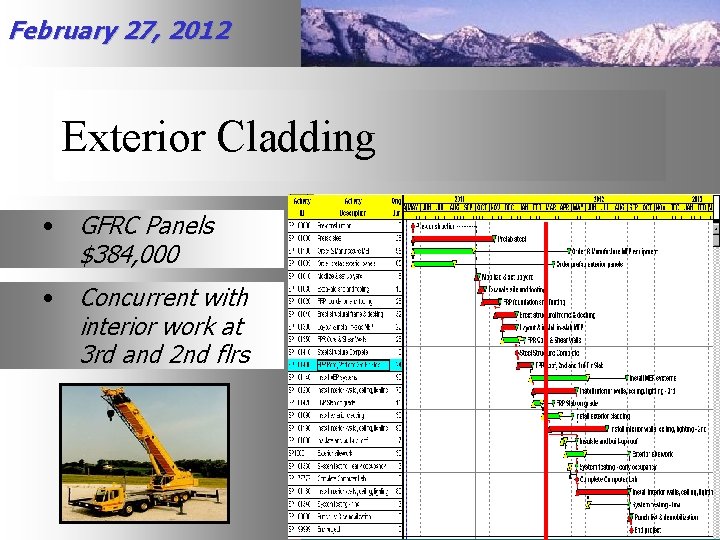

February 27, 2012 Exterior Cladding • GFRC Panels $384, 000 • Concurrent with interior

February 27, 2012 Exterior Cladding • GFRC Panels $384, 000 • Concurrent with interior work at 3 rd and 2 nd flrs

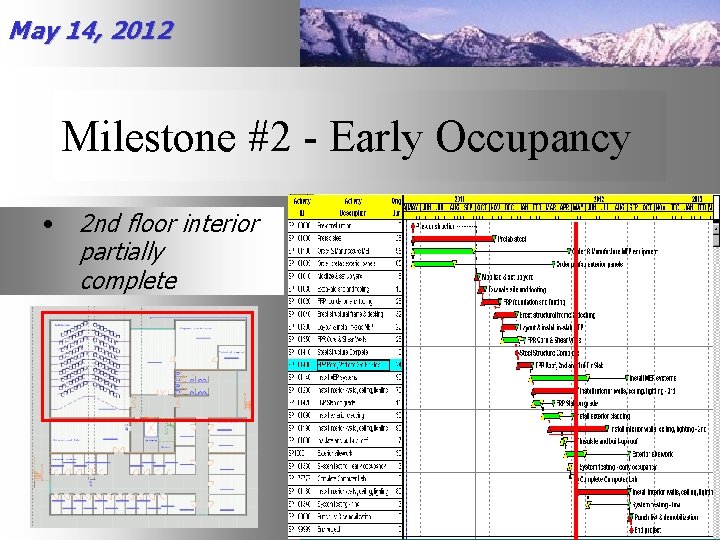

May 14, 2012 Milestone #2 - Early Occupancy • 2 nd floor interior partially

May 14, 2012 Milestone #2 - Early Occupancy • 2 nd floor interior partially complete

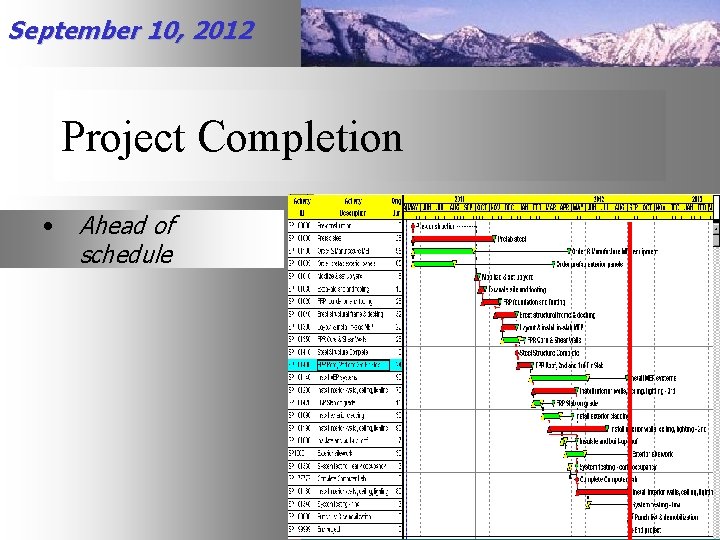

September 10, 2012 Project Completion • Ahead of schedule

September 10, 2012 Project Completion • Ahead of schedule

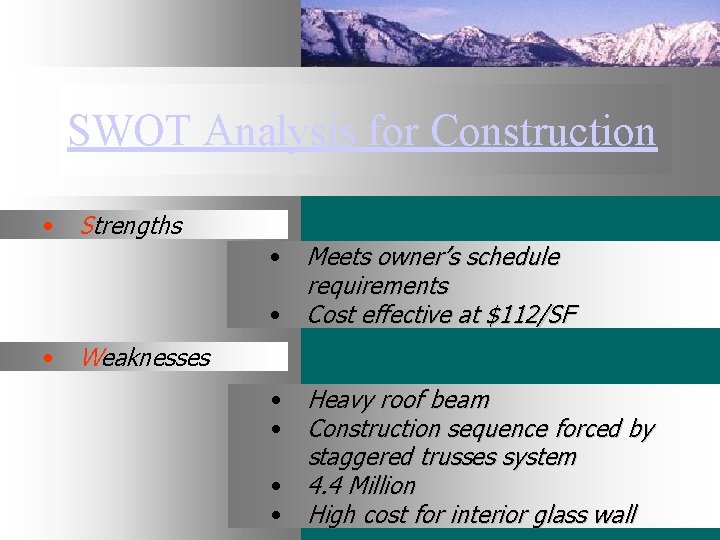

SWOT Analysis for Construction • Strengths • Meets owner’s schedule requirements • Cost effective

SWOT Analysis for Construction • Strengths • Meets owner’s schedule requirements • Cost effective at $112/SF • Weaknesses • Heavy roof beam • Construction sequence forced by staggered trusses system • 4. 4 Million • High cost for interior glass wall

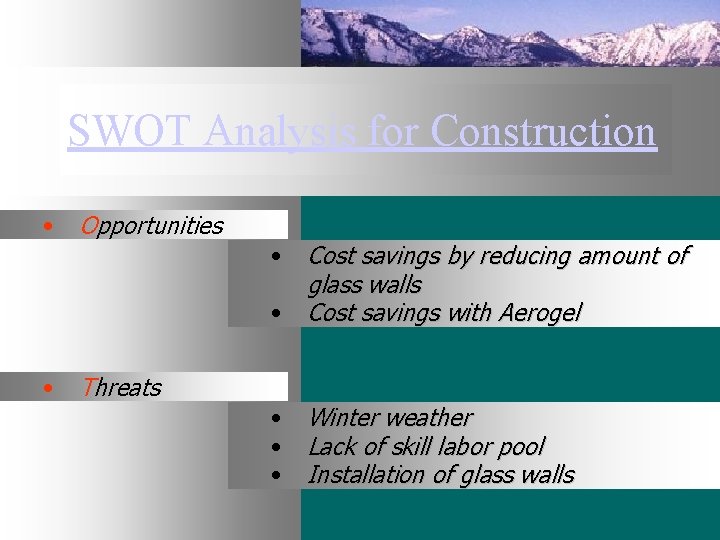

SWOT Analysis for Construction • Opportunities • Threats • Cost savings by reducing amount

SWOT Analysis for Construction • Opportunities • Threats • Cost savings by reducing amount of glass walls • Cost savings with Aerogel • Winter weather • Lack of skill labor pool • Installation of glass walls

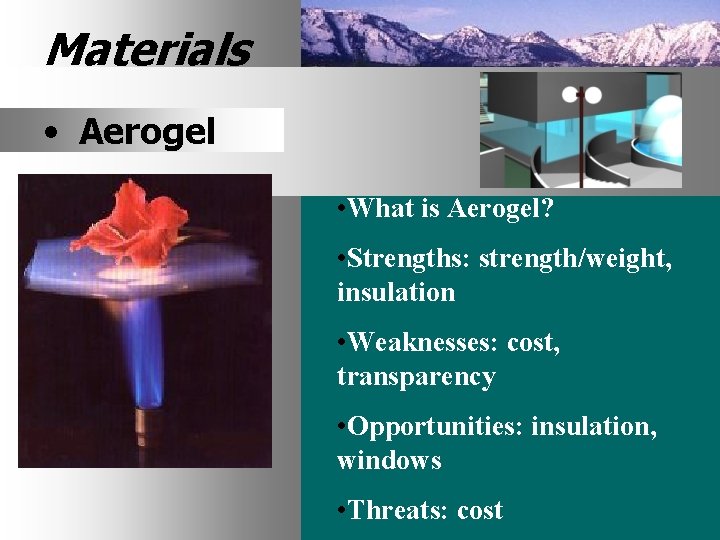

Materials • Aerogel • What is Aerogel? • Strengths: strength/weight, insulation • Weaknesses: cost,

Materials • Aerogel • What is Aerogel? • Strengths: strength/weight, insulation • Weaknesses: cost, transparency • Opportunities: insulation, windows • Threats: cost

Materials • Supercritical Ceramics • What are supercritical ceramics? • Strengths: perfect formation, strength/weight

Materials • Supercritical Ceramics • What are supercritical ceramics? • Strengths: perfect formation, strength/weight • Weaknesses: scale, fabrication • Opportunities: environment • Threats: patents

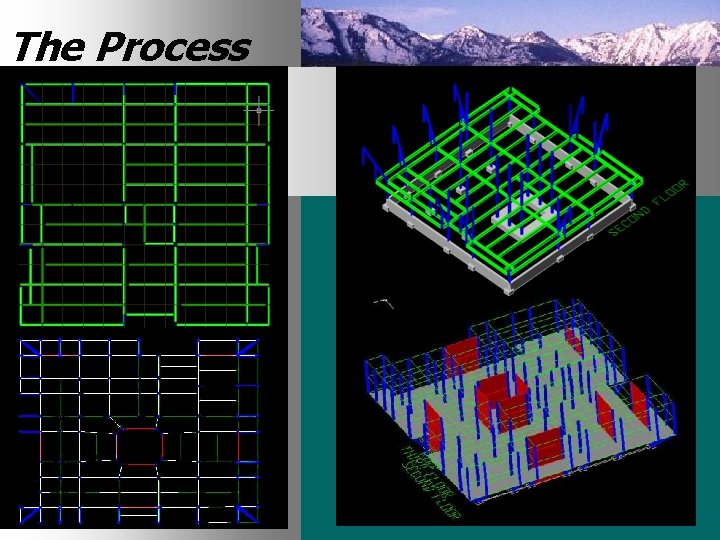

The Process A Iteration Collaboration Communication International C E

The Process A Iteration Collaboration Communication International C E

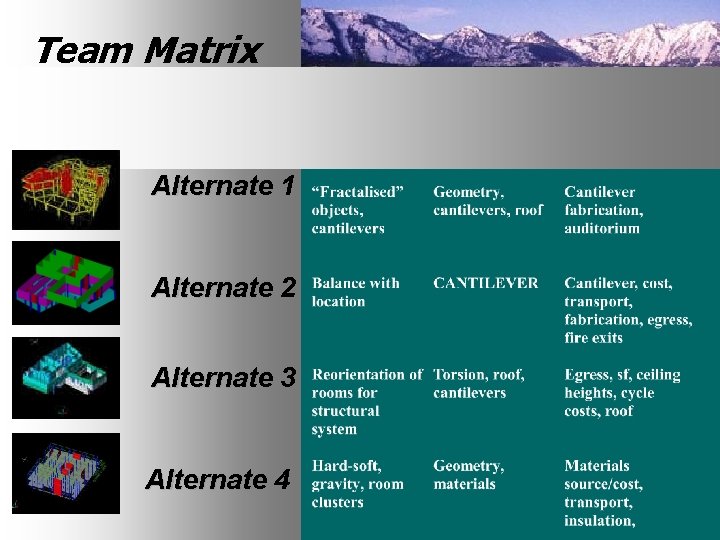

Team Matrix A Alternate 1 Alternate 2 Alternate 3 Alternate 4 E C

Team Matrix A Alternate 1 Alternate 2 Alternate 3 Alternate 4 E C

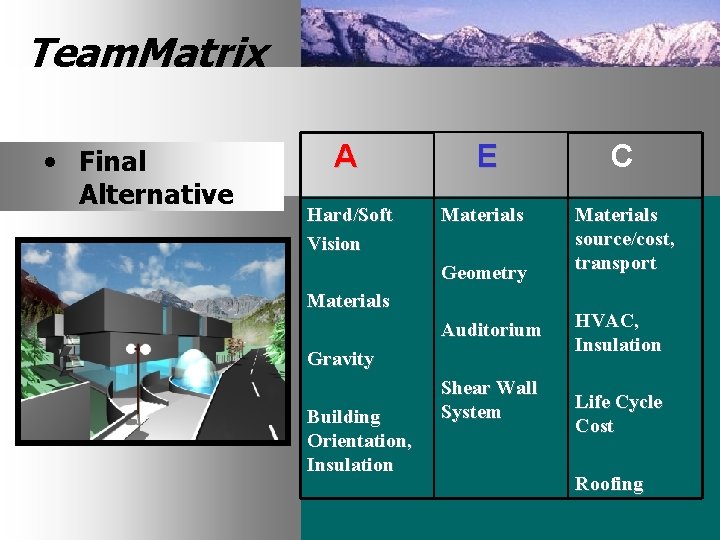

Team. Matrix • Final Alternative A E C Hard/Soft Vision Materials source/cost, transport Geometry

Team. Matrix • Final Alternative A E C Hard/Soft Vision Materials source/cost, transport Geometry Materials Auditorium Gravity Building Orientation, Insulation Shear Wall System HVAC, Insulation Life Cycle Cost Roofing

CONCLUSION Architecture Engineering Construction Special Thanks to Mentors Questions?

CONCLUSION Architecture Engineering Construction Special Thanks to Mentors Questions?
