Improved Project Control Through CPM Scheduling What Owners

  • Slides: 56
Download presentation
Improved Project Control Through CPM Scheduling What Owners, PM’s and CM’s Need to Know

Improved Project Control Through CPM Scheduling What Owners, PM’s and CM’s Need to Know t. HE TIBURON G R O U P, L L C September 25, 2015

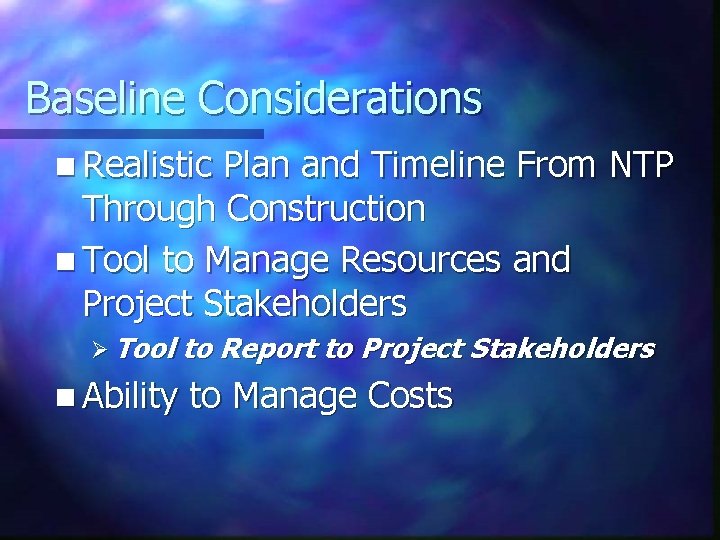

Baseline Considerations n Realistic Plan and Timeline From NTP Through Construction n Tool to

Baseline Considerations n Realistic Plan and Timeline From NTP Through Construction n Tool to Manage Resources and Project Stakeholders Ø Tool n Ability to Report to Project Stakeholders to Manage Costs

Baseline Considerations n Schedule Detail to: Needs to be of Sufficient ØMinimize Secondary Effects

Baseline Considerations n Schedule Detail to: Needs to be of Sufficient ØMinimize Secondary Effects of Construction on Operations ØDo Preconstruction Schedule to Accomplish This ØDocument As Built Conditions ØDemonstrate Need for Time Extensions and Work Around Options ØTool to Resolve Disputes

Baseline Considerations n Analyze Time Impacts n Develop Work Around Options n Furnishings, Fixtures

Baseline Considerations n Analyze Time Impacts n Develop Work Around Options n Furnishings, Fixtures And Equipment n Coordinate With Third Party Contracts n Start Up and Commissioning n Move In

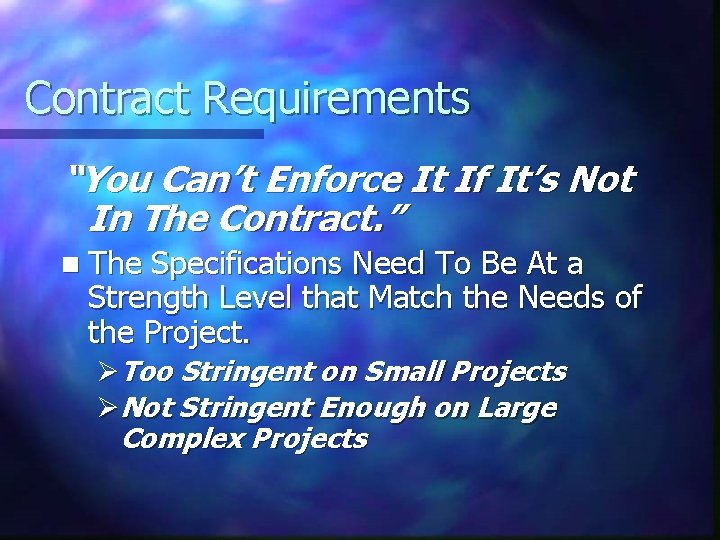

Contract Requirements “You Can’t Enforce It If It’s Not In The Contract. ” n

Contract Requirements “You Can’t Enforce It If It’s Not In The Contract. ” n The Specifications Need To Be At a Strength Level that Match the Needs of the Project. ØToo Stringent on Small Projects ØNot Stringent Enough on Large Complex Projects

Contract Requirements Scheduling Requirements Stronger for Larger Projects n Require Latest Primavera, P 6,

Contract Requirements Scheduling Requirements Stronger for Larger Projects n Require Latest Primavera, P 6, P 3 or Sure. Trak n Require Cost and Manpower Loading n Require Monthly Narrative & Reports n Require Time Impact Analysis for Time Extensions n Tie Updates to Progress Payments n

Baseline Review n Do Thorough and Detailed Review of Baseline n Analyze Baseline for

Baseline Review n Do Thorough and Detailed Review of Baseline n Analyze Baseline for Abuses and Flaws n Assure Contractor Has Adequate Scheduling Resources n Assure Contractor Has Included Adequate Detail

Baseline Review n Do Not Allow Sequestering of Float ØThrough Logic and Constraints n

Baseline Review n Do Not Allow Sequestering of Float ØThrough Logic and Constraints n Check Near Criticality ØNot More Than 20% of Activities with 10 Working Days of Float n Check Preferential Logic n Check Calendar Usage

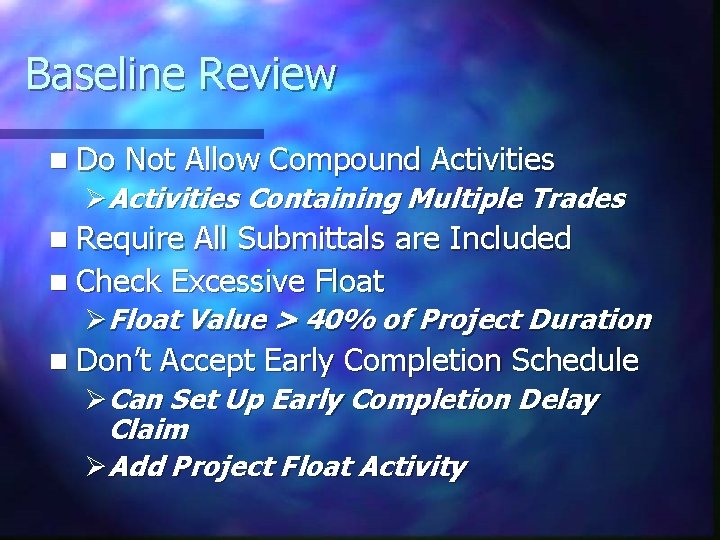

Baseline Review n Do Not Allow Compound Activities ØActivities Containing Multiple Trades n Require

Baseline Review n Do Not Allow Compound Activities ØActivities Containing Multiple Trades n Require All Submittals are Included n Check Excessive Float ØFloat Value > 40% of Project Duration n Don’t Accept Early Completion Schedule ØCan Set Up Early Completion Delay Claim ØAdd Project Float Activity

Some Analysis Tools n Claims Digger n (Comes with P 6) n Schedule Analyzer

Some Analysis Tools n Claims Digger n (Comes with P 6) n Schedule Analyzer Pro n Sure Change n Excel n Proprietary Software ØAbove Commercial Packages Do Not Do It All

Relationship Types n Minimize Logic Use Of Non-Conventional ØAim For Majority of Logic To

Relationship Types n Minimize Logic Use Of Non-Conventional ØAim For Majority of Logic To Be Finish To Start. o Finish To Start (FS) = An Successor Activity Cannot Start Until Its Predecessor Activities Finishes

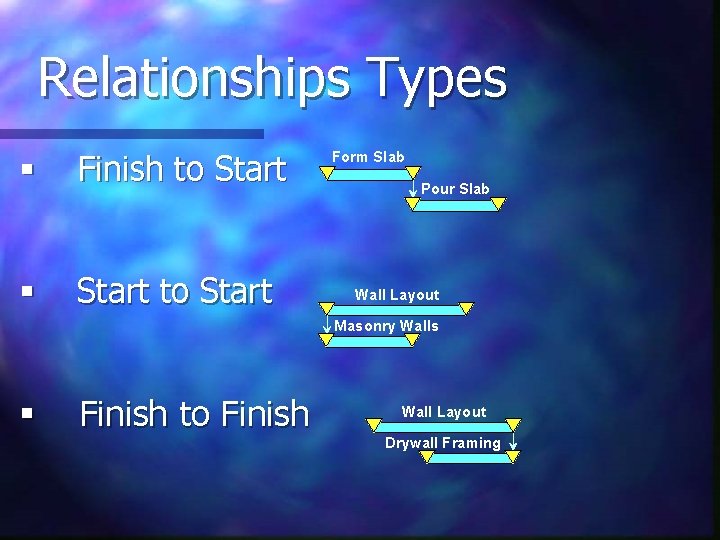

Relationships Types § Finish to Start § Start to Start Form Slab Pour Slab

Relationships Types § Finish to Start § Start to Start Form Slab Pour Slab Wall Layout Masonry Walls § Finish to Finish Wall Layout Drywall Framing

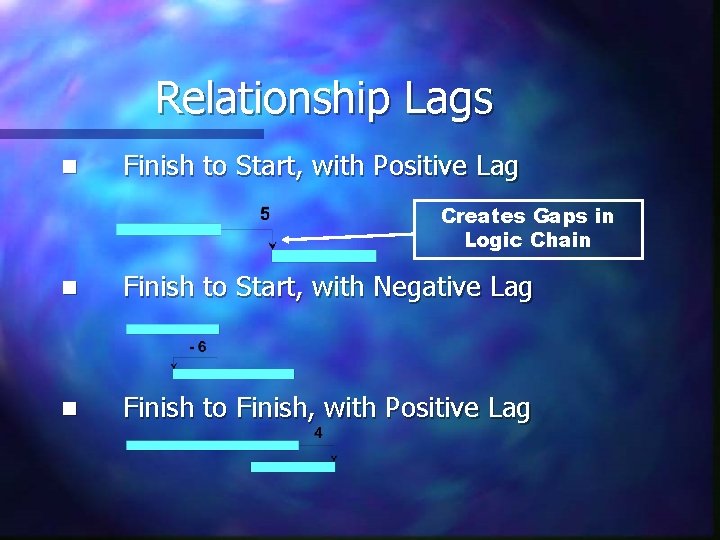

Relationship Lags n Finish to Start, with Positive Lag Creates Gaps in Logic Chain

Relationship Lags n Finish to Start, with Positive Lag Creates Gaps in Logic Chain n Finish to Start, with Negative Lag n Finish to Finish, with Positive Lag

Float vs. Lag n A Logic Tie Lag is Not Float ØLags Can be

Float vs. Lag n A Logic Tie Lag is Not Float ØLags Can be Used to Sequester Float n Who Owns the Float? ØNormally Project Owns the Float ØYou Can Allow for Owner to Retain Float for Their Time Savings, but This Must be In the Contract.

Unconventional and Unbalanced, or Uncoordinated Logic

Unconventional and Unbalanced, or Uncoordinated Logic

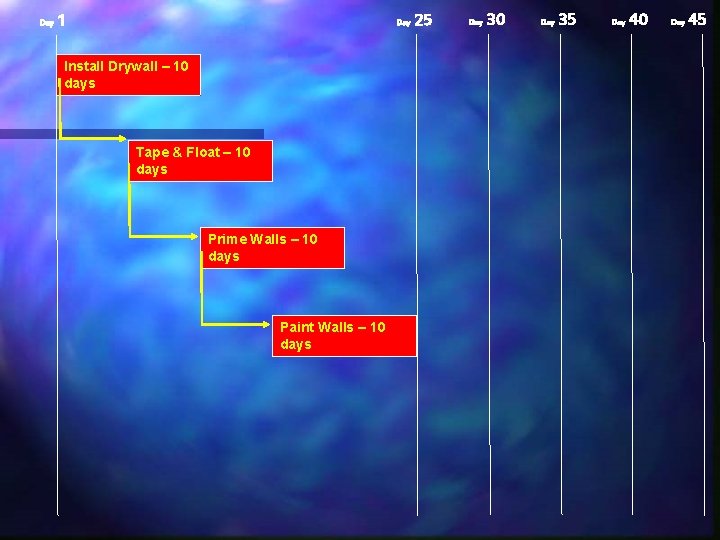

Day 1 Day Install Drywall – 10 days Tape & Float – 10 days

Day 1 Day Install Drywall – 10 days Tape & Float – 10 days Prime Walls – 10 days Paint Walls – 10 days 25 Day 30 Day 35 Day 40 Day 45

Day 1 Day 25 Day 30 Day 35 Day 40 Install Drywall – 30

Day 1 Day 25 Day 30 Day 35 Day 40 Install Drywall – 30 days Tape & Float – 10 days Prime Walls – 10 days Paint Walls – 10 days Day 45

Reverse Critical Path n With Unconventional Logic, Even If The Logic Is Properly Coordinated

Reverse Critical Path n With Unconventional Logic, Even If The Logic Is Properly Coordinated Its Use Can Have Drastic Effects When Original Durations Are Revised

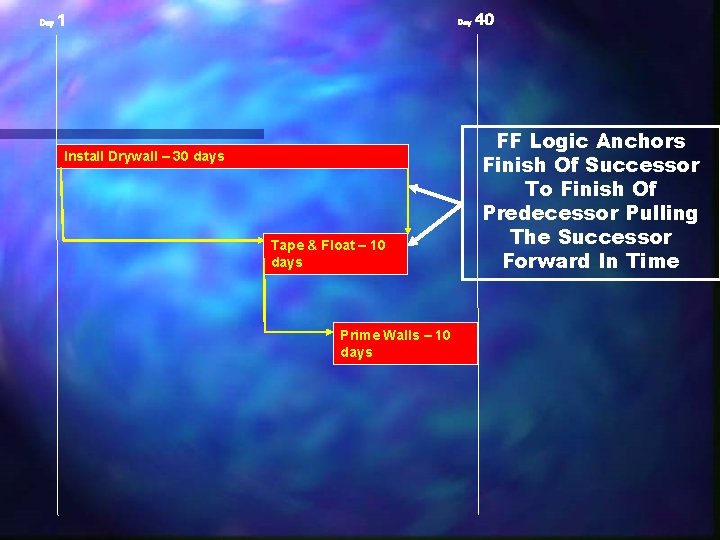

Day 1 Day Install Drywall – 30 days Tape & Float – 10 days

Day 1 Day Install Drywall – 30 days Tape & Float – 10 days Prime Walls – 10 days 40 FF Logic Anchors Finish Of Successor To Finish Of Predecessor Pulling The Successor Forward In Time

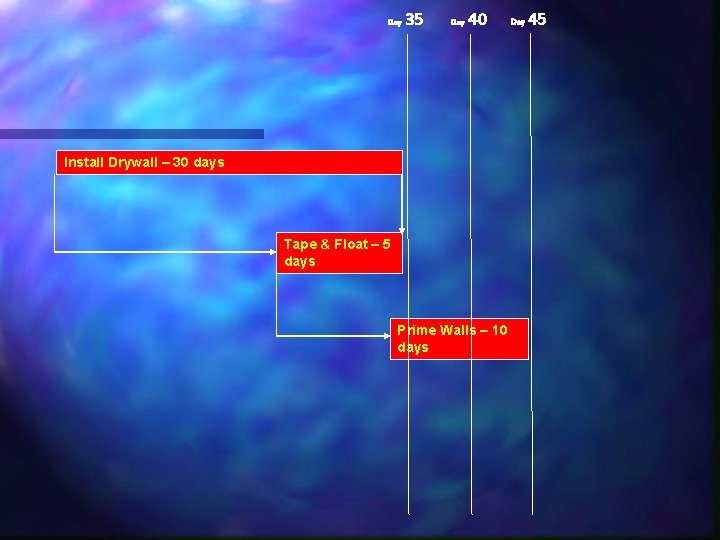

Day 35 Day 40 Install Drywall – 30 days Tape & Float – 5

Day 35 Day 40 Install Drywall – 30 days Tape & Float – 5 days Prime Walls – 10 days Day 45

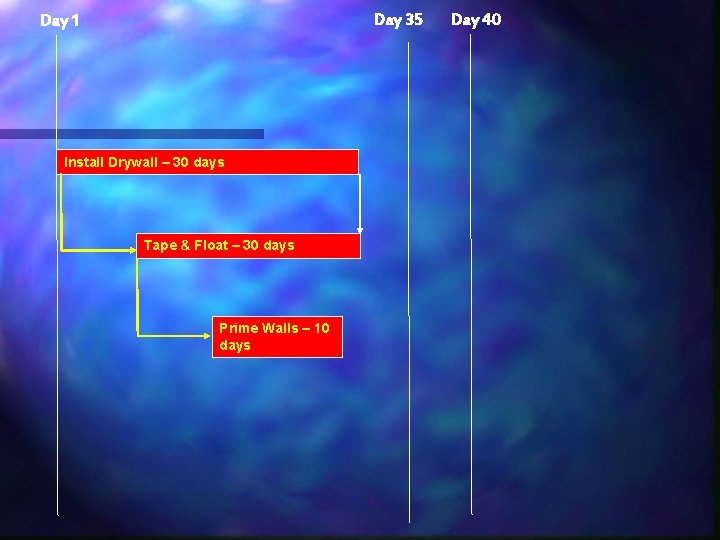

Day 35 Day 1 Install Drywall – 30 days Tape & Float – 30

Day 35 Day 1 Install Drywall – 30 days Tape & Float – 30 days Prime Walls – 10 days Day 40

Date and Float Constraints

Date and Float Constraints

Opinion On Constraints “In General The Baseline Schedule Should Only Contain Two (2) Constraints;

Opinion On Constraints “In General The Baseline Schedule Should Only Contain Two (2) Constraints; The Notice To Proceed And The Project Completion Date. ” Use of Constraints Other Than These Requires Careful Consideration

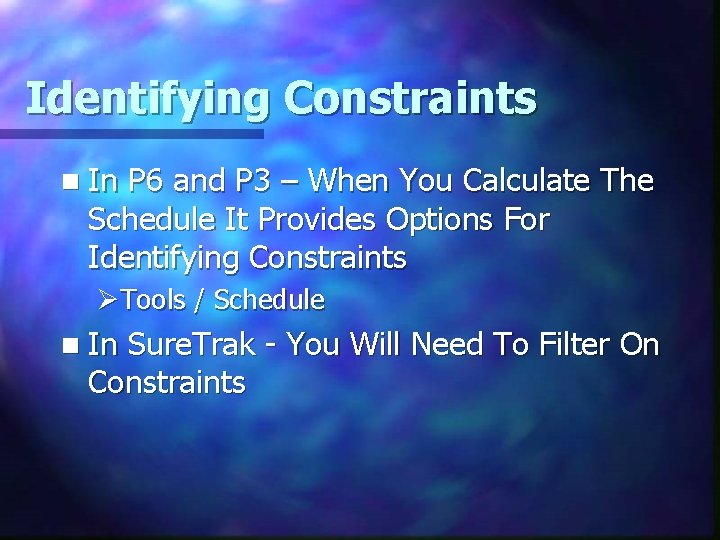

Identifying Constraints n In P 6 and P 3 – When You Calculate The

Identifying Constraints n In P 6 and P 3 – When You Calculate The Schedule It Provides Options For Identifying Constraints ØTools / Schedule n In Sure. Trak - You Will Need To Filter On Constraints

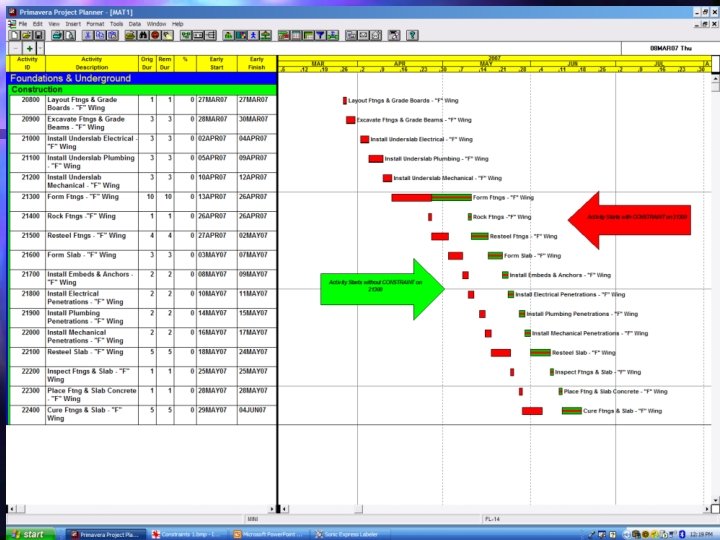

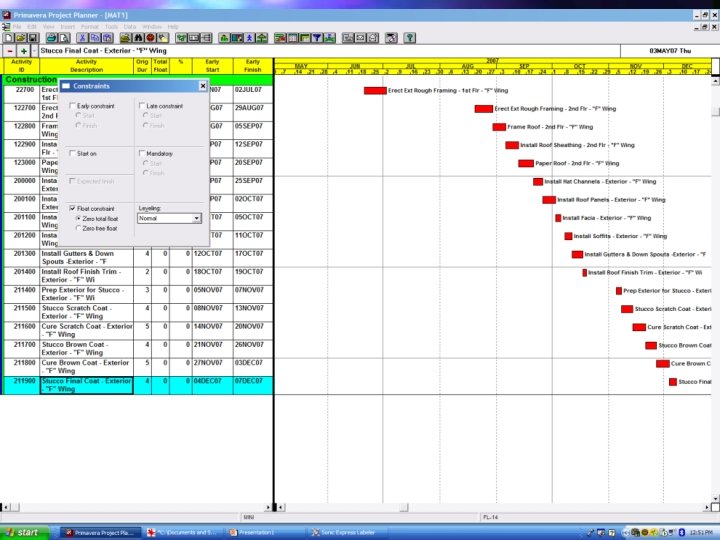

Sample Constraint Window (P 3 and Sure. Trak, In P 6 Appears Under Status

Sample Constraint Window (P 3 and Sure. Trak, In P 6 Appears Under Status Tab)

Date Constraints

Date Constraints

Mandatory Start and Finish Constraints n Mandatory Start and Finish Constraints Override CPM Calculation

Mandatory Start and Finish Constraints n Mandatory Start and Finish Constraints Override CPM Calculation They Can Truncate the Longest Critical Path n They Can Render a False Total Float Calculation n

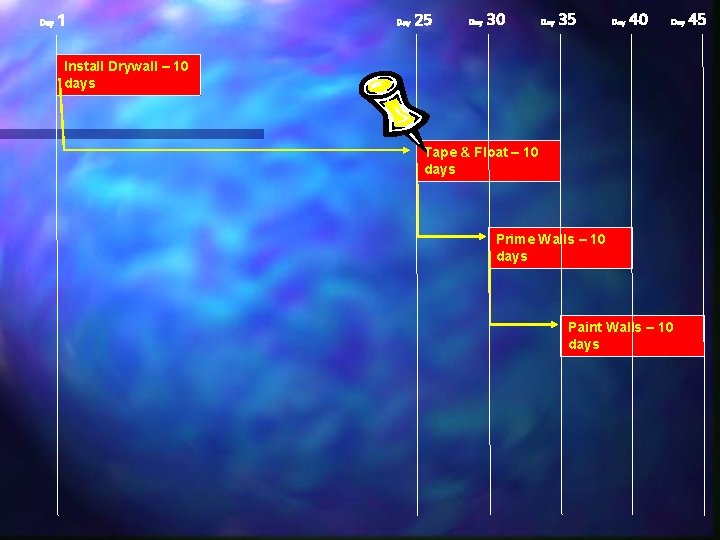

Day 1 Day Install Drywall – 10 days Tape & Float – 10 days

Day 1 Day Install Drywall – 10 days Tape & Float – 10 days Prime Walls – 10 days Paint Walls – 10 days 25 Day 30 Day 35 Day 40 Day 45

Day 1 Day 25 Day 30 Day 35 Day 40 Day Install Drywall –

Day 1 Day 25 Day 30 Day 35 Day 40 Day Install Drywall – 10 days Tape & Float – 10 days Prime Walls – 10 days Paint Walls – 10 days 45

Zero Float Constraints n Float Constraints Force Criticality Without Reference To Start and Finish

Zero Float Constraints n Float Constraints Force Criticality Without Reference To Start and Finish Dates. n P 6 Does Not Provide For Float Constraints

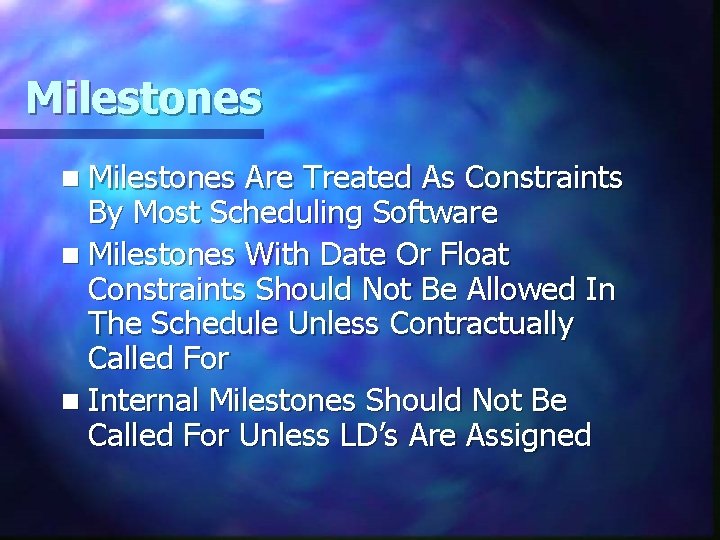

Milestones n Milestones Are Treated As Constraints By Most Scheduling Software n Milestones With

Milestones n Milestones Are Treated As Constraints By Most Scheduling Software n Milestones With Date Or Float Constraints Should Not Be Allowed In The Schedule Unless Contractually Called For n Internal Milestones Should Not Be Called For Unless LD’s Are Assigned

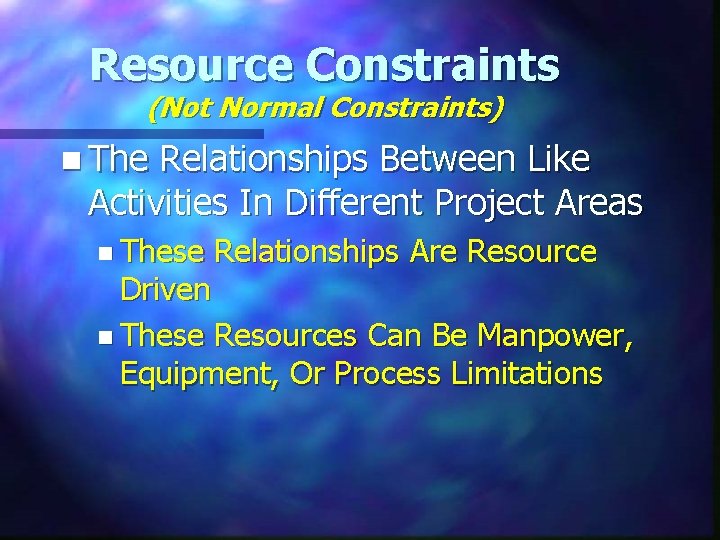

Resource Constraints (Not Normal Constraints) n The Relationships Between Like Activities In Different Project

Resource Constraints (Not Normal Constraints) n The Relationships Between Like Activities In Different Project Areas n These Relationships Are Resource Driven n These Resources Can Be Manpower, Equipment, Or Process Limitations

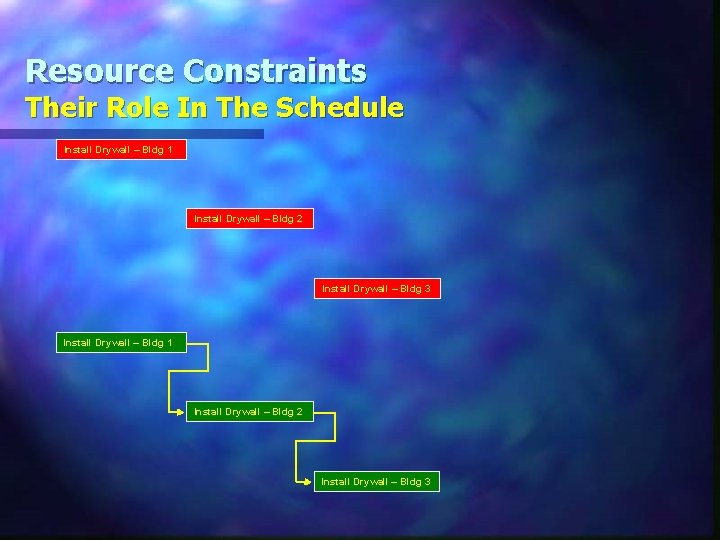

Resource Constraints Their Role In The Schedule Install Drywall – Bldg 1 Install Drywall

Resource Constraints Their Role In The Schedule Install Drywall – Bldg 1 Install Drywall – Bldg 2 Install Drywall – Bldg 3

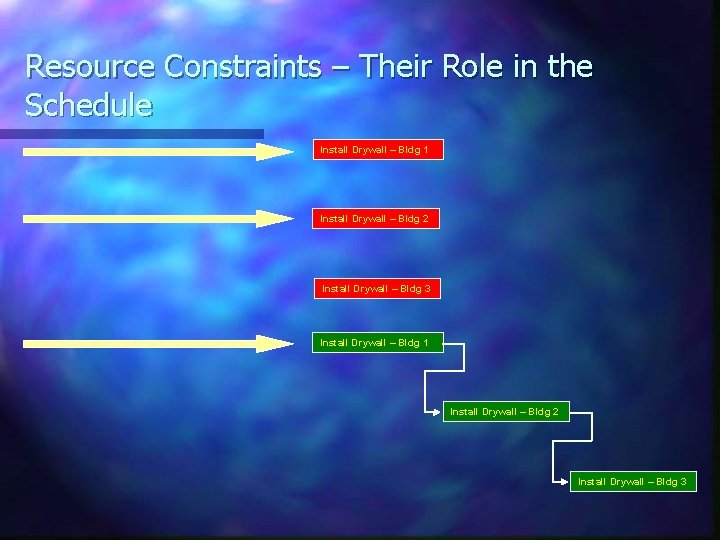

Resource Constraints – Their Role in the Schedule Install Drywall – Bldg 1 Install

Resource Constraints – Their Role in the Schedule Install Drywall – Bldg 1 Install Drywall – Bldg 2 Install Drywall – Bldg 3

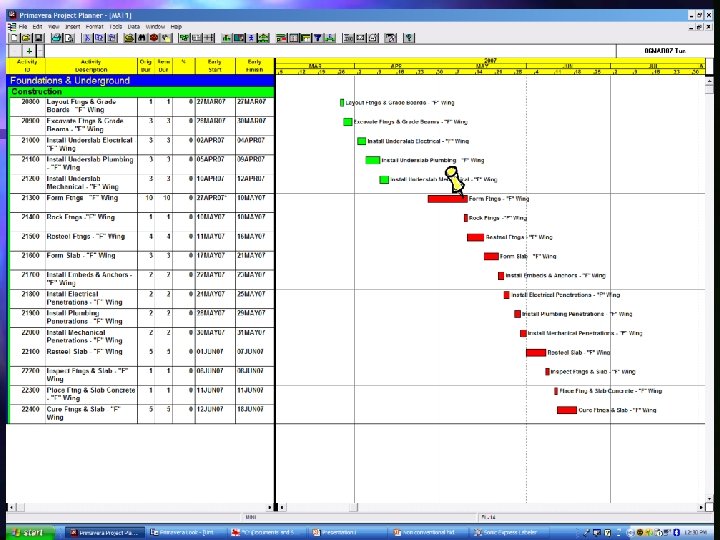

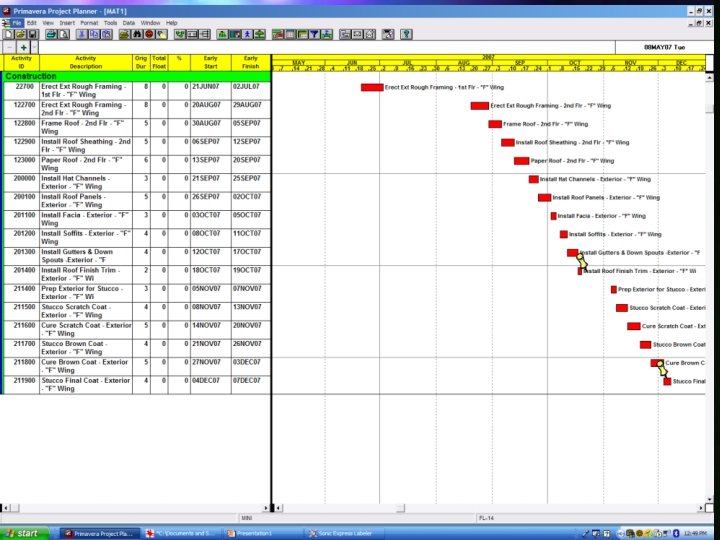

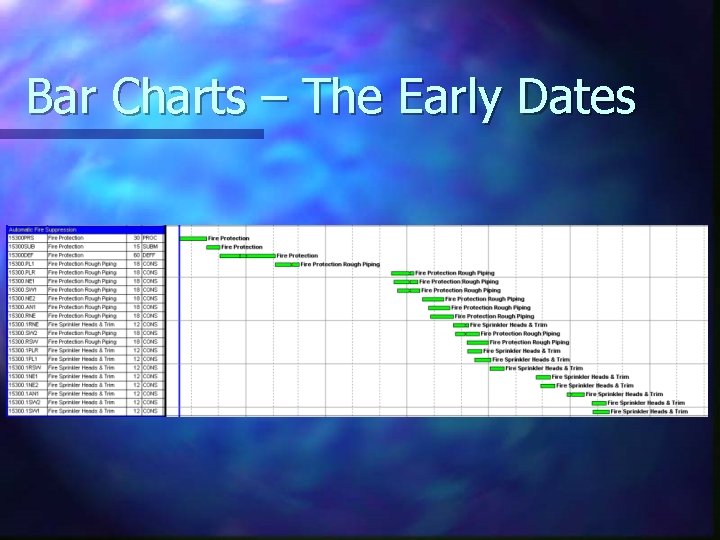

Bar Charts – The Early Dates

Bar Charts – The Early Dates

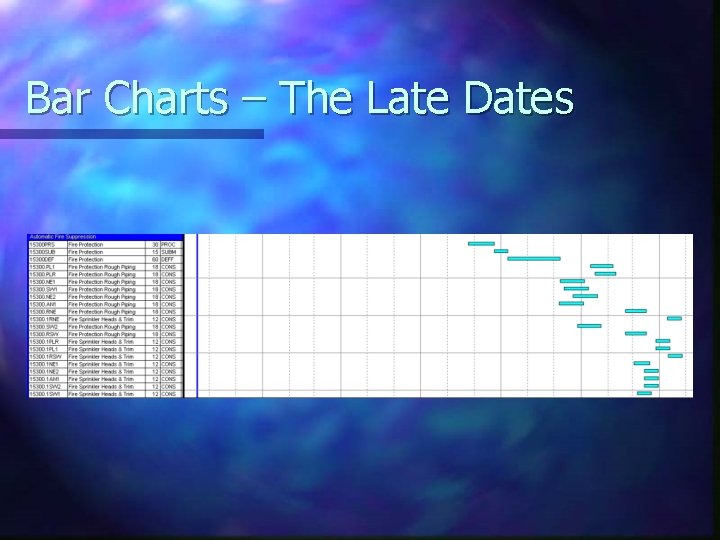

Bar Charts – The Late Dates

Bar Charts – The Late Dates

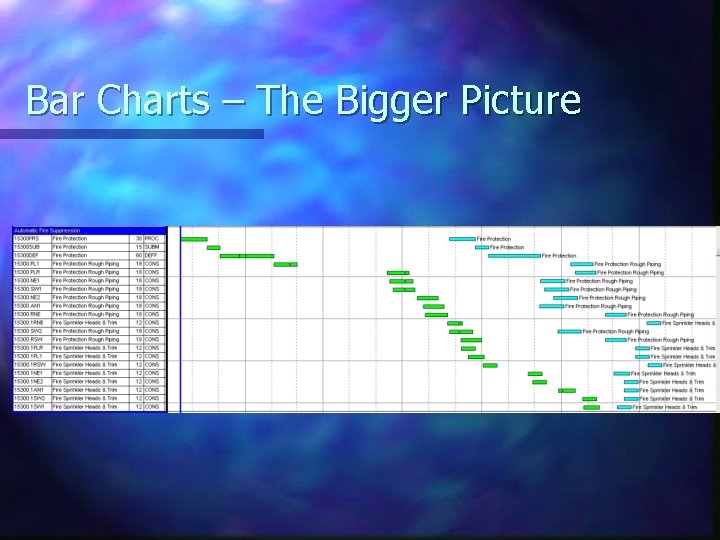

Bar Charts – The Bigger Picture

Bar Charts – The Bigger Picture

Update Reviews n Assure Updates Reflect Actual Progress and Match Payment Applications n Review

Update Reviews n Assure Updates Reflect Actual Progress and Match Payment Applications n Review Updates Promptly and Analyze for Abuses n Don’t Allow Mass Unilateral Changes to Schedule Updates n If Schedule Significantly Changes Require Statused Only Copy Plus Revised Copy

Retained Logic n Retained Logic Schedules an Activity With Out of Sequence Progress According

Retained Logic n Retained Logic Schedules an Activity With Out of Sequence Progress According to the Network Logic. It Allows an Activity to Begin Out of Sequence, but the Remaining Duration for the Activity Cannot be Completed Until It’s Logical Predecessors Complete.

Progress Override n Progress Override Ignores Network Logic and Treats Out of Sequence Activities

Progress Override n Progress Override Ignores Network Logic and Treats Out of Sequence Activities as Though They Have No Predecessors and Can Progress Without Delay. ØThis Can Hide Delays To The Project. ØDoes Not Reflect Contractor’s Current Work Plan.

Calculating the Critical Path Act A – 1 day Act F – 2 days

Calculating the Critical Path Act A – 1 day Act F – 2 days Act B – 2 day Act G – 2 days Act D – 2 day Act H – 3 days Act J – 2 days Act K – 1 day Act C – 2 day Act A – 1 day Act E – 2 day Act H – 3 day Act F – 2 day Act A – 1 day Act B – 2 days Act F – 2 days Act C – 2 days Act G – 2 days Act D – 2 days Act H – 3 days Act I – 2 days Act E – 2 days Act J – 2 days Act K – 1 day Total - 10 days Total - 11 days Total - 10 days Act K – 1 day Act J – 2 day Act G – 2 day Act I – 2 day Total - 11 days

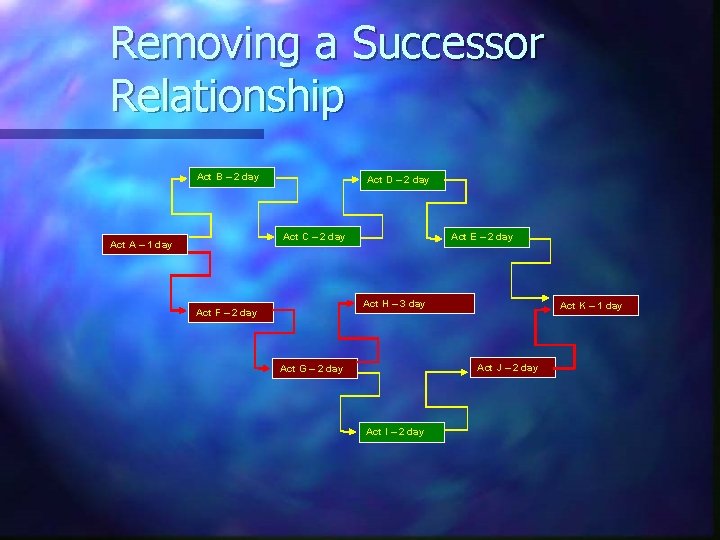

Removing a Successor Relationship Act B – 2 day Act D – 2 day

Removing a Successor Relationship Act B – 2 day Act D – 2 day Act C – 2 day Act A – 1 day Act E – 2 day Act H – 3 day Act F – 2 day Act K – 1 day Act J – 2 day Act G – 2 day Act I – 2 day

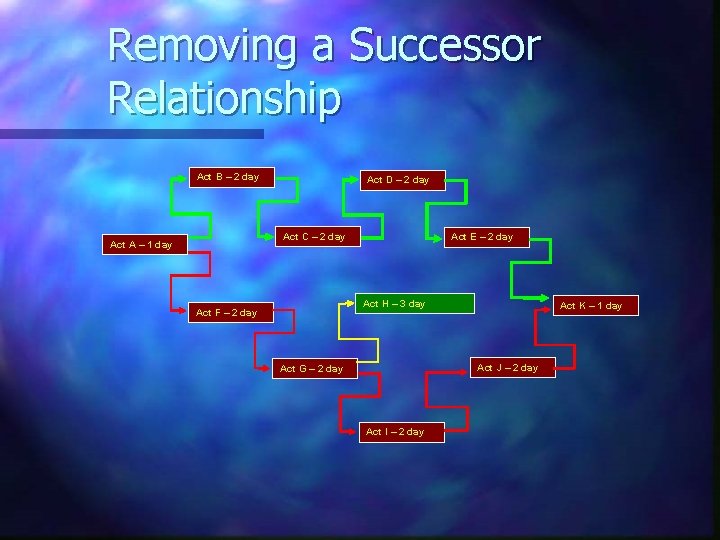

Removing a Successor Relationship Act B – 2 day Act D – 2 day

Removing a Successor Relationship Act B – 2 day Act D – 2 day Act C – 2 day Act A – 1 day Act E – 2 day Act H – 3 day Act F – 2 day Act K – 1 day Act J – 2 day Act G – 2 day Act I – 2 day

Removing a Successor Relationship Act B – 2 day Act D – 2 day

Removing a Successor Relationship Act B – 2 day Act D – 2 day Act C – 2 day Act A – 1 day Act E – 2 day Act H – 3 day Act F – 2 day Act K – 1 day Act J – 2 day Act G – 2 day Act I – 2 day

Recovery Options n Increase Manpower n Increase Work Hours and Workdays n Addition Shifts

Recovery Options n Increase Manpower n Increase Work Hours and Workdays n Addition Shifts n Re-sequence Work Activities ØMeeting Of Minds Required Here n Increase Equipment Or Material

Dealing With Change n Construction is a Dynamic Process, Change Will Occur ØUpdates Should

Dealing With Change n Construction is a Dynamic Process, Change Will Occur ØUpdates Should Accommodate Changes n Contract Should Require Notification of Change n Contract Should Require Submission of Time Impact Analysis n Contract Should Require Recovery Options be Submitted

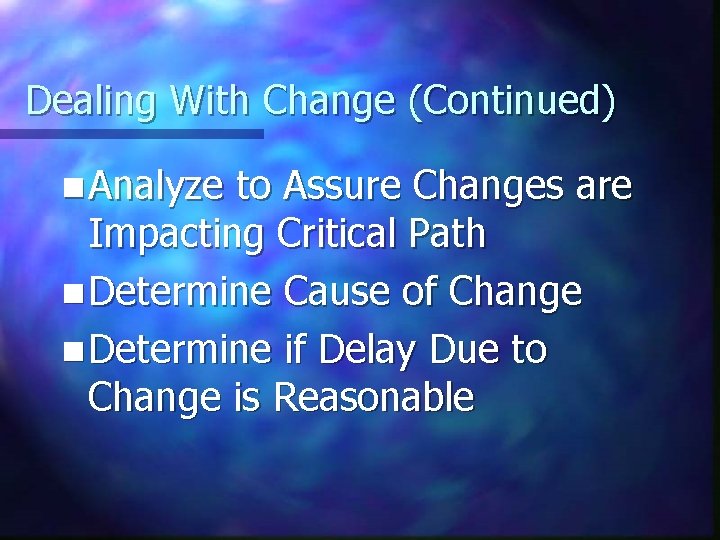

Dealing With Change (Continued) n Analyze to Assure Changes are Impacting Critical Path n

Dealing With Change (Continued) n Analyze to Assure Changes are Impacting Critical Path n Determine Cause of Change n Determine if Delay Due to Change is Reasonable

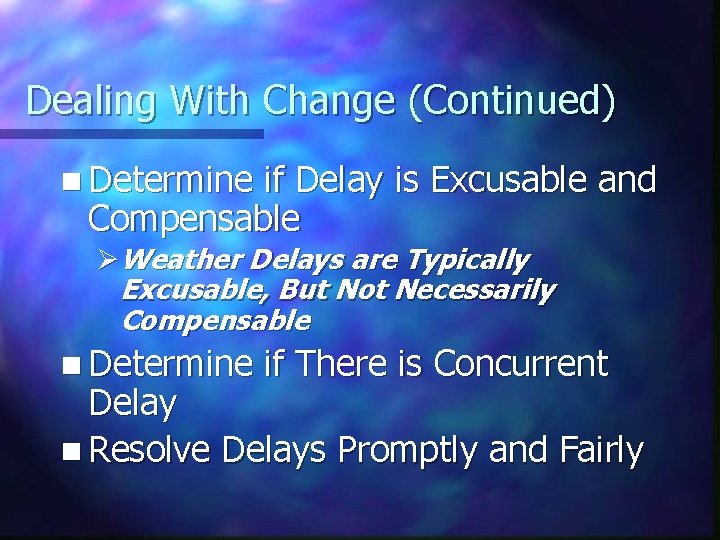

Dealing With Change (Continued) n Determine if Delay is Excusable and Compensable ØWeather Delays

Dealing With Change (Continued) n Determine if Delay is Excusable and Compensable ØWeather Delays are Typically Excusable, But Not Necessarily Compensable n Determine if There is Concurrent Delay n Resolve Delays Promptly and Fairly
