Gemini AO Program The Gemini Adaptive Optics Program

  • Slides: 24
Download presentation

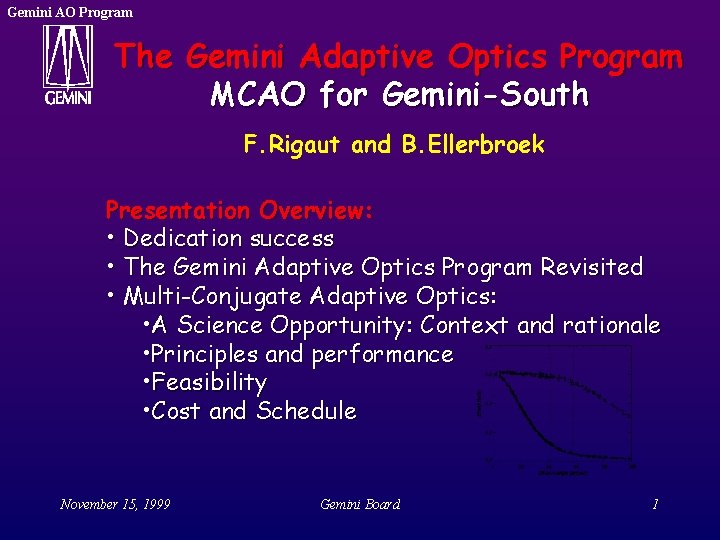

Gemini AO Program The Gemini Adaptive Optics Program MCAO for Gemini-South F. Rigaut and

Gemini AO Program The Gemini Adaptive Optics Program MCAO for Gemini-South F. Rigaut and B. Ellerbroek Presentation Overview: • Dedication success • The Gemini Adaptive Optics Program Revisited • Multi-Conjugate Adaptive Optics: • A Science Opportunity: Context and rationale • Principles and performance • Feasibility • Cost and Schedule November 15, 1999 Gemini Board 1

Gemini AO Program Gemini’s Dedication BD 30: Courtesy C. Roddier, UH-If. A November 15,

Gemini AO Program Gemini’s Dedication BD 30: Courtesy C. Roddier, UH-If. A November 15, 1999 Gemini Board 2

Gemini AO Program Gemini Top Level Performance Requirement #2 “ Image quality of better

Gemini AO Program Gemini Top Level Performance Requirement #2 “ Image quality of better than 0. 1 arcsec with AO: Achievement of outstanding image quality will have the highest scientific priority for the project […]” • 85% of the science topics in the Abingdon report need AO to be “effectively addressed” • The proposed evolution of the program at CP will enable unique NGST-class science 4 years ahead of NGST launch. It will keep Gemini competitive during the NGST era November 15, 1999 Gemini Board 3

Gemini AO Program Proposed Baseline AO Program Doing AO Since 1989 (Come-On, ESO 3.

Gemini AO Program Proposed Baseline AO Program Doing AO Since 1989 (Come-On, ESO 3. 6 -m) NORTH 1999 2000 2001 2002 2003 2004 • Facility VLT AO : NAOS+Conica • AO/Integral field unit: MACAO • 4 AO systems for the VLTI Altair 10 W LGS Hokupa’a SOUTH 36 Keck 85 Subaru VLT CP AOS/LGS CP Hokupa’a 2 W LGS November 15, 1999 85 VLT-LGS 1’’ 3 Years Gap Vesta 1. 5 m FWHM<40 mas Gemini Board 4

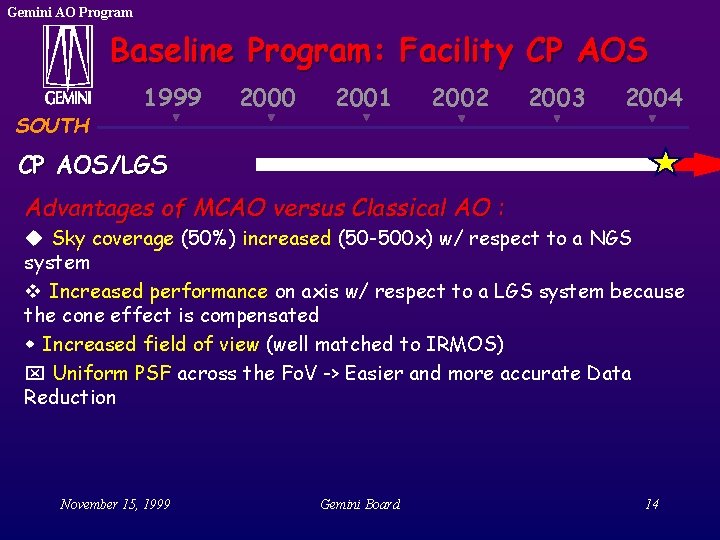

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003

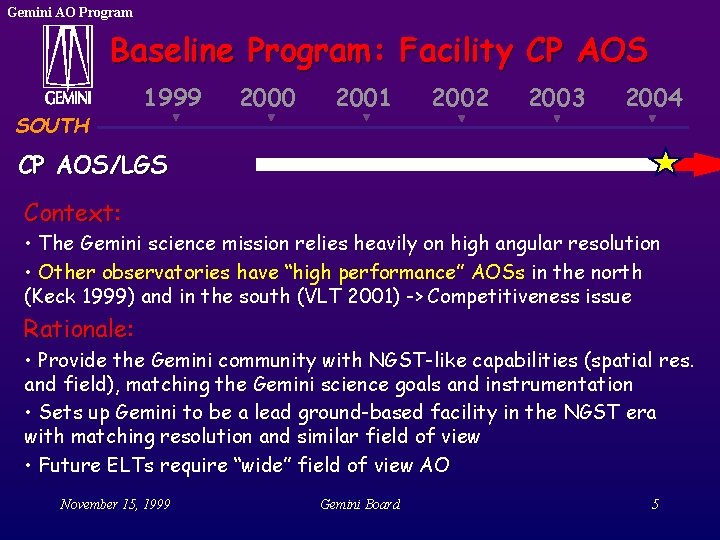

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003 2004 CP AOS/LGS Context: • The Gemini science mission relies heavily on high angular resolution • Other observatories have “high performance” AOSs in the north (Keck 1999) and in the south (VLT 2001) -> Competitiveness issue Rationale: • Provide the Gemini community with NGST-like capabilities (spatial res. and field), matching the Gemini science goals and instrumentation • Sets up Gemini to be a lead ground-based facility in the NGST era with matching resolution and similar field of view • Future ELTs require “wide” field of view AO November 15, 1999 Gemini Board 5

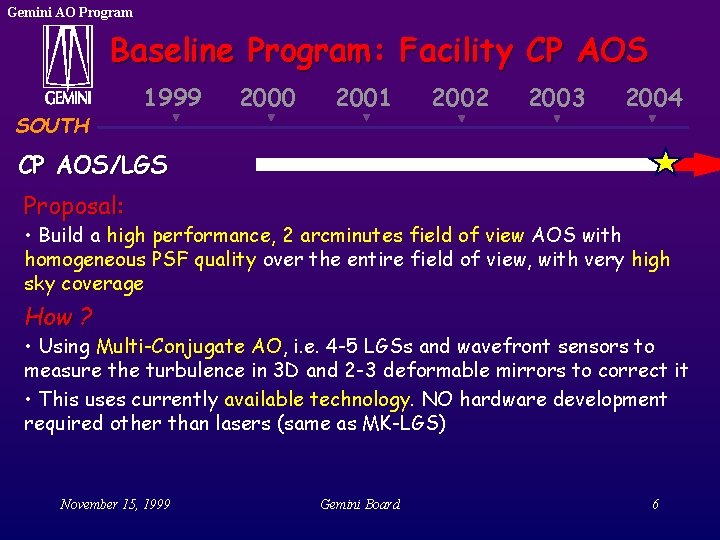

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003 2004 CP AOS/LGS Proposal: • Build a high performance, 2 arcminutes field of view AOS with homogeneous PSF quality over the entire field of view, with very high sky coverage How ? • Using Multi-Conjugate AO, i. e. 4 -5 LGSs and wavefront sensors to measure the turbulence in 3 D and 2 -3 deformable mirrors to correct it • This uses currently available technology. NO hardware development required other than lasers (same as MK-LGS) November 15, 1999 Gemini Board 6

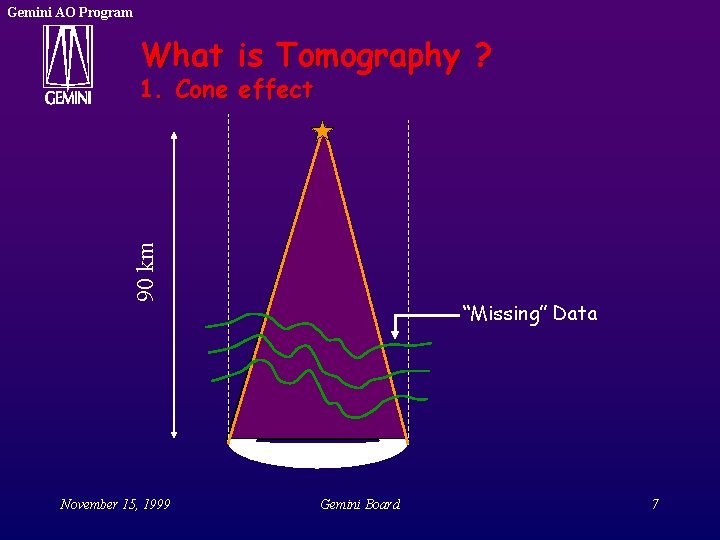

Gemini AO Program What is Tomography ? 90 km 1. Cone effect November 15,

Gemini AO Program What is Tomography ? 90 km 1. Cone effect November 15, 1999 “Missing” Data Gemini Board 7

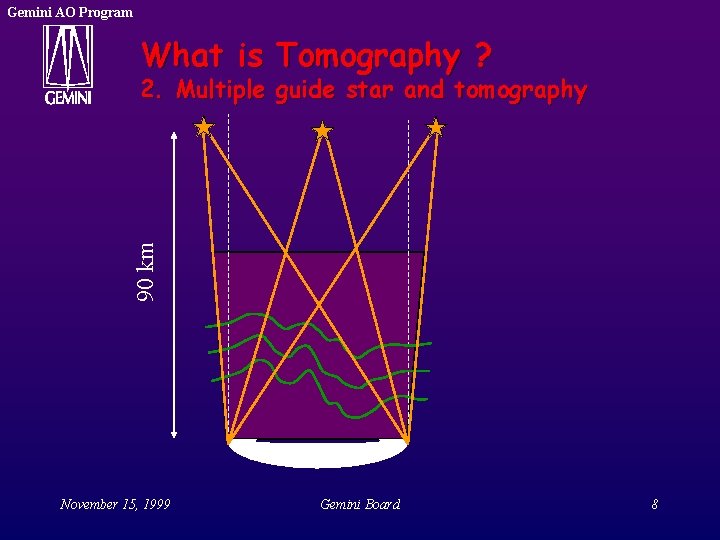

Gemini AO Program What is Tomography ? 90 km 2. Multiple guide star and

Gemini AO Program What is Tomography ? 90 km 2. Multiple guide star and tomography November 15, 1999 Gemini Board 8

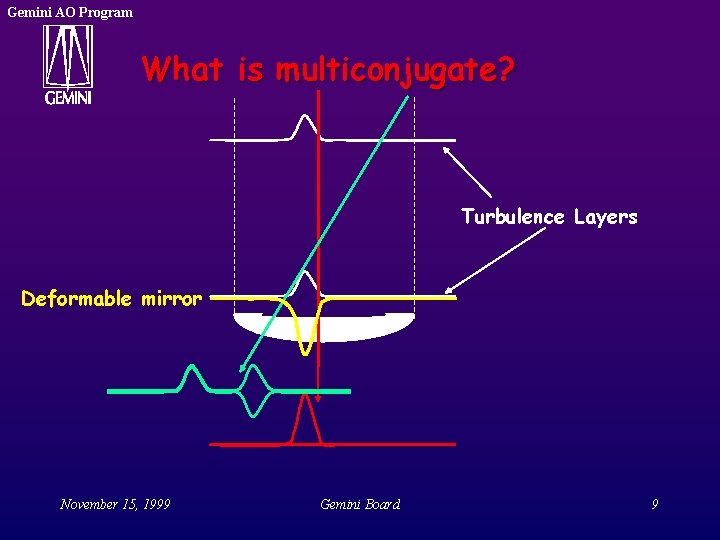

Gemini AO Program What is multiconjugate? Turbulence Layers Deformable mirror November 15, 1999 Gemini

Gemini AO Program What is multiconjugate? Turbulence Layers Deformable mirror November 15, 1999 Gemini Board 9

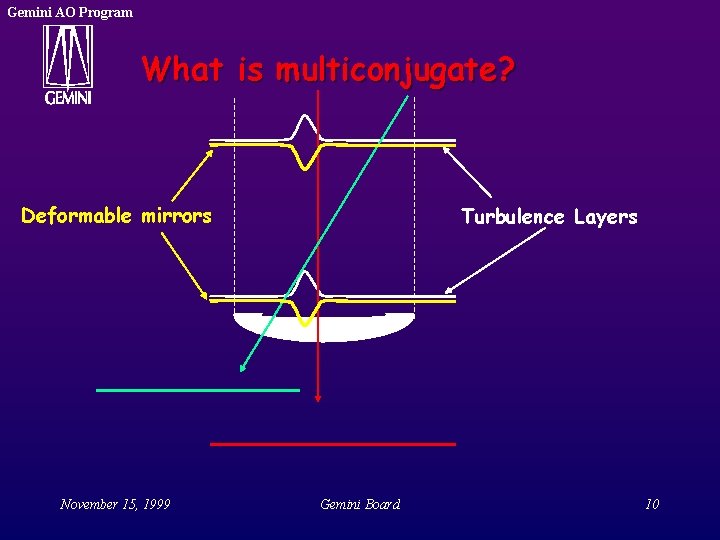

Gemini AO Program What is multiconjugate? Deformable mirrors November 15, 1999 Turbulence Layers Gemini

Gemini AO Program What is multiconjugate? Deformable mirrors November 15, 1999 Turbulence Layers Gemini Board 10

Gemini AO Program Effectiveness of MCAO Numerical simulations: • 5 Natural guide stars •

Gemini AO Program Effectiveness of MCAO Numerical simulations: • 5 Natural guide stars • 5 Wavefront sensors • 2 mirrors • 8 turbulence layers • MK turbulence profile • Field of view ~ 1. 2’ • H band November 15, 1999 Gemini Board 11

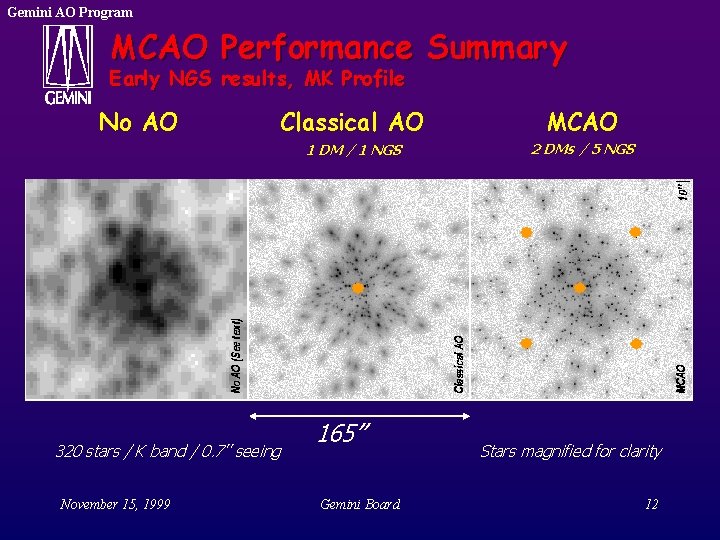

Gemini AO Program MCAO Performance Summary Early NGS results, MK Profile No AO 320

Gemini AO Program MCAO Performance Summary Early NGS results, MK Profile No AO 320 stars / K band / 0. 7’’ seeing November 15, 1999 Classical AO MCAO 1 DM / 1 NGS 2 DMs / 5 NGS 165’’ Gemini Board Stars magnified for clarity 12

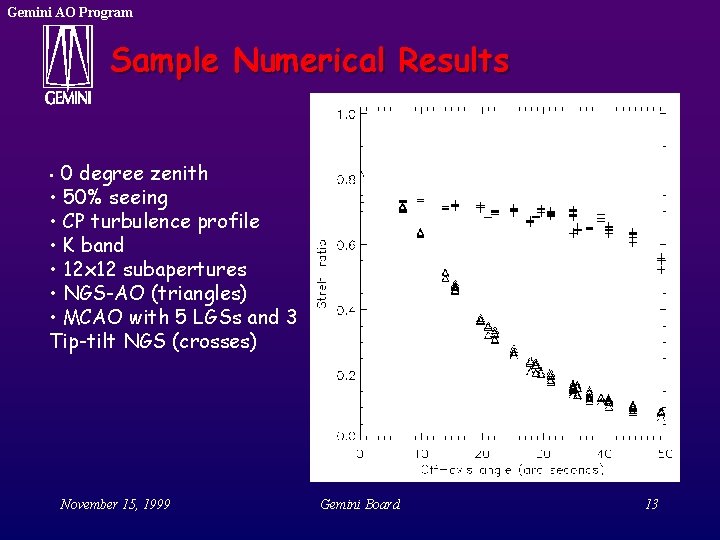

Gemini AO Program Sample Numerical Results 0 degree zenith • 50% seeing • CP

Gemini AO Program Sample Numerical Results 0 degree zenith • 50% seeing • CP turbulence profile • K band • 12 x 12 subapertures • NGS-AO (triangles) • MCAO with 5 LGSs and 3 Tip-tilt NGS (crosses) • K H J I November 15, 1999 Gemini Board 13

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003

Gemini AO Program Baseline Program: Facility CP AOS SOUTH 1999 2000 2001 2002 2003 2004 CP AOS/LGS Advantages of MCAO versus Classical AO : u Sky coverage (50%) increased (50 -500 x) w/ respect to a NGS system v Increased performance on axis w/ respect to a LGS system because the cone effect is compensated w Increased field of view (well matched to IRMOS) x Uniform PSF across the Fo. V -> Easier and more accurate Data Reduction November 15, 1999 Gemini Board 14

Gemini AO Program MCAO Implementation- Feasibility study conclusions: • • • Optics and optics

Gemini AO Program MCAO Implementation- Feasibility study conclusions: • • • Optics and optics bench – Mass, volume similar to Altair Wave front sensor camera – Goal of a single camera for all laser guide stars – 80 by 80 to 128 by 128 pixels, 5 to 10 read noise electrons Deformable mirrors and tip/tilt mirror – Number of actuators, other parameters demonstrated Wave front reconstruction electronics – Frame rate, number of inputs/outputs demonstrated – Flexible algorithms and architectures necessary for NGS tip/tilt measurements Tip/tilt sensors, laser transfer optics and launch telescope – Appear straightforward, feasibility designs in progress – 2 -3 T/T sensors + 1 more provided by OIWFS Laser(s): Technology and engineering development required November 15, 1999 Gemini Board 15

Gemini AO Program MCAO Science Optical Path • 3 DM’s at R=0, 4, and

Gemini AO Program MCAO Science Optical Path • 3 DM’s at R=0, 4, and 8 km • 13 actuators across beamprint • 4 folds, 2 off-axis parabolas, 1 dichroic beamsplitter (not shown) - Near-minimum number of surfaces for facility MCAO • f/30 output focus November 15, 1999 Gemini Board 16

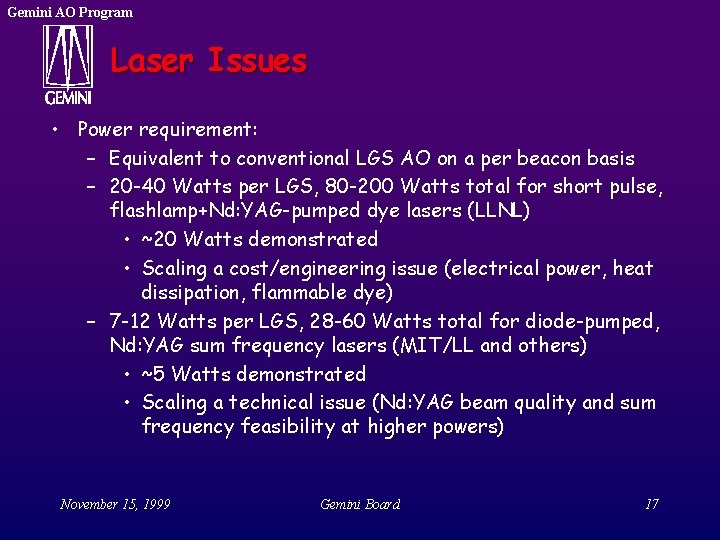

Gemini AO Program Laser Issues • Power requirement: – Equivalent to conventional LGS AO

Gemini AO Program Laser Issues • Power requirement: – Equivalent to conventional LGS AO on a per beacon basis – 20 -40 Watts per LGS, 80 -200 Watts total for short pulse, flashlamp+Nd: YAG-pumped dye lasers (LLNL) • ~20 Watts demonstrated • Scaling a cost/engineering issue (electrical power, heat dissipation, flammable dye) – 7 -12 Watts per LGS, 28 -60 Watts total for diode-pumped, Nd: YAG sum frequency lasers (MIT/LL and others) • ~5 Watts demonstrated • Scaling a technical issue (Nd: YAG beam quality and sum frequency feasibility at higher powers) November 15, 1999 Gemini Board 17

Gemini AO Program Baseline Schedule • Conceptual design review: 3/00 • Preliminary design reviews:

Gemini AO Program Baseline Schedule • Conceptual design review: 3/00 • Preliminary design reviews: 12/00 • Critical design reviews: 12/01 • Subsystems complete: 6/03 • System integration and test: 10/03 • Science handover: 3/04 November 15, 1999 Gemini Board 18

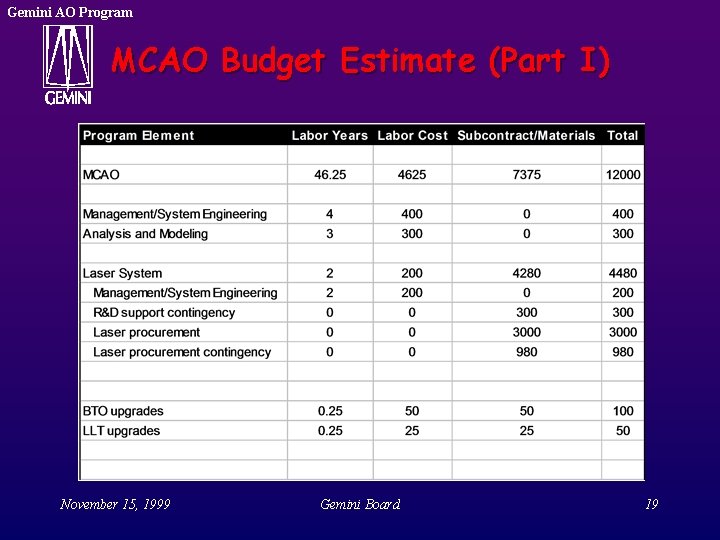

Gemini AO Program MCAO Budget Estimate (Part I) November 15, 1999 Gemini Board 19

Gemini AO Program MCAO Budget Estimate (Part I) November 15, 1999 Gemini Board 19

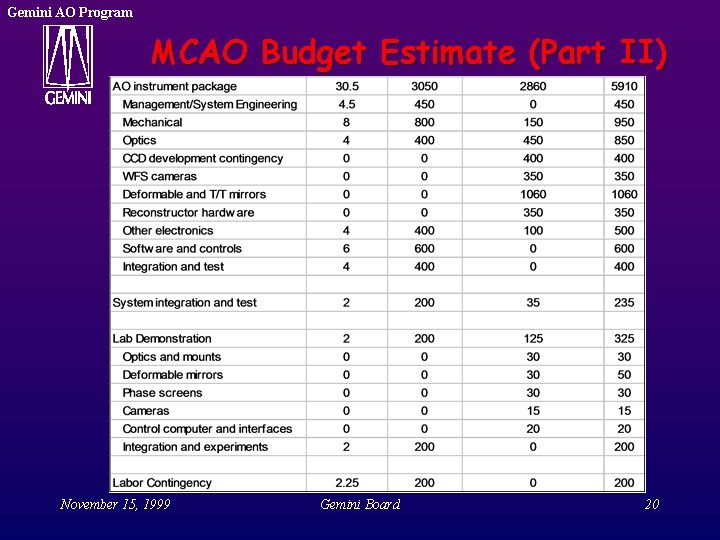

Gemini AO Program MCAO Budget Estimate (Part II) November 15, 1999 Gemini Board 20

Gemini AO Program MCAO Budget Estimate (Part II) November 15, 1999 Gemini Board 20

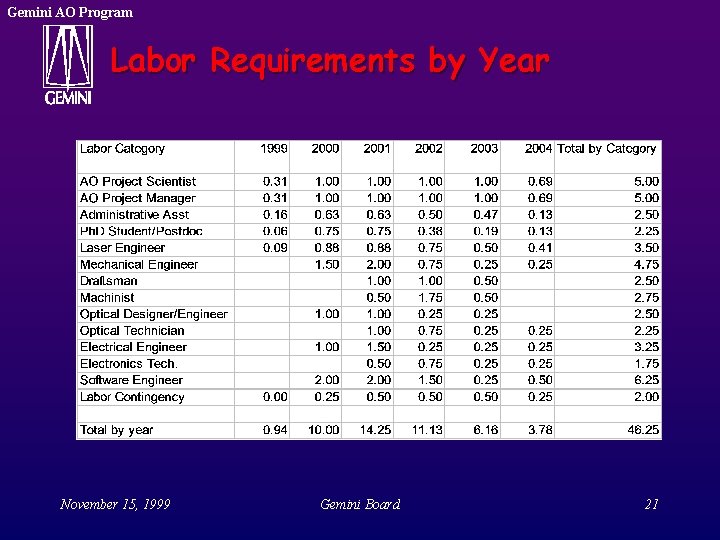

Gemini AO Program Labor Requirements by Year November 15, 1999 Gemini Board 21

Gemini AO Program Labor Requirements by Year November 15, 1999 Gemini Board 21

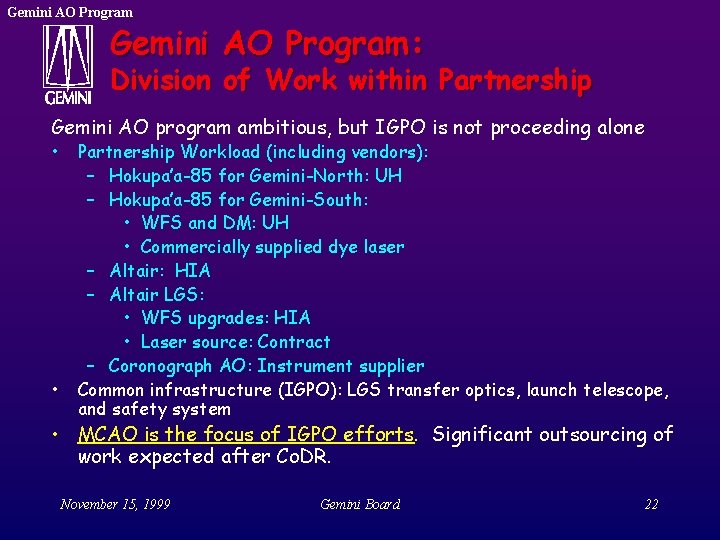

Gemini AO Program: Division of Work within Partnership Gemini AO program ambitious, but IGPO

Gemini AO Program: Division of Work within Partnership Gemini AO program ambitious, but IGPO is not proceeding alone • • Partnership Workload (including vendors): – Hokupa’a-85 for Gemini-North: UH – Hokupa’a-85 for Gemini-South: • WFS and DM: UH • Commercially supplied dye laser – Altair: HIA – Altair LGS: • WFS upgrades: HIA • Laser source: Contract – Coronograph AO: Instrument supplier Common infrastructure (IGPO): LGS transfer optics, launch telescope, and safety system • MCAO is the focus of IGPO efforts. Significant outsourcing of work expected after Co. DR. November 15, 1999 Gemini Board 22

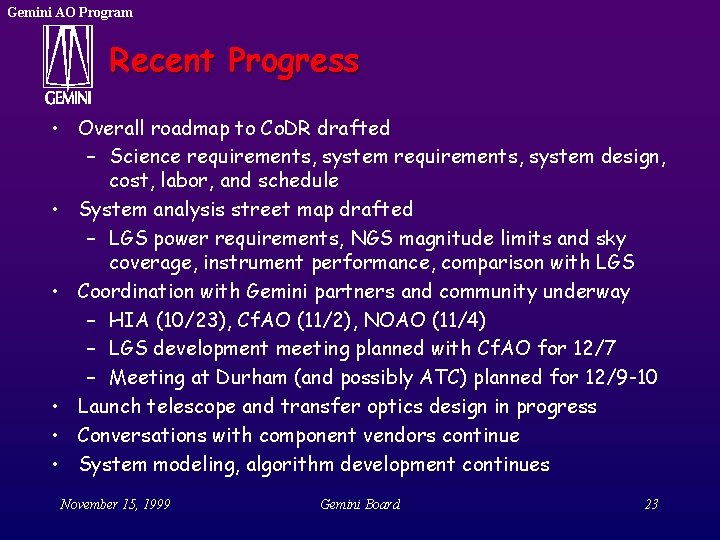

Gemini AO Program Recent Progress • Overall roadmap to Co. DR drafted – Science

Gemini AO Program Recent Progress • Overall roadmap to Co. DR drafted – Science requirements, system design, cost, labor, and schedule • System analysis street map drafted – LGS power requirements, NGS magnitude limits and sky coverage, instrument performance, comparison with LGS • Coordination with Gemini partners and community underway – HIA (10/23), Cf. AO (11/2), NOAO (11/4) – LGS development meeting planned with Cf. AO for 12/7 – Meeting at Durham (and possibly ATC) planned for 12/9 -10 • Launch telescope and transfer optics design in progress • Conversations with component vendors continue • System modeling, algorithm development continues November 15, 1999 Gemini Board 23

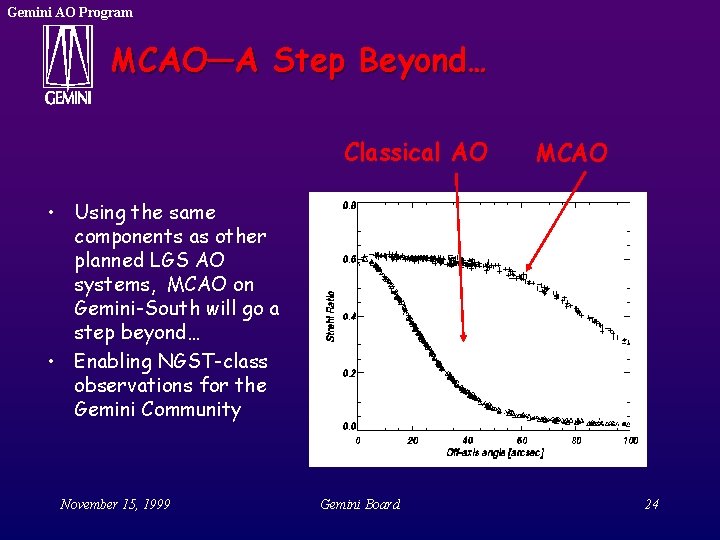

Gemini AO Program MCAO—A Step Beyond… Classical AO MCAO • Using the same components

Gemini AO Program MCAO—A Step Beyond… Classical AO MCAO • Using the same components as other planned LGS AO systems, MCAO on Gemini-South will go a step beyond… • Enabling NGST-class observations for the Gemini Community November 15, 1999 Gemini Board 24
